106A MAN-DAY CAPABILITY

SEABEE COMBAT. WARFARE. NMCB SPECIFIC. 106A MAN-DAY CAPABILITY. Contingency Operations. References: NAVFAC P-437, Planning Guide for Navy Facilities, Vol. 1 NAVFAC P-437, Planning Guide for Navy Facilities, Vol. 2. Contingency Operations.

alessa
Télécharger la présentation

106A MAN-DAY CAPABILITY

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. SEABEE COMBAT WARFARE NMCB SPECIFIC 106A MAN-DAY CAPABILITY

  2. Contingency Operations • References: • NAVFAC P-437, Planning Guide for Navy Facilities, Vol. 1 • NAVFAC P-437, Planning Guide for Navy Facilities, Vol. 2

  3. Contingency Operations • NAVEDTRA 12543, Naval Construction Force/Seabee 1 &C • Seabee Crew Leader Handbook • Seabee Construction Management I & II

  4. Abbreviations • MC =Total Manday Capability of Direct Labor Personnel (projects + training) • DL =Number of Direct Labor Personnel Assigned • WD =Number of Available Workdays in the Deployment • ME =Manday Equivalent (converts typical workdays to 8 hour mandays) • AF =Availability Factor

  5. Manday Capability • In order to calculate the construction activity duration's, you must first understand the Manday Capability Equation. • The equation used to determine the direct labor manday capability at the mainbody site and each detail site is as follows.

  6. Manday Capability Manday Capability (MC)- the total number of mandays that a NMCB, DET, DFT, etc. is able to produce within a specified period of time.

  7. Direct/Indirect/Overhead Labor • Direct Labor personnelare those whose efforts contribute to project work-in-place (WIP). • Indirect labor personnel provide project support and include mechanics, expeditors, EA’s (except when surveying), MLO / CTR, Staffs and the Ops / QC staff. • Overhead labor personnel provide battalion support such as disbursing, galley ops, personnel, admin and supply.

  8. Workdays • Workdays (WD) - The number of available workdays is the total number of calendar days minus all off days. • Off days may include: Sundays; half of the Saturdays; all holidays; battalion turnover (up to 10 days for mainbody); one day for mid-deployment party; and one day for the change of command.

  9. Manday Equivalent • Manday Equivalent (ME) - is the actual manhours worked “swinging hammers” on the job site during a workday. It is the length of the workday, minus lunch, minus breaks minus travel time to and from the job site (including lunch), divided by 8 (the number of hours in a manday).

  10. Availability Factor • Availability Factor (AF)- Takes into account that Seabees assigned as direct labor are not available 100% of the time. • About 20% of the direct labor personnel’s time is lost to : leave, liberty, inspections, quarters, medical, dental, haircuts, military drills, battalion indoc, watches, collateral duties, etc.

  11. Availability Factor • Availability Factors for planning purposes are provided by higher headquarters. • They vary between .60 and .90 depending on the deployment site. • The typical percentages are .75 for mainbody sites and .85 for detail sites. • The typical percentage for contingencyconstruction is .90.

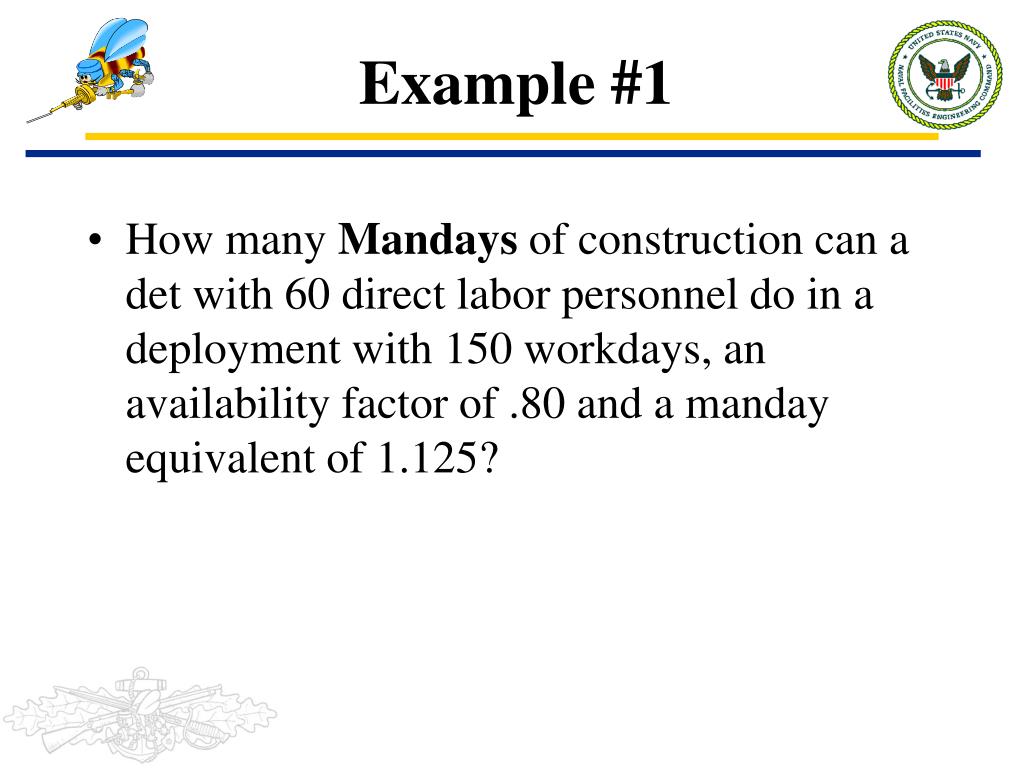

  12. Example #1 • How many Mandays of construction can a det with 60 direct labor personnel do in a deployment with 150 workdays, an availability factor of .80 and a manday equivalent of 1.125?

  13. Answer #1 • MC = DL x WD x ME x AF • MC = 60 x 150 x 1.125 x .80 • MC = 8,100

  14. Example #2 • How many Direct Labor personnel would be required for a detail tasked to do 4,000 mandays in a deployment with 150 workdays? • Use 1.125 as the manday equivalent and .90 for the availability factor.

  15. Answer #2 • DL = MC / (WD x ME x AF) • DL = 4,000 / (150 x 1.125 x .90) • DL = 4,000 / 151.875 • DL = 4,000 / 151.875 = 26.337 or 27

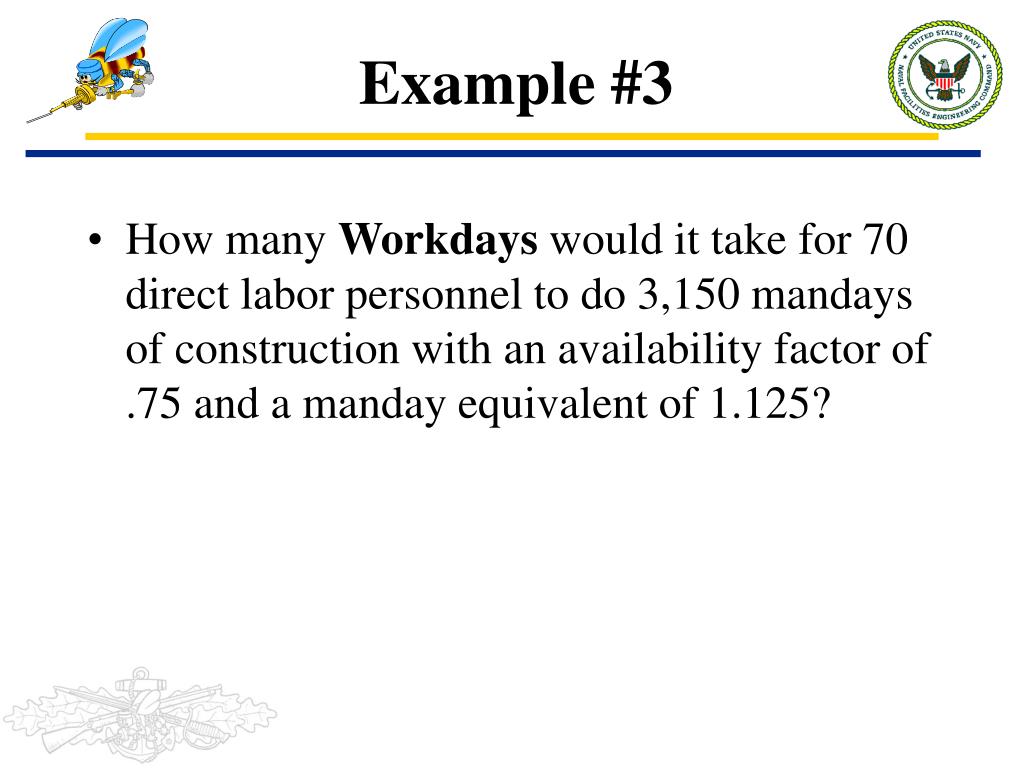

  16. Example #3 • How many Workdays would it take for 70 direct labor personnel to do 3,150 mandays of construction with an availability factor of .75 and a manday equivalent of 1.125?

  17. Answer #3 • WD = MD / (DL x ME x AF) • WD = 3,150 / (70 x 1.125 x .75) • WD = 3,150 / 59.0625 • WD = 53.33 or 54

  18. Example #4 What would our Manday Equivalent be if we had a crew of 12 working from 0630 to 1700, traveled 5 minutes to and from work, 1 hour for lunch (including travel time) and two 10 minute breaks?

  19. Answer #4 • ME = WD - Travel time - break time -lunch / 8 • ME = 10.5 - .167 - .33 - 1 / 8 • ME = 1.125

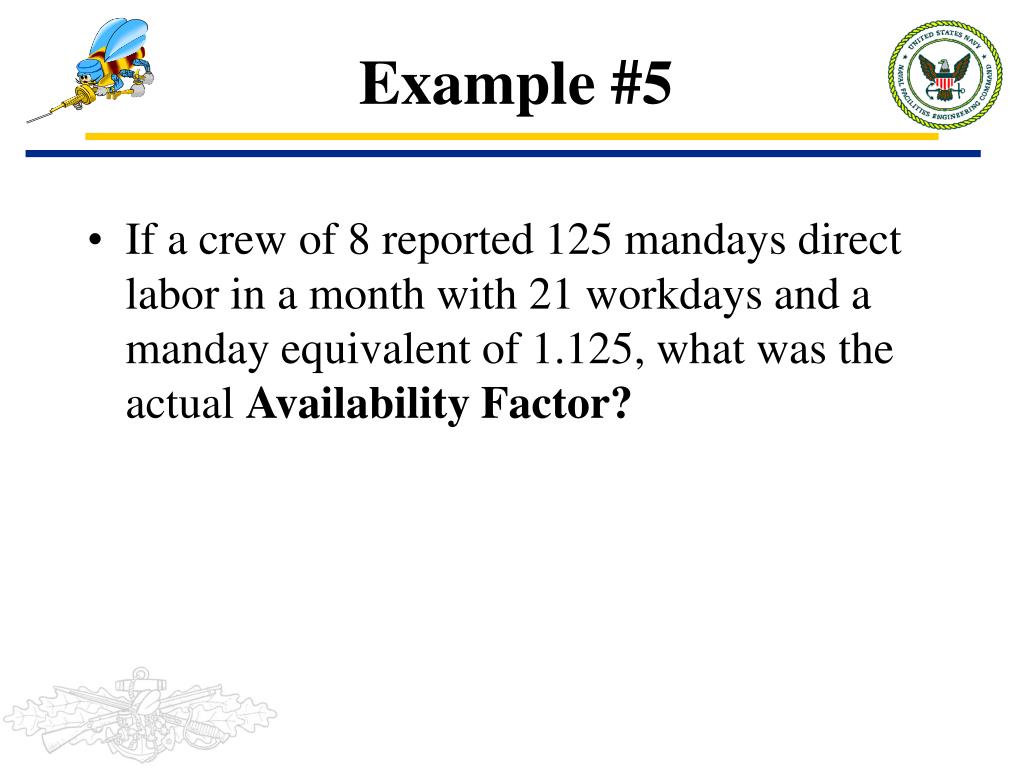

  20. Example #5 • If a crew of 8 reported 125 mandays direct labor in a month with 21 workdays and a manday equivalent of 1.125, what was the actual Availability Factor?

  21. Answer #5 • AF = MD / (DL x WD x ME) • AF 1.125 IS FOR MAIN BODY ONLY • AF = 125 / (8 x 21 x 1.125) • AF = 125 / 189 • AF = .6613756 or 66%

  22. NAVFAC P-437 VOL 2INDEX OF COMPONETS

  23. NAVFAC P-437 VOL 2COMPONETS

  24. NAVFAC P-437 VOL 2FACILITIES

  25. NAVFAC P-437 VOL 2ASSEMBLIES

  26. SMEAC • Situation • Mission • Execution • Administration • Command and control

  27. SMEAC #1 • Situation: Dayton peach accord requires deployment to NATO forces to Bosnia to which the United States has committed 5,000. Permanent and temporary campsites are required to house U.S. Forces. • Mission:Construct campsite to house JTF forces. Construct one (1) 750 man tent camp. Provide for repair of runway for C-130 aircraft. Convoy security will be provided by JTF as requested.

  28. SMEAC #1 cont. • Execution: Be prepared to deploy with in 5 days, advise ALCON when available for airlift. Provide specific airlift/sealift requirements to 2NCB within 48 hours. Identify Class IV materials required for camp construction within 72 hours. Upon completion of tasking, redeploy to originating site (approx. 60 days). • Administration: Operate own self-sufficient camp. Resupply requests through JTF. CESE support through own command, require anticipated schedule for airlift within fire days of arrival.

  29. SMEAC #1 cont. • Command and control: • OPCON - JTF • ADCON - NMCB 74 • Advise ADCON on arrival • Revise schedule for construction and submit weekly sitrep.

  30. NAVFAC P-437 VOL 2INDEX OF COMPONETS

  31. NAVFAC P-437 VOL 2COMPONETS

  32. CONVERT MANHOURS TO MANDAYS • MD = MH / 8 hour in a workday • MD = 7,501 / 8 • MD = 937.625 or 938

  33. FORMULA FOR MANDAY CAPABILITY • DL = MD / WD / ME / AF • DL = 938 / 56(60 - 4 days for mount out)/ 1.25 / .90 • ME 1.25 is for contingency ops only • DL = 14.88 or15

  34. RATIO • CM 6 TO 1 • WILL BE CHANGING TO 8 TO 1 BUT IT HAS NOT GONE INTO EFFECT YET • HM 100 TO 1 • IDC 150 TO 1 • YN/PN 50 TO 1 • MS 50 TO 1 LESS THEN 50 PEOPLE THERE WILL BE NO FSA’S

  35. RATIO cont. • SK UNDER 100 THERE WILL BE ONLY 1 • ET DEPENDS ON SMEAC • GM DEPENDS ON SMEAC

  36. RATIO cont. • FSA • FOR EVERY ONE MS THERE WILL BE ONLY ONE FSA’S • 1 TO 1

  37. RRR • 46 LEVEL I • 20 LEVEL II • 6 CRETE MOB. • TOTAL • 72 PEOPLE

  38. MAIN SUPPLY ROUTE • MSR • 6 EO’s • FOR EVERY 10 MILES OF ROADS

  39. SECURITY • SECURITY PLT HAS 45 PEOPLE • PLT COMMANDER • ASST. PLT COMMANDER • RIGHT GUIDE • 14 IN SQ

  40. WATER WELL • TOTAL OF 21 PEOPLE • OIC • MS • IDC • 18 DL

  41. THE END • ANY QUESTIONS
