UNCERTAINTIES

UNCERTAINTIES. There is inherent variability in work makes it difficult to follow schedules. There is competition for people, facilities and other equipment within and across products – work waits in queue Unpredictable work cause schedule delays.

alisa
Télécharger la présentation

UNCERTAINTIES

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

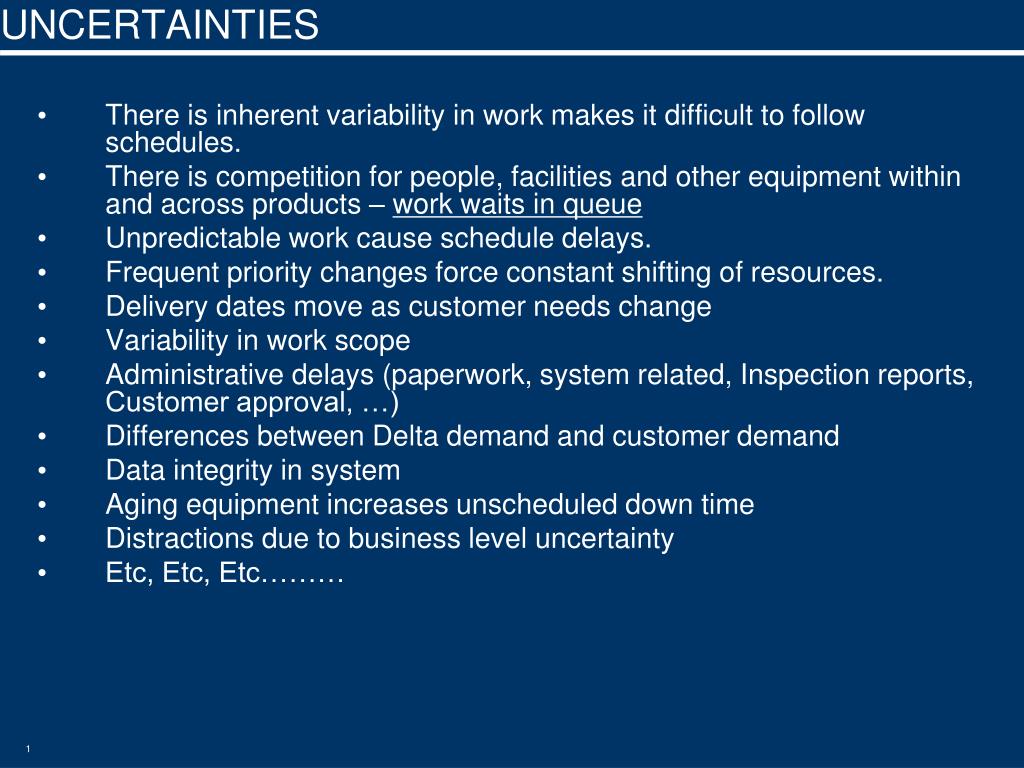

  1. UNCERTAINTIES • There is inherent variability in work makes it difficult to follow schedules. • There is competition for people, facilities and other equipment within and across products – work waits in queue • Unpredictable work cause schedule delays. • Frequent priority changes force constant shifting of resources. • Delivery dates move as customer needs change • Variability in work scope • Administrative delays (paperwork, system related, Inspection reports, Customer approval, …) • Differences between Delta demand and customer demand • Data integrity in system • Aging equipment increases unscheduled down time • Distractions due to business level uncertainty • Etc, Etc, Etc………

  2. Product Assembly & Test Outside Repair Product Disassembly Scrap Replacement Repair & Support Shops Before TOC How Products Flowed – Engine Maintenance = Engines, APU’s, Landing Gear Historical 4 year monthly average production = ~38 engines/mth 20,000 open shop orders to support 60 + engines in WIP

  3. Policy Constraint(s) • Pressure to deliver on time • Pressure to expedite  • Multi-tasking • Priority changes • De-synchronization • Induct Asset ASAP • Start repairs ASAP • Start buildup ASAP • Expediting  • Multi-tasking • De-synchronization • Early release for • production • Push parts to Back shops ASAP • Pull parts from Back shops ASAP Intrinsic Uncertainties Uncertainties multiply Delays  Start Early (CT ) Lines High no. of jobs in progress Delays/ Shortages  Lead time  Resource contention  (Queues ) Backshops Realization Technologies, Inc

  4. “If I just had my !@#$ parts…” Originally focused on Disassemble and release of Parts ASAP • Created excess WIP • Little’s Law* • Competing priorities • Customer vs. Delta • Day Cards, Green Cards, Manager Specials • Long Queue Times vs. Short Touch Times • Long TAT and Low Through-Put • Parts late to Outside repair vendors

  5. Implement Theory of Constraints • Metrics –Throughput, Turn Time, WIP • Drum Buffer Rope Scheduling (Repair Shops) • Exception Management • CCPM (Product Lines)

  6. Simplified Drum-Buffer-Rope Drum Determined by Due Date Established a 15 day rope • 10 working days plus 5 days of Buffer • Determined by Longest Lead-Time part • Approx. 156 process hours, ~ 6.5 days • Most parts require < 3 days Touch-Time • Typical parts repair averaged 60 days • Now 10 days, 7 days plus 3 days of buffer Control release of Material • Work to the rate of R&S (Constraint) • Established Parts Release mechanism to protect the system • Parts sent to Holding Area to wait for release • Release Exception Parts ASAP • Release Non-Exception Parts at A15, now A10 • Repair Gate Manager—sets schedule & priority

  7. Exception Management Production Meeting each Day • D+2 & D+7 Validation • BOMs complete • Exception Parts released • Non exception parts in holding area • A-2 Communication • Identify parts that will miss start date • Determine options • Wait, protected by Project Buffer • Expedite—20 Tags monitored • Swap—available part • Work with Supplier/Vendor for Solution • Buy

  8. CCPM Introduced Critical Chain rules to manage Product Lines • Treat each Product as a project • Pipeline (staggered) Products across all lines to protect the system • Transitioned from precise, Task-Level management to Simple Milestones (Concerto) • Explicit time buffers

  9. ASSY BEGIN (A ZERO) DISASSY END (D ZERO) INDUCTION (I ZERO) TEST (T ZERO) A-10 D+7 D+2 A-3 Stagger Inductions HOLD FOR RELEASE PARTS REPAIR DISASSEMBLY ASSEMBLY • Minimizes R&S WIP levels • Ensures only parts that are needed are in work • Results include increased throughput and decreased TAT • Do not begin until 100% of parts are received • Use OT only to regain lost buffer • All exception parts routed • Complete BOM BY D0 • Ensure all exception parts out by D+2 & D+7 follow up • All shops follow RED, FIFO priority in RGM. Expedite tags used only for emergency Current Execution Process A-2

  10. Summary of Changes • Create Plans with Buffers • Developed aggressive project plans with buffers for Product lines • Setup FIFO/red/expedite priority system for all piece parts Control WIP • Control the release of Products into the system based on WIP • Hold non-exception parts until A-10 • Do not start assembly until all parts are available Manage Using the Buffers • Turn parts red 3 days before the start of assembly • Assign work based on buffer priorities • Allocate resources to red parts and/or red tasks Exception Management • Review D+2 and OSR parts at D+7 to ensure on-time delivery • Review all parts starting A-2 and make decisions if A0 will not be met

  11. Results • WIP: • Was 20,000 Piece Part WIP  6000 Piece Part WIP TP: • 25% increase in piece part repair • 97+% parts back at A0 • 23% increase in engine production within first year • 50+ engines per month produced consistently Turn Time: • 70% Reduction in Piece Part TAT • Engine total TAT reduction – 40% AVG across all product lines • Landing Gear TAT reduction – 60% • Robert Fox Award—Operational Innovation

  12. Next Steps TOC implementation has continued to drive the flywheel faster YOY • Next steps: • Distribution Solution • Focus on Outside Repair Vendors and New Material Supply Processes • Attention around exception management • Improve synchronization

  13. Questions?
