Upgrading to Project Server 2013

PC304. Upgrading to Project Server 2013. Dan Smith – Deputy CIO Aaron Ott – Windows Administrator Marquette University. Agenda. Where we Started How we use Project Server Reasons for Project Server 2013 Technical Upgrade Functional Improvements Workflow Issues and Challenges.

ardice
Télécharger la présentation

Upgrading to Project Server 2013

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. PC304 Upgrading to Project Server 2013 Dan Smith – Deputy CIO Aaron Ott – Windows Administrator Marquette University

  2. Agenda • Where we Started • How we use Project Server • Reasons for Project Server 2013 • Technical Upgrade • Functional Improvements • Workflow • Issues and Challenges

  3. UNIVERSITY Stats • Approximately11,000 students • 2,500 faculty and staff • Centralized IT Services staff size of ~80 FTE • 6 full time PM’s that report to the PMO • Standardized on Project Server 2013 • SharePoint, MS Excel & Word Templates • Approx. 15% IT Projects, 85% Institutional

  4. The Start • Project Center • Project Server 2007 • Only in progress projects • Project Server 2010 • All projects • All project information

  5. Using Project ServerPM methodology

  6. Hope is NOT a Strategy • Project Management requires adherence to a well-defined process • Tracking against a schedule is necessary, but not sufficient • Cost, Schedule, and Performance are inseparable • Communication is the #1 success factor

  7. Marquette Best Practices • Use of templates for • Project Plan • Budget • Use of Project Server • Standardizes many aspects of project mechanics • PM Training (in house and external) • PM incentive to obtain PMP

  8. Project Management Plan vs. Schedule • Project Management Plan (PMI, PMBOK®) • A formal, approved document that defines how the project is executed, monitored and controlled. It may be summary or detailed and may be composed of one or more subsidiary management plans and other planning documents • Project Schedule • Listing of project tasks which attempts to model the project and predict the future

  9. Elements of the Plan • Project scope and objectives • Start-up plan • Project Tracking Plan • Budget Control • Issue Control • Reporting • Project Metrics • Risk Management Plan • Communication Plan • Closure plan

  10. How we use Project Server • Publish Projects • Collect project information • Collect task information via the Web • Views make lists very usable • Make great use of lists • Issues • Risks • Communications plan • Change orders • Project Workspaces • Single place for all project information • Document Management • Prevent stepping on others changes • Version control • Manage Issues and Risks • Defined attributes • Can be linked to specific tasks

  11. Project Mechanics • All Project Managers are expected to abide by: • Project Plan completed as necessary • Detailed project schedule developed, with resources assigned, and published to Project Server • Project schedule updated at least weekly with current status • Documents associated with the project posted to Project Server • Project issues and risks entered into Project Server • Weekly project status reports submitted on all active projects

  12. Project Workspaces

  13. What is an Issue? • Something that is or will stop forward movement • A problem • A decision that needs to be made • A question that needs to be answered • When do we need to log it in Project Server • Open for greater than 1 business day • Cross functional – need to involve others for resolution

  14. Issue Attributes Status (1) Active (2) Postponed (3) Closed Category (O) Request for Change -- Out of Scope (R) Request for Change -- In Scope (Q) Question or Concern (I) Other Priority (0) Blocking (1) High (2) Medium (3) Low Post Project Closure Closure not approved yet (T) Project Team (P) Project Manager (G) PM Working Group (S) Steering Committee

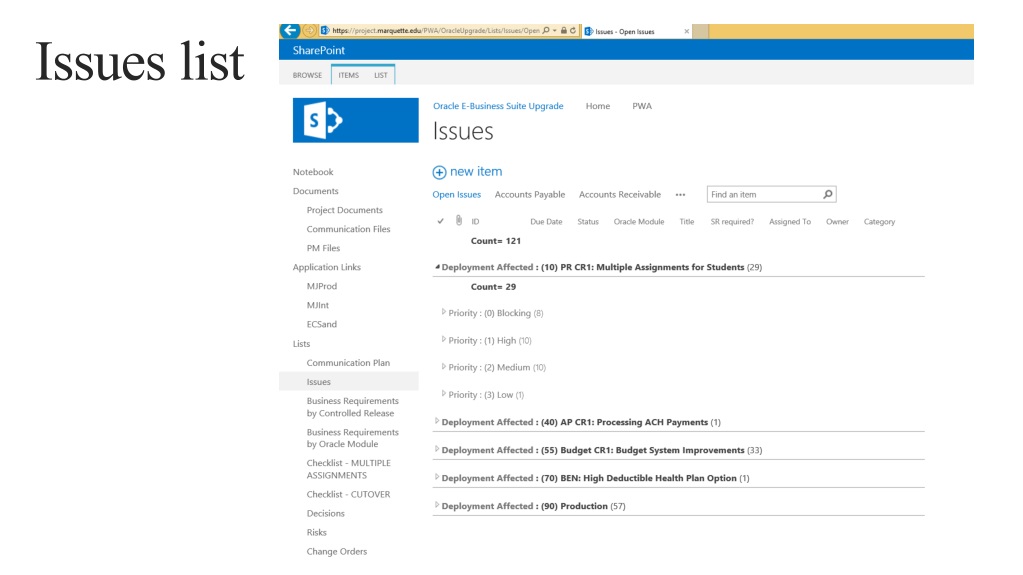

  15. Issues list

  16. Finance Needs

  17. Finance Needs Solution Short term Needs a “Projects Database” Needs project rational in a common format Needs budgets in a consistent format Needs better more timely budget forecasts Longer term Needs a better way to prioritize projects Project Server Project Server UMT 360 UMT 360 Project Server

  18. Two Major Initiatives • Collect Project Information • Common format • Retain Historical information • Document approval • Reporting • Project Selection Recommendation • Provide for a more visible and transparent process

  19. UMT 360 • Allowed to track budget in Project Financial Server • Facilitates forecasting • Tracking actuals • Seamless integration in Project Server

  20. Project Server Upgrade

  21. Reasons to Upgrade • Improved performance • Browser support • Improved workflow • OneNotenotebook • Improved client • Client reporting • Project timeline Web part • Database consolidation

  22. Project Server 2010 Environment • Single App/Web server • SQL backend • 3rd party portfolio management app with custom workflow

  23. Target Environment • Multi-tiered farm • Better (virtual) hardware • Upgraded SQL backend • Latest Windows OS • Latest Cumulative Update • Latest release of 3rd party portfolio management app • Migrate workflow from 3rd party to native workflow

  24. Preparation • Lots of reading on Technet, blogs, Social forums • Lots of test VMs • Notes (lot of them) • Inventory your current environment • Lots of practice upgrades • More practice upgrades • Take more notes

  25. More ways to prepare • Microsoft TAPs & RDPs • Use OneNote to track everything • Create your own installation guide • Create your own upgrade guide • Try to break your builds

  26. Upgrade Execution Plan • Coordinate with teams • What the upgrade means to a PM and projects • What happens to PWA 2010? • How do PMs get to upgraded PWA? • Double-check target farm, notes, everything • What if it all blows up?

  27. Upgrade Execution • BACKUPS • Begin upgrade process • PWA and project sites take a while • Check logs constantly • Migrate what needs to be migrated

  28. Post Upgrade • Test everything • Release to users • Something will probably break • Keep checking logs • Keep checking farm performance • Keep your test environment

  29. Workflow Improvement • Easy to setup using SharePoint designer • More options for e-mail notifications • Can use workflow in other SharePoint environments

  30. Active Projects

  31. Reporting • SQL Reporting Services

  32. Integration with Oracle Financials Budgets Project Server Oracle EBS Actuals Project Budgets Forecasts Actuals Reports

  33. Issues/Comments • Converted Project Sites or using Custom Templates • Notebooks do not light up automatically • Deliverables Web part does not look correct • Changing e-mail recipients in Workflow • Default workflow task list did not work • Required fields do not work as expected with Workflow (DCR)

  34. Challenges • Other departments adapting to a PM methodology • We need to get the data to be trusted • Project Prioritization • Started to use the tool this FY for the first time • Establish committee • Redefining drivers to align with Strategic Plan • Discussing how to handle maintenance projects vs “new” projects

  35. Questions?

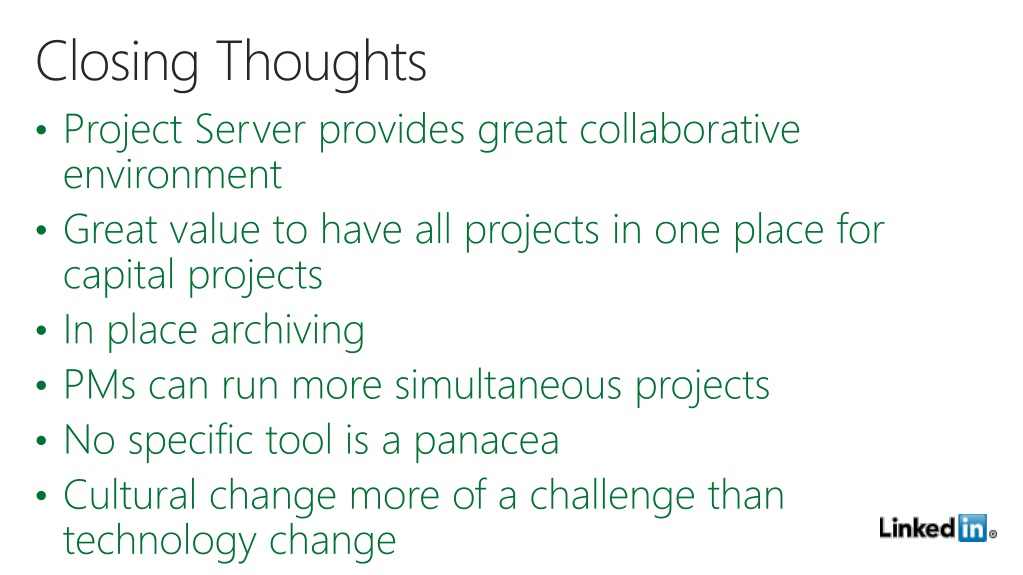

  36. Closing Thoughts • Project Server provides great collaborative environment • Great value to have all projects in one place for capital projects • In place archiving • PMs can run more simultaneous projects • No specific tool is a panacea • Cultural change more of a challenge than technology change

  37. MyPCfill out evaluations & win prizes! Fill out session evaluations by logging into MyPC on your laptop or mobile device. Evaluation prizes daily! Claim your prize at the Registration Desk on Level 1. After the event, over 100 hours of resources; including all of the PPT decks and session videos will be available. www.msprojectconference.com

  38. © 2014 Microsoft Corporation. All rights reserved. Microsoft, Windows and other product names are or may be registered trademarks and/or trademarks in the U.S. and/or other countries. The information herein is for informational purposes only and represents the current view of Microsoft Corporation as of the date of this presentation. Because Microsoft must respond to changing market conditions, it should not be interpreted to be a commitment on the part of Microsoft, and Microsoft cannot guarantee the accuracy of any information provided after the date of this presentation. MICROSOFT MAKES NO WARRANTIES, EXPRESS, IMPLIED OR STATUTORY, AS TO THE INFORMATION IN THIS PRESENTATION.
