An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. Project Coordination R. Cavanaugh University of Florida

  2. Important • UltraLight is a project with two equal and symbiotic activities • Application driven Network R&D • Not just a networking project, nor solely a distributed data analysis project • UltraLight is a Physics ITR • Ultimate goal • Enable and produce physics (more generally e-science), which could not otherwise be performed • Network Technical Group is the “backbone” of the Project • Activity: Perform network R&D • Metric: CS Publications, demonstrations • Applications Technical Group is the “driver” of the Project • Activity: Perform “middleware” R&D, perform LHC Physics research • Metric: CS and Physics Publications, demonstrations, community adoption

  3. CMS CCS APROM US-CMS S&C Tier-1 UAF Tier-2 Program DYSUN Tier-2c ATLAS Relationship between UltraLight and LHC ATLAS and CMS will integrate the UltraLight Application Services respectively into their own separate Software Stacks

  4. LHC Computing Model: Requirements and Scale

  5. Reminder from the Proposal • Phase 1 (12 months) • Implementation of network, equipment and initial services • Phase 2 (18 Months) • Integration • Phase 3 (18 Months) • Transition to Production

  6. Connecting to the LHC schedule

  7. Original UltraLight Synchronisation Plan with CMS Phase 1 Now UltraLight Milestones 6-m from now CMS Milestones and activities Phase 2 UltraLight Deliverables UltraLight Users Phase 3

  8. Scope of UltraLight • Original Proposed Programme of Work • Current Amended Programme of Work

  9. Relationship between Ultralight, and proposed GISNET

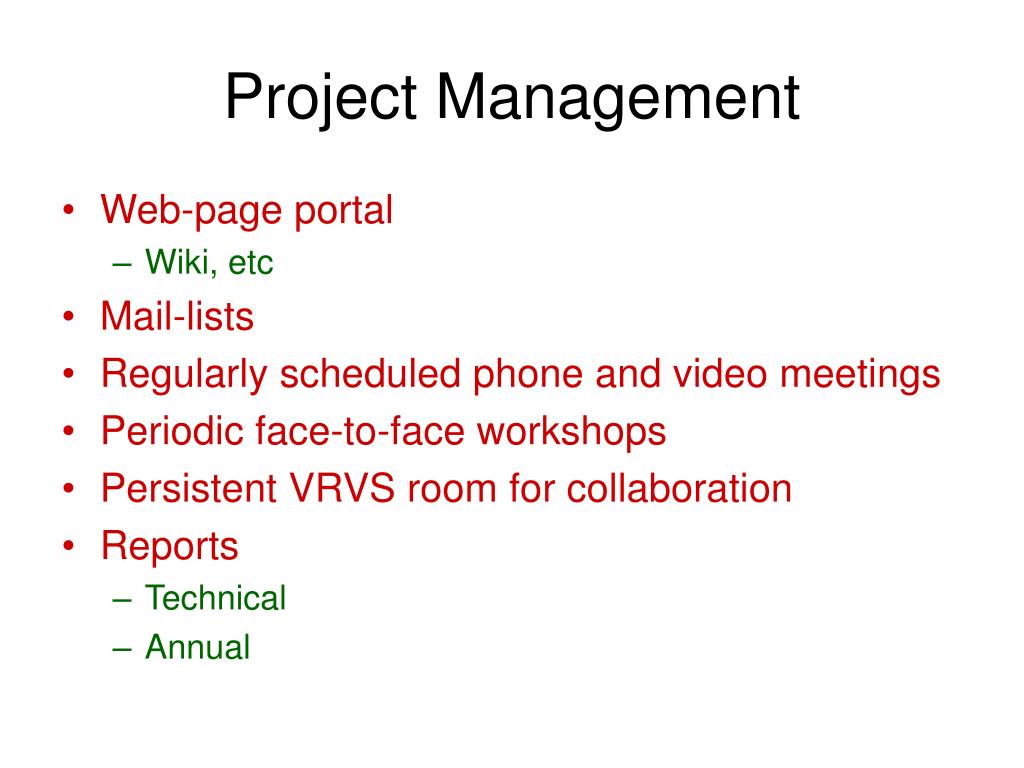

  10. Project Management • Web-page portal • Wiki, etc • Mail-lists • Regularly scheduled phone and video meetings • Periodic face-to-face workshops • Persistent VRVS room for collaboration • Reports • Technical • Annual

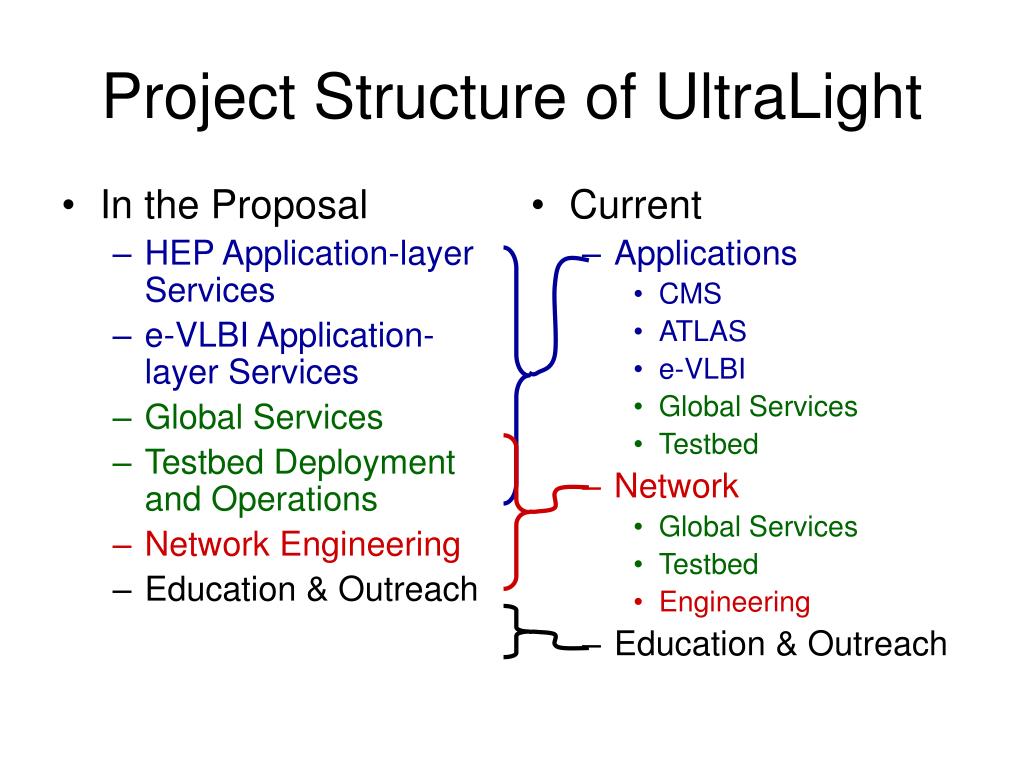

  11. In the Proposal HEP Application-layer Services e-VLBI Application-layer Services Global Services Testbed Deployment and Operations Network Engineering Education & Outreach Current Applications CMS ATLAS e-VLBI Global Services Testbed Network Global Services Testbed Engineering Education & Outreach Project Structure of UltraLight

  12. Connection between Application and Network Tech. Groups

  13. Project Plan • Short term • Longer term

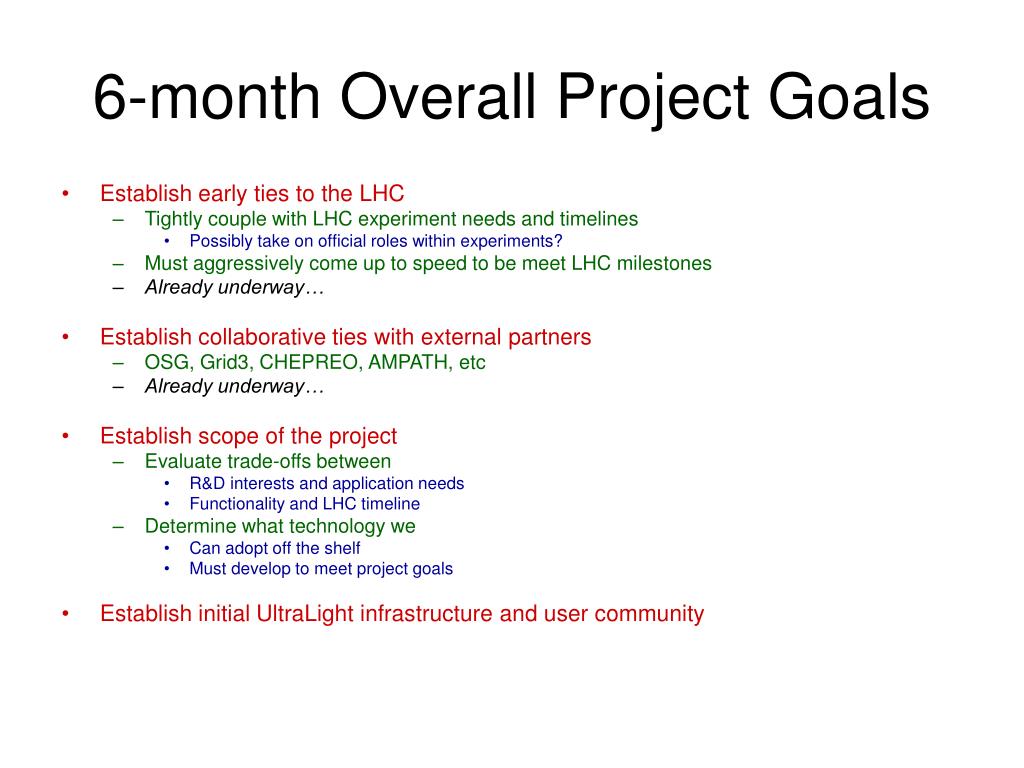

  14. 6-month Overall Project Goals • Establish early ties to the LHC • Tightly couple with LHC experiment needs and timelines • Possibly take on official roles within experiments? • Must aggressively come up to speed to be meet LHC milestones • Already underway… • Establish collaborative ties with external partners • OSG, Grid3, CHEPREO, AMPATH, etc • Already underway… • Establish scope of the project • Evaluate trade-offs between • R&D interests and application needs • Functionality and LHC timeline • Determine what technology we • Can adopt off the shelf • Must develop to meet project goals • Establish initial UltraLight infrastructure and user community

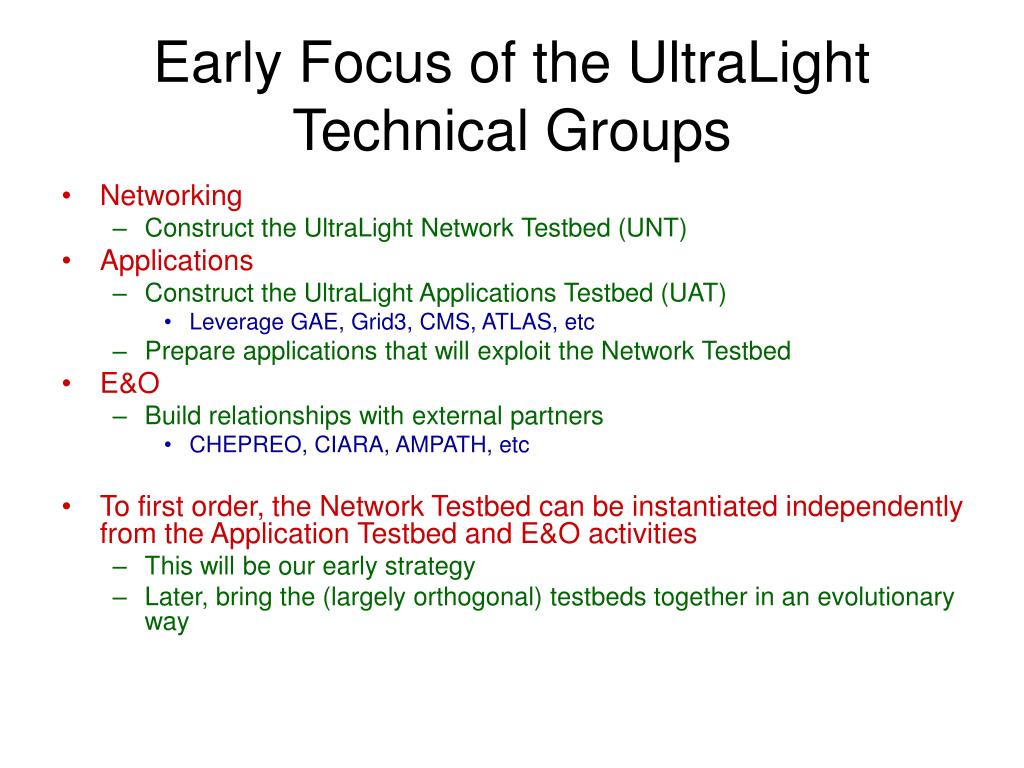

  15. Early Focus of the UltraLight Technical Groups • Networking • Construct the UltraLight Network Testbed (UNT) • Applications • Construct the UltraLight Applications Testbed (UAT) • Leverage GAE, Grid3, CMS, ATLAS, etc • Prepare applications that will exploit the Network Testbed • E&O • Build relationships with external partners • CHEPREO, CIARA, AMPATH, etc • To first order, the Network Testbed can be instantiated independently from the Application Testbed and E&O activities • This will be our early strategy • Later, bring the (largely orthogonal) testbeds together in an evolutionary way

  16. Longer Term Project Goals (past initial testbed building phase) • Global Services • Develop handles which monitor, control, and provision network resources • Manually at first, then move to automate • Close collaborative effort between Applications Group and Networking Group • Requires the that the UNT and UAT work together as a coherent whole • Combine to operate single UltraLight Testbed (UT) • Smooth transformation to UT expected as UNT and UAT activities are very complementary

  17. 6-month Network Goals • Inventory the different UltraLight sites • What are the current connections available at each site? • What type of switches, how many, and where are they located, etc? • Construct the UltraLight Network Testbed • Persistent development environment • Piece together all the different network components • Create the NOC Team • Begin thinking about disk-to-disk transfers • Interface with Storage Elements • Important for later integration work with Applications

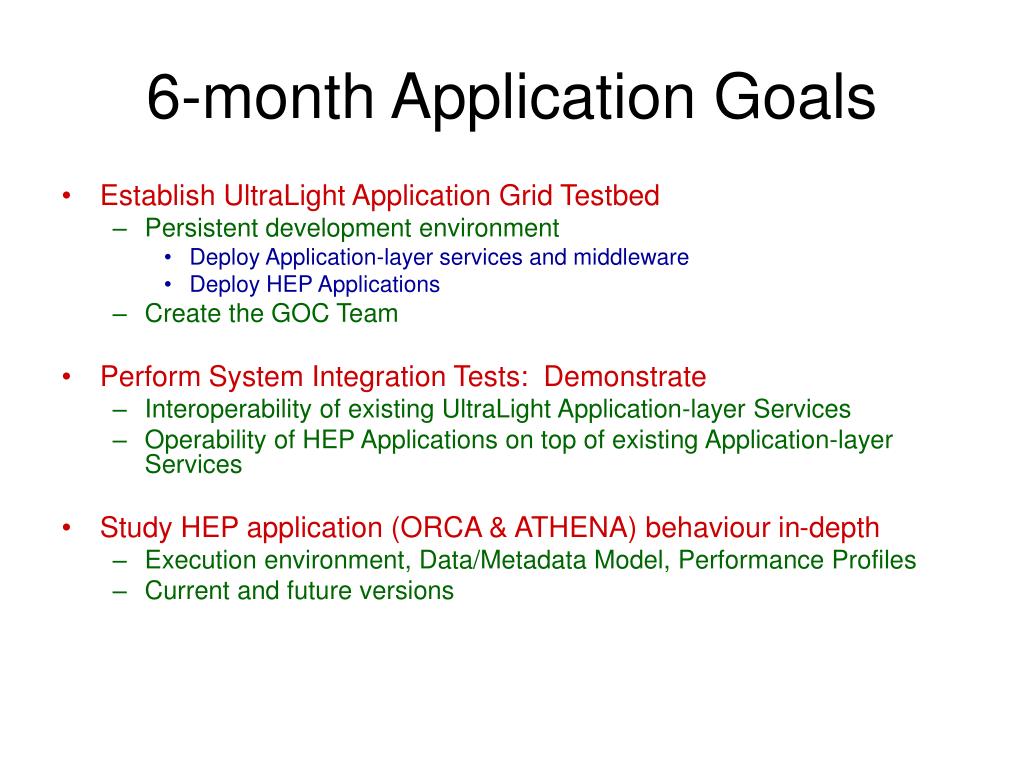

  18. 6-month Application Goals • Establish UltraLight Application Grid Testbed • Persistent development environment • Deploy Application-layer services and middleware • Deploy HEP Applications • Create the GOC Team • Perform System Integration Tests: Demonstrate • Interoperability of existing UltraLight Application-layer Services • Operability of HEP Applications on top of existing Application-layer Services • Study HEP application (ORCA & ATHENA) behaviour in-depth • Execution environment, Data/Metadata Model, Performance Profiles • Current and future versions

  19. 6-month E&O Goals • Earni and Fabian Network engineers • Networking to brasil • $ for E&O connected with CHEPREO • Julio and Heidi • EO (CHEPREO and UltraLight) • QuarkNet • Bring people together to do science • Community aspect

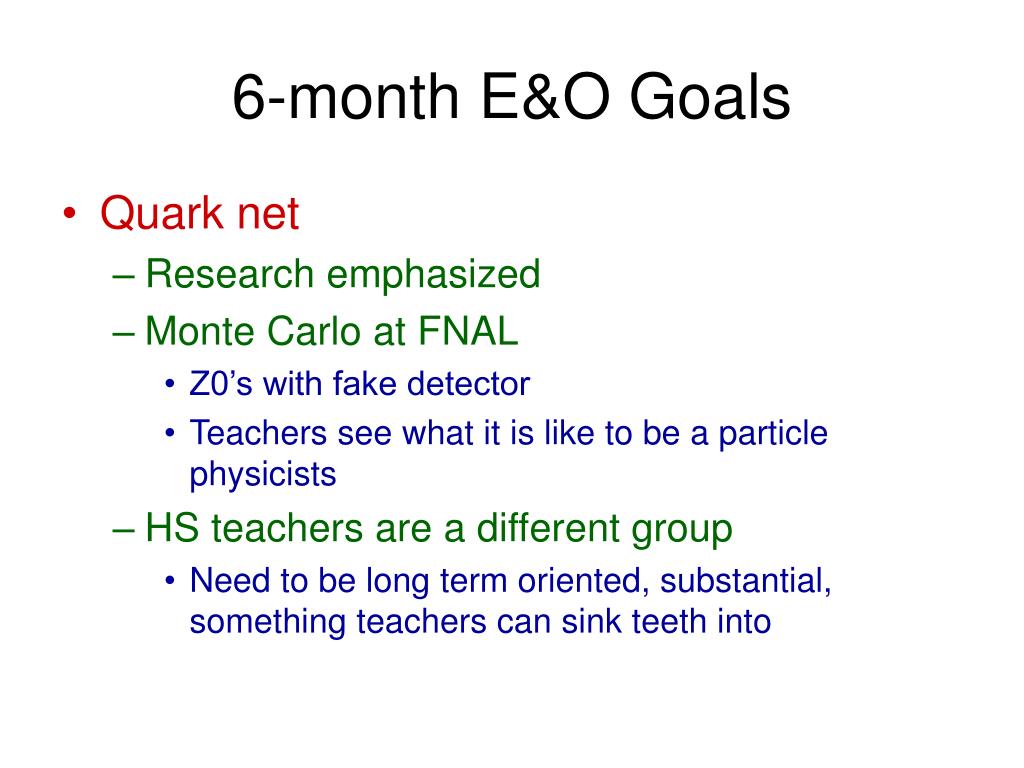

  20. 6-month E&O Goals • Quark net • Research emphasized • Monte Carlo at FNAL • Z0’s with fake detector • Teachers see what it is like to be a particle physicists • HS teachers are a different group • Need to be long term oriented, substantial, something teachers can sink teeth into

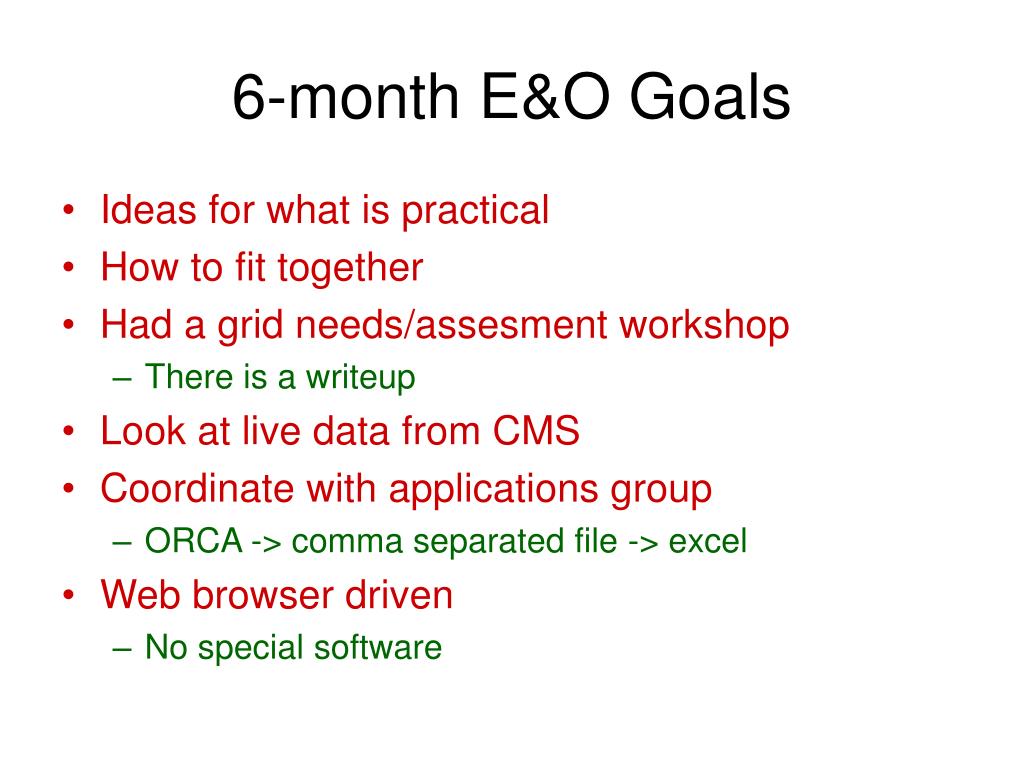

  21. 6-month E&O Goals • Ideas for what is practical • How to fit together • Had a grid needs/assesment workshop • There is a writeup • Look at live data from CMS • Coordinate with applications group • ORCA -> comma separated file -> excel • Web browser driven • No special software

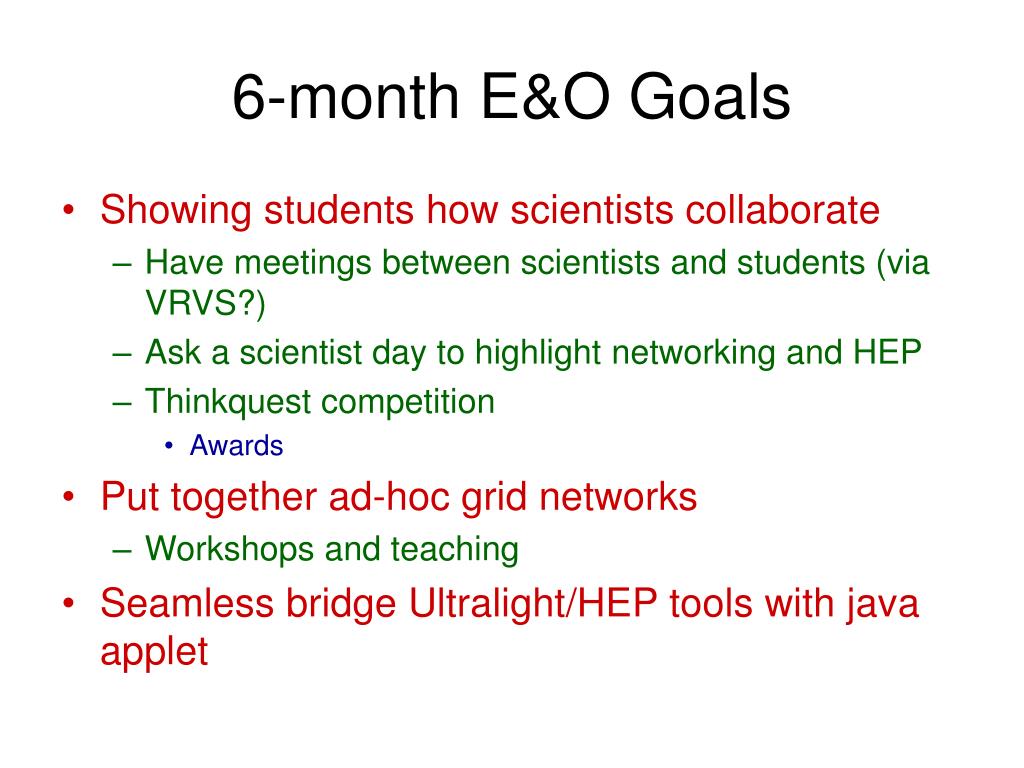

  22. 6-month E&O Goals • Showing students how scientists collaborate • Have meetings between scientists and students (via VRVS?) • Ask a scientist day to highlight networking and HEP • Thinkquest competition • Awards • Put together ad-hoc grid networks • Workshops and teaching • Seamless bridge Ultralight/HEP tools with java applet

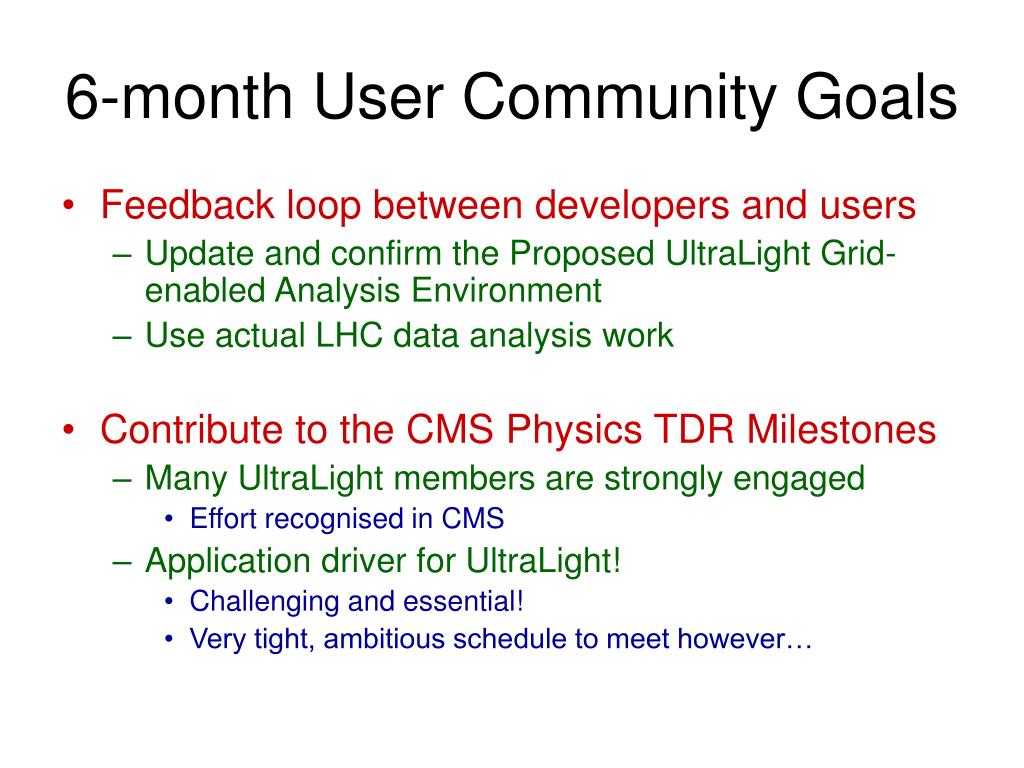

  23. 6-month User Community Goals • Feedback loop between developers and users • Update and confirm the Proposed UltraLight Grid-enabled Analysis Environment • Use actual LHC data analysis work • Contribute to the CMS Physics TDR Milestones • Many UltraLight members are strongly engaged • Effort recognised in CMS • Application driver for UltraLight! • Challenging and essential! • Very tight, ambitious schedule to meet however…

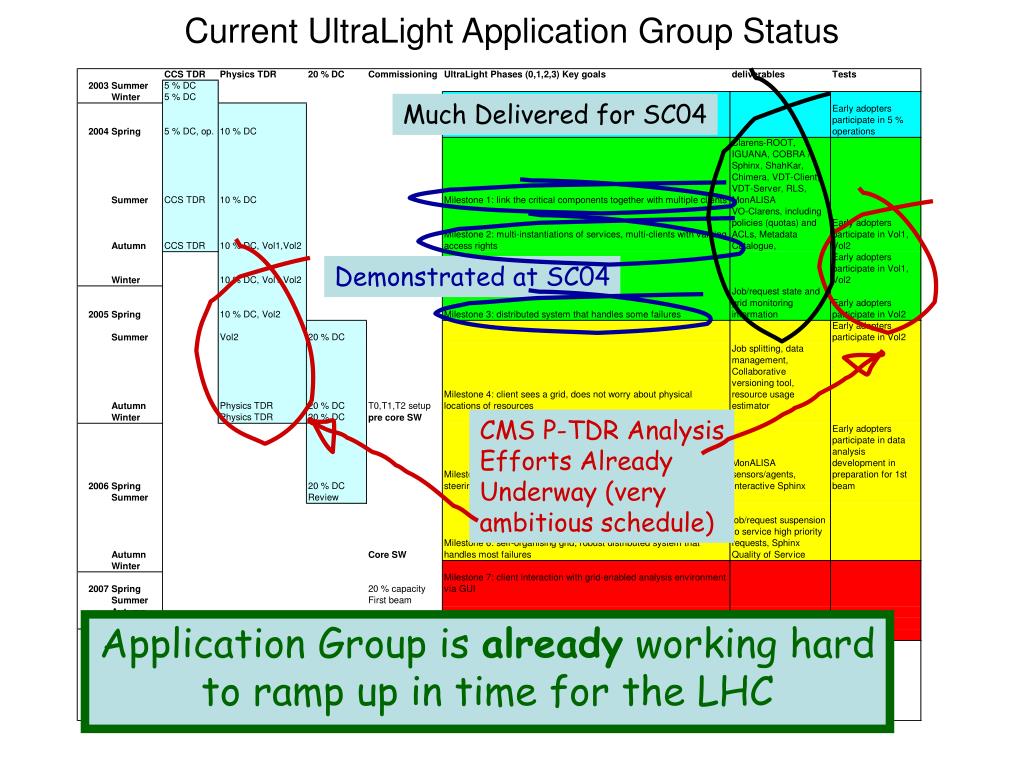

  24. Current UltraLight Application Group Status Much Delivered for SC04 Demonstrated at SC04 CMS P-TDR Analysis Efforts Already Underway (very ambitious schedule) Application Group is already working hard to ramp up in time for the LHC

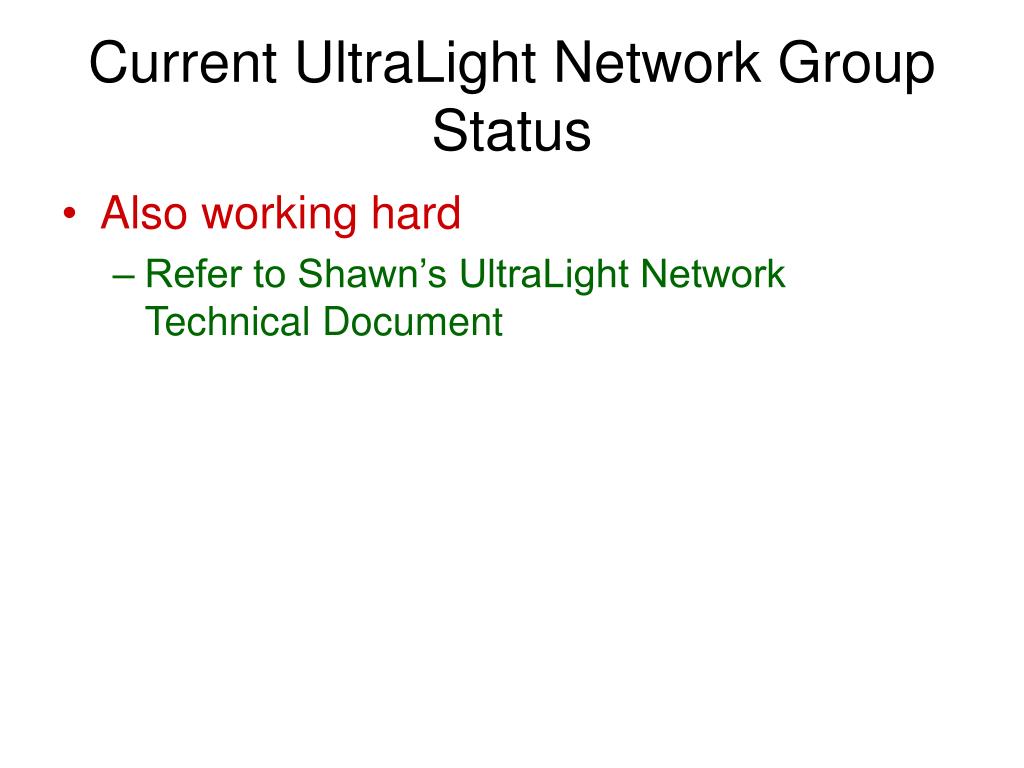

  25. Current UltraLight Network Group Status • Also working hard • Refer to Shawn’s UltraLight Network Technical Document

  26. Major Milestones over the Next 6 Months • Dec • Initial UltraLight Collaboration Meeting at CIT • Jan • UltraLight Week at CIT: UltraLight Applications Testbed Started • Feb: CMS PRS Meeting • UM connects to MiLR, UF connects to FLR • Mar: CMS Week • FLR declared to be “Production” • Apr: • May: CMS CPT Week • First round of CMS approvals for analyses to enter P-TDR • Jun: CMS Week • UltraLight Meeting (UM?): UltraLight Network Testbed in place

  27. Major Project Milestones

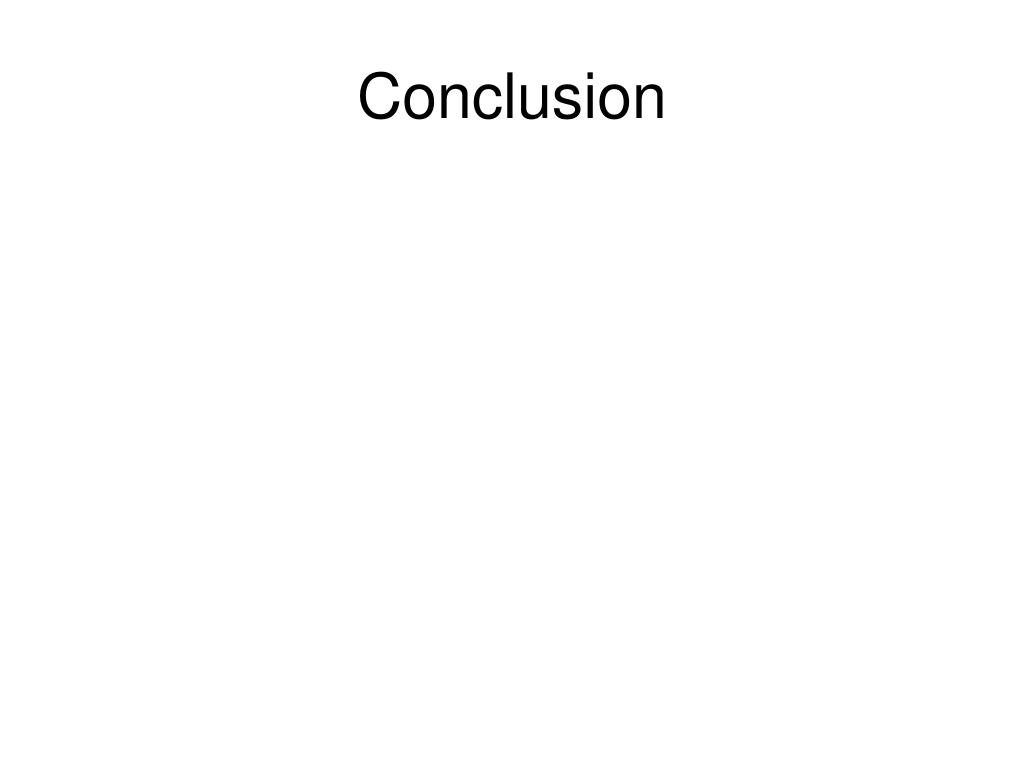

  28. Conclusion

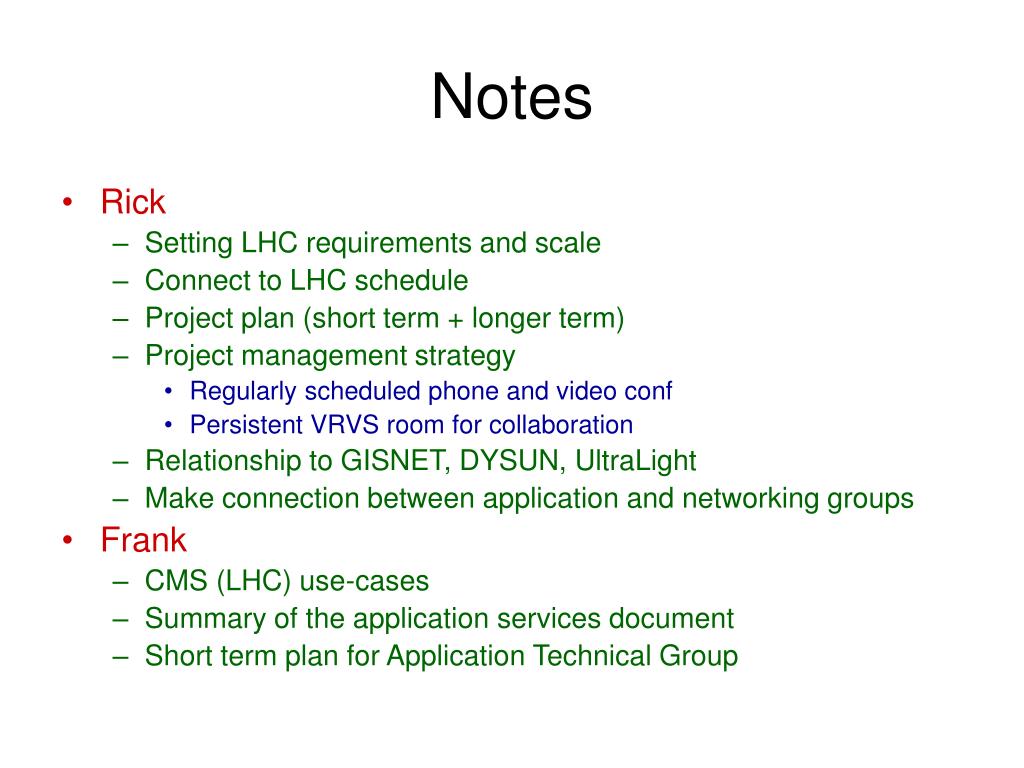

  29. Notes • Rick • Setting LHC requirements and scale • Connect to LHC schedule • Project plan (short term + longer term) • Project management strategy • Regularly scheduled phone and video conf • Persistent VRVS room for collaboration • Relationship to GISNET, DYSUN, UltraLight • Make connection between application and networking groups • Frank • CMS (LHC) use-cases • Summary of the application services document • Short term plan for Application Technical Group
