1 / 17

Next Steps and Priorities

G. Schneider. Next Steps and Priorities. BI Beamline Operational Spares Strategy. Next Steps and Priorities. Complete identification of What do we have ? Proirities What do we need ? Logistics How can we organise it ? Next steps Identify required manpower , cost and time.

doane
Télécharger la présentation

Next Steps and Priorities

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. G. Schneider Next Steps and Priorities BI Beamline Operational Spares Strategy G. Schneider BE-BI

  2. Next Steps and Priorities • Complete identification of • What do we have? • Proirities • What do weneed? • Logistics • How canwe organise it? • Nextsteps • Identifyrequiredmanpower, cost and time G. Schneider BE-BI

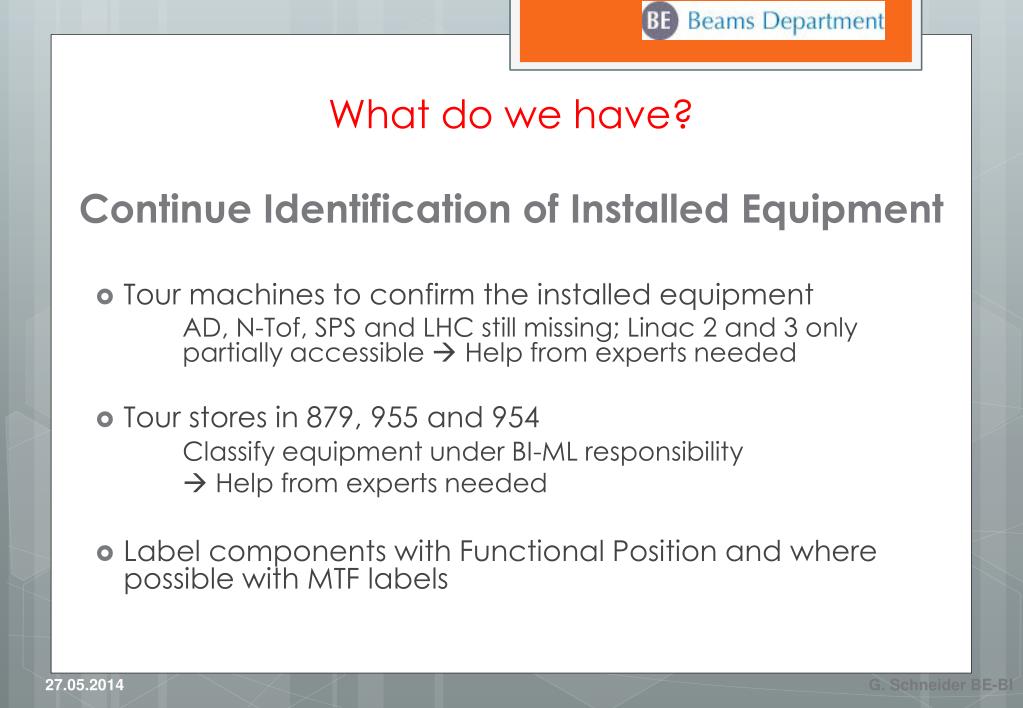

  3. Tour machines to confirm the installed equipment AD, N-Tof, SPS and LHC still missing; Linac 2 and 3 only partially accessible  Help from experts needed • Tour stores in 879, 955 and 954 Classify equipment under BI-ML responsibility  Help from experts needed • Label components with Functional Position and where possible with MTF labels What do we have?Continue Identification of Installed Equipment G. Schneider BE-BI

  4. What do we have?Complete OP lists • Priority on LHC injector chain instruments LINAC 2, LINAC 3 and LEIR are still missing • Complete other machines: AD, N-Tof, North area, ISOLDE… G. Schneider BE-BI

  5. What do we have?Drawing availability • Missing drawings available on paper? • Missing drawings available on Microfilm? G. Schneider BE-BI

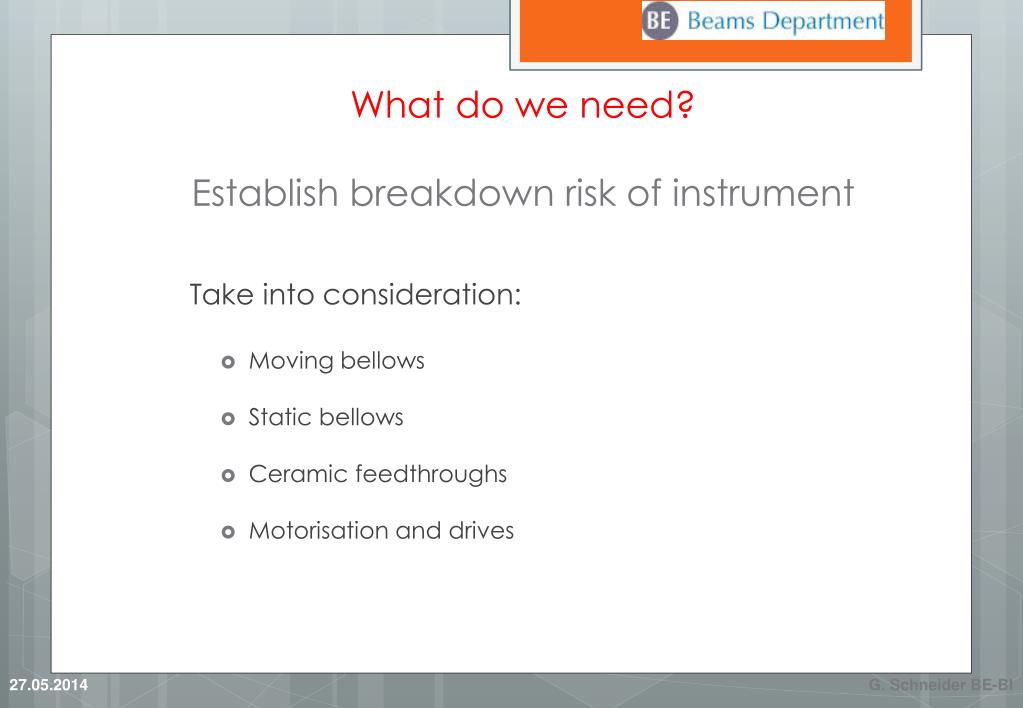

  6. What do we need?Establish breakdown riskof instrument Take into consideration: • Moving bellows • Static bellows • Ceramic feedthroughs • Motorisation and drives G. Schneider BE-BI

  7. What do we need?Establish risk matrixby comparing OP impactversus failure risk G. Schneider BE-BI

  8. What do we need?Drawing Availability Bring drawings in CDD with agreed Equipment Code: • Scan microfilm according to priority list • Top assemblies • Detailed drawings • Check with colleagues if paper drawings are available • Make transfer into CDD G. Schneider BE-BI

  9. How can we organise it?Enter components is System G. Schneider BE-BI

  10. How can we organise it?Enter components is System G. Schneider BE-BI

  11. How can we organise it?Let the system know what and where you have e.g. bananas (or motor, screen, BPM…) Pre-requirements: Drawing or description • MTF (Manufacturing and Test file) is the interface for machined or assembled components • EAM light(Enterprise Asset Management) is the interface for stores management • Both MTF or EAM come from the same database Industry started to do this 20 years ago: ISO 9000 G. Schneider BE-BI

  12. How can we organise it?What is the big job? • Know what you have installed where • Know what is the corresponding drawing including sub-assemblies • Know what you have in stock G. Schneider BE-BI

  13. How can we organise it?What do we need? • Some infrastructure • Agreed storage spaces Everybody stores equipment in the office, local store or lab, centralised lab, which combination? • Think to which level you want to go with the stores and stock management • Training and agree to use the system both for newcomers and experienced staff G. Schneider BE-BI

  14. Powerfull tools availavle at CERN today • Example from EN-HE stores inventory G. Schneider BE-BI Courtesy: C. Hazelaar-Bal

  15. Next Steps1. Be ready for corrective maintenance • Make priority list of instruments following risk matrix • Project planning: • Estimate design and design management manpower needed • Establish list of components to be ready on shelf • Establish list of vacuum replacement chambers • Estimate the cost From experience from TE-VSC and EN-HE: Several years in time and 5 to 10 man-years • Project execution • Ensure drawing availability for Performance, Set-up and Operational instruments • Identify or procure spare vacuum chambers • On-shelf availability for critical components • Set-up stores management system: Know where everything is kept • Removal of obsolete instruments from machines G. Schneider BE-BI

  16. Next Steps2. Work towards preventive maintenance • Collect data on instrument usage • Movements • Service intervals • Replacement intervals • Integral radiation dose • Stores system G. Schneider BE-BI

  17. Thank you G. Schneider BE-BI
