Task Analysis is Part of Planning

Task Analysis is Part of Planning. Once we have completed planning on the deliverables and contents of the deliverables , we need to plan out “how to accomplish” the deliverables. Task Analysis. Task analysis is domain dependent : build a desk plant a tree write computer program

efuru
Télécharger la présentation

Task Analysis is Part of Planning

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Task Analysis is Part of Planning Once we have completed planning on the deliverables and contents of the deliverables, we need to plan out “how to accomplish” the deliverables

  2. Task Analysis • Task analysis is domain dependent: • build a desk • plant a tree • write computer program • build a road • make a spaghetti dish • Software project task analysis is no different • you need domain knowledge to do this well • computer science • software engineering • information technology • possibly application domain Task Analysis: Defining and Sequencing the sub-activities of a Task

  3. From Requirements to Work Breakdown Structure (WBS) Note: date is purposely not included, yet • We get 2 sets of information from Requirements: • required deliverables to the customers • descriptions about those deliverables • The first “high level” task of sequencing the required customer deliverables may seem simple, but --- consider the example listed for a project: • code • user guide • support plan • development process document WBS: - is the listing and sequencing of the work activities needed to produce the required deliverables. (Note that there may be concurrent activities.) - a way to do Task Analysis

  4. External Deliverables of A Project code user guide Support plan consider these develop. Process doc

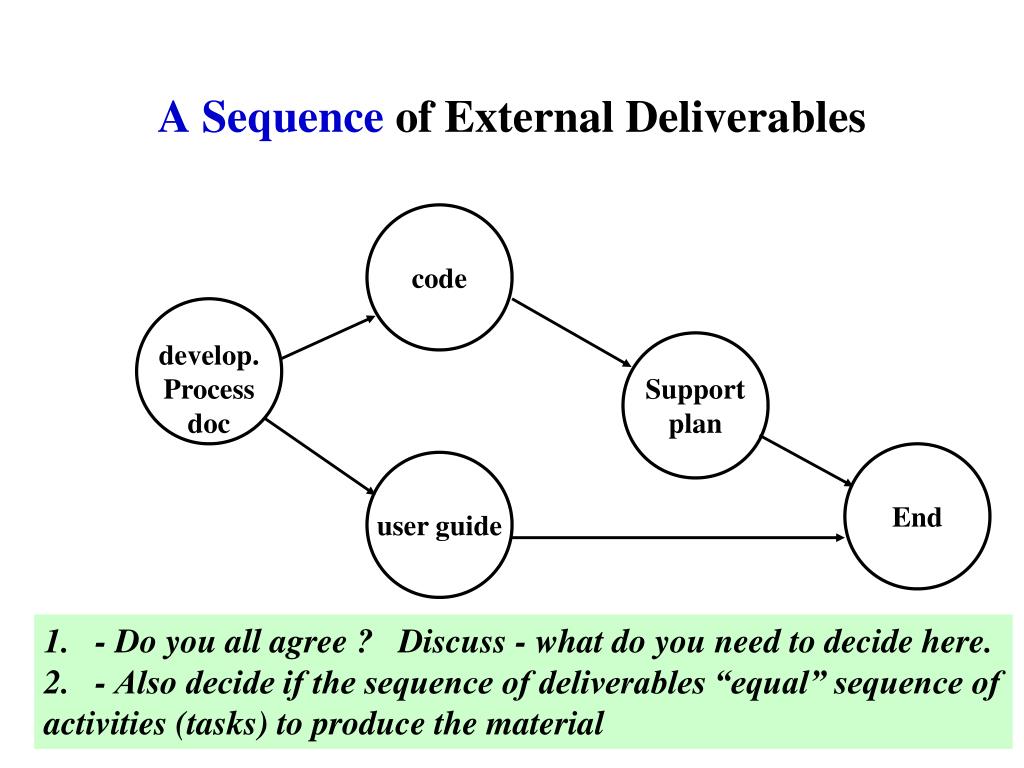

  5. A Sequence of External Deliverables code develop. Process doc Support plan End user guide - Do you all agree ? Discuss - what do you need to decide here. - Also decide if the sequence of deliverables “equal” sequence of activities (tasks) to produce the material

  6. Representing in “Schedule” form Deliverables became Tasks ! New parameter Resp. May June July Tasks Proc Gw All the same length and no overlap Code Gx User Guide Gy S.Plan Gz

  7. Effort Analysis • Estimation of “Effort” for each deliverable • need to understand the subtasks required to produce the deliverable and any intermediate deliverables that may be required • need to break it (deliverable/task) down more • by sub-components • to the level where : • one person can do the task • skill of the person can be described • actual task can be described and size estimate has some comparable “past history” or “algorithm” • a common measurement: effort = size/productivity How important are these?

  8. A Deeper Work Breakdown Structure (WBS)for “Developing” A Support Plan Interview Customer for input Analysis and Develop Outline Develop the whole Plan Review with Customer Not O.K. O.K. 1 cycle only Final Review End

  9. Effort Analysis & A Deeper Work Breakdown Structure (WBS) of “Developing” A Support Plan * note Interview Customer for input Analysis and Develop Outline p-day estimate based on the assumptions: 1. size of (how much) work is estimated. 2. Productivity of the assigned person 3 p-days 1/2 p-day Develop the whole Plan Review with Customer O.K. 1/2 p-day 5 p-days 1/2 p-day ** - Do not forget about wait time - how many people are required ? - what kind of skill & background ? Final Review End 1/2 p- day

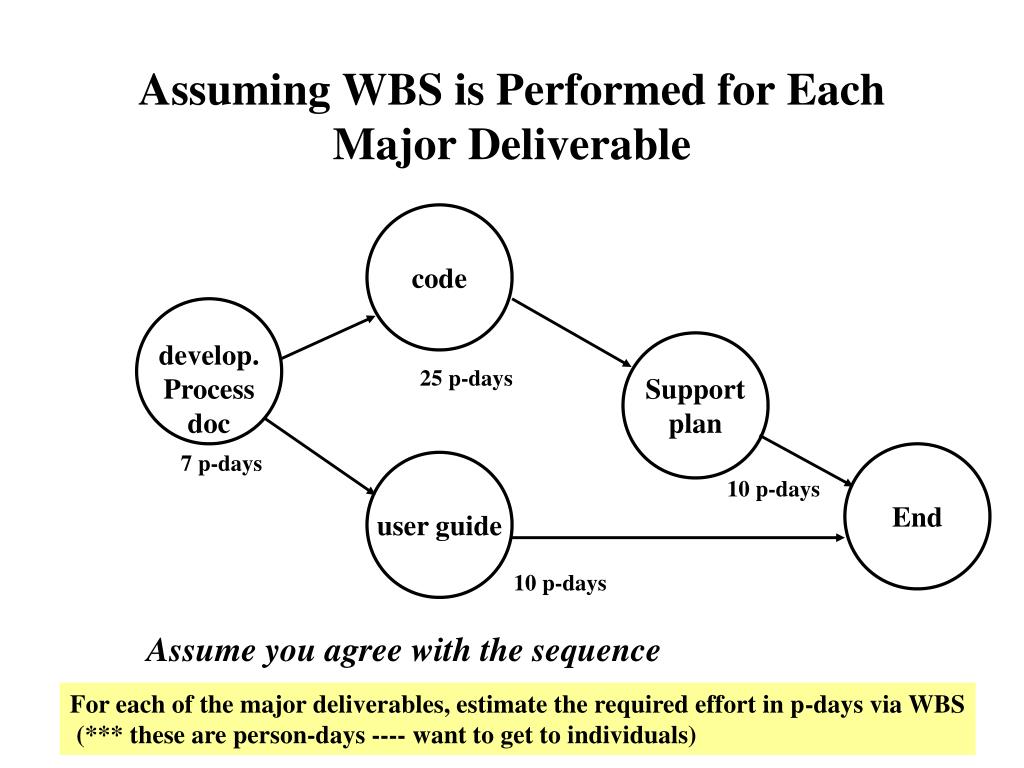

  10. Assuming WBS is Performed for Each Major Deliverable code develop. Process doc Support plan 25 p-days 7 p-days End user guide 10 p-days 10 p-days Assume you agree with the sequence For each of the major deliverables, estimate the required effort in p-days via WBS (*** these are person-days ---- want to get to individuals)

  11. Improving on Task “Schedule” Having chosen specific resources Resp. May June July Tasks Proc Overlapping, different length Gw Code Gx User Guide Gy S.Plan Gw

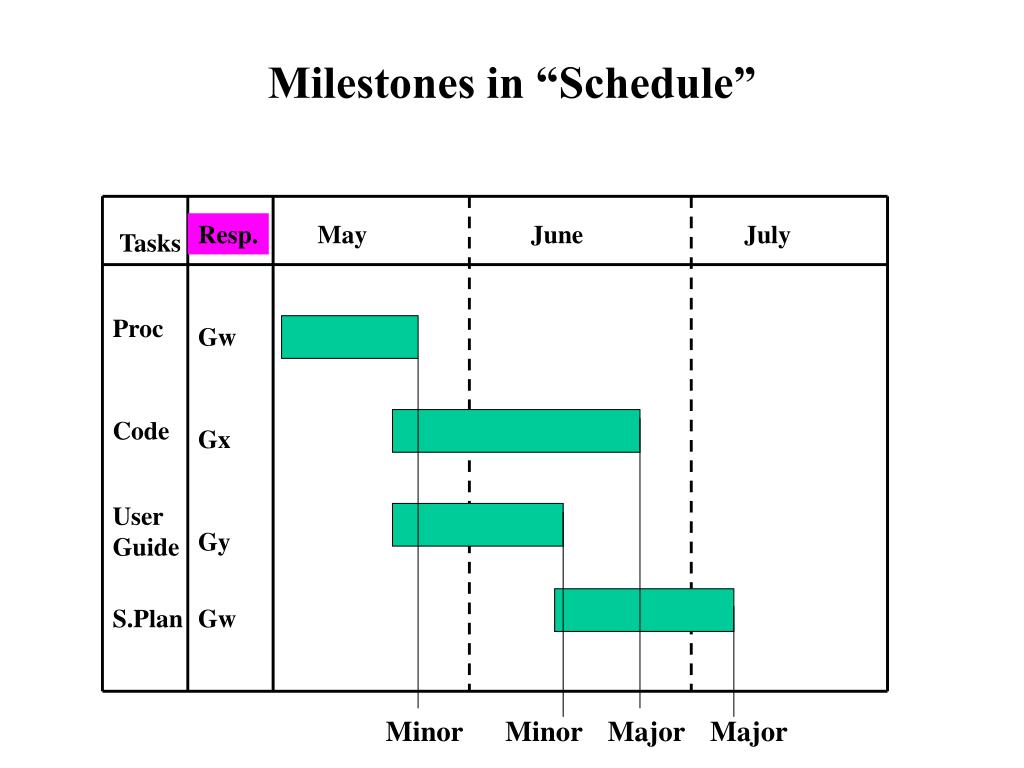

  12. Milestones in “Schedule” Resp. May June July Tasks Proc Gw Code Gx User Guide Gy S.Plan Gw Minor Minor Major Major

  13. General flow of WBS to Timeline Schedule Identify the deliverables For each deliverable: identify the tasks for completing the deliverable Sequence the tasks • For each task: • Estimate the productivity • of the assigned resource • for effort analysis • For each task: • Estimate the needed • size of work for effort • analysis For each task: compute the “effort” timeline for that task by dividing size of work by productivity After all the effort for all the tasks for all the deliverables are computed do following step Lay out the effort timeline for all the ordered tasks needed for each of the deliverables
