MEGAPROJECT Case Study

MEGAPROJECT Case Study. Case compiled by: ....Jonas Wennström. Contact details: ...jonas.wennstrom@vti.se. Basic Project Information. SECTION 1 - BASIC PROJECT INFORMATION. MEGAPROJECT Stakeholder Identification (Internal) . SECTION 2 - PROJECT STAKEHOLDERS.

garron
Télécharger la présentation

MEGAPROJECT Case Study

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

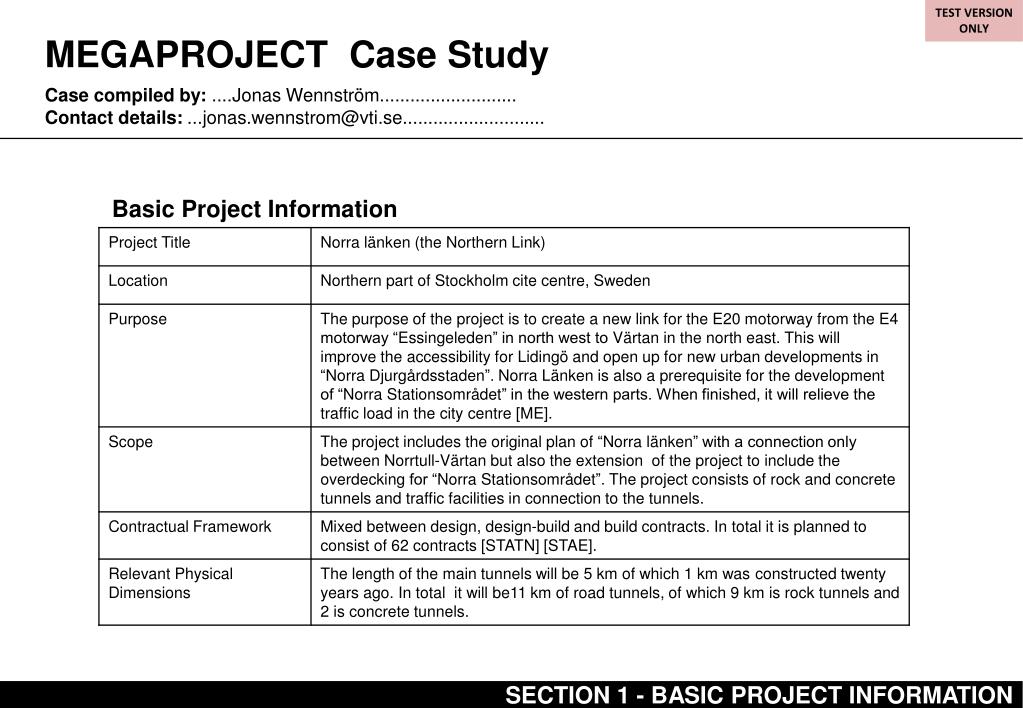

  1. MEGAPROJECT Case Study Case compiled by: ....Jonas Wennström........................... Contact details: ...jonas.wennstrom@vti.se............................ Basic Project Information SECTION 1 - BASIC PROJECT INFORMATION

  2. MEGAPROJECT Stakeholder Identification (Internal) SECTION 2 - PROJECT STAKEHOLDERS

  3. MEGAPROJECT Stakeholder Identification (External) SECTION 2 - PROJECT STAKEHOLDERS

  4. MEGAPROJECT Stakeholder Relationship Maps Ministry of Finance Swedish government Swedish parliament County Administrative Boards of Sweden Supreme Administrative Court of Sweden Stockholm Municipality MEEC Public Finances 75 % Finances 25% Environmentalists STA (client) Public participation Road users Contracts with Build/”Design Build” 62 contracts Design Operation ? Ramböll WSP Grontmij PEAB Skanska Svevia Hochtief Veidekke Bilfinger-Berger Züblin-Pihl Bravida Key: - Project Actor - Project Relationship Subconsultants Subcontractors Description of relationship SECTION 2 -PROJECT STAKEHOLDERS

  5. MEGAPROJECT External Stakeholder Attitude Analysis SECTION 2 - PROJECT STAKEHOLDERS

  6. MEGAPROJECT Project Management Project Organisation Project Tools and Techniques Please √ if present, x if absent , leave blank if unknown Life-Cycle Costing Approaches □ Project Management Software □Y Lessons Learnt Transfers □ Stakeholder Involvement □Y[VV05] Relationship Management Tools □ Team Building Tools □ Building Information Modelling (BIM) □Y[BIM] Project Knowledge Management Tools □ Competency framework □ Other Tools and Techniques or More Information For the design procurements , requirement of all drawings should be presented in 3D based on experiences from the Southern Link project [3DP]. SECTION 3 - PROJECT MANAGEMENT

  7. Project Processes SECTION 3 - PROJECT MANAGEMENT

  8. MEGAPROJECT Project Performance Aspects of Performance Concerned with Doing the Project Right SECTION 4 - PROJECT PERFORMANCE

  9. Aspects of Performance Concerned with Doing the Right Project SECTION 4 - PROJECT PERFORMANCE

  10. MEGAPROJECT Project Environment Legal and Regulatory Environment Political Environment SECTION 5 - PROJECT ENVIRONMENT

  11. MEGAPROJECT Project Environment Economic Environment SECTION 5 - PROJECT ENVIRONMENT

  12. MEGAPROJECT Project Key Events and Activities Timeline TIME Aug 1996 Jan 1997 60’s 1991 2005 2007 2009 2006 2008 2010 2011 Current development Events before current development Extension of project with”Norra stationsområdet” Breakthrough in tunnel boring Design & Procure. Project halt Start of rock tunnel construction Completion of Karlberg - Norrtull Ring road discussions Events in project Contracting NL12 : PEAB NL11 : Skanska NL31 : Züblin NL22 : BB NL33 : Veidekke Working tunnels NL34 : Veidekke NL35 : Hochtief & Oden NL51 : Hochtief & Oden NL41 : PEAB NL62 : Veidekke NL52 : Skanska N66 : TE AB N67 : Bravida N68 : Bravida N69 : Läckeby N72 : Bravida Change in the ”Environmental Code” regarding temporary works in National Parks Political acceptance Appeal against project rejected, full project legally accepted Events in environment Hard to find labour [REF?] Economic recession SECTION 6 - PROJECT TIMELINE

  13. References • [STAFAQ] Trafikverket: Frågor och svar. http://www.trafikverket.se/Privat/Projekt/Stockholm/E20-norra-lanken/Fragor-och-svar/ • [ME] Genomslaget klart - asfalteringen börjar http://www.me.se/Tidning/Branschnytt/20111/Nomvember/Genomslaget-klart---asfalteringen-borjar/ • [IN] Genomslag för Norra Länken. Infrastrukturnyheter. http://www.infrastrukturnyheter.se/2011/12/genomslag-i-norra-l-nken • [3D] ”Väg- och vattenbyggaren”. Volume 4. 2006 • [BIM] Trafikverket. Stefan Engdahl. • [VV05]. Norrtullsområdet. Vägverket. 2005. • [GA] Startklart för Norra länken, Svenska Dagbladet 6 april 2006 • [BV09] Byggare kan börja gräva för Norra länken. 2009. http://www.byggvarlden.se/nyheter/byggprojekt/article87866.ece • [RA] The Road Act SFS 1971:948. http://www.notisum.se/rnp/sls/lag/19710948.htm • [EC] The Environmental Code 1998:808 • [STATN] http://www.trafikverket.se/Privat/Projekt/Stockholm/E20-norra-lanken/Delprojekt-i-Norra-lanken/Tomteboda--Karlberg/ • [STAE] Entreprenader, tecknade kontrakt. http://www.trafikverket.se/Privat/Projekt/Stockholm/E20-norra-lanken/Om-projektet/Entreprenader-Tecknade-kontrakt/ • [STAA] http://www.trafikverket.se/Privat/Projekt/Stockholm/E20-norra-lanken/Om-projektet/ • [3DP] 3D-projektering – framtiden i vägbyggnadssektorn? . Rasmus Regnstrand. Master thesis. 2011. • [IN10] Snabbt driv i Norra länken. Infrastrukturnyheter. http://www.infrastrukturnyheter.se/2010/02/snabbt-driv-i-norra-lanken
