An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. State Route 99 Corridor Update Kome Ajise District 10 Director Caltrans

  2. SR 99 Business Plans • 424 Miles of SR 99 In Central Valley • State Route 99 Business Plan San Joaquin Valley • 274 miles in Districts 6 and 10 • Route 70/99 Corridor Business Plan Sacramento Valley • 150 miles in Districts 2 and 3

  3. SR 99 Business Plan(San Joaquin Valley) • Plan Covers SR 99 South Of The Sacramento/San Joaquin County Line • Priority Category 1 • Freeway Conversion (4 projects) • Priority Category 2 • Capacity Increasing Projects (25 projects) • Priority Category 3 • Major Operational Projects (34 projects) • Priority Category 4 • New Interchanges (4 projects)

  4. SR 99 Business Plan Funding Phases • 20 Year Funding Program • Three Funding Phases ($6 Billion) • Phase 1 - $1.0 B - Completes Category 1 and part of Categories 2 & 3 • Phase 2 - $3.0 B - Completes Category 2 • Phase 3 - $2.0 B - Completes Categories 3 & 4

  5. SR 99 Business Plan Objectives • Performance Objective • Level Of Service “C” in rural areas • Level Of Service “D” in urban areas • Facility Objective • Minimum 6 lane freeway • 115 of the 274 miles currently meet objective • Objective is fully met in Kern and Stanislaus • Driver Experience Objective • Visually attractive corridor • SJ Valley identity and sense of place

  6. SR 99 Business Plan Progress • 1st WAVE: 5 widening projects currently in construction phase • Adds 17 miles of 6 lane freeway • Results in 48% of corridor attaining 6F • 2nd WAVE: 7 projects funded by Prop 1B funds • Adds another 44 miles of 6 lane freeway • Will result in 64% of corridor attaining 6F

  7. SR 99 Dist 6 Transportation Concept Report SR 99 Dist 10 Transportation Concept Report Enhancement Plan + Business Plan = SR 99 CorridorMaster Plan Regional Transportation Plans (RTP) Interregional Transportation System Plan (ITSP) Partnership (Caltrans, GVC, Kern COG, Tulare CAG, Fresno COG, Madera CTC, Merced CAG, Stanislaus COG, San Joaquin COG)

  8. Master Plan Update …Next Steps • Prepare Work Plans For Updates • Business Plan and Enhancement Plan Elements • Technical Updates • Business Plan and Enhancement Plan Elements • Corridor Financial Plan • Project Implementation Agreements • Enhancement Plan Advisory Committee

  9. Route 70/99 Business Plan(Sacramento Valley) • Plan Covers North Of The Sacramento/San Joaquin County Line • Route 70/99 Business Plan Priorities • Shared Funding Plan • Safety component • Mainline capacity • Expressway conversion

  10. Route 70/99 Priority Categories • Priority Category 1 ($524 M) • Programmed Safety, Capacity and Expressway Conversion (10 projects) • Priority Category 2 ($273 M) • Programmed Safety, Capacity and Expressway Conversion (11 projects) • Priority Category 3 ($681 M) • Planned Projects (34 projects) • Priority Category 4 (TBD) • Future Projects (40 projects)

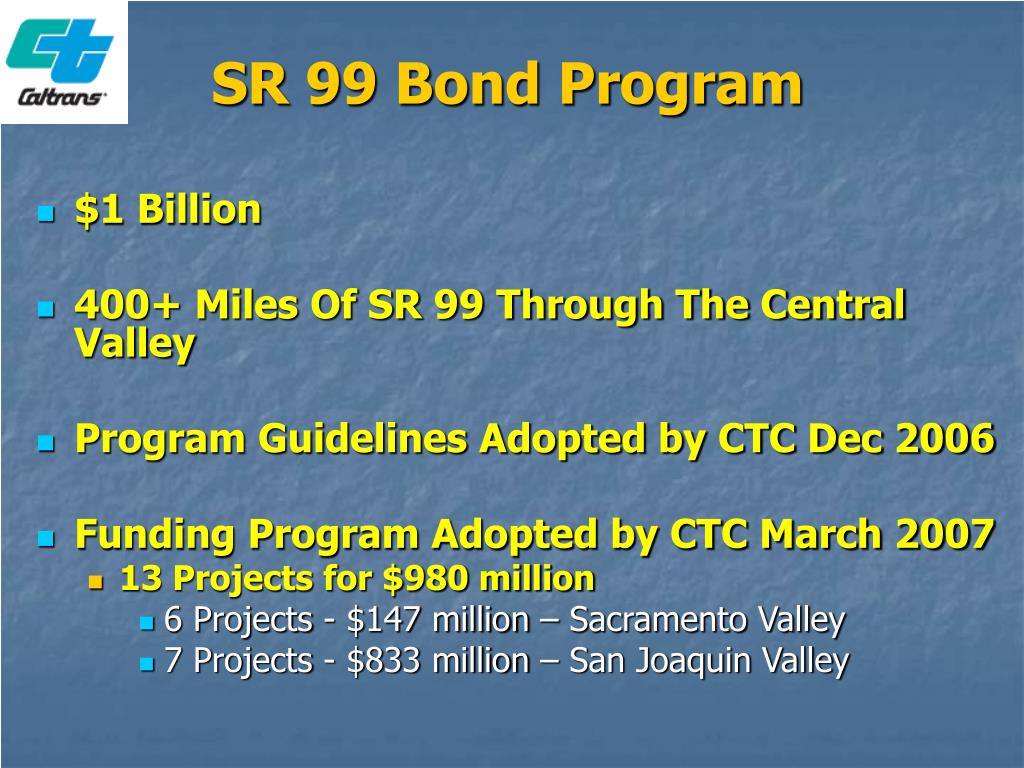

  11. SR 99 Bond Program • $1 Billion • 400+ Miles Of SR 99 Through The Central Valley • Program Guidelines Adopted by CTC Dec 2006 • Funding Program Adopted by CTC March 2007 • 13 Projects for $980 million • 6 Projects - $147 million – Sacramento Valley • 7 Projects - $833 million – San Joaquin Valley

  12. SR 99 Bond Program Expected Results… • 44 Miles of 6-lane Freeway • 3.3 Miles of 4-lane Conventional Highway • 2 New Interchanges • 1 Reconstructed Interchange • 2.5 Miles of Aux. Lanes and Operational Improvements

  13. SR 99 Bond Program * Construction Starts

  14. Questions?
