1 / 23

Highlights from the FEMP Advanced Metering Workshop

Highlights from the FEMP Advanced Metering Workshop. September 25, 2003 Golden, Colorado. Overview. Discuss guidance development process and structure Describe Advanced Metering technology Build a business case Discuss costs, strategies, and savings Consider government case studies.

hija
Télécharger la présentation

Highlights from the FEMP Advanced Metering Workshop

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. Highlights from the FEMP Advanced Metering Workshop September 25, 2003 Golden, Colorado

  2. Overview • Discuss guidance development process and structure • Describe Advanced Metering technology • Build a business case • Discuss costs, strategies, and savings • Consider government case studies

  3. Guidance Development Process • Form an Ad Hoc Meeting Committee (AHMC) • Composed of attendees at the workshop • Gather input from agencies and private sector regarding • Potential benefits • Better energy management • Improved O&M, cost savings • Improved security • Resources • Constraints on appropriated funds • Limitations on personnel • Use of Alternative Financing • AHMC will present Draft Guidance to the Interagency Energy Task Force (IAETF) • IAETF develops Consensus Guidance • Consensus Guidance reviewed by 656 Committee • DOE Secretary issues Guidance Carr, 2003

  4. Produce a flexible framework that helps guide agencies when they develop specific implementation plans. Agency implementation plans should consider Specific constraints Opportunities Energy program management benefits Produce a screening process that identifies the cost- effective application of metered data, such as: Energy unit costs Ability to respond to demand and charges Bill aggregation Total annual costs Energy intensity per square foot Potential energy savings projects Guidance Development: Structure Ream, 2003

  5. Exemptions granted on the basis of security or economic justification based on the lack of savings to cover the costs. Metering program reporting should be made through a simple change to the existing annual agency energy report. Metering should eventually include all energy sources (and water as economically appropriate) for which data use could result in better resource management. Guidance Development: Structure Ream, 2003

  6. Sub-metering can include any meters on a multi-building facility beyond the utility revenue meter, or metering of large energy users in an individual building Initial phases Access to existing utility revenue meter pulse data Metering of obviously significant buildings using rules of thumb, e.g. annual energy use over $X0,000 Guidance Development: Structure Ream, 2003

  7. Guidance should outline a phased effort to start with easily implemented, cost-effective projects, and the use of early experience to refine follow-up efforts. Follow-up phases Identify and prioritize additional meter installation through a cost -benefit analysis based on assessment of the specific metering costs and related potential savings. Guidance Development: Structure Ream, 2003

  8. Utility Time-of-use billing Demand response Automated meter reading Distribution load management Energy management Benchmark, target Analyze loads Manage peak demand Measurement & Verification Facility management Power quality Emergency / condition alerts Maintenance diagnostics Combine multiple BMS Financial management Load aggregation Cost allocation Budgeting, forecasting and reporting Purposes of Advanced Metering Burns, 2003

  9. Hardware Advanced “smart” meter Interval measurements Communication ability Sub-meter Separate loads by buildings, floors, etc. What to meter Electricity, natural gas, water, steam Software Data presentation Data analysis Gateways Data collection Communication Data format Transmission System Security, data storage and management Advanced Metering Technology Burns, 2003

  10. Building a Business Case • Costs, benefits, issues, what-if’s • Comes before RFP • Yet needs feedback from RFP for cost calculation • Determine needs • Satisfy whom? • Facility manager • Energy manager • Financial manager • Determine goals • Identify data sources Burns, 2003

  11. Building a Business Case • Costs easy to underestimate • Hardware • Who owns, inventory • Software (presentation) • Data collection (communication) • Data storage, system management • Internal IT, outsourced ASP, SLA Burns, 2003

  12. Building a Business Case • Costs, continued • Installation, integration, project management • Turnkey solution, internal team costs, onsite labor • Training, evaluation • Ongoing • Data collection (communication) • Maintenance, updates, upgrades, additions • Re-training, re-integrating • Labor Burns, 2003

  13. Building a Business Case • Energy bill reduction, event avoidance, O&M improvement • Facility management • Load management, distribution • Power quality • Combined BMS • Maintenance diagnostics • Process scheduling • Financial management • Benchmark, target • Budget forecast • Cost allocation, aggregation Burns, 2003

  14. Building a Business Case • Benefits, continued • Energy management • Fuel cost analysis, tariff / contract alternatives, on-site generation • Demand response • Measurement & Verification • Administrative efficiency • Automatic collection and reporting of energy usage, emissions, whatever monitored Burns, 2003

  15. Issues Don’t underestimate deployment costs Project management Installation Integration Training Quantifying benefits tends to be conservative Begin with energy audit Prioritize projects according to payback What-ifs Pilots Scaled or segmented deployments Hardware alternatives Multiple goals Alternative energy contracts, providers Building a Business Case Burns, 2003

  16. Deployment Issues • Critical: identify members of team • Critical: identify goals • Type of report • Source of data • Installation site walk-through checklist • One-line drawings • CTs, PTs, enclosures • Contact information for all entities • On-site labor • Responsibility for updates Burns, 2003

  17. Deployment Issues • Getting the data is hard • Integration • MV-90, EDI, gateways • Interruptions • VEE • Systematizing use is hard • Advanced meter / energy information system is only a tool, not a result • Expectations Burns, 2003

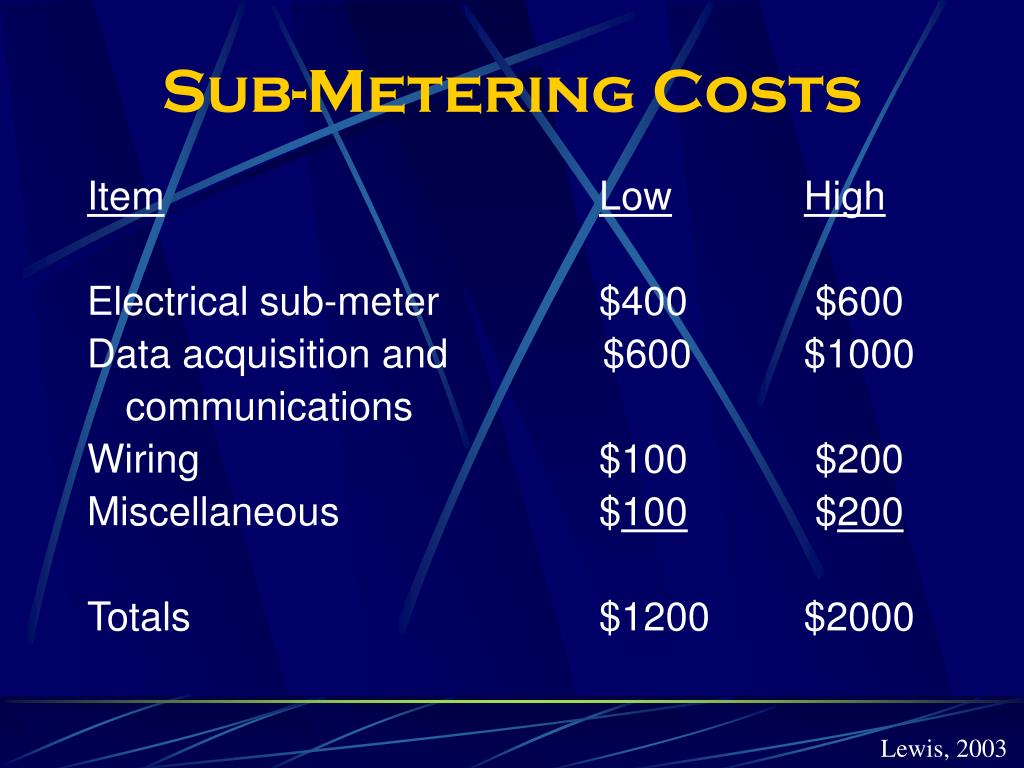

  18. Sub-Metering Costs ItemLowHigh Electrical sub-meter $400 $600 Data acquisition and $600 $1000 communications Wiring $100 $200 Miscellaneous $100 $200 Totals $1200 $2000 Lewis, 2003

  19. Sub-Metering Sample Strategies • Install meters only with software for collecting data • Metering with cost allocation software • Metering with cost allocation and operational analysis and fine-tuning (Building Tune Up) • Metering with cost allocation, intensive monitoring of major energy consuming equipment using specialized software and outside review of operations and verification of savings (continuous commissioning) Lewis, 2003

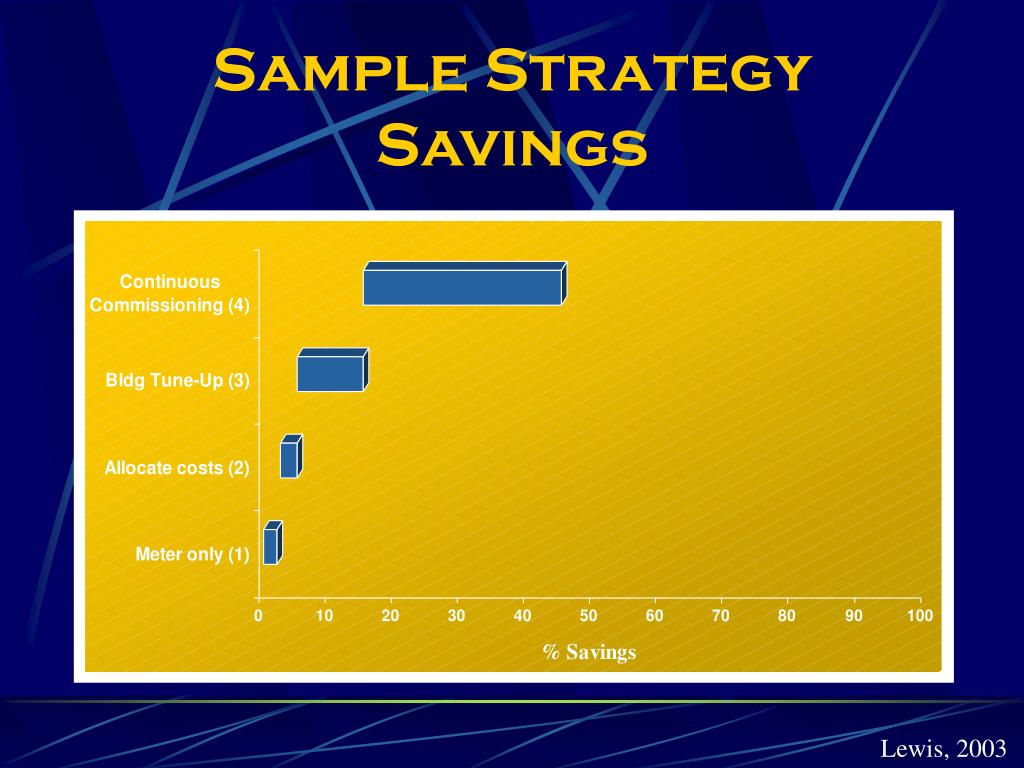

  20. Sample Strategy Savings Lewis, 2003

  21. Sample Strategy Savings Lewis, 2003

  22. LA Air Force Base Over 50 E-MON D-MON sub-meters 21 I-MON data accumulators CE-MON software Est. Cost $50k Used to verify over $1 million in savings Washington National Airport installed 200 meters @ ~ $300,000 Estimated savings from tenant billing 10% Estimated savings from cost allocation 5% Estimated savings from conservation, potential of 10% Minimize tenant/landlord disputes Government Case Studies Foley, 2003

  23. All presentations are available at:www.eere.energy.gov/femp/techassist/operations_maintenance/
