PROJECT MANAGEMENT Project Termination

PROJECT MANAGEMENT Project Termination. edlund.carl@epa.gov. Key Topics. Project Completion: Confirmation with client that objectives met File review and correction Process considers: legal, technical, administrative, client, your own organization’s future. Key Topics.

ilyssa
Télécharger la présentation

PROJECT MANAGEMENT Project Termination

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. PROJECT MANAGEMENTProject Termination edlund.carl@epa.gov

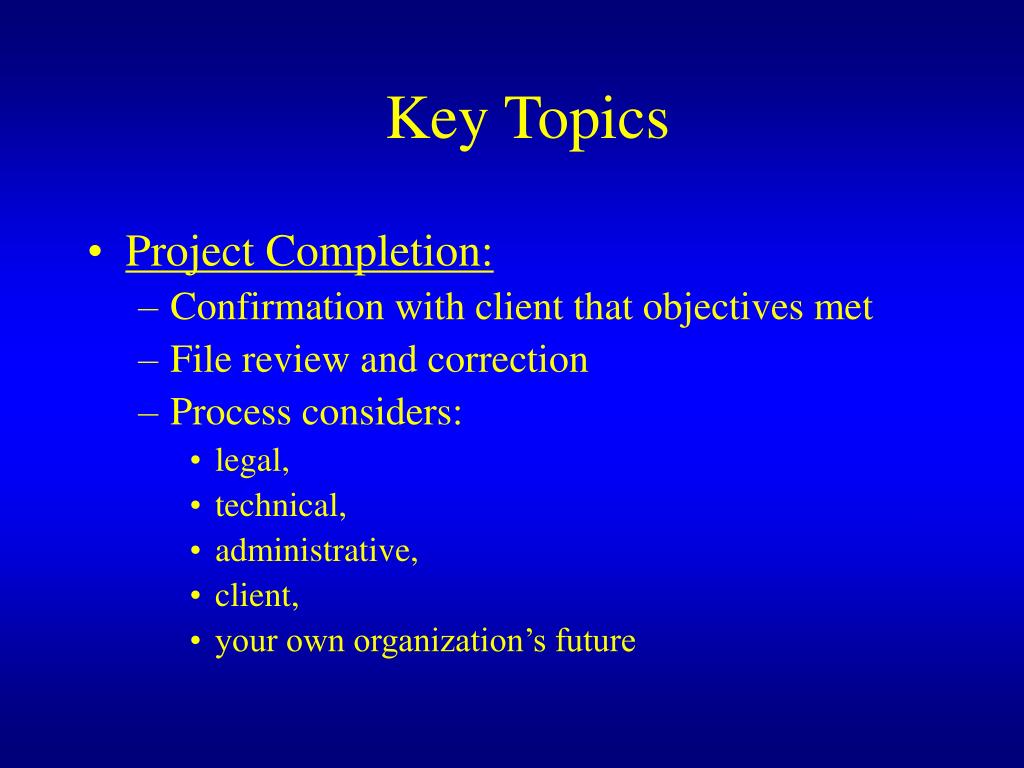

  2. Key Topics • Project Completion: • Confirmation with client that objectives met • File review and correction • Process considers: • legal, • technical, • administrative, • client, • your own organization’s future

  3. Key Topics • Control of Finances: • Ways to ensure payment: • accurate/timely invoices, • personal contacts, • discounts for early payment • Contract terms; areas of greatest importance to a supplier: • Indemnification, • Insurance, • Payment terms

  4. Key Topics • Sources: • Private Sector • Financing: • Public Sector • Foreign • Verification of Finances Why is it important to verify finances? To avoid a lein on the project or property or … your business!

  5. Key Topics • Checklist for Project Management • A&E Contract Provisions: • Deliverables defined • Responsibilities of Client and Contractor • Payment • Termination • Insurance, Liability, Indemnification • Timetable

  6. HOMEWORK #3Preparation of a Proposal • Situation: • Spilled: • 250 gal H2SO4 , • 4,000 gal gasoline • Recovered: 2,000 gal mixed • Discharged to King River: 50 gal? • In ground: 2,2000 gal? • GAG and SEA unhappy • ERU needs assessment, cost proposal ASAP

  7. HOMEWORK #3Preparation of a Proposal • To adequately respond you need to: • first know the client, and • second understand the scope of work • Critical aspects to selling a proposal: • Timeliness, • simplicity, • understanding of scope, • sensitivity to cost, • presentation of alternatives, • [unique] qualifications

  8. General Terminology • Contract: • Agreement between two or more parties [written] • Mutually binding • Legally enforceable Is it worth a trillion a year? Model for State, local, private sector Why study federal government contracting??

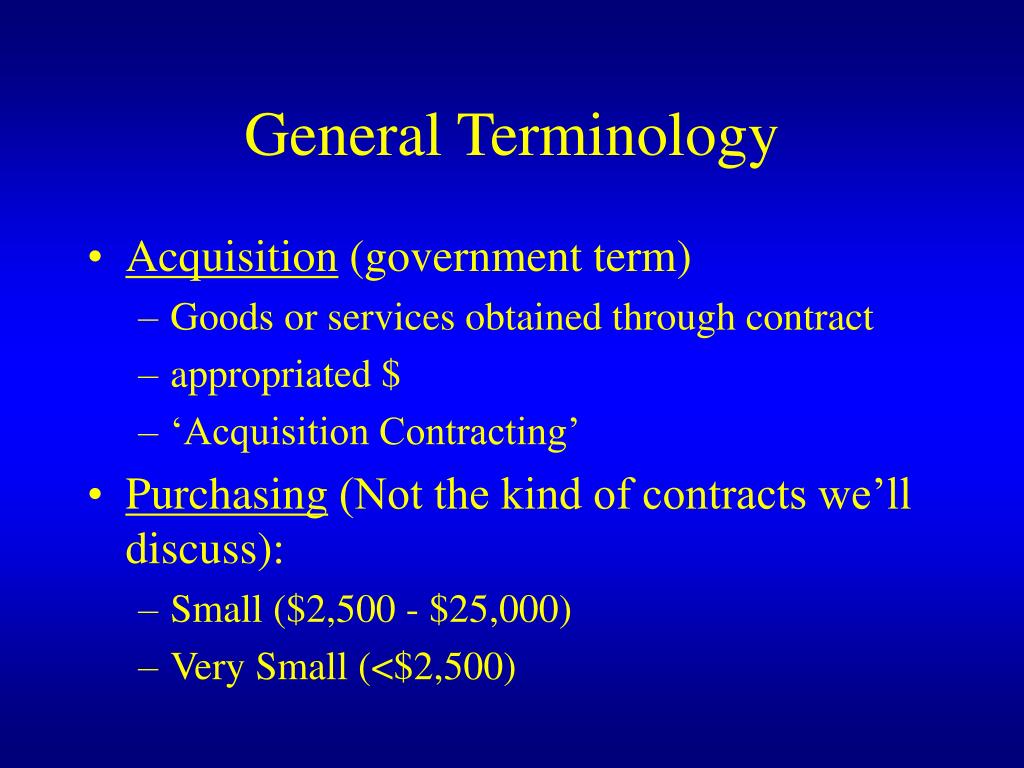

  9. General Terminology • Acquisition (government term) • Goods or services obtained through contract • appropriated $ • ‘Acquisition Contracting’ • Purchasing (Not the kind of contracts we’ll discuss): • Small ($2,500 - $25,000) • Very Small (<$2,500)

  10. Federal Contracting Authority • TWO DRIVING PRINCIPLES: • 1. Stewardship of Appropriated Funds • Full and open Competition • 2. Procurement ‘Above Reproach’: • Minimize: • Fraud • Waste • Abuse

  11. Federal Contracting Authority • PL 93-400 Federal Procurement Policy Act: • Goal: full and open competition to the extent possible • Use of competitive procedures where practical • Sealed bids are ‘best’ • Competitive proposals if sealed bids are not possible • Non-competitive relationships are least desirable [e.g. sole source contracts] • Single Uniform regulation [Federal Acquisition Regulations- ‘FAR’]

  12. Federal Acquisition Regulations • All federal procurements, all agencies • Maintained by: GSA, DoD, NASA, and EPA • Procurement Authority issued by GSA to each agency, subsequent delegations within each

  13. Federal Acquisition RegulationsDifferent people you want to get to know • Contracting Officer (CO) • Authority to issue and cancel contracts • Personal signature • Contracting Specialist (CS) • Administers the contract. • Works directly for the CO • Contracting Officer’s Technical Representative (COTR) • Evaluates technical specifications and deliverables, • Monitors work progress Why do these people work in different offices ?

  14. Federal Acquisition Regulations • Specifications are for ‘things’: • Technical attributes • Clear language • Avoid trademark or commercial description • Statement of Work (SOW) is for ‘services; • Task oriented • Meaningful measures • May be ambiguous [e.g. research] Performance-Based verses Specifications-Based Contracts … a growing trend [?]

  15. Contract Types • Sealed Bid Contracts • FFP - Firm Fixed Price • Maximum risk for contractor • Minimum contract administration • FPE - Fixed Price with Economic Price Adjustments • Contingencies related to economy • Reduces contractor risk .. but … • FPI - Fixed Price Incentive • Profit adjustment • Shared risks/benefits • Performance incentive

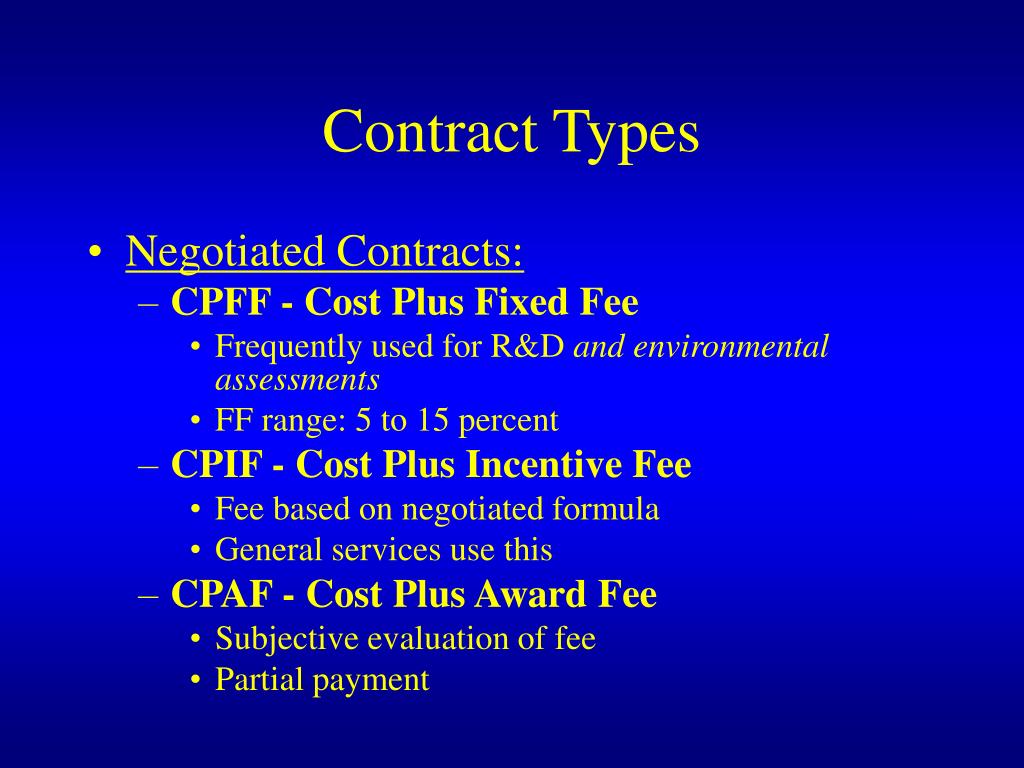

  16. Contract Types • Negotiated Contracts: • CPFF - Cost Plus Fixed Fee • Frequently used for R&D and environmental assessments • FF range: 5 to 15 percent • CPIF - Cost Plus Incentive Fee • Fee based on negotiated formula • General services use this • CPAF - Cost Plus Award Fee • Subjective evaluation of fee • Partial payment

  17. Contract Types • Negotiated Contracts: • T & M - Time and Materials • Frequent for A & E and environmental services • Hourly rates • Materials at cost • T & M * Indefinite Delivery T/M • Flexibility for scheduling and levels of effort • Bounds set on agency obligations • SSC - Sole Source Contracts • Uniquely qualified contractor .. Unique product or service • Limited component of overall project • Misery to administer

  18. Contract Types • Negotiated Contracts: • C%C - Cost Plus Percent of Cost • A ‘no - no’ … why? • Letter Contracts • No bidding/competition at all • Time of war, national emergency Q: Which form of contracting is most wanted by contractors, and why? A: Sealed bid FFP! This has the most potential for profit.

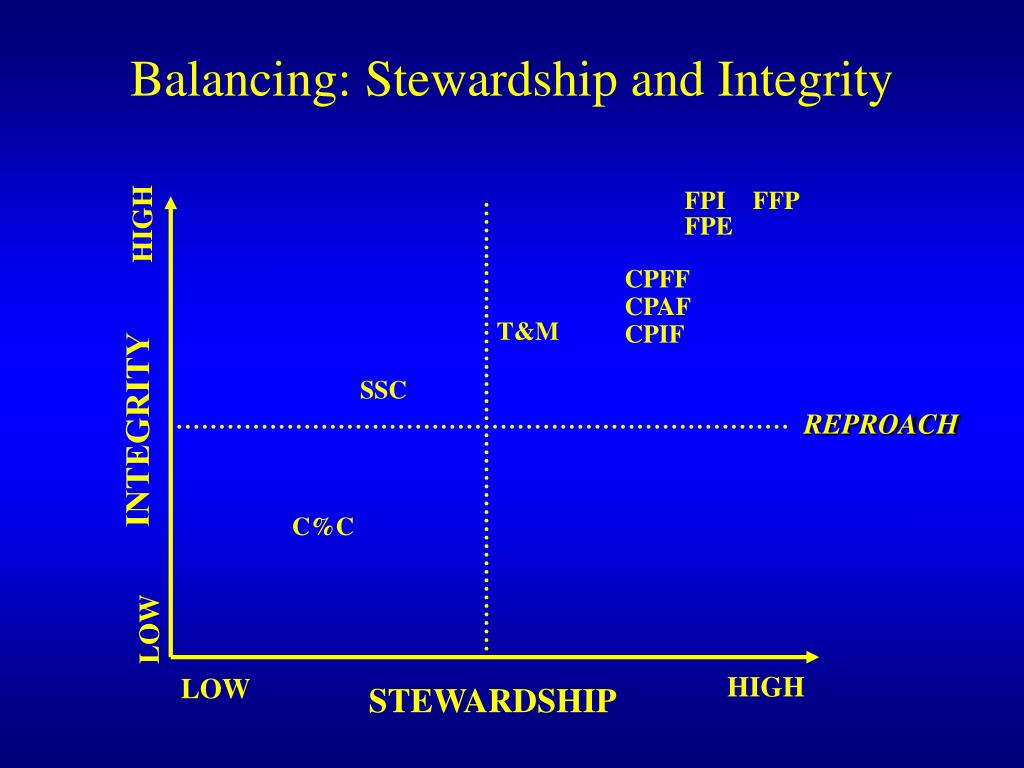

  19. Balancing: Stewardship and Integrity HIGH FPI FFP FPE CPFF CPAF CPIF T&M SSC INTEGRITY REPROACH C%C LOW HIGH LOW STEWARDSHIP

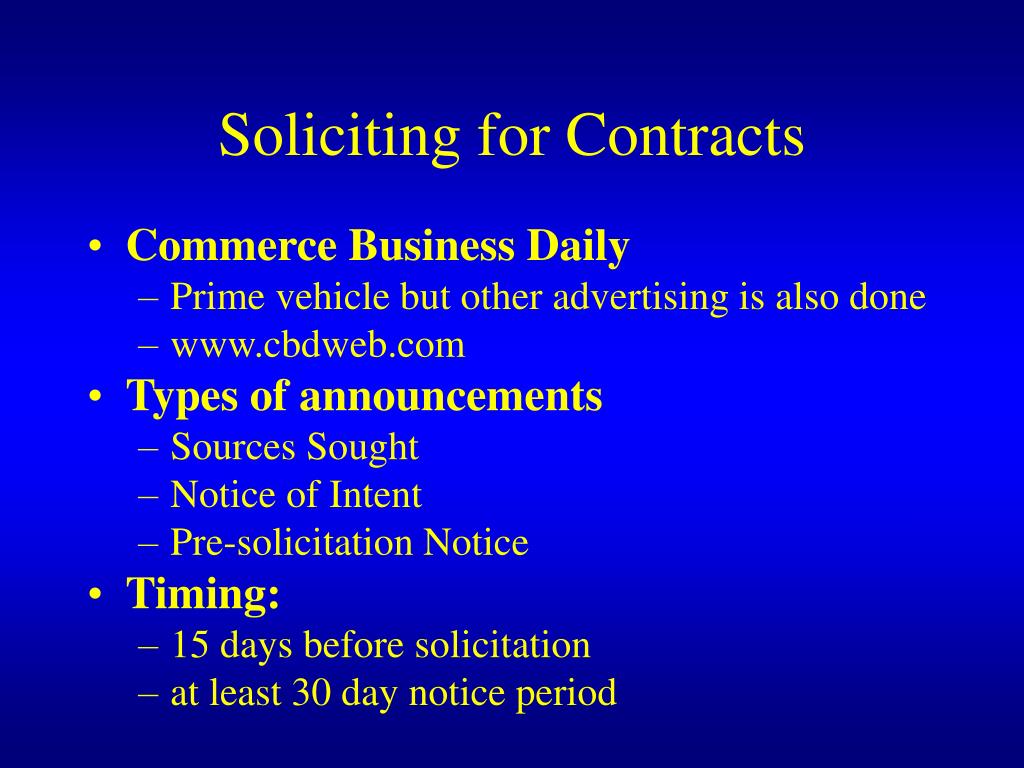

  20. Soliciting for Contracts • Commerce Business Daily • Prime vehicle but other advertising is also done • www.cbdweb.com • Types of announcements • Sources Sought • Notice of Intent • Pre-solicitation Notice • Timing: • 15 days before solicitation • at least 30 day notice period

  21. Soliciting for Contracts • Sealed Bid Process • Basic • Two Step • Negotiated Contracts • RFP/RFQ

  22. Bid Protests • Timing: • w/I 10 days • Made to: • Awarding Agency • GAO • Courts

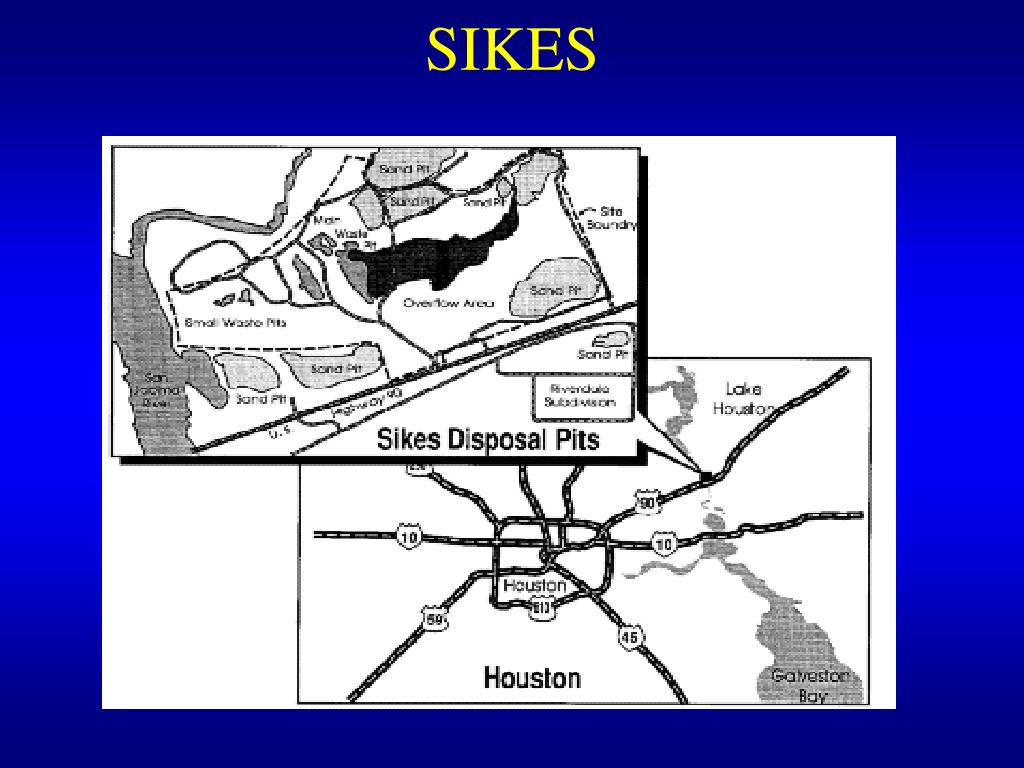

  23. SIKES

  24. SIKES • HISTORY: • 1940’s sand pit mining • 1950’s Girl Scout camp at Tank Lake; tragedy. • 1960’s Sikes family homesteads the land • Sikes’ enterprises: • deer leases • dumping

  25. SIKES • 1967 • Riverdale Community telegram to LBJ • Texas Dept of Water Resources issues / retracts water permit. • Sikes dump closed • 1982 • Floods • sampling shows widespread toxics

  26. SIKES • 1983 SITE ADDED TO NPL • Sikes family temporarily relocated [after fight] • TDWR & EPA start the RI/FS • 1986 RI/FS COMPLETED: • 80,000 cubic yds contaminated soils, • 80,000 cubic yds contaminated sludges • 13,000,000 gallons contaminated water

  27. SIKES • OPTIONS: • $ 0.4 M No Action • $ 23.4 M L/F sludges and soils on site • $ 56.0 M L/F sludges off site, soils on site • $ 53.4 M Incinerate only sludges on site • $ 111.3 M Incinerate sludges on site; L/F soils off site • $ 92.9 M Incinerate sludges and soils on site

  28. SIKES • PUBLIC COMMENT PERIOD: 7/30/86 TO 8/20/86 • PUBLIC MEETING [130 PEOPLE] 8/7/86 • PRINCIPAL CONCERNS: • Import waste from other sites? • Killer inversions? • Test innovative, cost saving, technologies? • Guarantee permanence? • Property devaluation?

  29. SIKES • Record of Decision (9/86): • Incinerate soils and sludges on site (est. $93 million) • Temporary incinerator, on quickly … off quickly. Estimated operation: 1988 - 1990. • Only Sikes waste. • Public fully informed of each step.

  30. SIKES • REMEDIAL DESIGN: 10/86 TO 10/89 • $139 M allocated [150% of ROD] • 2 step bidding process • 5 technically qualified contractors • SOLICITATION: 10/89 problem !

  31. SIKES • Single bid submitted: • $134 million [close, but under, $139 million allocated]. • Self insured and bonded • Extremely competent firm with international reputation • Other qualified bidders: • Lacked insurance • Did not lodge a protest [but were unhappy!]

  32. Elected Rep’s Agency Leaders Community State Agency Bidding contractor Other contractors Insurers Need results! Want results Restless @ delay 10% matching $ Over $500K invested Bummed by insurers Spooked by newness SIKESDifferent, Conflicting, InterestsPARTYDESIRE

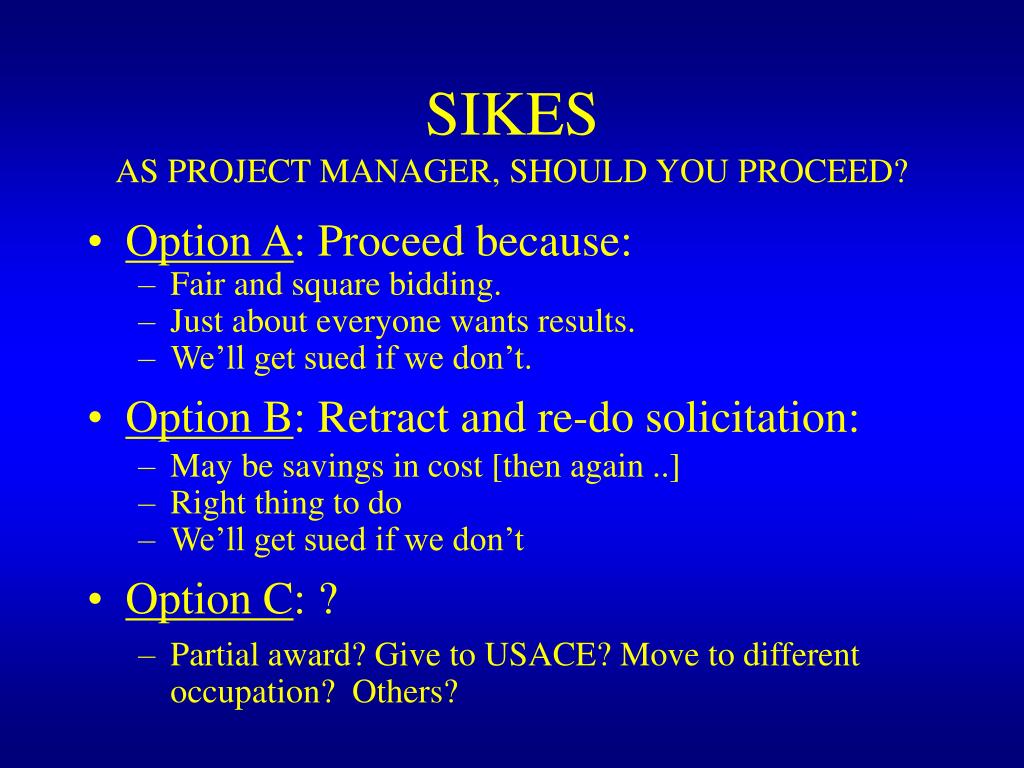

  33. SIKESAS PROJECT MANAGER, SHOULD YOU PROCEED? • Option A: Proceed because: • Fair and square bidding. • Just about everyone wants results. • We’ll get sued if we don’t. • Option B: Retract and re-do solicitation: • May be savings in cost [then again ..] • Right thing to do • We’ll get sued if we don’t • Option C: ? • Partial award? Give to USACE? Move to different occupation? Others?

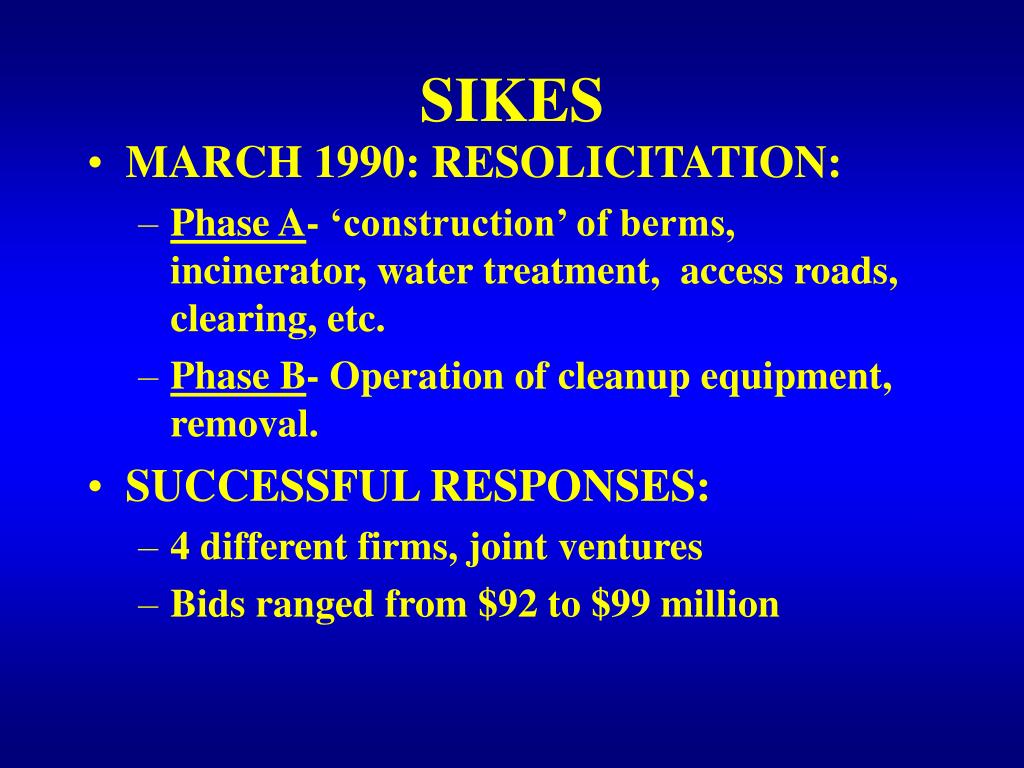

  34. SIKES • MARCH 1990: RESOLICITATION: • Phase A- ‘construction’ of berms, incinerator, water treatment, access roads, clearing, etc. • Phase B- Operation of cleanup equipment, removal. • SUCCESSFUL RESPONSES: • 4 different firms, joint ventures • Bids ranged from $92 to $99 million

  35. SIKES • OCTOBER ,1990- • Mobilization to field • JANUARY, 1992- • $32 million Phase A completed, • APRIL, 1992- • Trial Burn successful, operations started. • JANUARY, 1995- • Phase B completed [$85 vs $60 million but volume was 360,000 vs 160,000 cu yds]

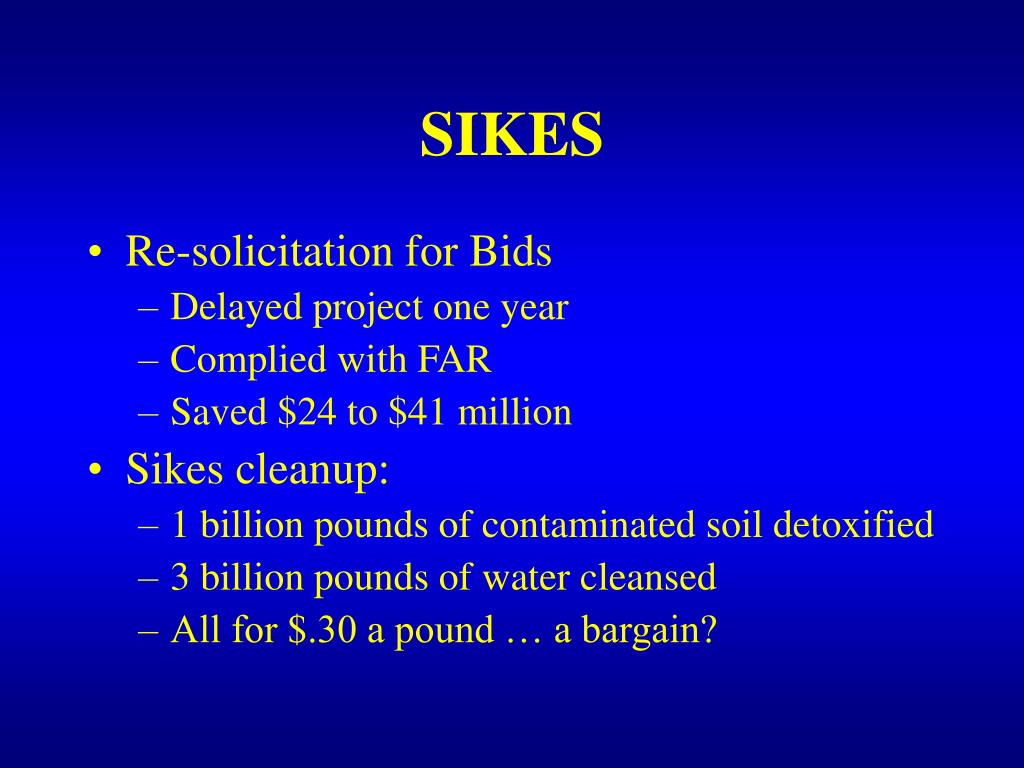

  36. SIKES • Re-solicitation for Bids • Delayed project one year • Complied with FAR • Saved $24 to $41 million • Sikes cleanup: • 1 billion pounds of contaminated soil detoxified • 3 billion pounds of water cleansed • All for $.30 a pound … a bargain?

  37. Socioeconomic Programs • Small Business • Set-asides • Competitiveness demonstration • Labor Surplus Area Set-aside • Minority and Woman's Business Enterprise [MBE/WBE] • Davis-Bacon Act

  38. A&E Contracts • Special Problems lead to 1972 Brookes Act • Qualifications Based Selection • Fair price [industry ‘standard’] • Announced in CBD • Panel selection

  39. Contract Modifications • Administrative vs Substantive • Unilateral vs Bilateral • The ‘Changes Clauses’ • Computation and negotiation difficult

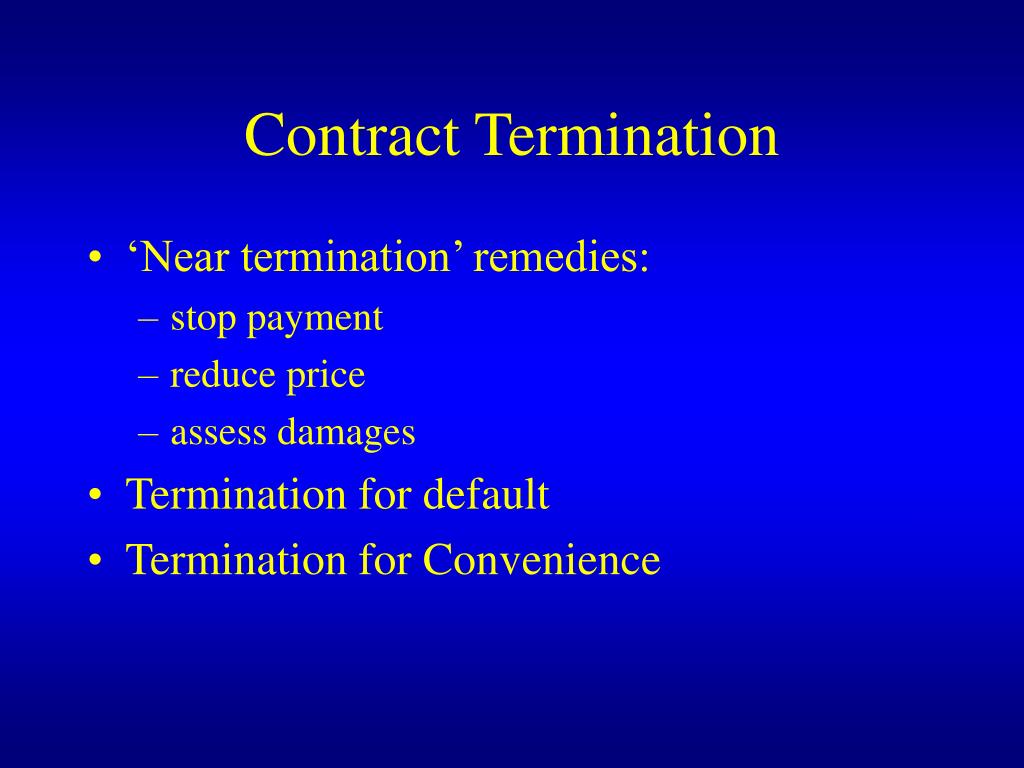

  40. Contract Termination • ‘Near termination’ remedies: • stop payment • reduce price • assess damages • Termination for default • Termination for Convenience

  41. Ethics in Contracting • BASIC DRIVING FACTORS: • 1. ABOVE REPROACH • 2. STEWARDSHIP
