  1. Calculate the critical pathArrow diagram CriticalPathMethod Edina NagyLajos KissSzabolcs Hornyák

  2. Time analysis Time analysisgoals: - Howmuchtime is neededtoimplementtheschedule? - Whencan I start and finishtheactivitiesattheearliest? - Whencan I start and finishtheactivitiesatthelatest?

  3. Activities A list of allactivitiesrequiredtocompletethe project. The timethateachactivitywilltaketocompletion. The dependenciesbetweentheactivities.

  4. Basic rules • Starting point and terminus • Arrows, circles • Activitiestime • ES,LS,EF,LF • Dummy

  5. 4 activitiesexample

  6. ES, EF, LF, LS ES - earliest start time EF- earliestfinishtime LF- latestfinishtime LS- latest start time

  7. ES, EF, LF, LS Formulas • Ei = ESij • Ej = EFij= ESij+tij • Li = LSij =LFij-tij • Lj = LFij

  8. The timecourseanalysis • TFij– totalfloat, TFij= Lj-Ei-tij = LFij-ESij-tij • FFij– free float, FFij= Ej-Ei-tij • IFij– independentfloatIFij= Ej-Li-tij • CFij – conditionalfloatCFij= TFij-FFij

  9. The timecourseanalysis The Forward pass (first phase) gives the turnaround time and the earliest possible occurence of events. The Backward pass (second phase) gives the latest possible occurrence of events.

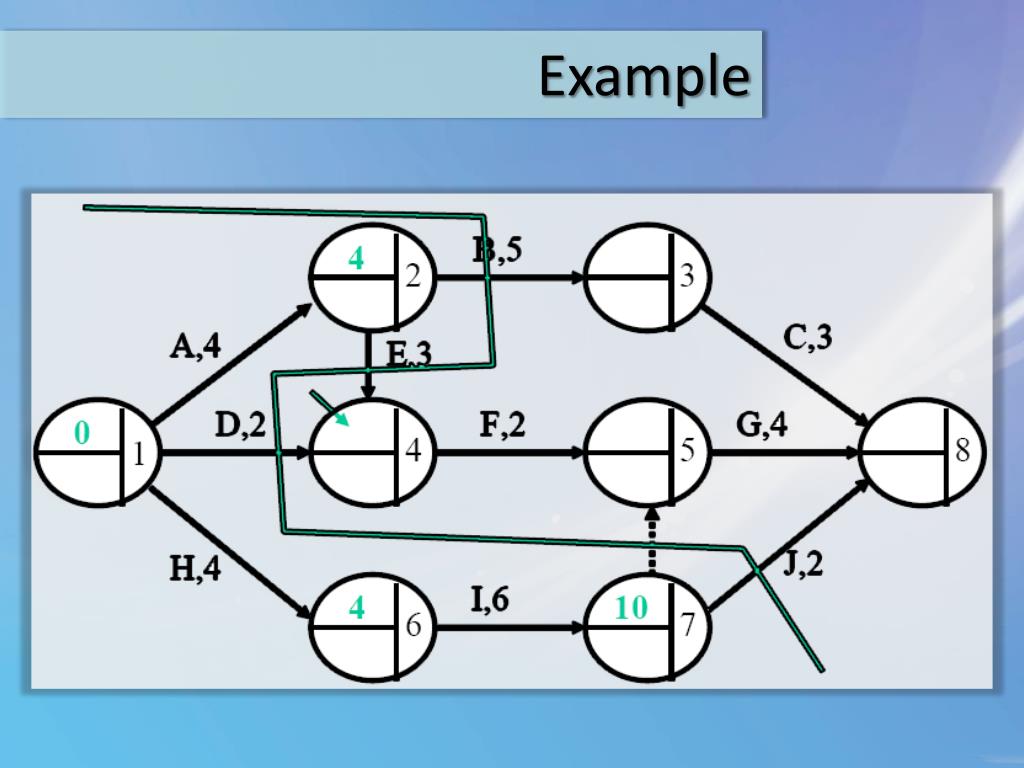

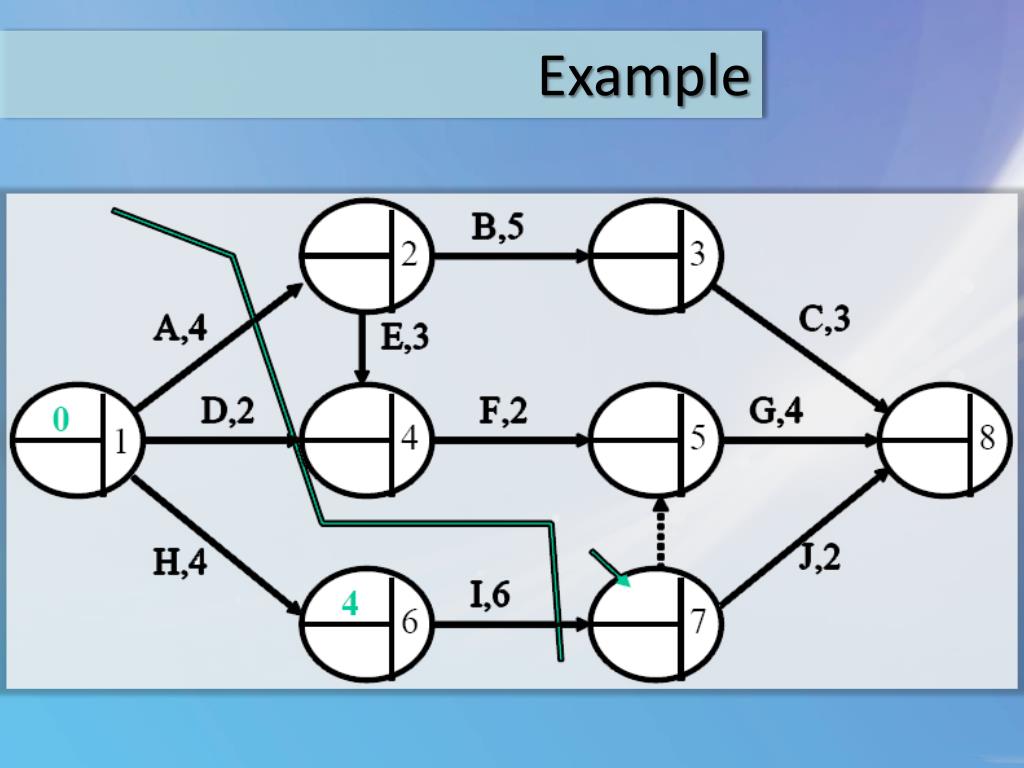

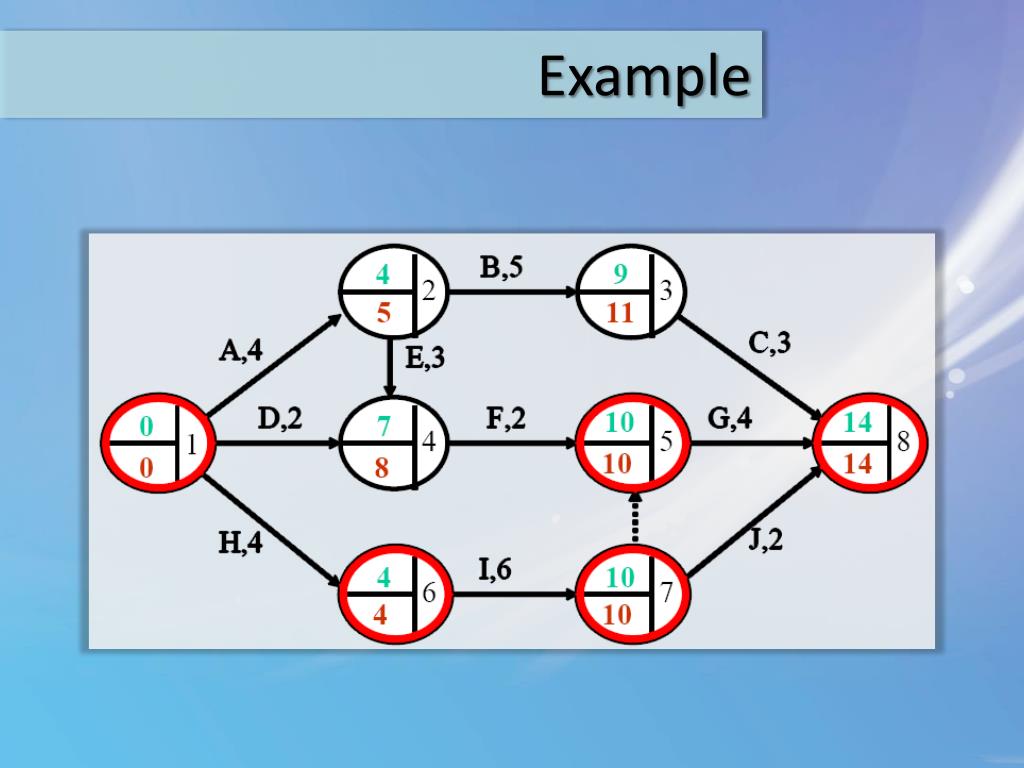

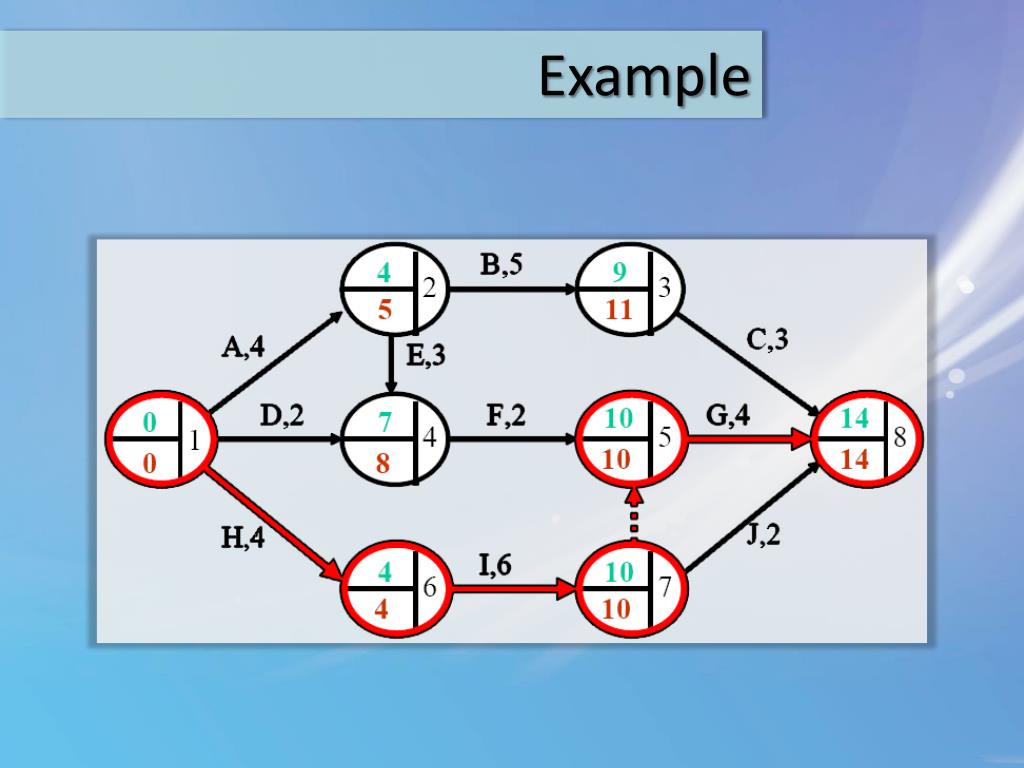

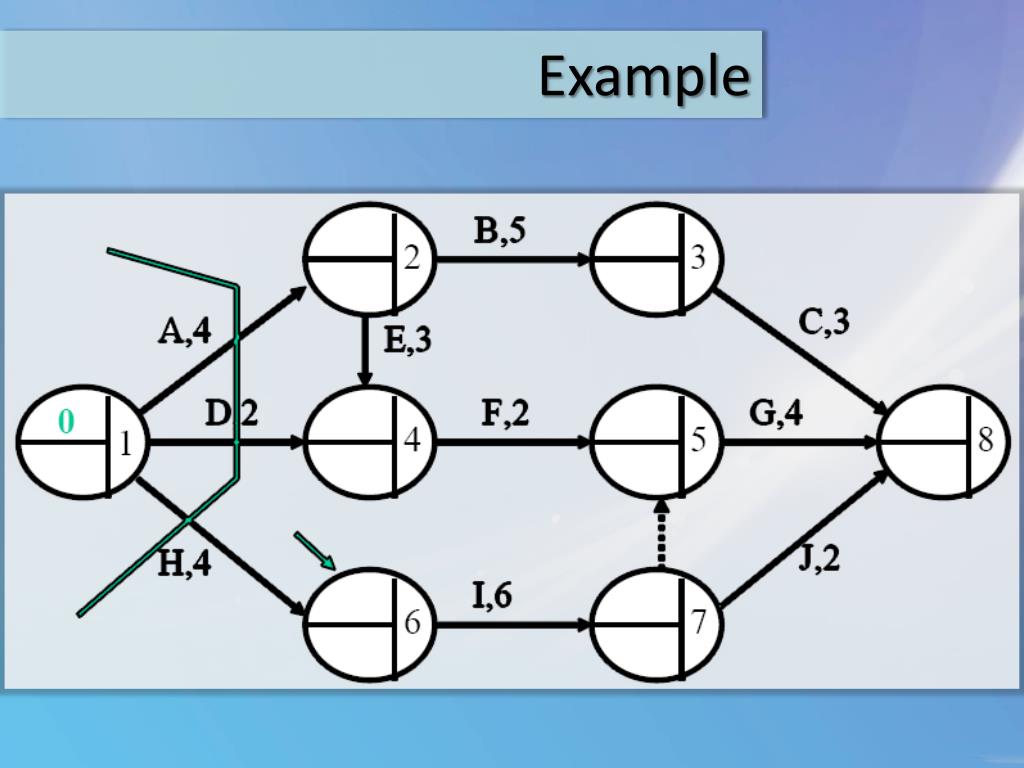

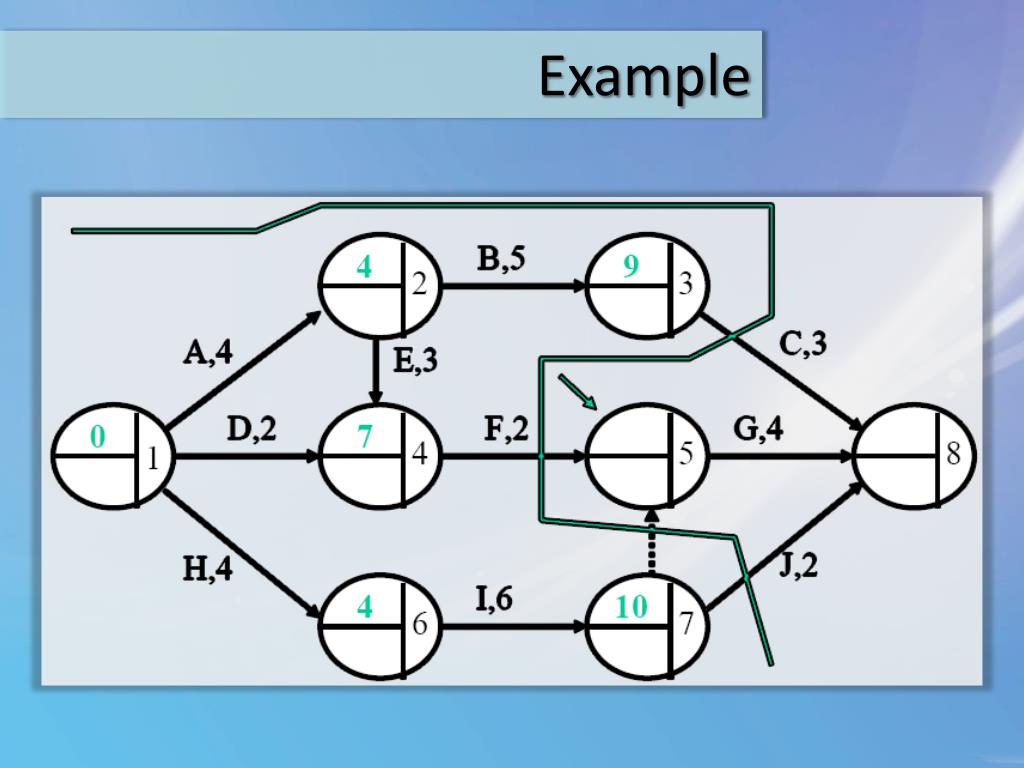

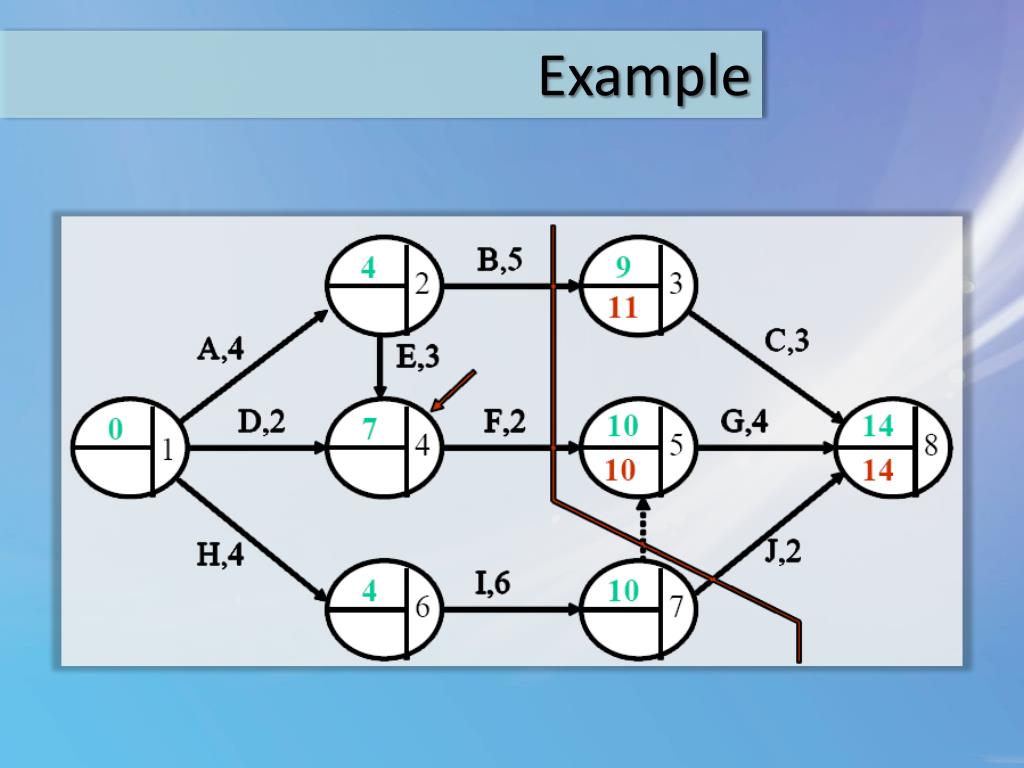

  10. Example

  11. Example

  12. Example

  13. Example

  14. Example

  15. Example

  16. Example

  17. Example

  18. Example

  19. Example

  20. Example

  21. Example

  22. Example

  23. Example

  24. Example

  25. Example

  26. Example

  27. Example

  28. Example

  29. Example

  30. Example

  31. References Dr. Hajdú Miklós YMMF - Constructionorganization and management Dr. Mályusz Levente BME - The CPM network www.netmba.com/operations/project/cpm/

  32. Thanks…
