Interim Procedures for Major IT Projects

Interim Procedures for Major IT Projects. Select (Project Planning Approval). initial. Agency Identifies Projects in IT Strategic Plan. PMD Reviews Agency IT Strategic Plans and Recommends Major IT Projects for Funding Priority to CIO and ITIB. ITIB Submits Major IT

laksha
Télécharger la présentation

Interim Procedures for Major IT Projects

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

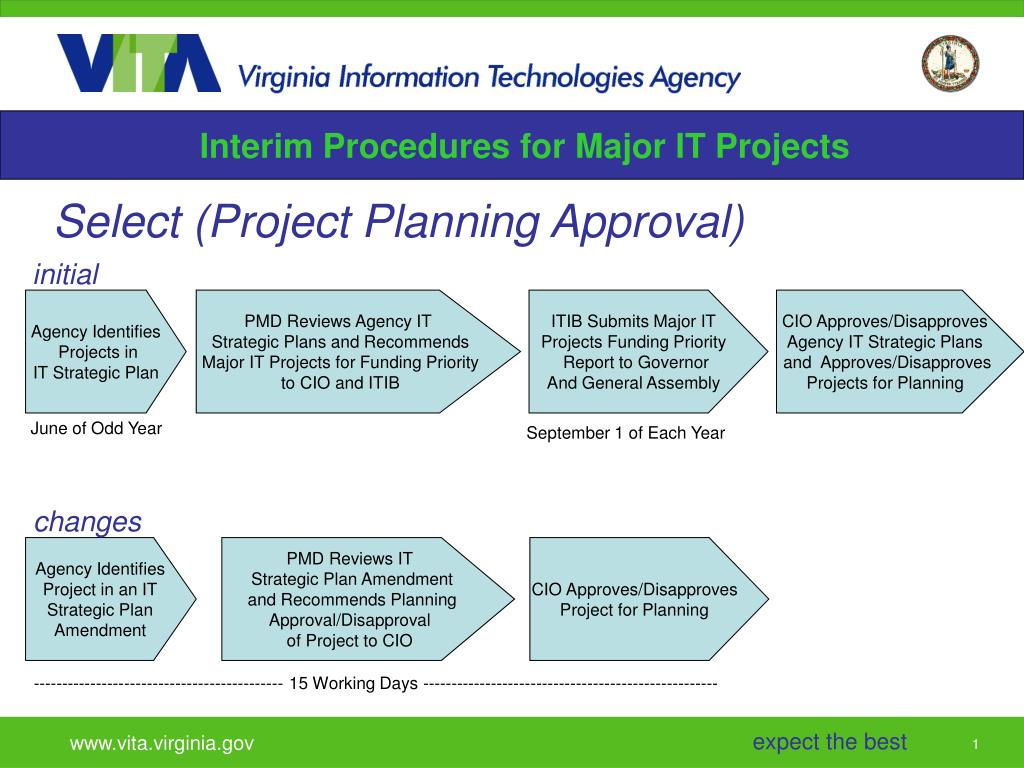

  1. Interim Procedures for Major IT Projects Select (Project Planning Approval) initial Agency Identifies Projects in IT Strategic Plan PMD Reviews Agency IT Strategic Plans and Recommends Major IT Projects for Funding Priority to CIO and ITIB ITIB Submits Major IT Projects Funding Priority Report to Governor And General Assembly CIO Approves/Disapproves Agency IT Strategic Plans and Approves/Disapproves Projects for Planning June of Odd Year September 1 of Each Year changes Agency Identifies Project in an IT Strategic Plan Amendment PMD Reviews IT Strategic Plan Amendment and Recommends Planning Approval/Disapproval of Project to CIO CIO Approves/Disapproves Project for Planning -------------------------------------------- 15 Working Days ----------------------------------------------------

  2. Interim Procedures for Major IT Projects Control (Development Approval) Agency Submits Project Proposal and Charter to PMD PMD Coordinates Secretariat Oversight Committee Meeting Secretariat Oversight Committee Recommends Project to PMD and CIO PMD Performs Initial Review and Provides Feedback to Agency 30 work days prior to ITIB Meeting IT Project Review Committee Recommends Development Approval/ Disapproval to ITIB CIO Recommends Development Approval/ Disapproval to IT Project Review Committee and ITIB PMD Performs Final Review and Recommends Development Approval/ Disapproval of Project to CIO ITIB Grants Development Approval of Project or Disapproves Project

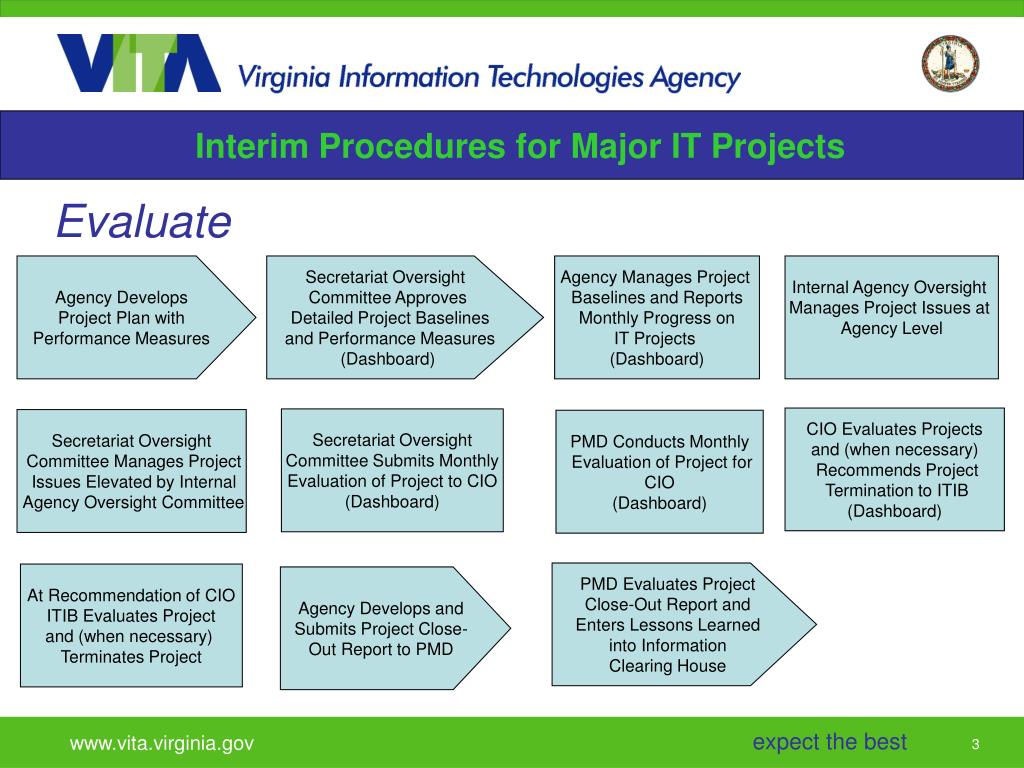

  3. Interim Procedures for Major IT Projects Evaluate Agency Develops Project Plan with Performance Measures Secretariat Oversight Committee Approves Detailed Project Baselines and Performance Measures (Dashboard) Agency Manages Project Baselines and Reports Monthly Progress on IT Projects (Dashboard) Internal Agency Oversight Manages Project Issues at Agency Level CIO Evaluates Projects and (when necessary) Recommends Project Termination to ITIB (Dashboard) Secretariat Oversight Committee Submits Monthly Evaluation of Project to CIO (Dashboard) Secretariat Oversight Committee Manages Project Issues Elevated by Internal Agency Oversight Committee PMD Conducts Monthly Evaluation of Project for CIO (Dashboard) PMD Evaluates Project Close-Out Report and Enters Lessons Learned into Information Clearing House At Recommendation of CIO ITIB Evaluates Project and (when necessary) Terminates Project Agency Develops and Submits Project Close- Out Report to PMD
