Documentation for New Manure Storages

Documentation for New Manure Storages. Manure Management Conference March 2007. Notice of Intent to Construct. Notice of Intent to Construct. Establishes base date for setback compliance determination (“who was here first”)

liang
Télécharger la présentation

Documentation for New Manure Storages

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Documentation for New Manure Storages Manure Management Conference March 2007

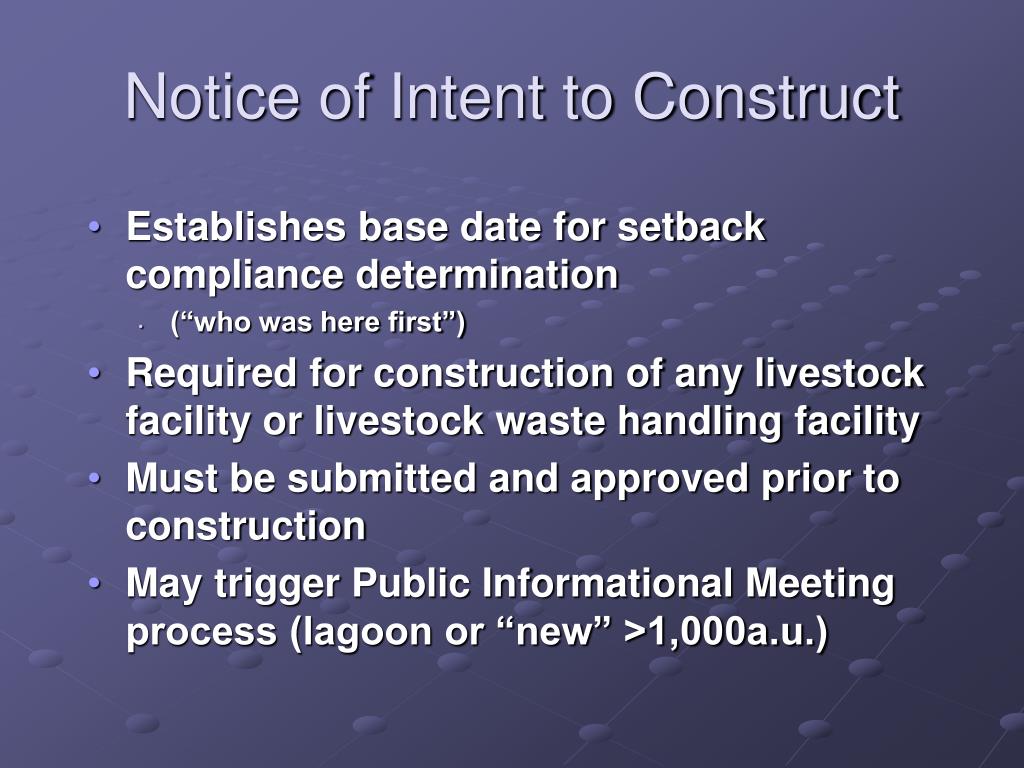

  2. Notice of Intent to Construct

  3. Notice of Intent to Construct • Establishes base date for setback compliance determination • (“who was here first”) • Required for construction of any livestock facility or livestock waste handling facility • Must be submitted and approved prior to construction • May trigger Public Informational Meeting process (lagoon or “new” >1,000a.u.)

  4. Notice of Intent to Construct Common Issues: • Ensure that all blanks are complete • List all existing and proposed structures • Distinguish • Map should depict compliance with applicable setback • Submit a complete plot plan • Sign application

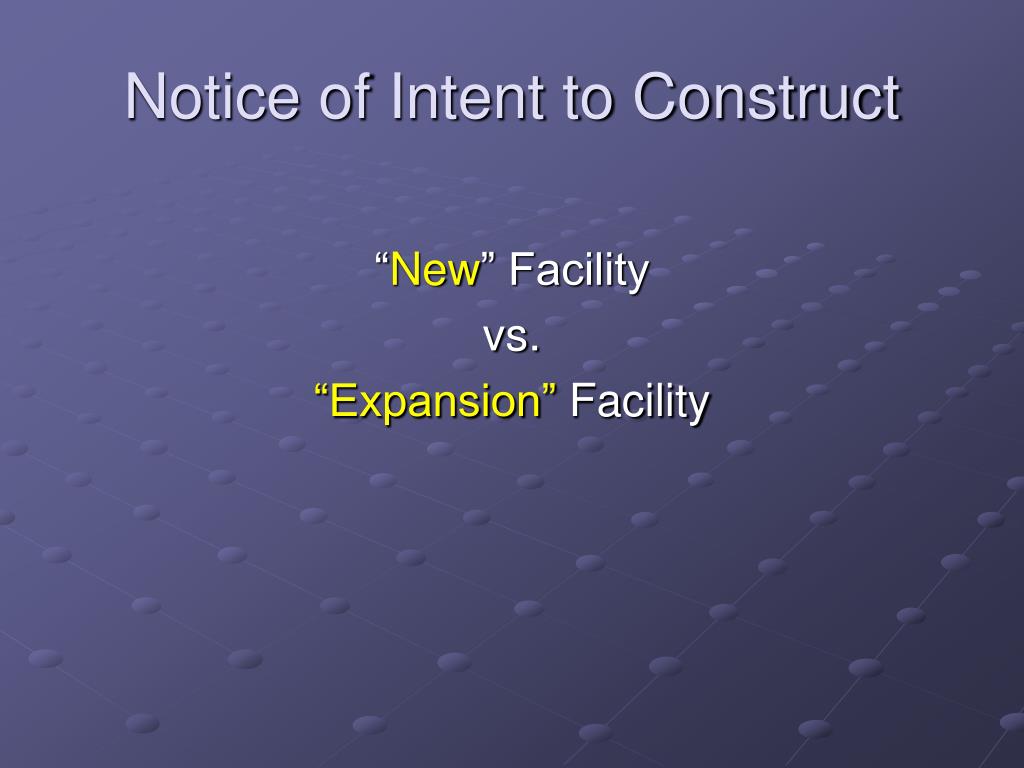

  5. Notice of Intent to Construct “New” Facility vs. “Expansion” Facility

  6. Definitions • “New” facility • No existing structures; or • Expansion where fixed capital cost of the new components constructed within a 2-year period exceed 50% of the cost of a comparable entirely new facility • New Facilities subject to numeric setbacks • ¼ mile residential setback • ½ mile populated area setback

  7. Notice of Intent to Construct • “Expansion” Facility • Expanded, not “ new” if fixed capital cost of the new components constructed within a 2-year period does not exceed 50% of the cost of a comparable entirely new facility • Expansions are subject to maximum feasible location • Proposed structure must be closer to owner’s residence or existing livestock structures than nearest non-facility owned residence.

  8. Do I Qualify as an Expansion? Comparable Entirely New Facility Cost + = Existing Replacement Cost New Construction Cost

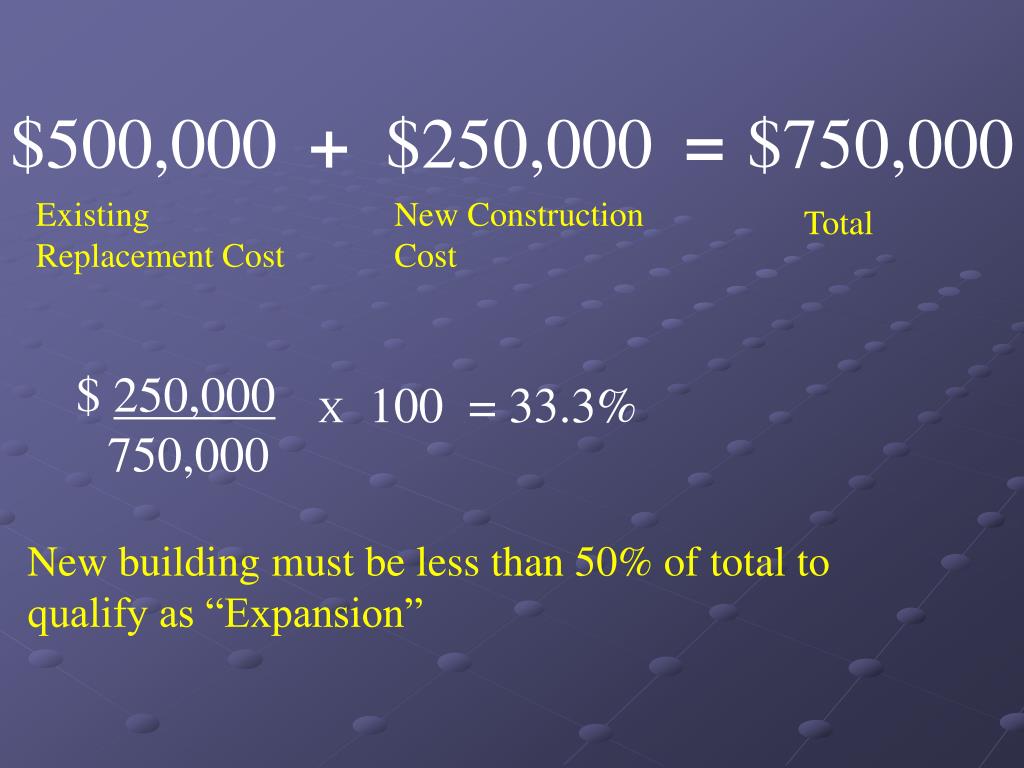

  9. $500,000 + $250,000 = $750,000 Existing Replacement Cost New Construction Cost Total $ 250,000 750,000 X 100 = 33.3% New building must be less than 50% of total to qualify as “Expansion”

  10. Plot Plan Example “Expansion”

  11. Plot Plan Example “New” Facility

  12. Design Requirements

  13. Non-Lagoon Livestock Waste Handling Facility Application

  14. Construction Standards • Lagoons • ASAE 403.2 or NRCS “Waste Treatment Lagoon” • Site investigation (50 feet below planned bottom - results to adjust design requirements) • Non-Lagoons • MWPS-36, MWPS-18, NRCS standards • Site investigation (karst area, 100 yr. Flood plain, aquifer material w/in 5 ft of bottom – results to adjust design requirementsor prohibit construction)

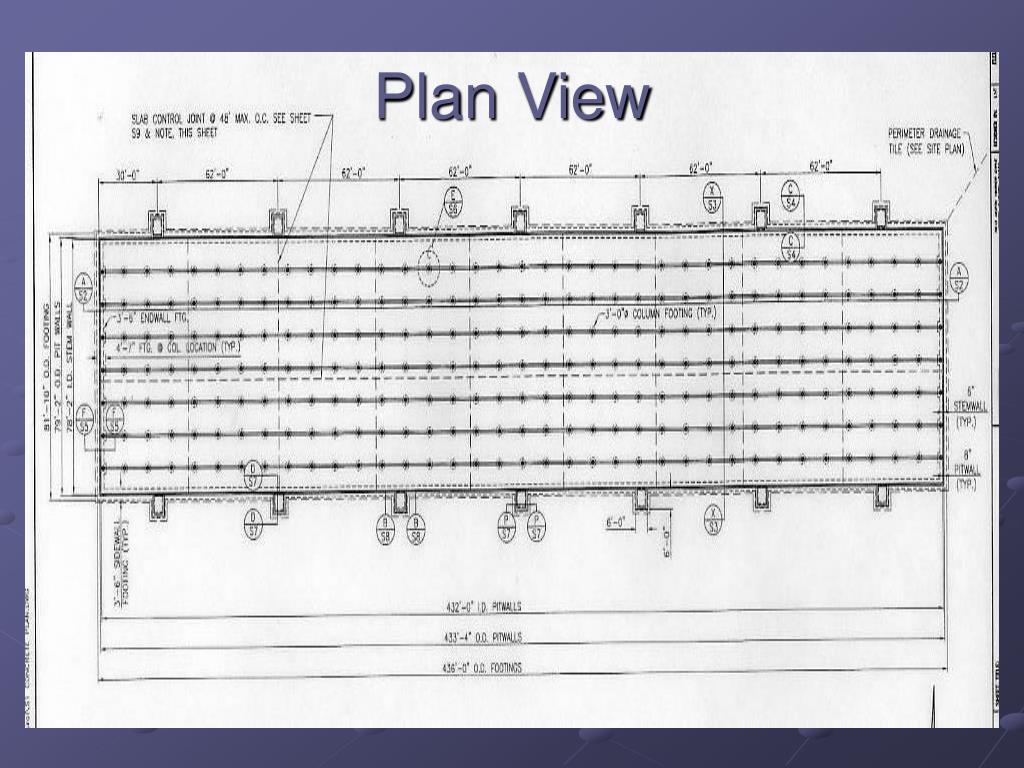

  15. Plan View

  16. Cross Section

  17. Cross Section

  18. Details

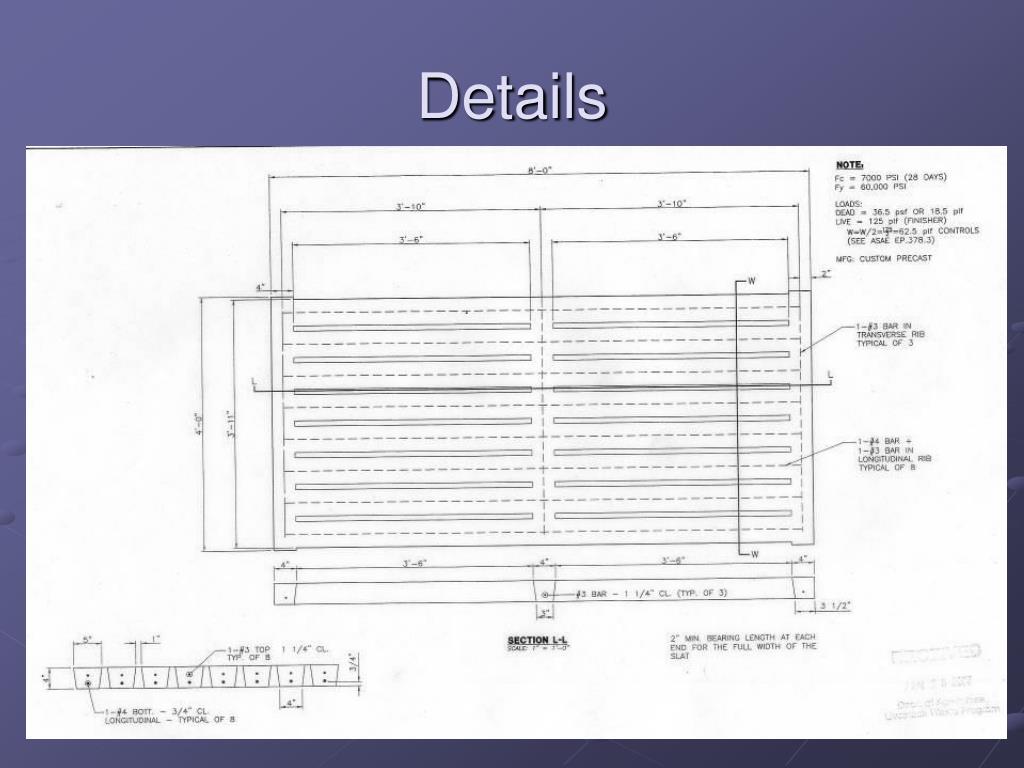

  19. Details

  20. Details

  21. Details

  22. Perimeter Foundation Drain • Required when seasonal high water table may encroach upon the bottom of the waste handling structure • Quarterly monitoring requirement • Supporting justification must be provided if not installed • Soil boring • Soil survey

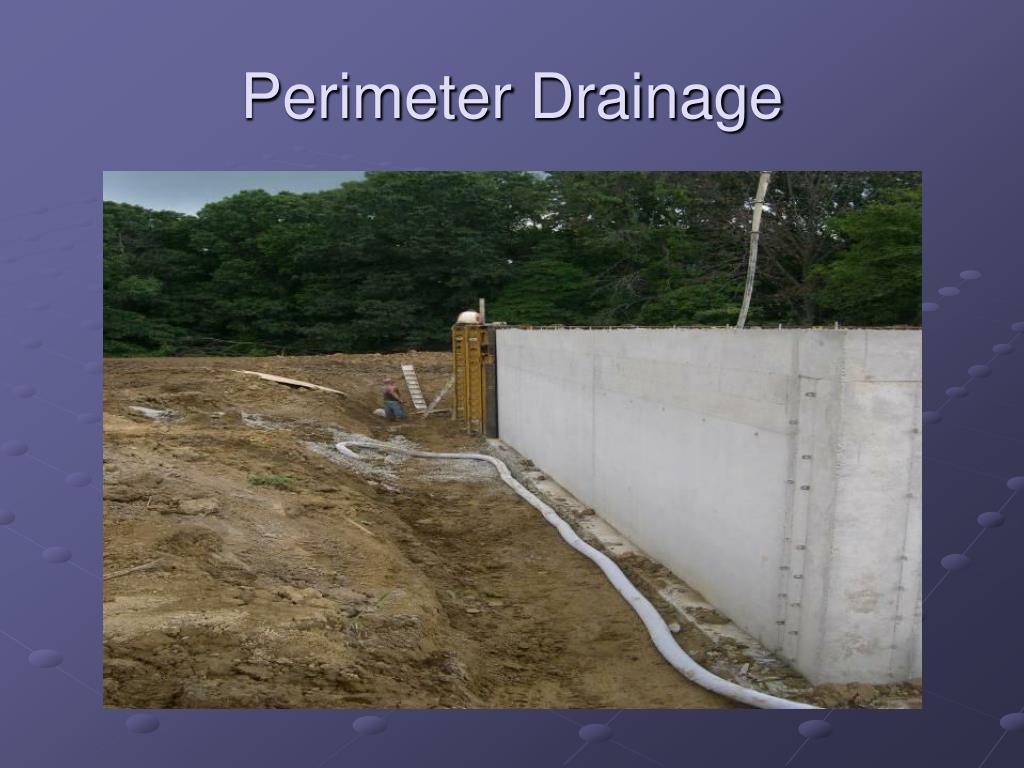

  23. Perimeter Drainage

  24. Facility Location

  25. Inspections • Pre-Construction • Verify accuracy of Noitc • During Construction • Verify construction proceeding according to Department approved construction plan • Final Construction • Final walk through • Conducted after waste handling system complete

  26. Certification Documentation

  27. Certification Documentation • Certification of Construction • Signed by owner • Certification of Concrete Quality • Signed by supplier • Verifies 28 day minimum compressive strength • Copies of delivery tickets • $250 filing fee

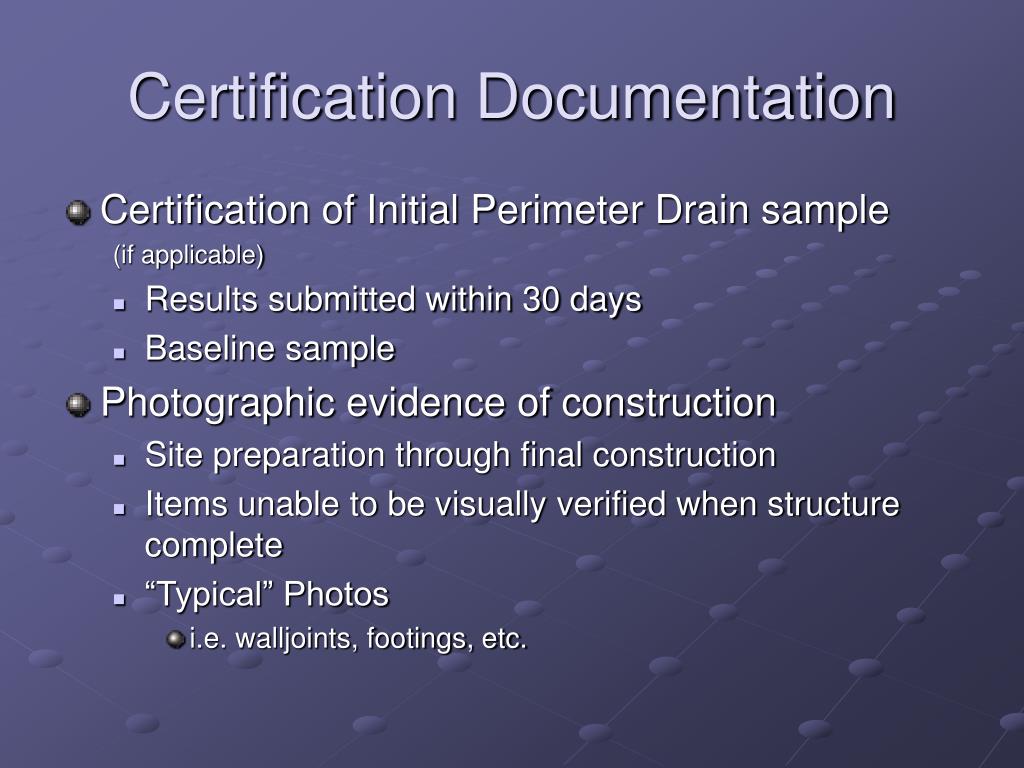

  28. Certification Documentation • Certification of Initial Perimeter Drain sample (if applicable) • Results submitted within 30 days • Baseline sample • Photographic evidence of construction • Site preparation through final construction • Items unable to be visually verified when structure complete • “Typical” Photos • i.e. walljoints, footings, etc.

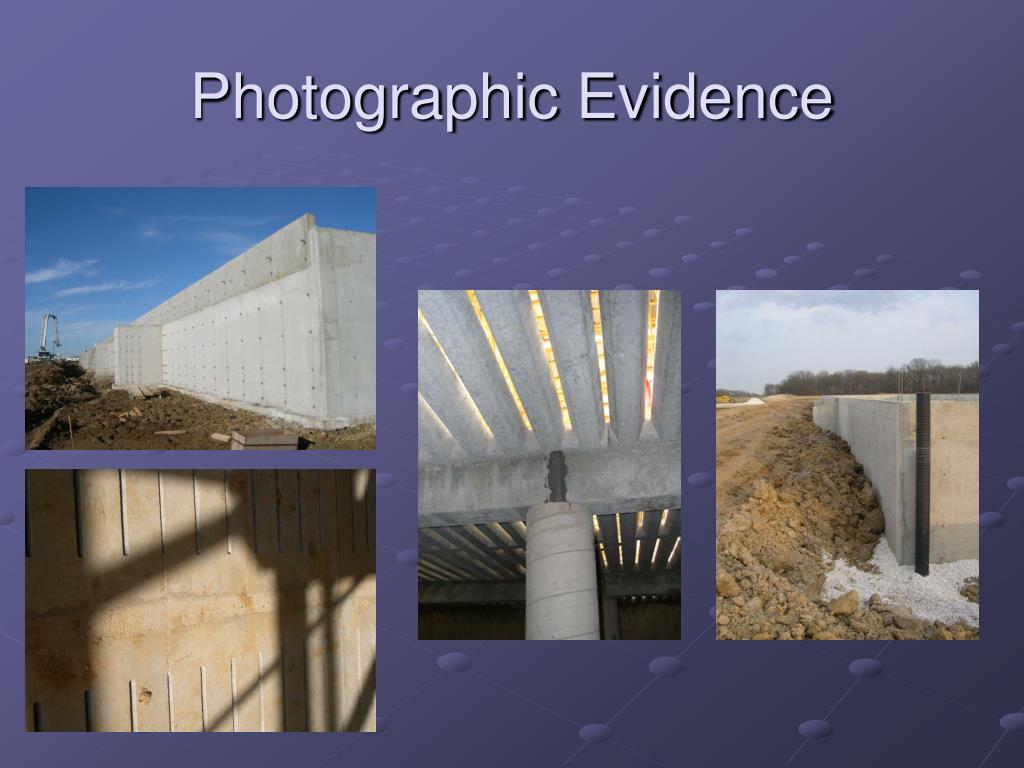

  29. Photographic Evidence

  30. Photographic Evidence

  31. Photographic Evidence

  32. Photographic Evidence

  33. Questions or Comments?
