Effort Estimation

Effort Estimation. For example?. Has been an “ art ” for a long time because many parameters to consider unclear of relative importance of the parameters unknown inter-relationship among the parameters unknown metrics for the parameters Historically , project managers

maylin
Télécharger la présentation

Effort Estimation

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Effort Estimation For example? • Has been an “art” for a long time because • many parameters to consider • unclear of relative importance of the parameters • unknown inter-relationship among the parameters • unknown metrics for the parameters • Historically, project managers • consulted others with past experiences • drew analogy from projects with “similar” characteristics • broke the projects down to components and used past history of workers who have worked on similar components; then combined the estimates

  2. Class Discussion of Size vs Effort Effort If the relation is non-linear then ---- ? Effort = a + b * (Size) Size

  3. General Model • There have been many proposed models for estimation of effort in software. They all have a “similar” general form: Effort≡ (size) and (set of factors) • Effort = [a + (b * ((Size)**c))] * [PROD(f’s)] • where : • Size is the estimated size of the project in loc or function points • a, b, c, are coefficients derived from past data and curve fitting • a = base cost to do business regardless of size • b = fixed marginal cost per unit of change of size • c = nature of influence of size on cost • f’s are a set of additional factors, besides Size, that are deemd important • PROD (f’s) is the arithmetic-product of the f’s

  4. COCOMO Estimating Technique • Developed by Barry Boehm in early 1980’s who had a long history with TRW and government projects (LOC based) • Later modified into COCOMO II in the mid-1990’s (FP preferred or LOC) • Assumed process activities : • Product Design • Detailed Design • Code and Unit Test • Integration and Test • Utilized by some but most of the people still rely on experience and/or own company proprietary data & process. (e.g. proprietary loc to pm conversion rate) Note that this does not includerequirements !

  5. Basic Form for Effort • Effort = A * B * (size ** C) • or more “generally” • Effort = [A * (size**C)] * [B ] • Effort = person months • A = scaling coefficient • B = coefficient based on 15 parameters • C = a scaling factor for process • Size = delivered source lines of code in “KLOC”

  6. Basic form for Time • Time = D * (Effort ** E) • Time = total number of calendar months • D = A constant scaling factor for schedule • E = a coefficient to describe the potential parallelism in managing software development

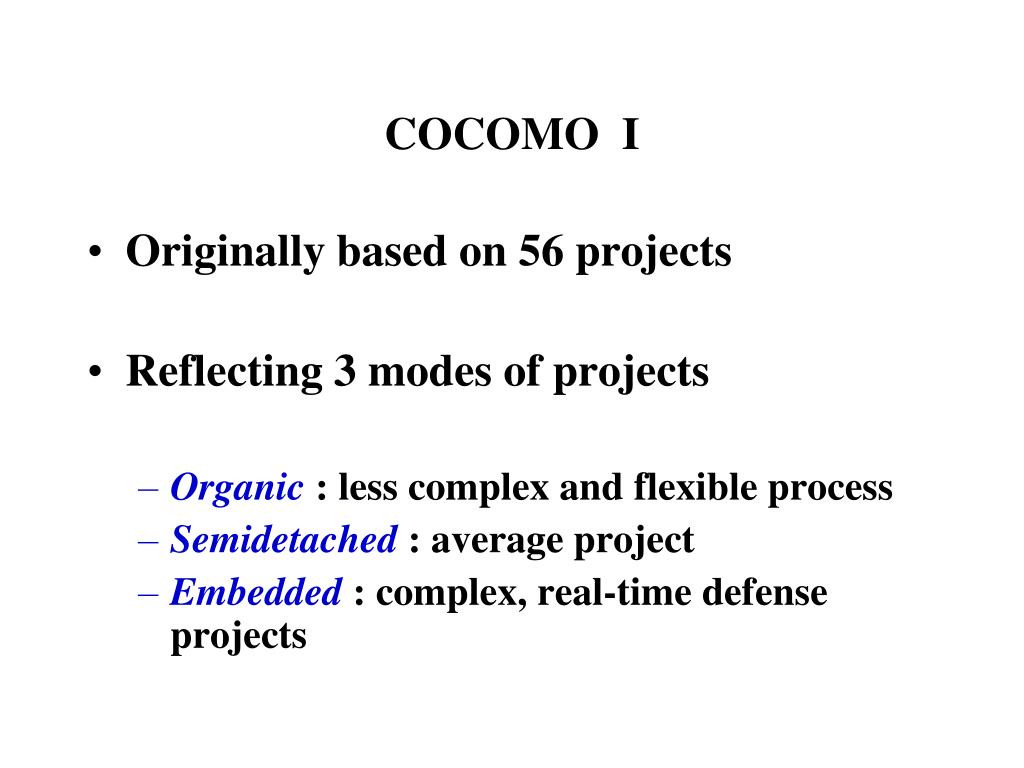

  7. COCOMO I • Originally based on 56 projects • Reflecting 3 modes of projects • Organic: less complex and flexible process • Semidetached : average project • Embedded : complex, real-time defense projects

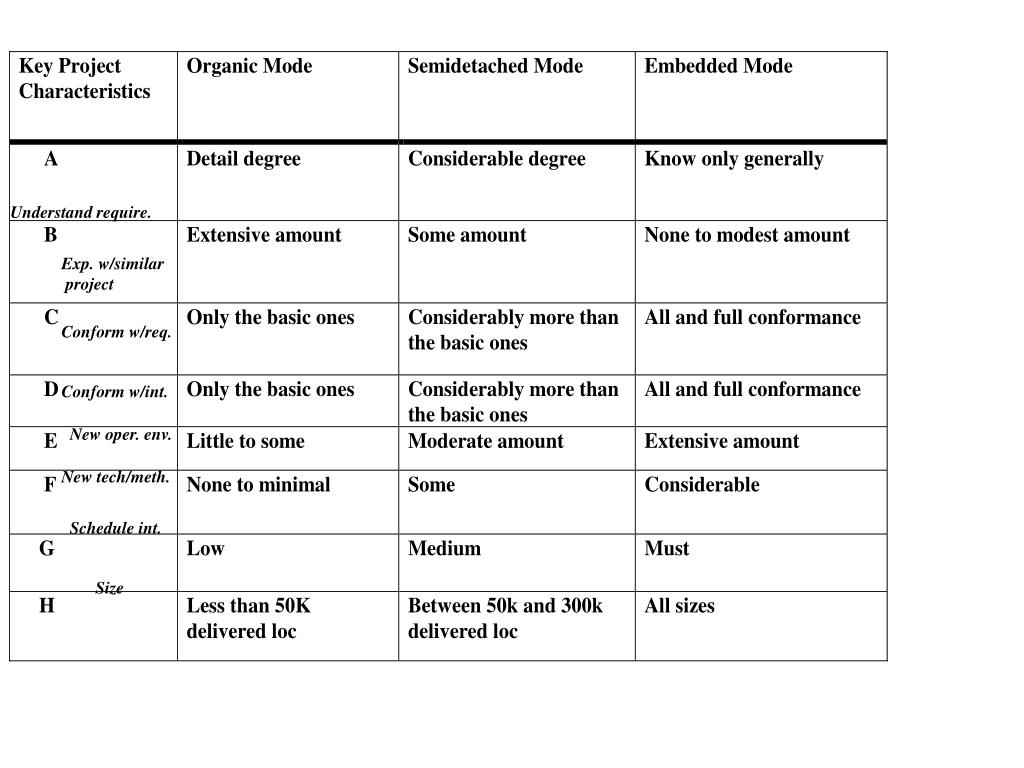

  8. 3 Modes are Based on 8 Characteristics • A. Team’s understanding of the project objective • B. Team’s experience with similar or related project • C. Project’s needs to conform with established requirements • D. Project’s needs to conform with established interfaces • E. Project developed with “new” operational environments • F. Project’s need for “new” technology, architecture, etc. • G. Project’s need for schedule integrity • H. Project’s “size” range

  9. Understand require. Exp. w/similar project Conform w/req. Conform w/int. New oper. env. New tech/meth. Schedule int. Size

  10. COCOMO I • For the basic forms: • Effort = A * B *(size)C • Time = D * (Effort)E • Organic : A = 3.2 ; C = 1.05 ; D= 2.5; E = .38 • Semidetached : A = 3.0 ; C= 1.12 ; D= 2.5; E = .35 • Embedded : A = 2.8 ; C = 1.20 ; D= 2.5; E = .32 What about the coefficient B? ---- see next slide

  11. Coefficient B • Coefficient B is an effort adjustment factor based on 15 parameters which varied from very low,low,nominal, high, very high to extra high • B = product (15 parameters) • Product attributes: • Required Software Reliability : .75 ; .88; 1.00; 1.15; 1.40; • Database Size : ; .94; 1.00; 1.08; 1.16; • Product Complexity : .70 ; .85; 1.00; 1.15; 1.30; 1.65 • Computer Attributes • Execution Time Constraints : ; ; 1.00; 1.11; 1.30; 1.66 • Main Storage Constraints : ; ; 1.00; 1.06; 1.21; 1.56 • Virtual Machine Volatility : ; .87; 1.00; 1.15; 1.30; • Computer Turnaround time : ; .87; 1.00; 1.07; 1.15;

  12. Coefficient B (cont.) • Personnel attributes • Analyst Capabilities : 1.46 ; 1.19; 1.00; .86; .71; • Application Experience : 1.29; 1.13; 1.00; .91; .82; • Programmer Capability : 1.42; 1.17; 1.00; .86; .70; • Virtual Machine Experience : 1.21; 1.10; 1.00; .90; ; • Programming lang. Exper. : 1.14; 1.07; 1.00; .95; ; • Project attributes • Use of Modern Practices : 1.24; 1.10; 1.00; .91; .82; • Use of Software Tools : 1.24; 1.10; 1.00; .91; .83; • Required Develop schedule : 1.23; 1.08; 1.00; 1.04; 1.10;

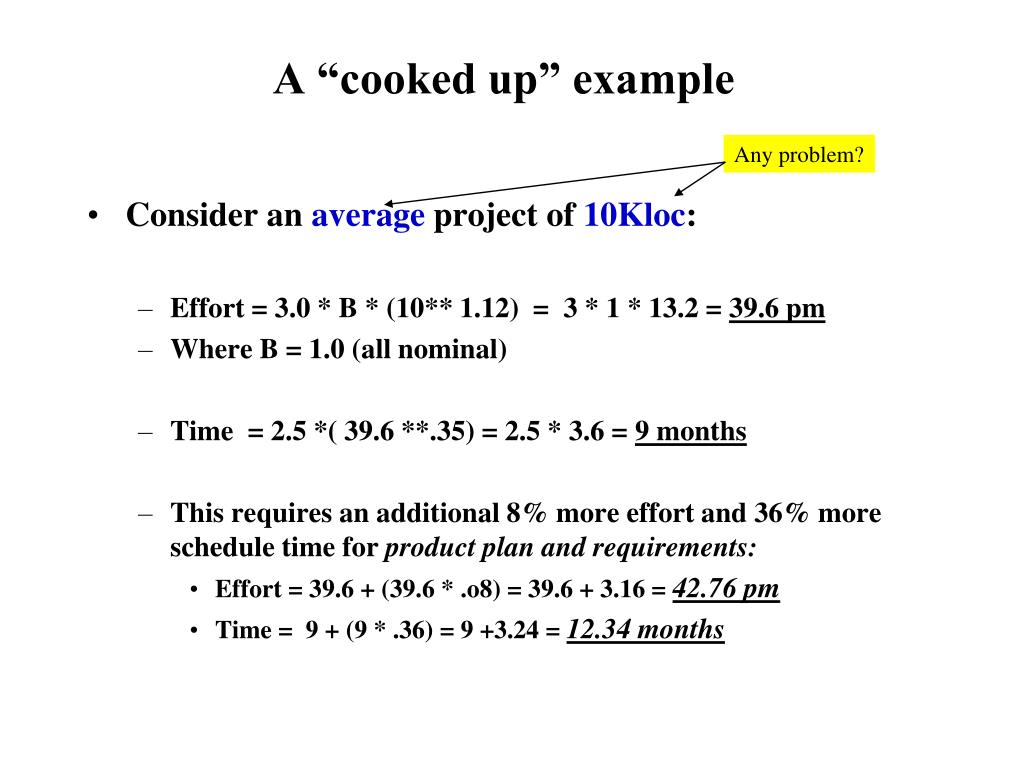

  13. A “cooked up” example Any problem? • Consider an average project of 10Kloc: • Effort = 3.0 * B * (10** 1.12) = 3 * 1 * 13.2 = 39.6 pm • Where B = 1.0 (all nominal) • Time = 2.5 *( 39.6 **.35) = 2.5 * 3.6 = 9 months • This requires an additional 8% more effort and 36% more schedule time for product plan and requirements: • Effort = 39.6 + (39.6 * .o8) = 39.6 + 3.16 = 42.76 pm • Time = 9 + (9 * .36) = 9 +3.24 = 12.34 months

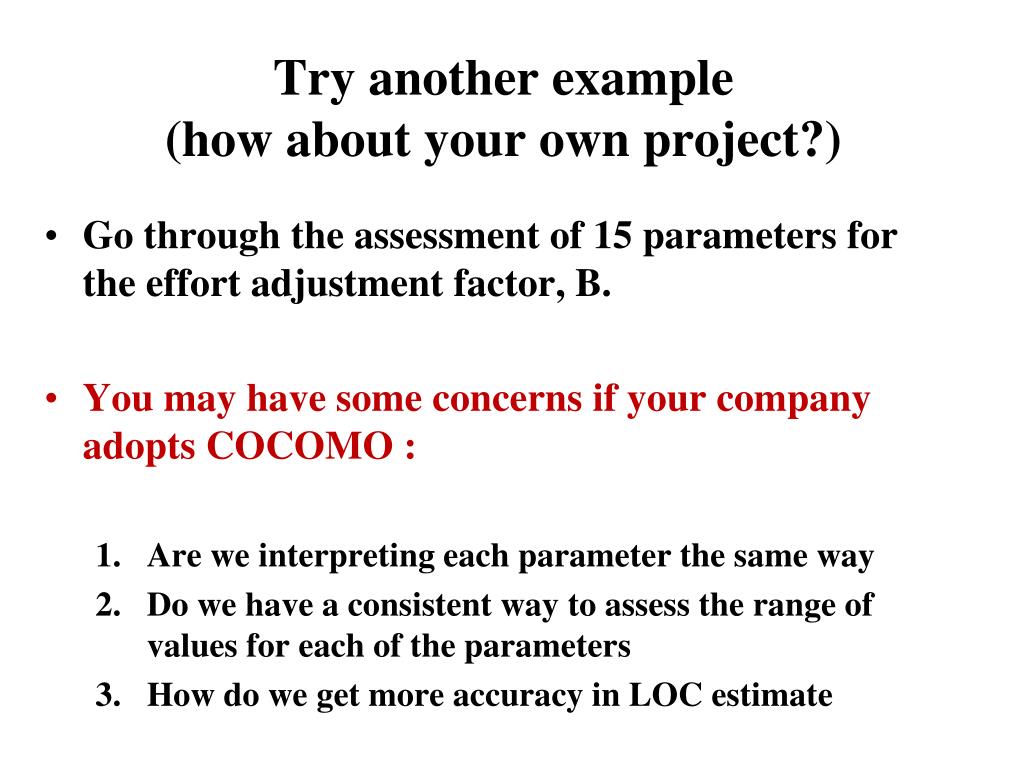

  14. Try another example(how about your own project?) • Go through the assessment of 15 parameters for the effort adjustment factor, B. • You may have some concerns if your company adopts COCOMO : • Are we interpreting each parameter the same way • Do we have a consistent way to assess the range of values for each of the parameters • How do we get more accuracy in LOC estimate

  15. Relative Accuracy of Estimates(from B. Boehm) 4x Estimate Range (size/cost) Actual size/cost x .25x Requirements Code/Test Design Early feasibility Stages of the Project

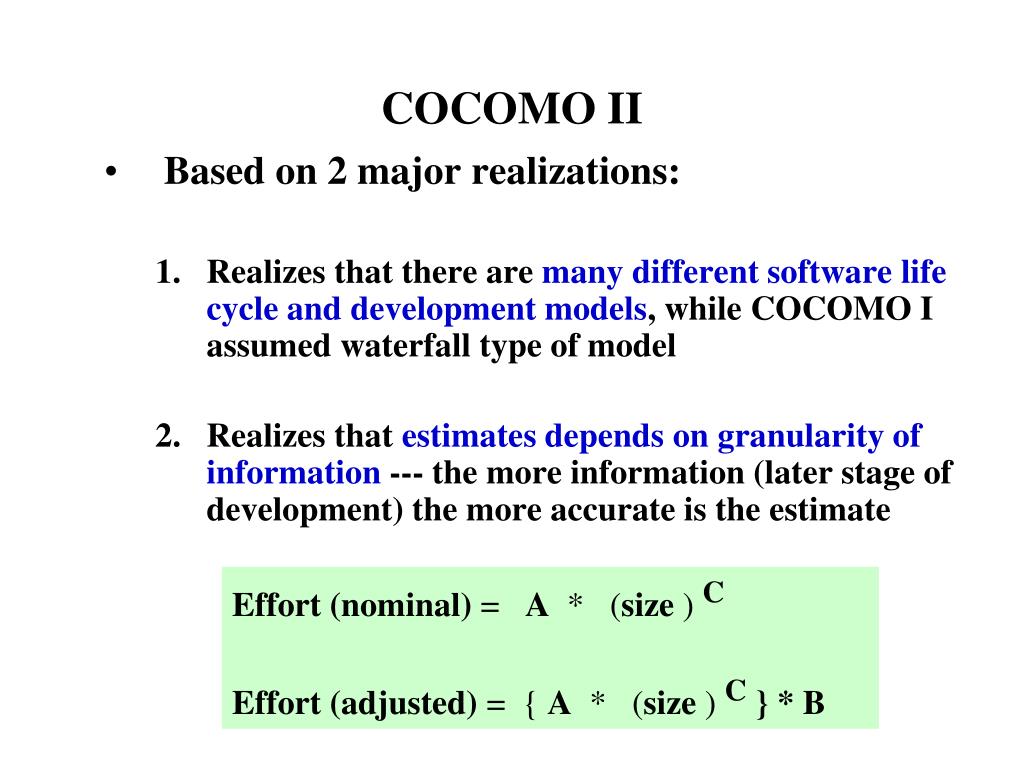

  16. COCOMO II • Based on 2 major realizations: • Realizes that there are many different software life cycle and development models, while COCOMO I assumed waterfall type of model • Realizes that estimates depends on granularity of information --- the more information (later stage of development) the more accurate is the estimate Effort (nominal) = A * (size )C Effort (adjusted) = { A * (size )C } * B

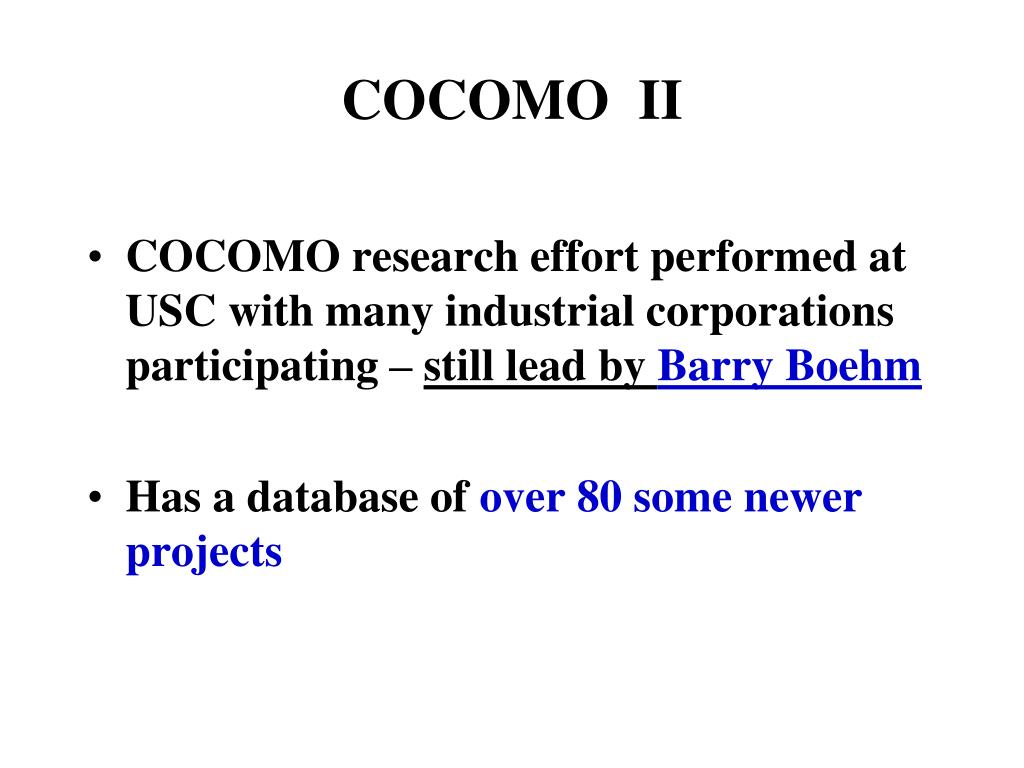

  17. COCOMO II • COCOMO research effort performed at USC with many industrial corporations participating – still lead by Barry Boehm • Has a database of over 80 some newer projects

  18. COCOMO II emphasis • COCOMO II - Effort (nominal) = A * (size )C: • Removal of “modes”: Instead of the 3 “modes,” which use 8 characteristics to determine the modes, use 5 factors to determine the scaling coefficient, “C” • Precedentedness • Flexibility • Risk • Team cohesion • Process maturity • COCOMO II - Effort (adjusted) = A * (size )C * B : • For Early Estimate, preferred to use Function Pointinstead of LOC for size (loc is harder to estimate without some experience). Coefficient “B” rolled up to 7 cost drivers (1. prod reliability & complex; 2. reuse req.; 3. platform difficulty; 4. personnel; 5. personnel experience; 6 facility; 7. schedule) • ForPost-Architecture Estimates, may use either loc or function points. Coefficient “B” use 17 cost drivers, expanded form the 7 cost drivers (e.g. personnel expands into 1) analyst capability; 2) programmer capability, 3) personnel continuity)

  19. Function Point • A non-LOC based estimator • Often used to assess software “complexity” and “size” • Started by Albrecht of IBM in late 1970’s

  20. Function Point (product size/complexity) • Gained momentum in the 1990’s with IFPUG as software service industry looked for a metric • Function Point does provide some advantages over loc • language independent • don’t need the actual lines of code to do the counting • takes into account of different entities • Some disadvantages include : • complex to come up with the final number • consistency (data reliability) varies by people --- although IFPUG membership and training have improved on this

  21. Function Point Metric via GQM* • Goal : Measure the Size of Software • Question: What is the size of a software in terms of its: • Data files • Transactions • Metrics: Function Points ---- (defined in this lecture) * GQM is a methodology invented and advocated by V. Basili of U. of Maryland

  22. FP Utility • Where is FP used? • Comparing software in a “normalized fashion” independent of op. system, languages, etc. • Benchmarking and Projection based on “size”: • size -> cost or effort • size -> development schedule • size -> defect rate • Outsourcing Negotiation

  23. Methodology(“extended version” --- compared to your text) Composed of 3 major steps: • Identify and Classifying: • Data • Transactions • Evaluation of Complexity Levels of Data and Transactions • Compute the Functional Point

  24. 1. Identifying & Classifying 5 “Basic Entities” • Data: • Internally generated and stored (logical files and tables) • Data maintained externally and requires an external interface to access (external interfaces) • Transactions: • Information or data entry into a system for transaction processing (inputs) • Information or data “leaving” the system such as reports or feeds to another application (outputs) • Information or data retrieved and displayed on the screen in response to query (query)

  25. 2. Evaluating Complexity • Using a complexity table, each of the 5 basic entities is evaluated as : • Low (simple) • Average • High (complex) • 3 attributes are used for the above complexity table decisions • # ofRecord Element Types (RET): e.g. employee data type, student record type • # of unique attributes (fields) or Data Element Types (DET) for each record : e.g. name, address, employee number, and hiring date would make 4 DETs for employee data stype • # ofFile Type Referenced (FTR): e.g an external payroll record file that needs to be accessed

  26. 5 Basic Entity Types uses the RET, DET, and FTRfor Complexity Evaluation For -- Internal Logical Files and External Interfacesdata entities: # of RET1-19 DET20-50 DET50+ DET 1 Low Low Ave 2 -5 Low Avg High 6+ Avg High High For -- Input, Output and Query transactions: # of FTR1-4 DET5 -15 DET16+ DET 0 - 1 Low Low Ave 2 Low Avg High 3+ Avg High High

  27. Example • Consider a requirement: “has the feature to add a new employee to the “system.” • Assume employee information involves 3 external files that each has a different Record Element Types (RET) • Employee Basic Information has employee data records • Each employee record has 55 fields (1 RET and 55 DET) - AVERAGE • Employee Benefits records • Each benefit record has 10 fields (1 RET and 10 DET) - LOW • Employee Tax records • Each tax record has 5 fields ( 1 RET and 5 DET) - LOW • Adding a new employee involves 1 input transaction which involves 3 file types referenced (FTR) and a total of 70 fields (DET). So for the 1 input transaction the complexity is HIGH

  28. Function Point (FP) Computation • Composed of 5 “Basic Entities” • input items (external input items from user or another application) • output items (external outputs such as reports, messages, screens – not each data item) • Queries (a query that results in a response of one or more data) • master and logical files (internal file or data structure or data table) • external interfaces (data or sets of data sent to external devices, applications, etc.) • And a “complexity level index” matrix : Simple(low) Complex (high) Average 3 4 6 Input 5 7 Output 4 3 Query 4 6 Logical files 7 10 15 Ext. Interface & file 7 5 10

  29. Function Point Computation (cont.) • Initial Function Point : Σ [Basic Entity x Complexity Level Index] all basic entities Continuing the Example of adding new employee: - 1 external interface (average) = 7 - 1 external interface (low) = 5 - 1 external interface (low) = 5 - 1 input (high) = 6 Initial Function Point = 7 + 5 + 5 + 6 = 23 Note that ---- this just got us to Initial Function Point

  30. Function Point Computation (cont.) • Initial Function Point : ∑ (Basic Entity x Complexity Level Index) is modified by 14 DI’s • There are 14 more “Degree of Influences” ( 0 to 5 scale) : • data communications • distributed data processing • performance criteria • heavy hardware utilization • high transaction rate • online data entry • end user efficiency • on-line update • complex computation • reusability • ease of installation • ease of operation • portability • maintainability These form the 14 DIs

  31. Function Point Computation (cont.) • Define Technical Complexity Factor (TCF): • TCF = .65 + [(.01) x (14 DIs )] • where DI = ∑ ( influence factor value) • So note that .65 ≤ TCF ≤ 1.35 Function Point (FP) = Initial FP x TCF Finishing the earlier Example: for the example, assume TCF came out to be 1.15, then Function Point = 23 x 1.15 = 26.45

  32. Function Point • Provides you another way to estimate the “size” of the project based on estimating 5 basic entities : • Inputs • Outputs • Logical Files • External Interfaces • Queries • (note : the text book algorithm is earlier, simplified version) (important) • ** Then --- still need to have an estimate on productivity e.g. function point/person-month • ***Divide the estimated total project function points (size) by the productivity to get an estimate of “effort” in person-month or person-days needed. - - - - - - - - - - - - - - - - - - - - - - - -
