Presentation at Graduate Student Day, 2012 Inter-Block Yard Crane Scheduling

Presentation at Graduate Student Day, 2012 Inter-Block Yard Crane Scheduling a t a Marine Container Terminal by Omor Sharif, Nathan Huynh, Mashrur Chowdhury , Jose Vidal Paper submitted to International Journal of Transportation Science and Technology.

morey
Télécharger la présentation

Presentation at Graduate Student Day, 2012 Inter-Block Yard Crane Scheduling

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Presentation at Graduate Student Day, 2012 Inter-Block Yard Crane Scheduling at a Marine Container Terminal by Omor Sharif, Nathan Huynh, MashrurChowdhury, Jose Vidal Paper submitted to International Journal of Transportation Science and Technology

  2. A Very Brief Review of A Container Terminal! • An interface between ocean and land transport • Containers are loaded/unloaded to/from a ship • Operation involves a large number of decisions • Capacity Constraints, Environmental Concerns etc

  3. Research problem and Motivation • Container Yard and Yard Crane (YC) • A container yard is made up of several blocks of containers • Workload varies among blocks during operational hours • Efficiency of YCs impacts truck waiting/ship waiting time • Assign/relocate YCs among blocks to finish most work • Known as Interblock YC Scheduling Problem

  4. Model Assumptions • Total operational hours is divided in several planning periods • A workload forecast for blocks is known at start (time-units) • At most two cranes work at a block at the same time • At most one transfer per planning period • Other operations will not introduce delay • 10 minutes transfer time for each longitudinal block traveled

  5. Initial Assignment of yard cranes

  6. Three Principal Parameters

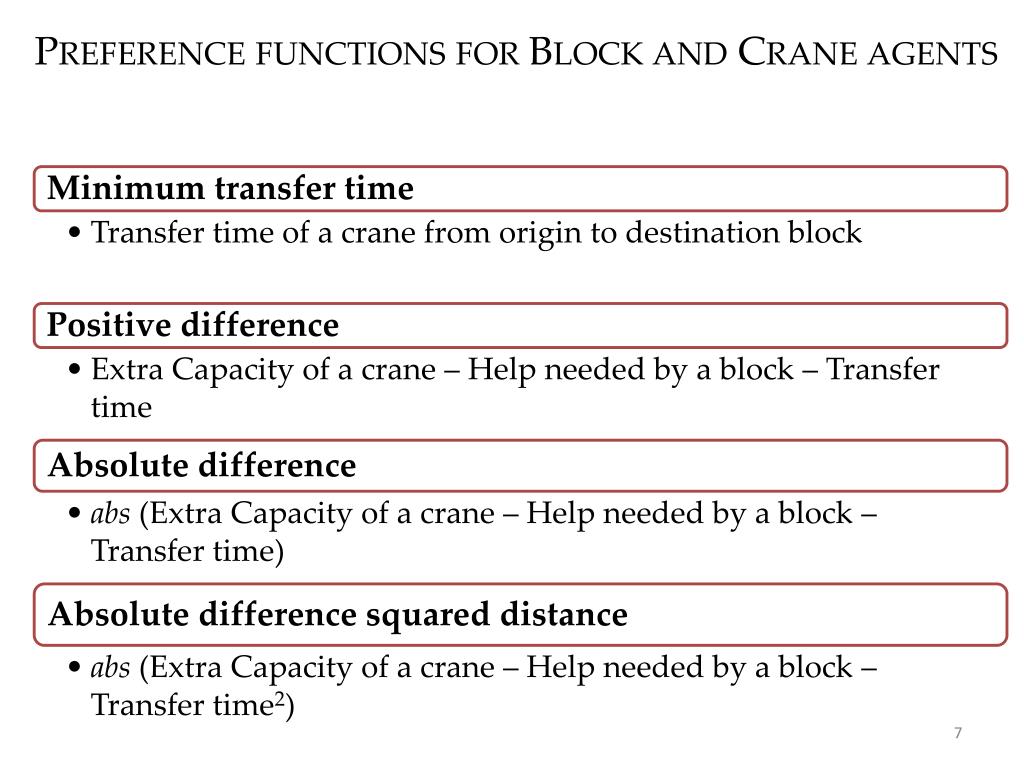

  7. Preference functions for Block and Crane agents

  8. An algorithm to assign cranes to blocks • 1. Each crane j proposes to first block i from its preference list • 2. Each block i receiving more than qi proposals, ‘holds’ the most preferred qi cranes and rejects all others. • n. Each crane j rejected at step n − 1 removes the block i rejecting the crane from its preference list. • Then the rejected crane j makes a new proposal to its next most preferred block i who hasn’t yet rejected it. • Go to step n − 1.

  9. Implementation • Multi-agent simulation GUI • Implemented in NETLOGO • Stationary block and Mobile crane agents

  10. Design of Experiments

  11. ResultsPercentage incomplete work volume: Case I - average number of cranes per block = 1.0

  12. Results (Contd..)Percentage incomplete work volume: Case II - average number of cranes per block = 1.5

  13. Summary of Findings • Future Work Concluding remarks • In ‘medium’ condition all work can be finished • In ‘heavy’ condition the percentage incomplete is 1% or less • In ‘above capacity’ condition the percentage remaining is within 3% of the lower bound. • Scalable; a test case with 30 blocks can be solved within 3 seconds • Consider relocating cranes multiple time • Include forecasts for multiple planning periods • Solve integrated problems involving other related decisions

  14. Thank YouQuestions ?

  15. A sample example
