1 / 11

FieldNet 2.x Enhancement

FieldNet 2.x Enhancement. TUG – September 8, 2003 Andres Marin, Info Tech Inc. Project Scope Objectives. Replace the manual processes used by Michigan DOT to ensure effective synchronization and balance between CAS and FieldManager

moriah
Télécharger la présentation

FieldNet 2.x Enhancement

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. FieldNet 2.x Enhancement TUG – September 8, 2003 Andres Marin, Info Tech Inc.

  2. Project Scope Objectives • Replace the manual processes used by Michigan DOT to ensure effective synchronization and balance between CAS and FieldManager • Minimize user involvement and to automate the actual transfer of data between FieldManager and CAS regardless of geographic distances. This will remove many potential points of failure inherent in the current physical transfer of data. • Use new technologies and methodologies to ensure that all data transfers are completed successfully or else completely rolled back with the state of both databases corrected.

  3. Project Scope Objectives (cont) • Built on Internet standards allowing the ubiquitous, secure and inexpensive automation of business processes. • Implement a scalable and flexible architectural design for future enhancements. • Data transfers will be authenticated, authorized, reliable, secure, accurately routed and delivered to the correct destination.

  4. Project Milestones

  5. Project Phases Scope Overview

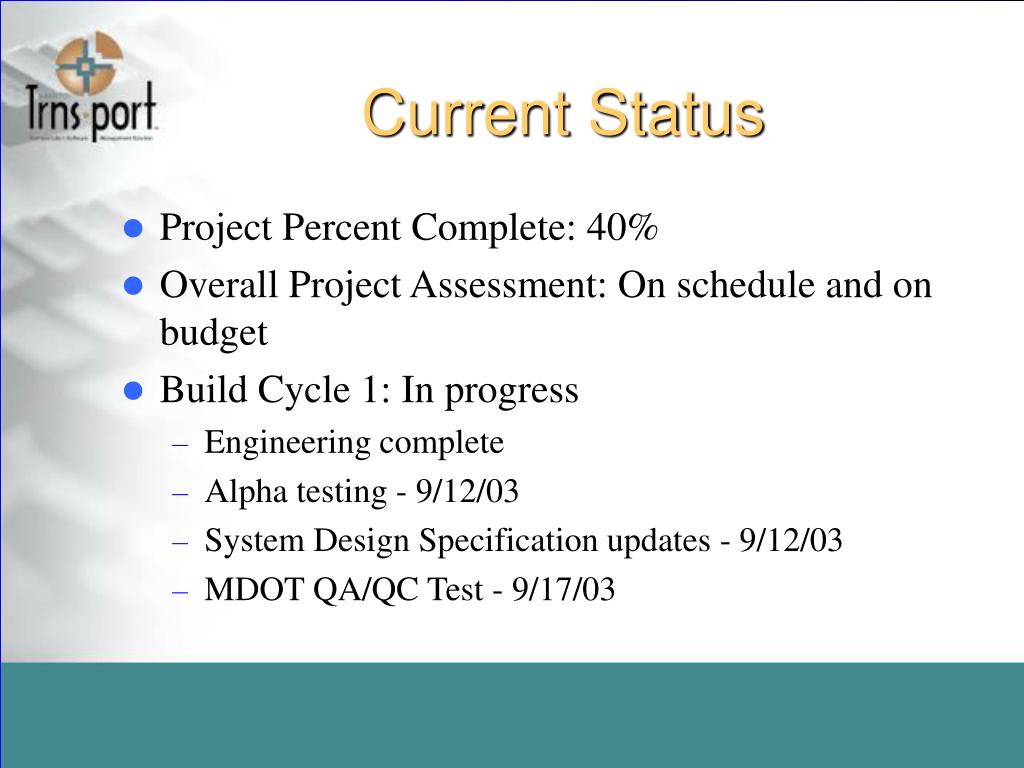

  6. Current Status • Project Percent Complete: 40% • Overall Project Assessment: On schedule and on budget • Build Cycle 1: In progress • Engineering complete • Alpha testing - 9/12/03 • System Design Specification updates - 9/12/03 • MDOT QA/QC Test - 9/17/03

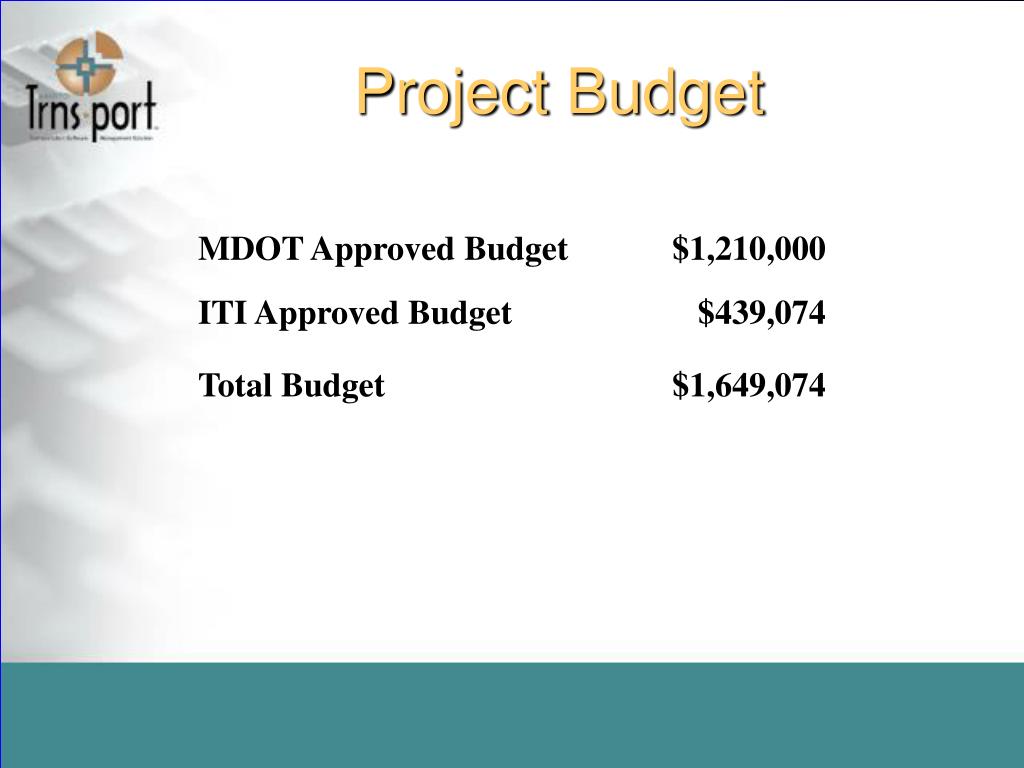

  7. Project Budget

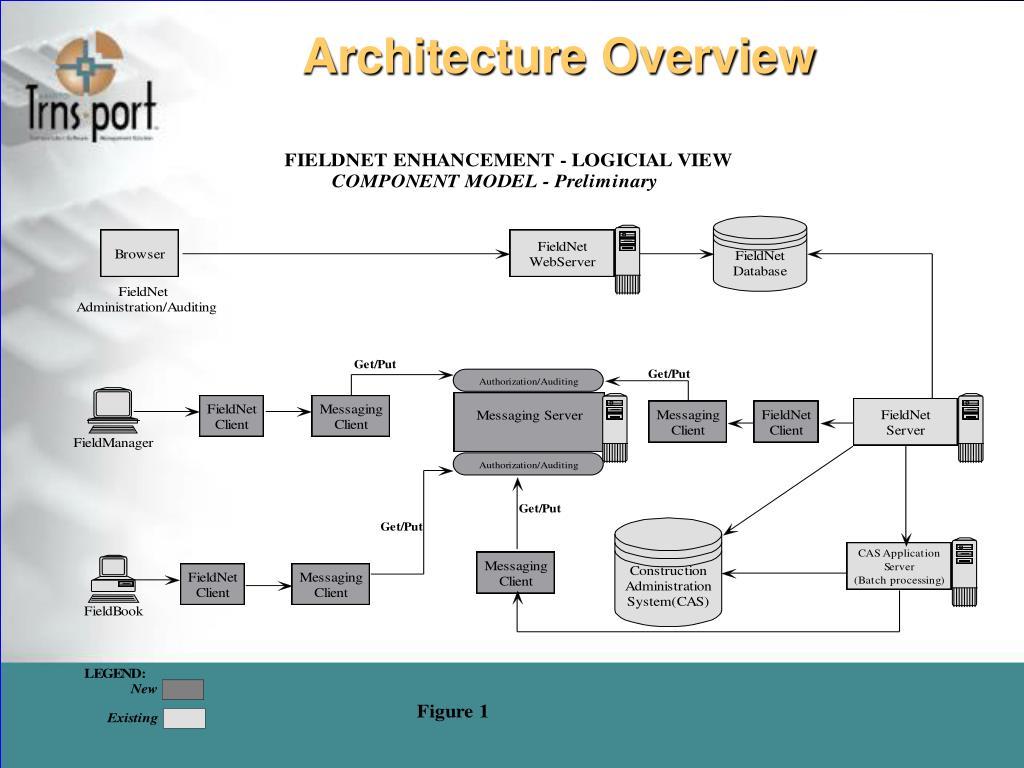

  8. Architecture Overview

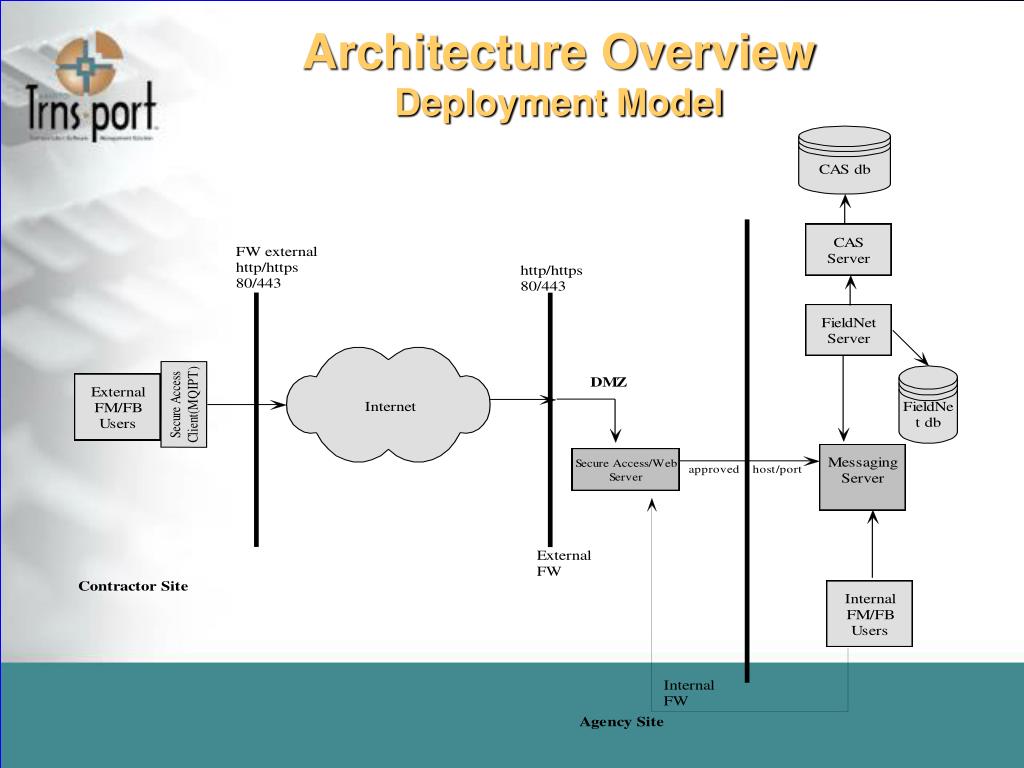

  9. Architecture OverviewDeployment Model

  10. Project Risks - Summary • Key Risk Mitigations • Synchronization with FM • Synchronization with CAS • Synchronization with FM / SM Interface

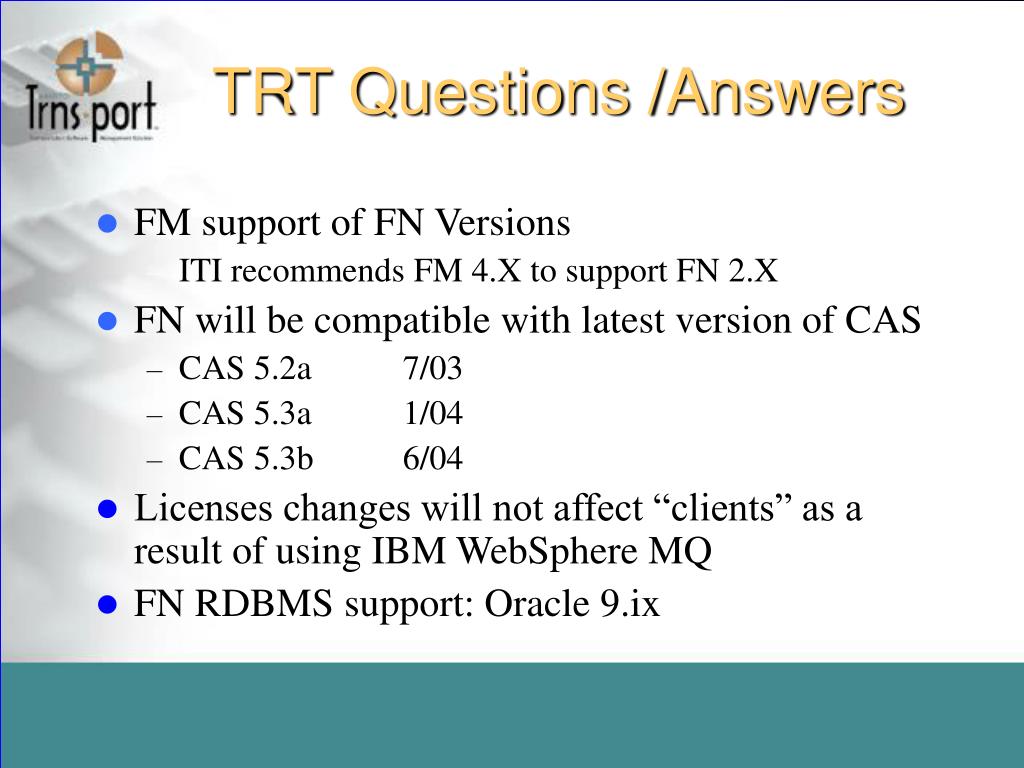

  11. TRT Questions /Answers • FM support of FN Versions • ITI recommends FM 4.X to support FN 2.X • FN will be compatible with latest version of CAS • CAS 5.2a 7/03 • CAS 5.3a 1/04 • CAS 5.3b 6/04 • Licenses changes will not affect “clients” as a result of using IBM WebSphere MQ • FN RDBMS support: Oracle 9.ix

More Related
