1 / 12

Microsoft Project 2010 Demo Part 2

Microsoft Project 2010 Demo Part 2 . Problem 2.8: Enter Tasks. Enter tasks and times for problem 2.8. Be sure to click Project/Project Information to set project starting date. Setting Time Units. To change time units go to File/Options. Click on Schedule tab. Change duration.

nerina
Télécharger la présentation

Microsoft Project 2010 Demo Part 2

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Microsoft Project 2010 Demo Part 2

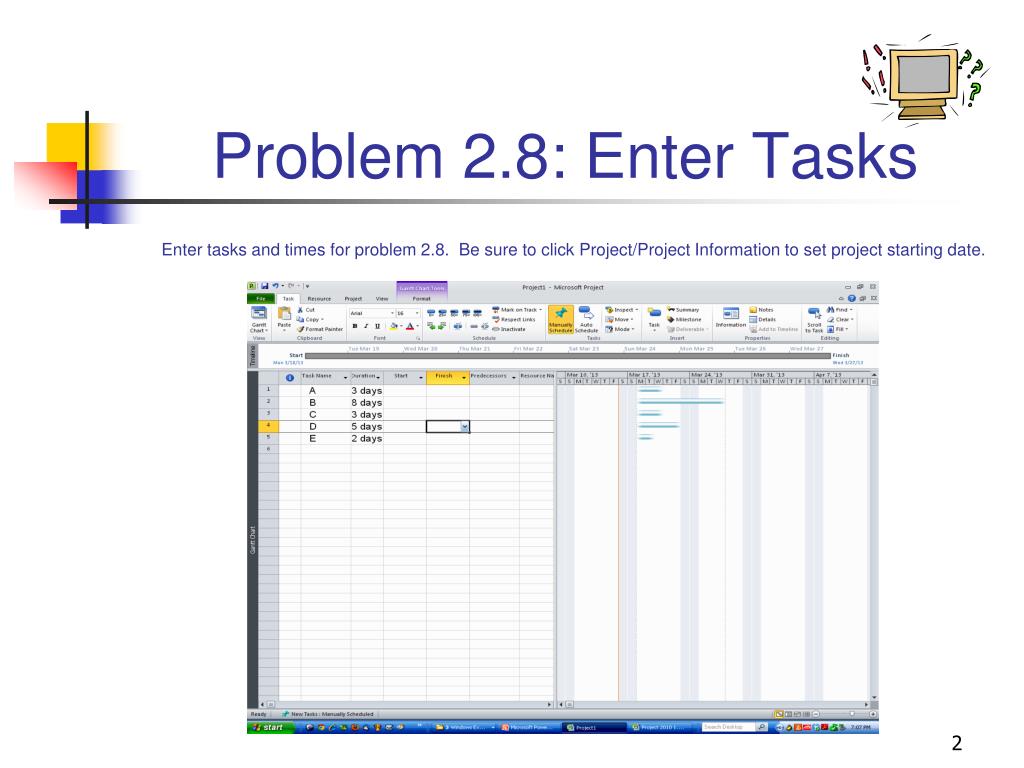

  2. Problem 2.8: Enter Tasks Enter tasks and times for problem 2.8. Be sure to click Project/Project Information to set project starting date.

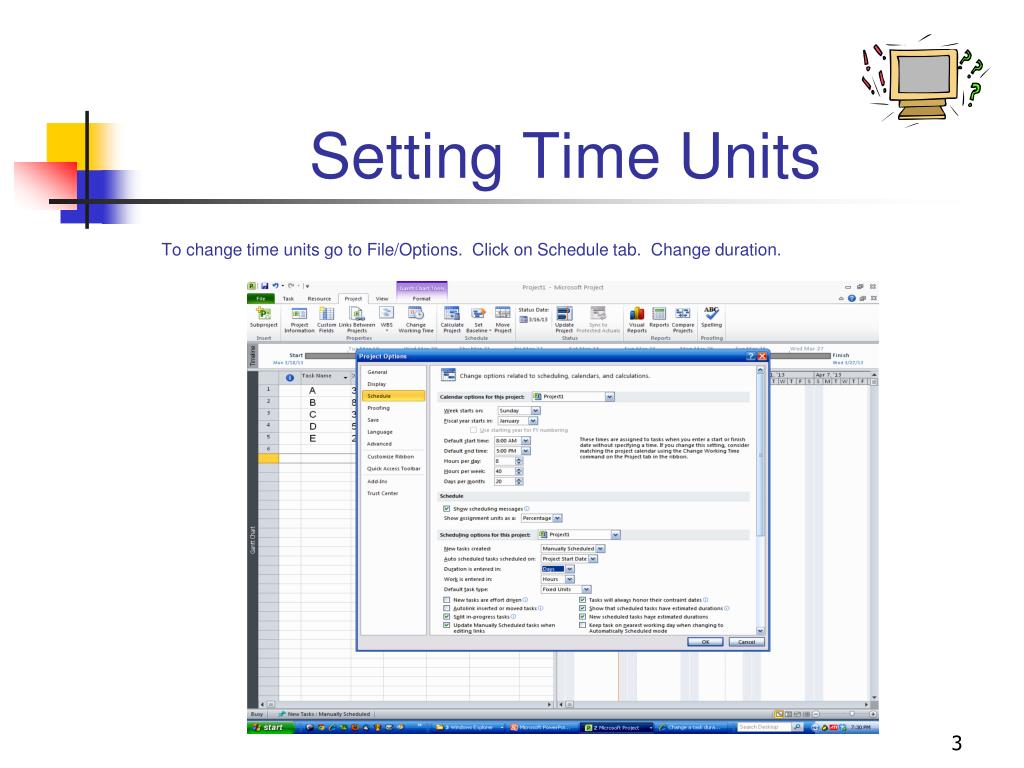

  3. Setting Time Units To change time units go to File/Options. Click on Schedule tab. Change duration.

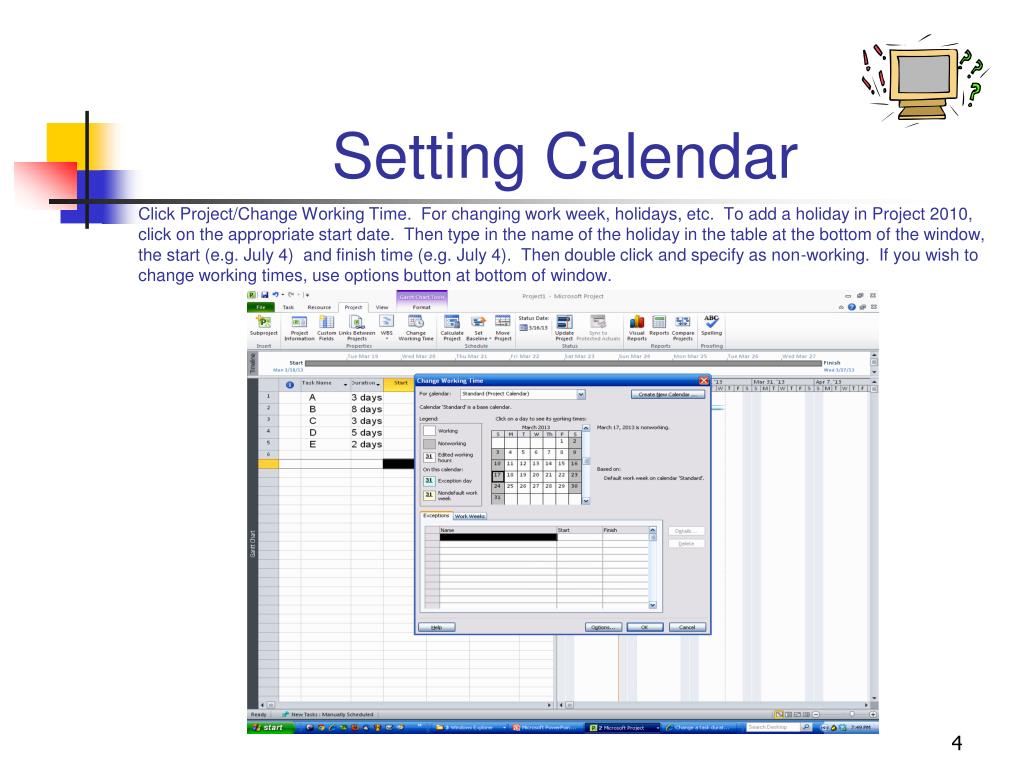

  4. Setting Calendar Click Project/Change Working Time. For changing work week, holidays, etc. To add a holiday in Project 2010, click on the appropriate start date. Then type in the name of the holiday in the table at the bottom of the window, the start (e.g. July 4) and finish time (e.g. July 4). Then double click and specify as non-working. If you wish to change working times, use options button at bottom of window.

  5. Resource Use by Task Double click on each task. Click Resources tab. Label resource Labor and enter in units used by each task. At same time also enter in predecessors.

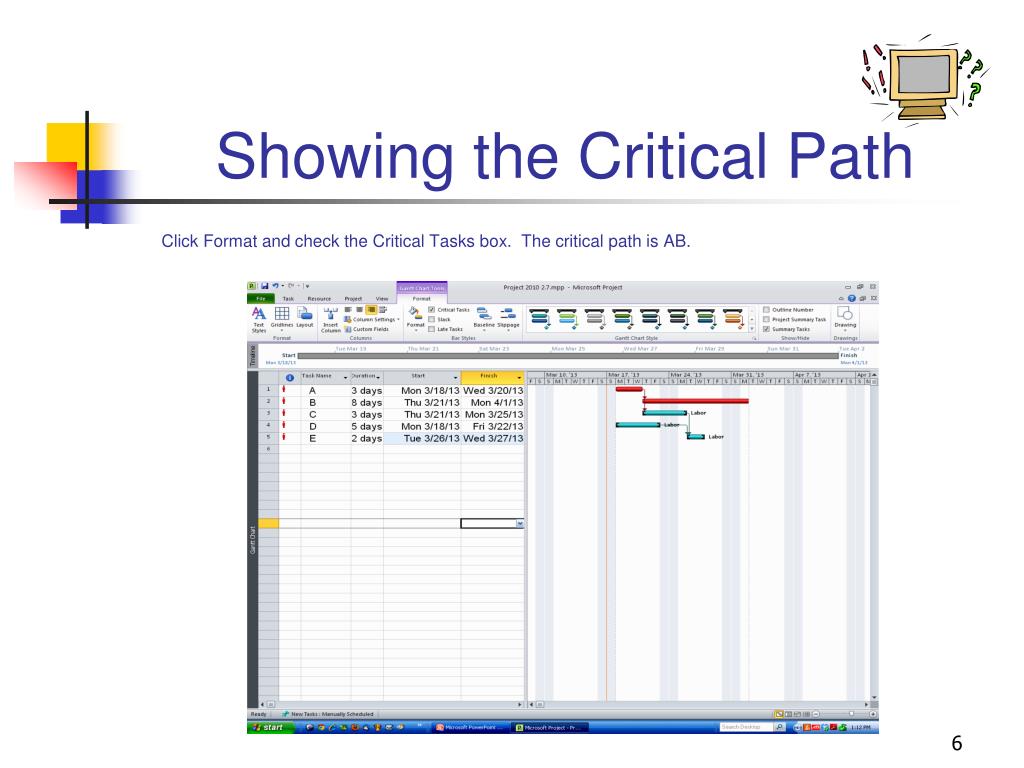

  6. Showing the Critical Path Click Format and check the Critical Tasks box. The critical path is AB.

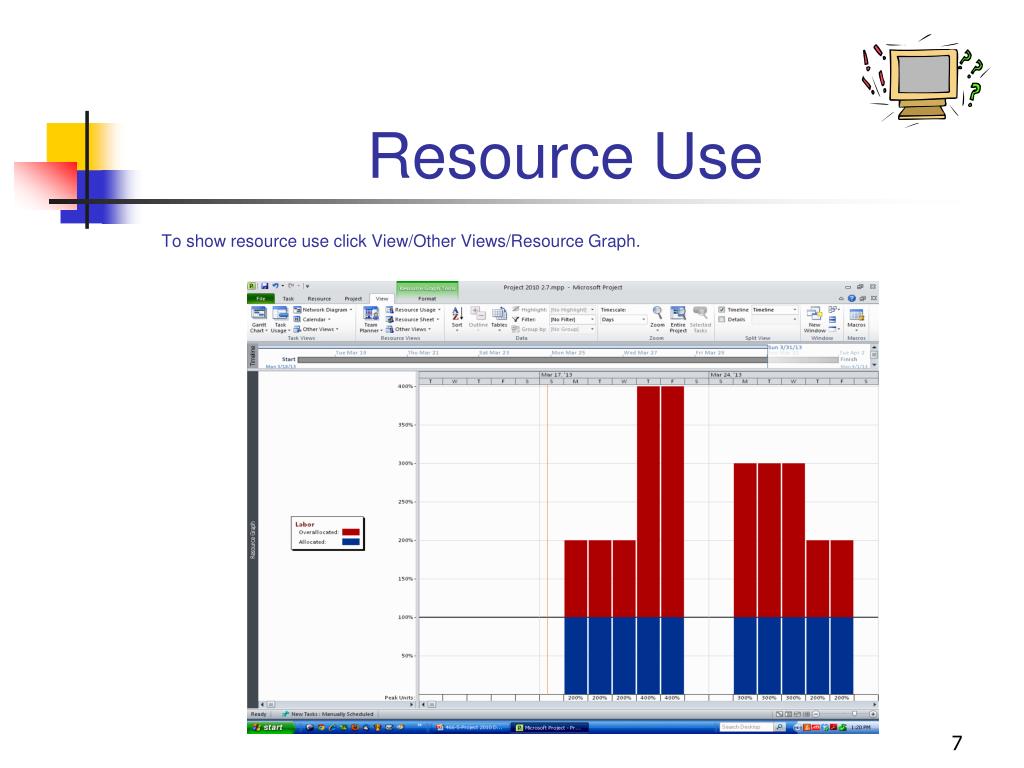

  7. Resource Use To show resource use click View/Other Views/Resource Graph.

  8. Resource Availability Click Resource/Information (You need to do this while you are in resource use view). In Resource Information window, enter dates resource is available and maximum units available.

  9. Resource Balanced Schedule To level resources click Resource/Level Resource. Check the Level Now box.

  10. Resource Balanced Schedule To see Gantt Chart click View/Gantt Cart.

  11. Beware of Indicator Icon To remove indicator, double click task with icon. Open the Advanced tab. Set constraint type to “as soon as possible”.

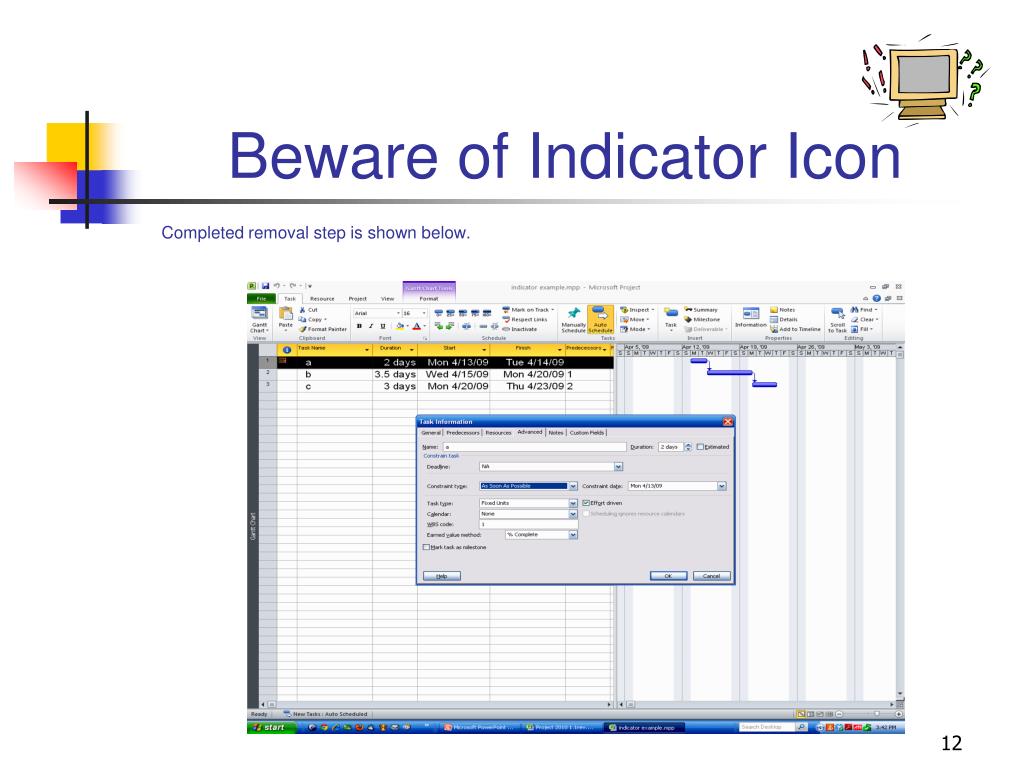

  12. Beware of Indicator Icon Completed removal step is shown below.

More Related
