Southeast AWWA District Meeting

Reducing THM via Aeration: A Case Study November 21, 2013 by Gary Williams, P.E. Jones & Henry Engineers. Southeast AWWA District Meeting. Agenda. Location History Pilot Implementation Take Away Information. Location Map. Distribution System Map. Water Quality 2008. THM 2008.

nerina
Télécharger la présentation

Southeast AWWA District Meeting

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. Reducing THM via Aeration: A Case StudyNovember 21, 2013by Gary Williams, P.E.Jones & Henry Engineers Southeast AWWA District Meeting

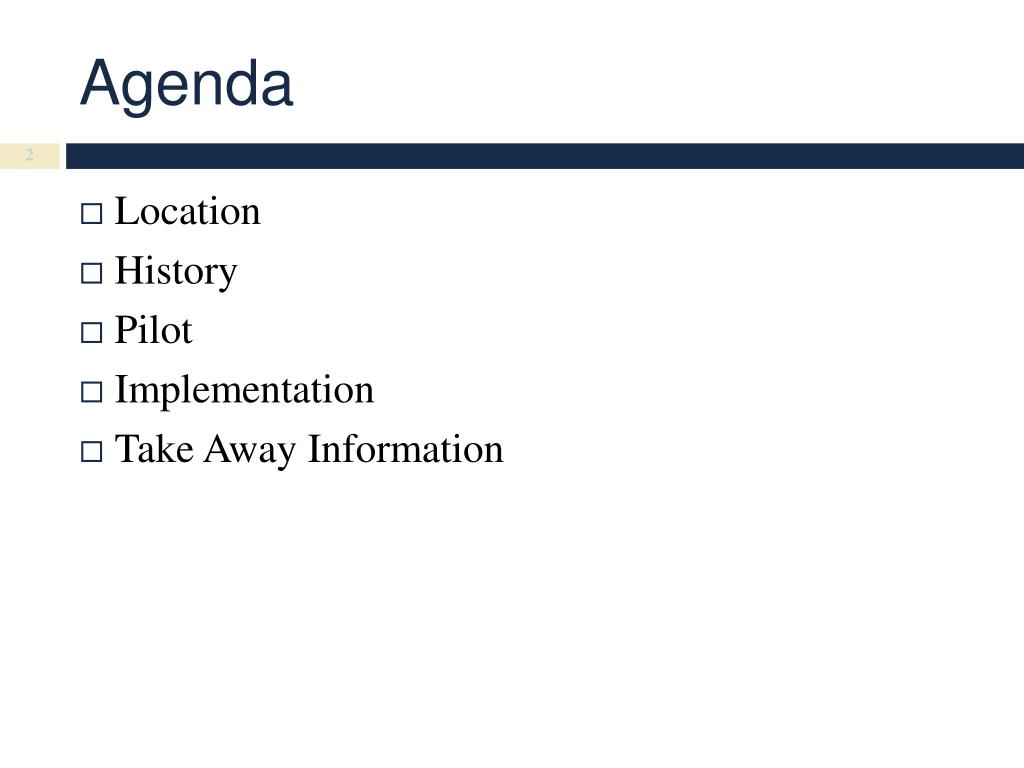

  2. Agenda • Location • History • Pilot • Implementation • Take Away Information

  3. Location Map

  4. Distribution System Map

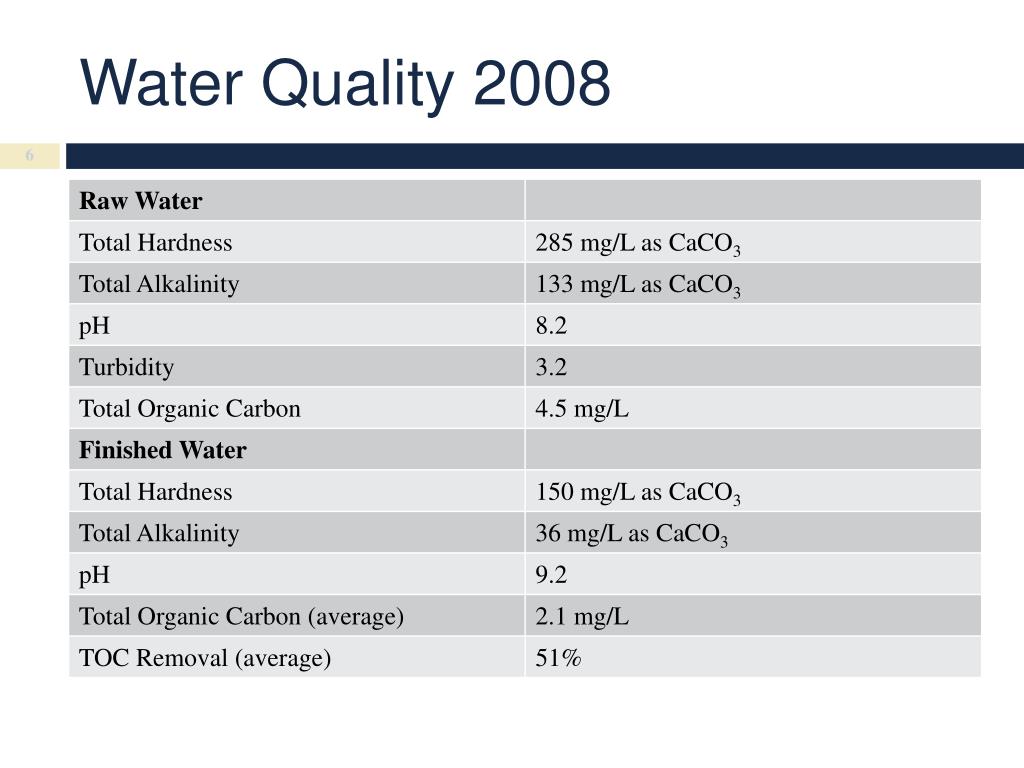

  5. Water Quality 2008

  6. THM 2008

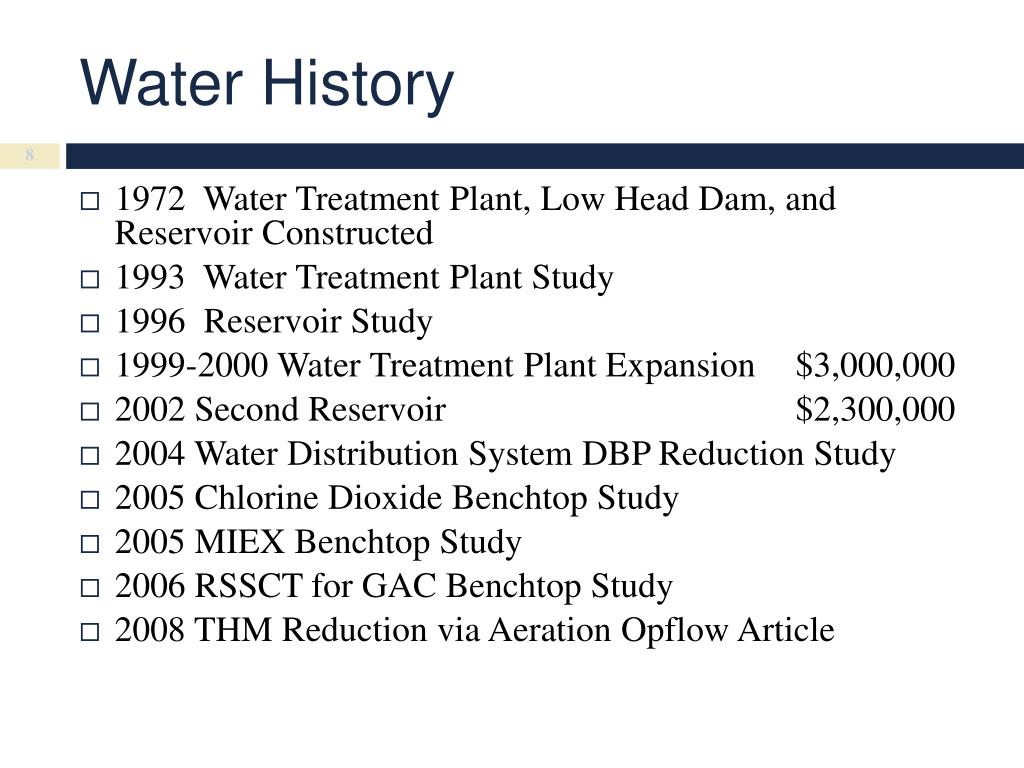

  7. Water History • 1972 Water Treatment Plant, Low Head Dam, and Reservoir Constructed • 1993 Water Treatment Plant Study • 1996 Reservoir Study • 1999-2000 Water Treatment Plant Expansion $3,000,000 • 2002 Second Reservoir $2,300,000 • 2004 Water Distribution System DBP Reduction Study • 2005 Chlorine Dioxide Benchtop Study • 2005 MIEXBenchtop Study • 2006 RSSCT for GACBenchtop Study • 2008 THM Reduction via Aeration Opflow Article

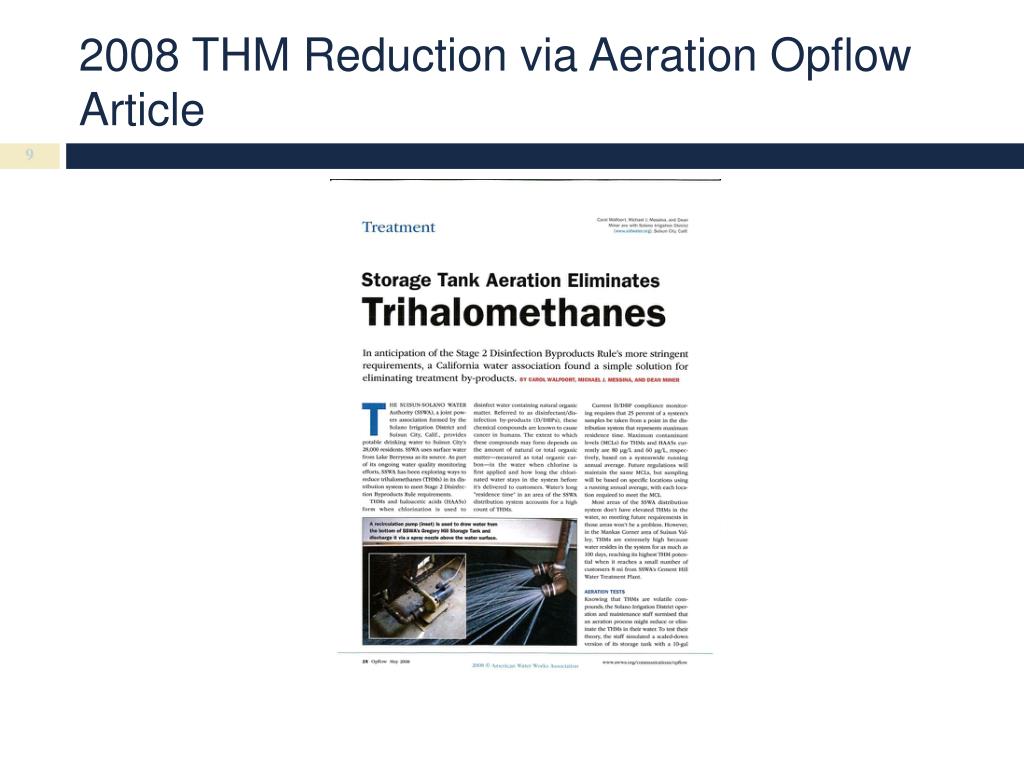

  8. 2008 THM Reduction via Aeration Opflow Article

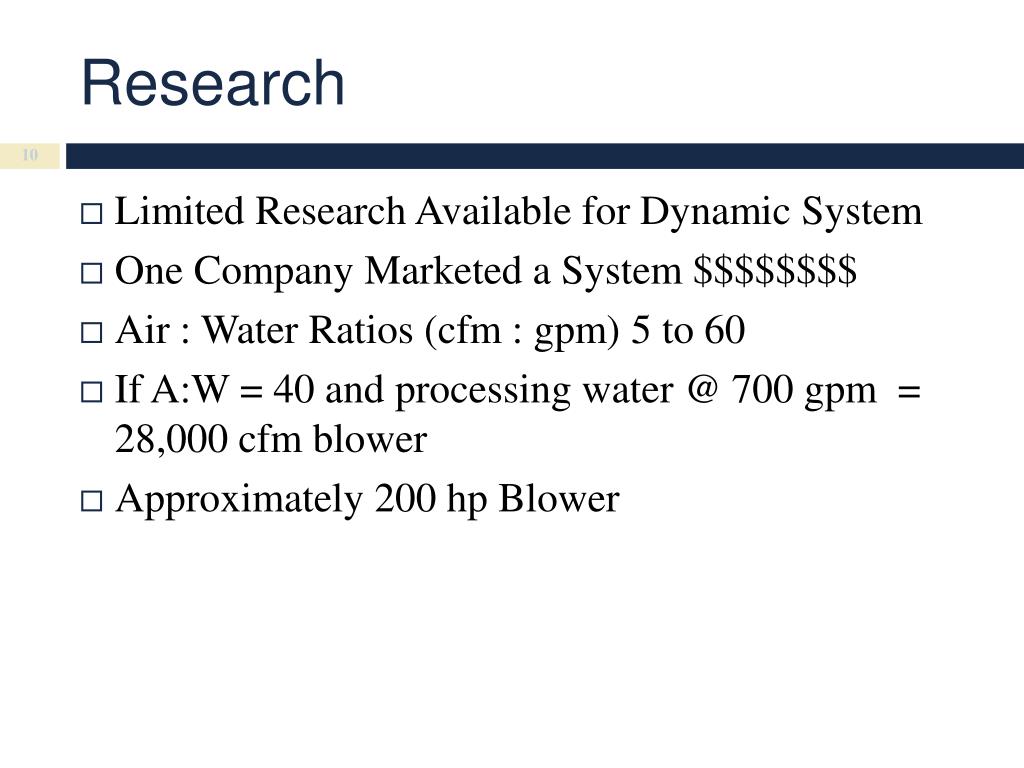

  9. Research • Limited Research Available for Dynamic System • One Company Marketed a System $$$$$$$$ • Air : Water Ratios (cfm : gpm) 5 to 60 • If A:W = 40 and processing water @ 700 gpm = 28,000 cfm blower • Approximately 200 hpBlower

  10. Pilot • Assumed 20:1 A:W ratio or 14,000 cfm • Determined Approximate Area Diffusors for 14,000 cfm in Clearwell 2 • Assumed One/half Depth of Clearwell or 7 feet • Calculated the Volume over the Diffusors • Developed the Detention Times in the Three Celled Clearwell • Influent Cell 60 minutes • Aeration Cell 75 minutes • Effluent Cell 60 minutes • Scaled down the flows of air and water to match a 4-inch PVC pipe

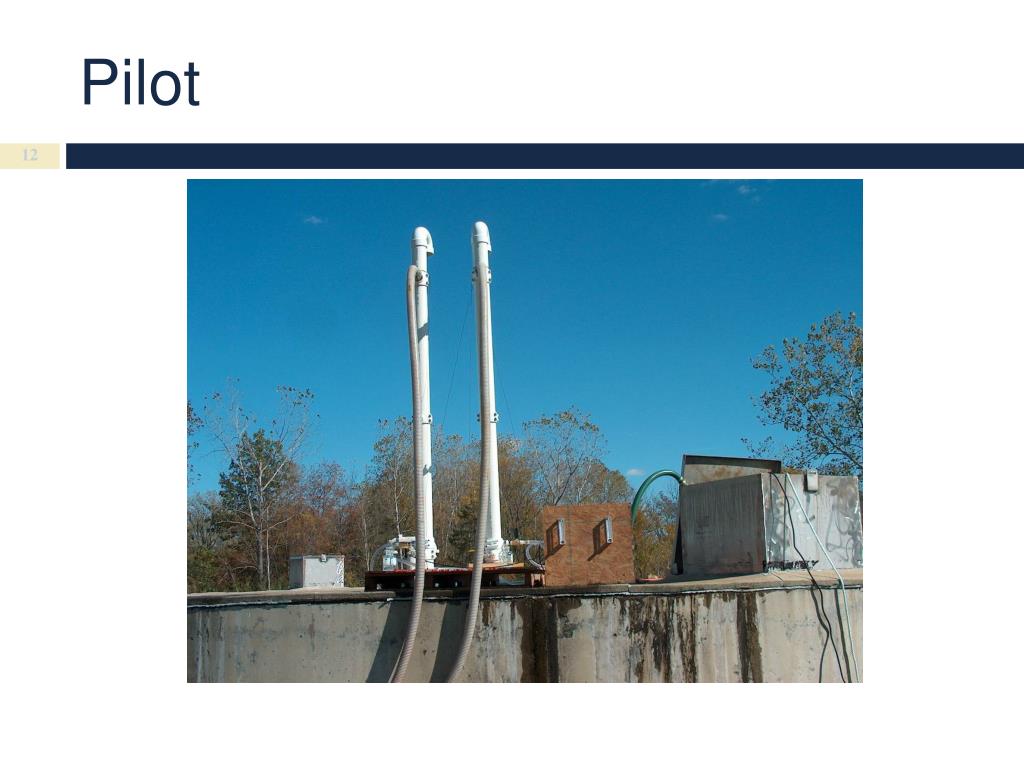

  11. Pilot

  12. Test Pipe Arrangement

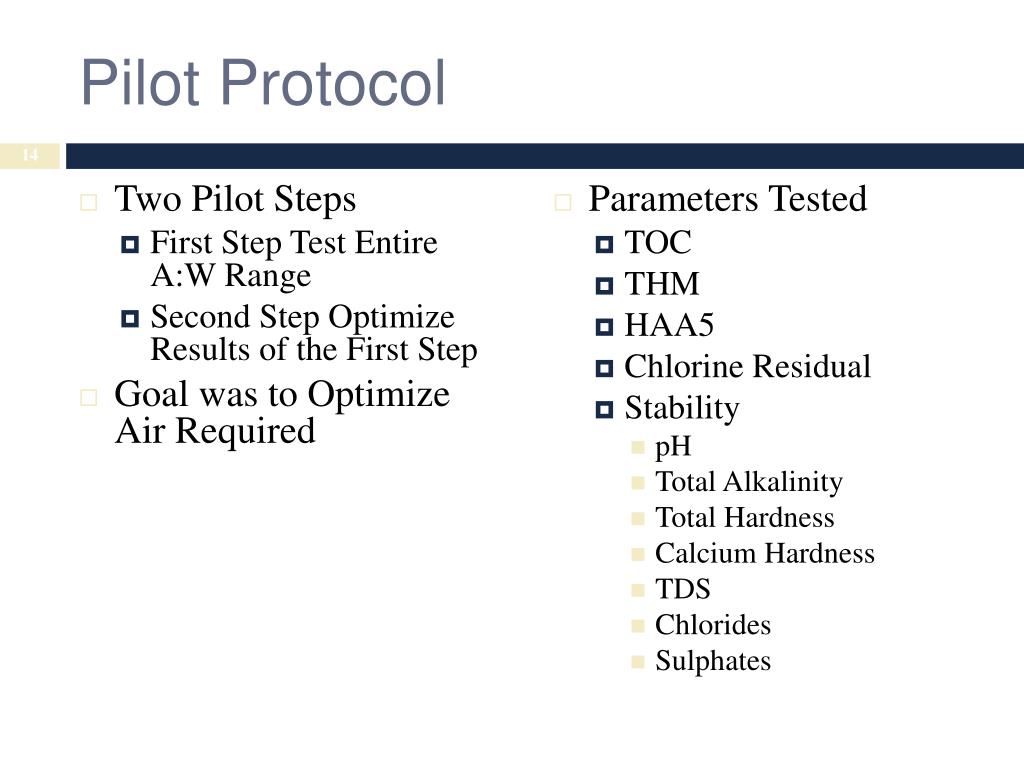

  13. Pilot Protocol • Two Pilot Steps • First Step Test Entire A:W Range • Second Step Optimize Results of the First Step • Goal was to Optimize Air Required • Parameters Tested • TOC • THM • HAA5 • Chlorine Residual • Stability • pH • Total Alkalinity • Total Hardness • Calcium Hardness • TDS • Chlorides • Sulphates

  14. Pilot Results

  15. Pilot Results

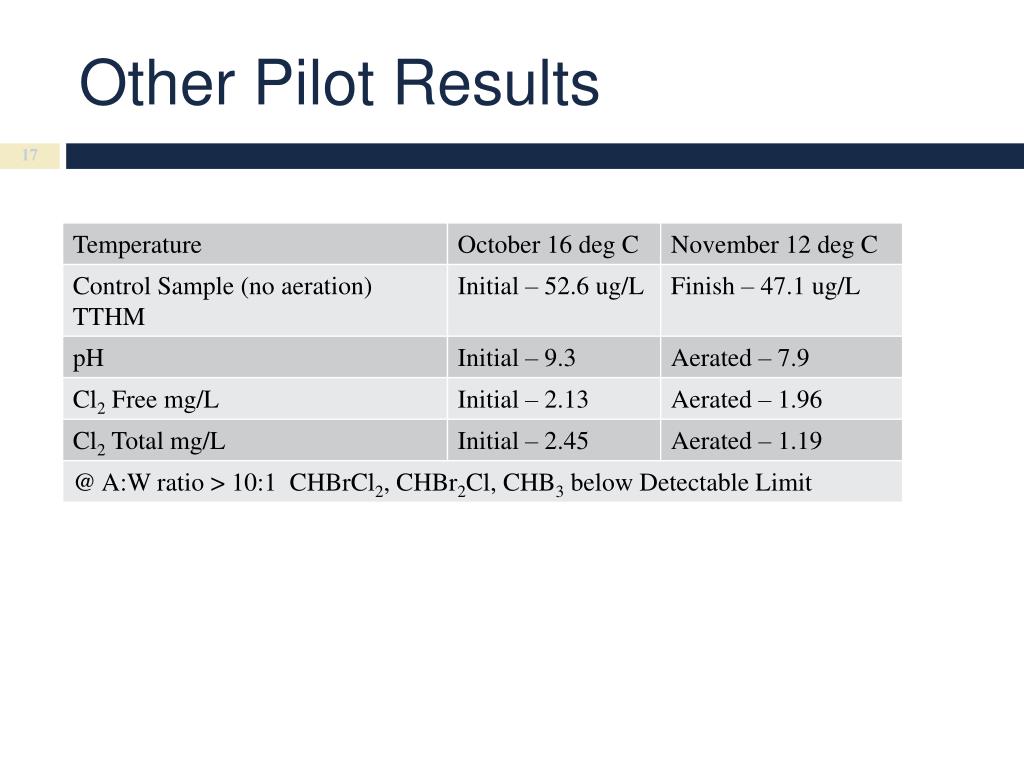

  16. Other Pilot Results

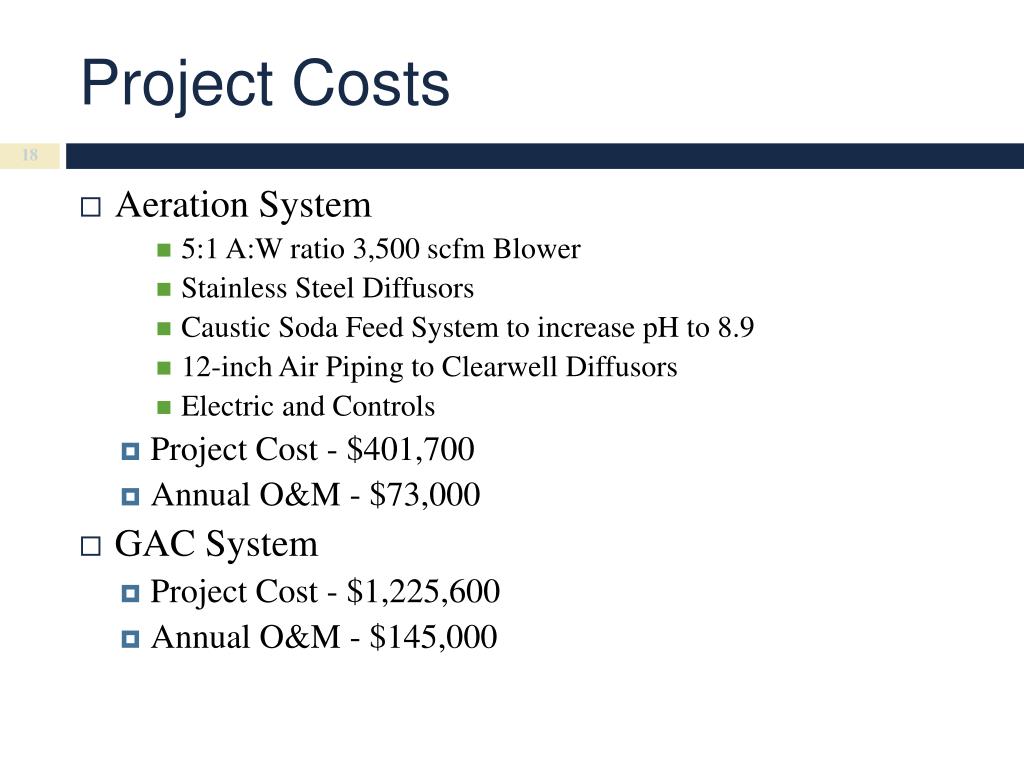

  17. Project Costs • Aeration System • 5:1 A:W ratio 3,500 scfm Blower • Stainless Steel Diffusors • Caustic Soda Feed System to increase pH to 8.9 • 12-inch Air Piping to Clearwell Diffusors • Electric and Controls • Project Cost - $401,700 • Annual O&M - $73,000 • GACSystem • Project Cost - $1,225,600 • Annual O&M - $145,000

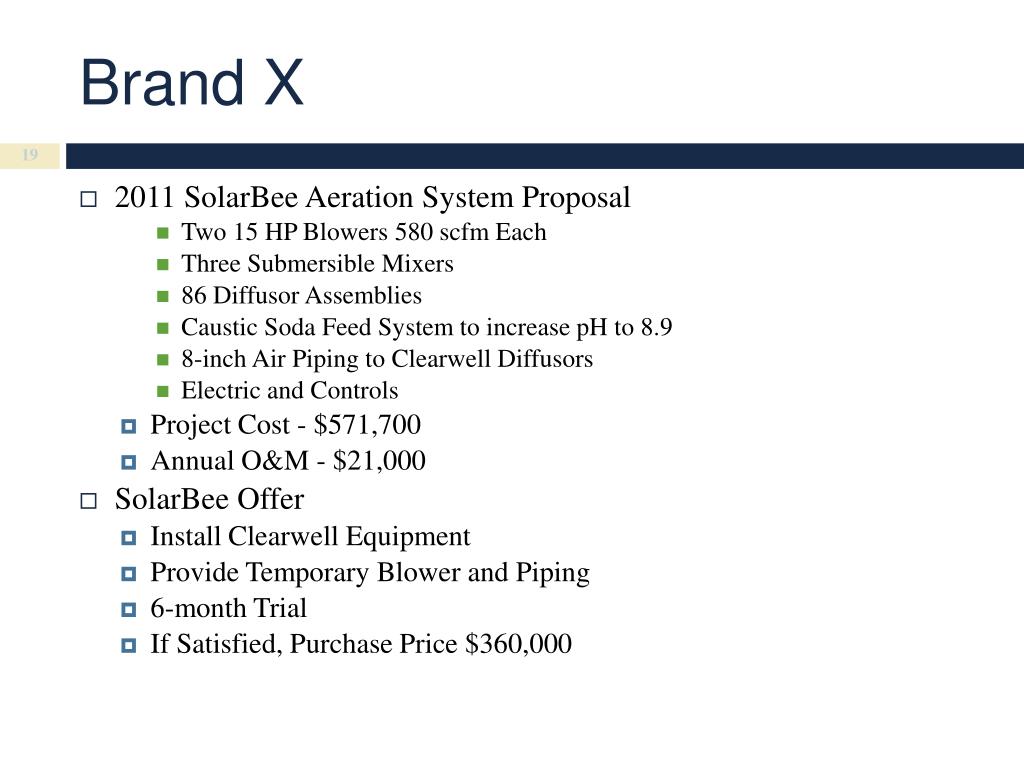

  18. Brand X • 2011 SolarBee Aeration System Proposal • Two 15 HP Blowers 580 scfm Each • Three Submersible Mixers • 86 Diffusor Assemblies • Caustic Soda Feed System to increase pH to 8.9 • 8-inch Air Piping to Clearwell Diffusors • Electric and Controls • Project Cost - $571,700 • Annual O&M - $21,000 • SolarBeeOffer • Install Clearwell Equipment • Provide Temporary Blower and Piping • 6-month Trial • If Satisfied, Purchase Price $360,000

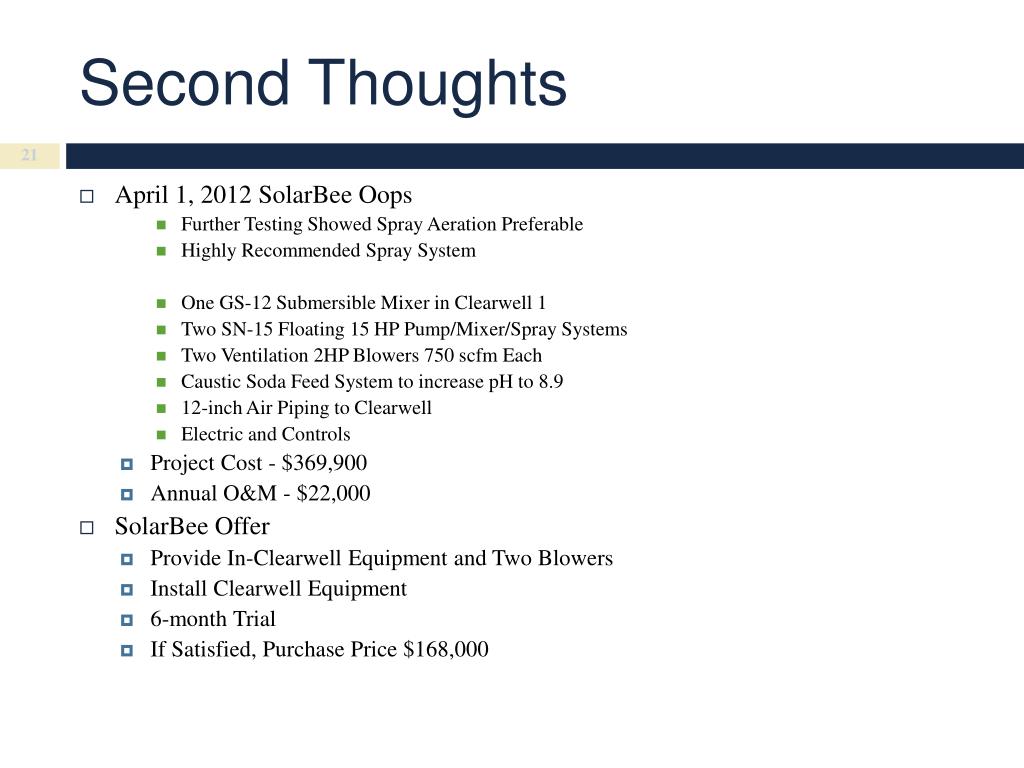

  19. Second Thoughts • April 1, 2012 SolarBee Oops • Further Testing Showed Spray Aeration Preferable • Highly Recommended Spray System • One GS-12 Submersible Mixer in Clearwell 1 • Two SN-15 Floating 15 HP Pump/Mixer/Spray Systems • Two Ventilation 2HP Blowers 750 scfm Each • Caustic Soda Feed System to increase pH to 8.9 • 12-inch Air Piping to Clearwell • Electric and Controls • Project Cost - $369,900 • Annual O&M - $22,000 • SolarBeeOffer • Provide In-Clearwell Equipment and Two Blowers • Install Clearwell Equipment • 6-month Trial • If Satisfied, Purchase Price $168,000

  20. Schedule • Bid – October 2012 • Preconstruction Meeting – November 2012 • Substantial Completion – March 2013 • Total Completion – June 2013

  21. TTHM Summary (all values TTHM in ppb, except where noted)

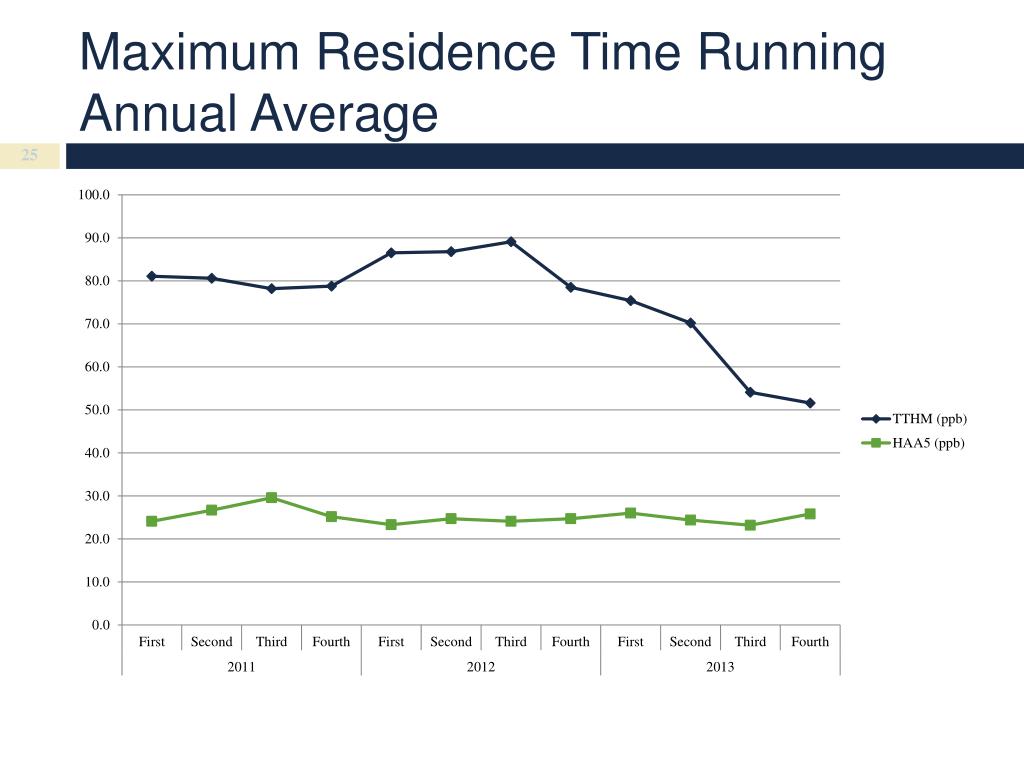

  22. Maximum Residence Time Running Annual Average

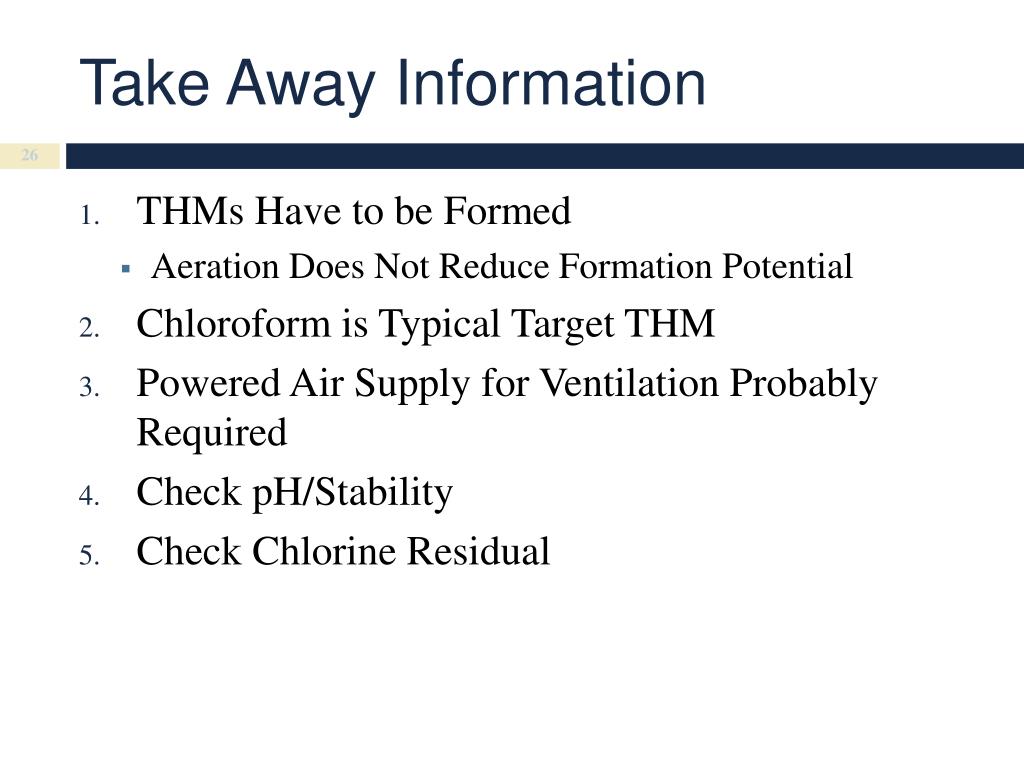

  23. Take Away Information • THMsHave to be Formed • Aeration Does Not Reduce Formation Potential • Chloroform is Typical Target THM • Powered Air Supply for Ventilation Probably Required • Check pH/Stability • Check Chlorine Residual
