Splitters 2

Aimants MDLV240206 et MDLV240209 à retirer. Chambre à remplacer durant la campagne vide. Splitters 2. Aimant MDLV à retirer. 1 mSv /h. 6 mSv /h. 4 mSv /h. Aimants MDLV240206 et MDLV240209 à retirer. Transfert du cote Jura au cote Salève à l’entrée du TCC2 via le pont roulant.

nibal
Télécharger la présentation

Splitters 2

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

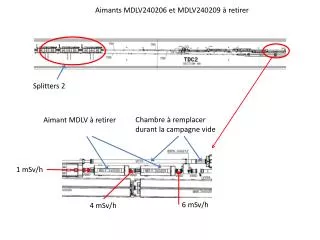

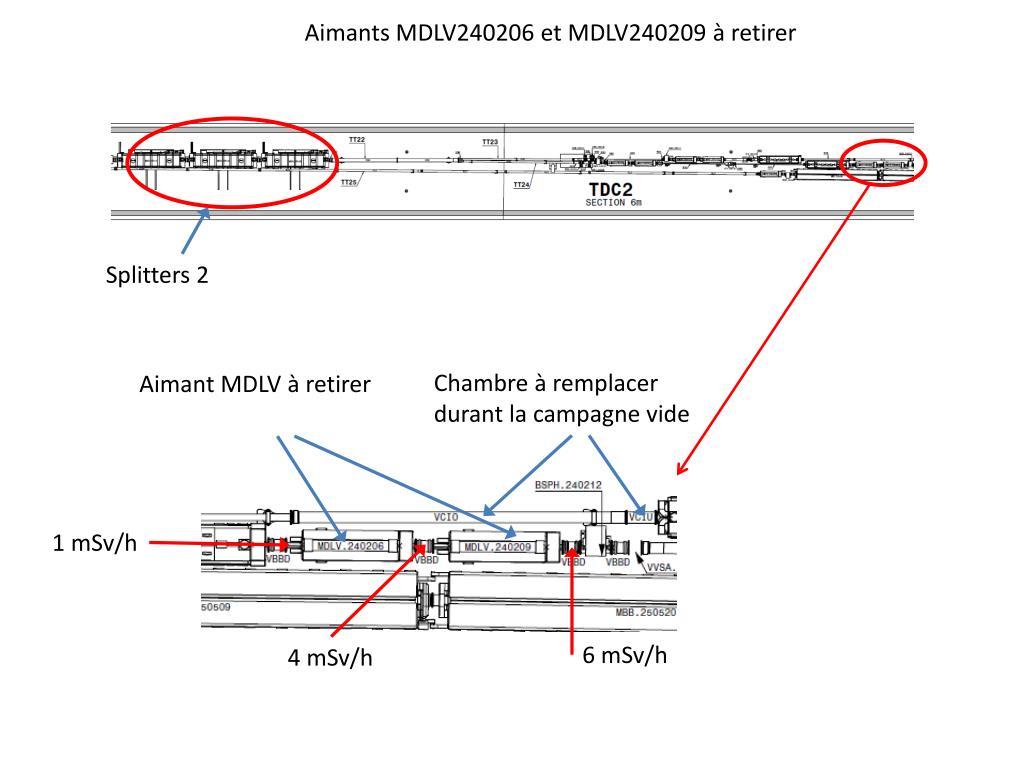

  1. Aimants MDLV240206 et MDLV240209 à retirer Chambre à remplacer durant la campagne vide Splitters 2 Aimant MDLV à retirer 1 mSv/h 6 mSv/h 4 mSv/h

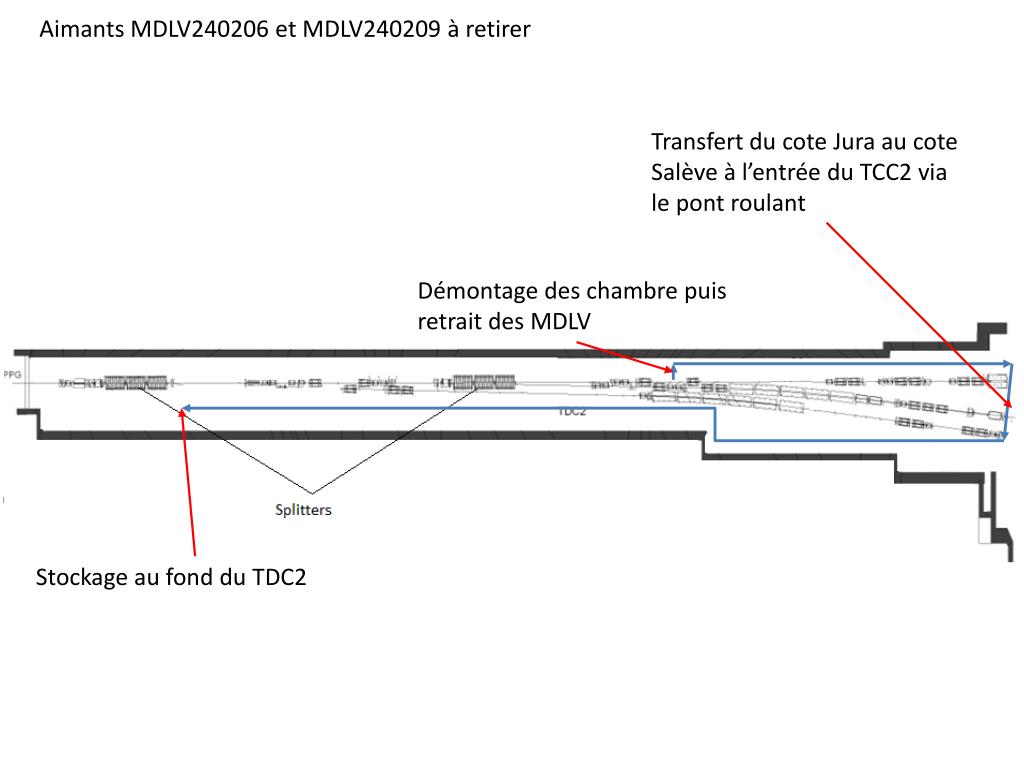

  2. Aimants MDLV240206 et MDLV240209 à retirer Transfert du cote Jura au cote Salève à l’entrée du TCC2 via le pont roulant Démontage des chambre puis retrait des MDLV Stockage au fond du TDC2

  3. Aimants QNL a remplacer dans le TT20 PPG.21161 porte interzone à franchir maintenir ouverte durant l’opération Roulage coté Jura dans le TT20 Aimant QNL a remplacer Réinstallation de l’aimant neuf dans la foulée. Temps total de l’opération: 2-3jours Planification: Apres le retrait du TCSC (environ fin novembre) Transfert coté Jura à coté Salève. Chambre à vide à démonter.
