COSYSMO Application At BAE Systems

COSYSMO Application At BAE Systems. Gan Wang COSYSMO Workshop 23 rd International Forum on COCOMO and Systems/Software Cost Modeling and ICM Workshop USC Campus, Los Angeles, CA Oct. 29 & 30, 2008. COSYSMO Implementation at BAE Systems.

Télécharger la présentation

COSYSMO Application At BAE Systems

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. COSYSMO Application At BAE Systems Gan Wang COSYSMO Workshop 23rd International Forum on COCOMO and Systems/Software Cost Modeling and ICM Workshop USC Campus, Los Angeles, CA Oct. 29 & 30, 2008

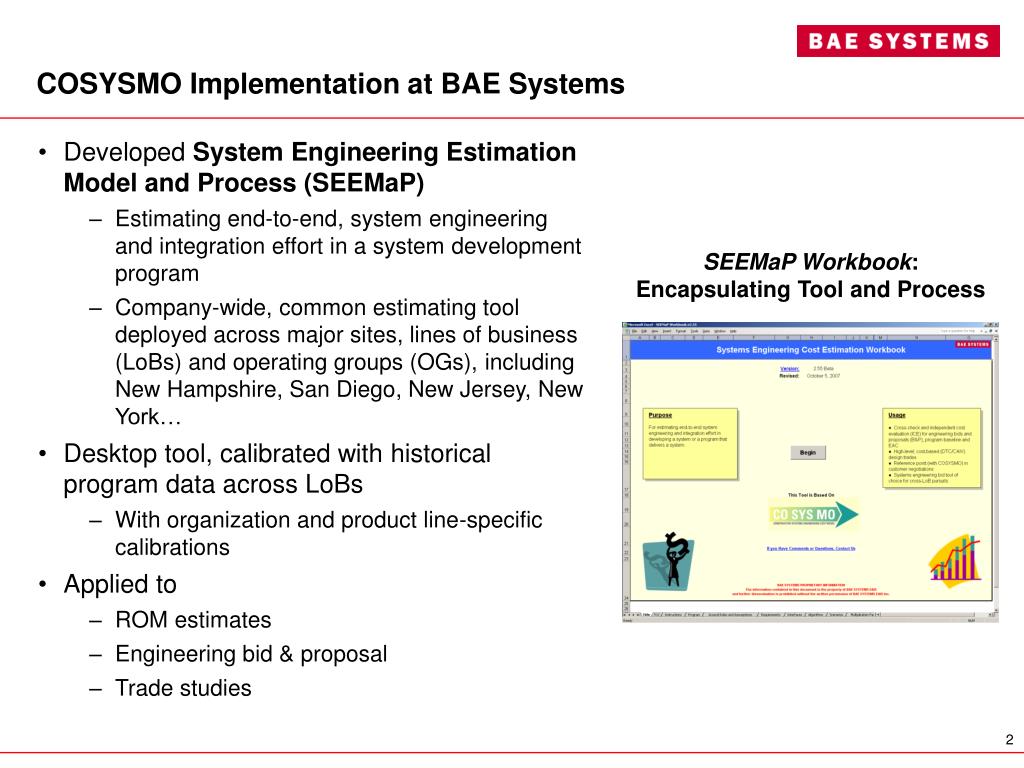

  2. COSYSMO Implementation at BAE Systems • Developed System Engineering Estimation Model and Process (SEEMaP) • Estimating end-to-end, system engineering and integration effort in a system development program • Company-wide, common estimating tool deployed across major sites, lines of business (LoBs) and operating groups (OGs), including New Hampshire, San Diego, New Jersey, New York… • Desktop tool, calibrated with historical program data across LoBs • With organization and product line-specific calibrations • Applied to • ROM estimates • Engineering bid & proposal • Trade studies SEEMaP Workbook: Encapsulating Tool and Process

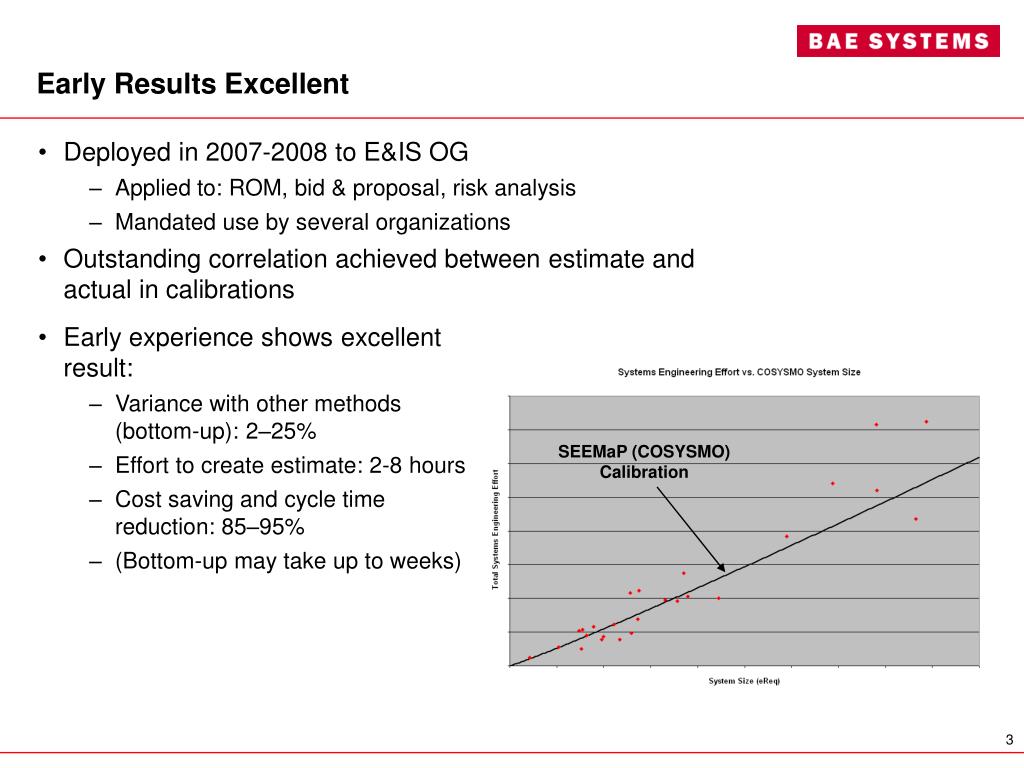

  3. Early Results Excellent • Deployed in 2007-2008 to E&IS OG • Applied to: ROM, bid & proposal, risk analysis • Mandated use by several organizations • Outstanding correlation achieved between estimate and actual in calibrations • Early experience shows excellent result: • Variance with other methods (bottom-up): 2–25% • Effort to create estimate: 2-8 hours • Cost saving and cycle time reduction: 85–95% • (Bottom-up may take up to weeks) SEEMaP (COSYSMO) Calibration

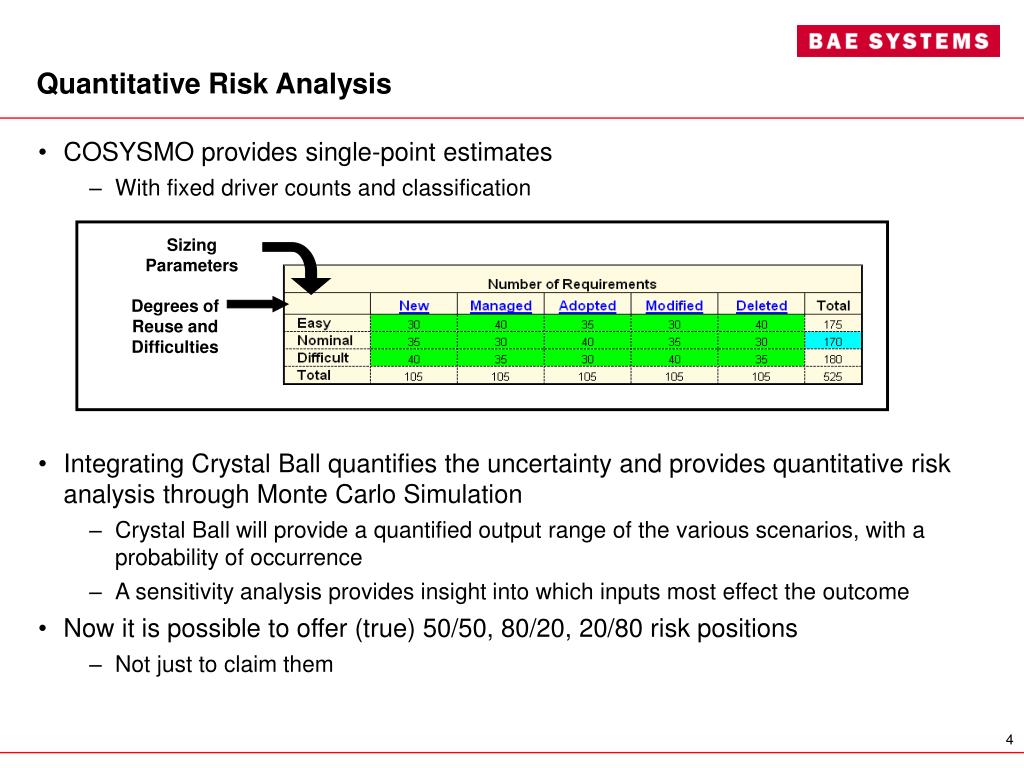

  4. Quantitative Risk Analysis • COSYSMO provides single-point estimates • With fixed driver counts and classification • Integrating Crystal Ball quantifies the uncertainty and provides quantitative risk analysis through Monte Carlo Simulation • Crystal Ball will provide a quantified output range of the various scenarios, with a probability of occurrence • A sensitivity analysis provides insight into which inputs most effect the outcome • Now it is possible to offer (true) 50/50, 80/20, 20/80 risk positions • Not just to claim them Sizing Parameters Degrees of Reuse and Difficulties

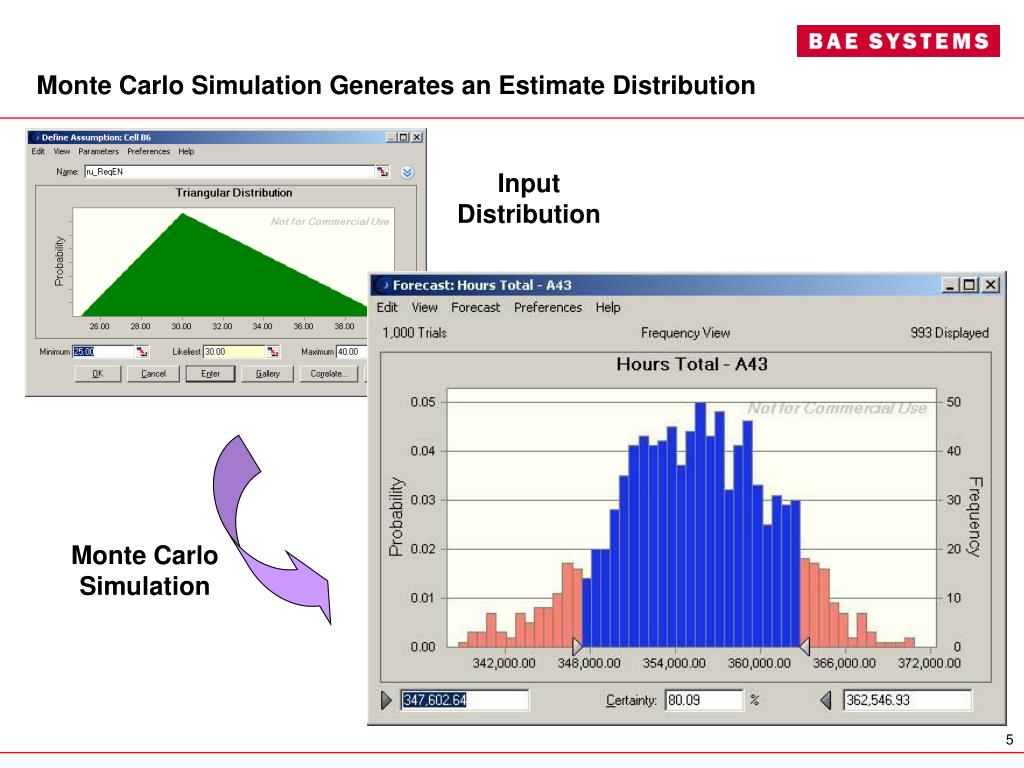

  5. Monte Carlo Simulation Monte Carlo Simulation Generates an Estimate Distribution Input Distribution

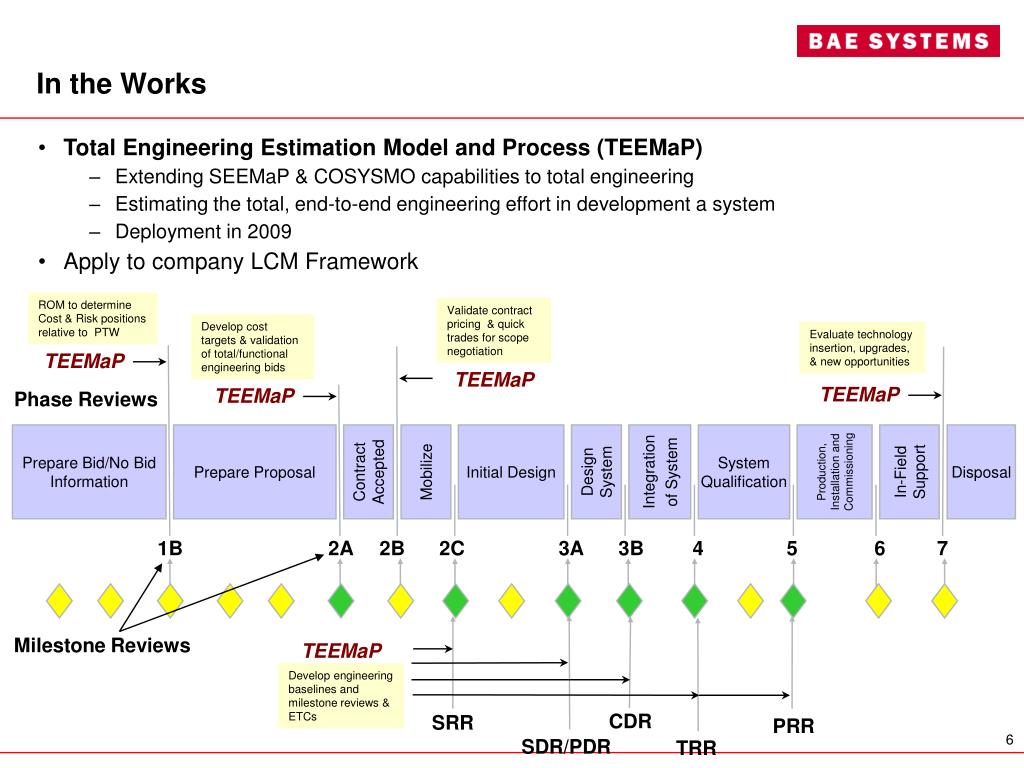

  6. In the Works • Total Engineering Estimation Model and Process (TEEMaP) • Extending SEEMaP & COSYSMO capabilities to total engineering • Estimating the total, end-to-end engineering effort in development a system • Deployment in 2009 • Apply to company LCM Framework ROM to determine Cost & Risk positions relative to PTW Validate contract pricing & quick trades for scope negotiation Develop cost targets & validation of total/functional engineering bids Evaluate technology insertion, upgrades, & new opportunities TEEMaP TEEMaP TEEMaP TEEMaP Phase Reviews Prepare Bid/No Bid Information Prepare Proposal Contract Accepted Mobilize Initial Design Design System Integration of System System Qualification Production, Installation and Commissioning In-Field Support Disposal 1B 2A 2B 2C 3A 3B 4 5 6 7 Milestone Reviews TEEMaP Develop engineering baselines and milestone reviews & ETCs CDR SRR PRR SDR/PDR TRR

  7. Questions and Comments Gan Wang gan.wang@baesystems.com 703-668-4259
