Information for FAHP Project Initiation

Information for FAHP Project Initiation. When a new project begins early coordination, the project proponent (REU or local agency) will alert project stakeholders via E-mail regarding: Project Name Key # Location General concept of project with anticipated activities that may affect species

phoebe
Télécharger la présentation

Information for FAHP Project Initiation

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Information for FAHP Project Initiation • When a new project begins early coordination, the project proponent (REU or local agency) will alert project stakeholders via E-mail regarding: • Project Name • Key # • Location • General concept of project with anticipated activities that may affect species • - e.g., turning lane project with new impervious surface area • Anticipated dates for key project milestones • - e.g., DAP, PS&E, Bid-let • - As best as known at time of Initiation (Page 10)

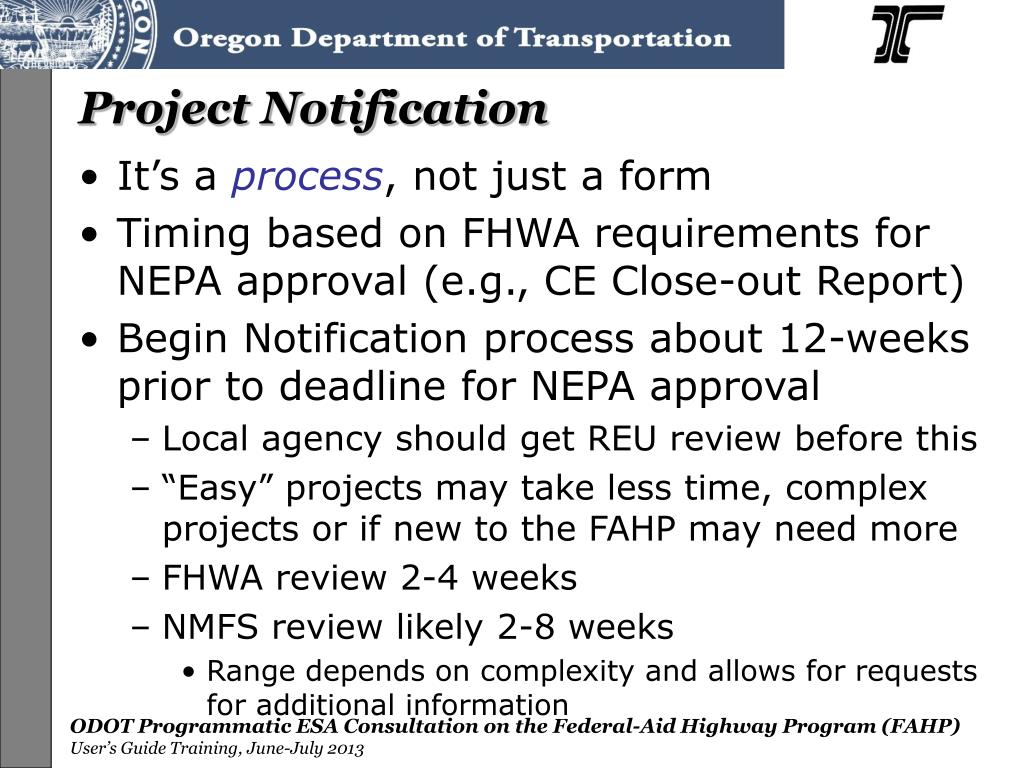

  2. Project Notification • It’s a process, not just a form • Timing based on FHWA requirements for NEPA approval (e.g., CE Close-out Report) • Begin Notification process about 12-weeks prior to deadline for NEPA approval • Local agency should get REU review before this • “Easy” projects may take less time, complex projects or if new to the FAHP may need more • FHWA review 2-4 weeks • NMFS review likely 2-8 weeks • Range depends on complexity and allows for requests for additional information

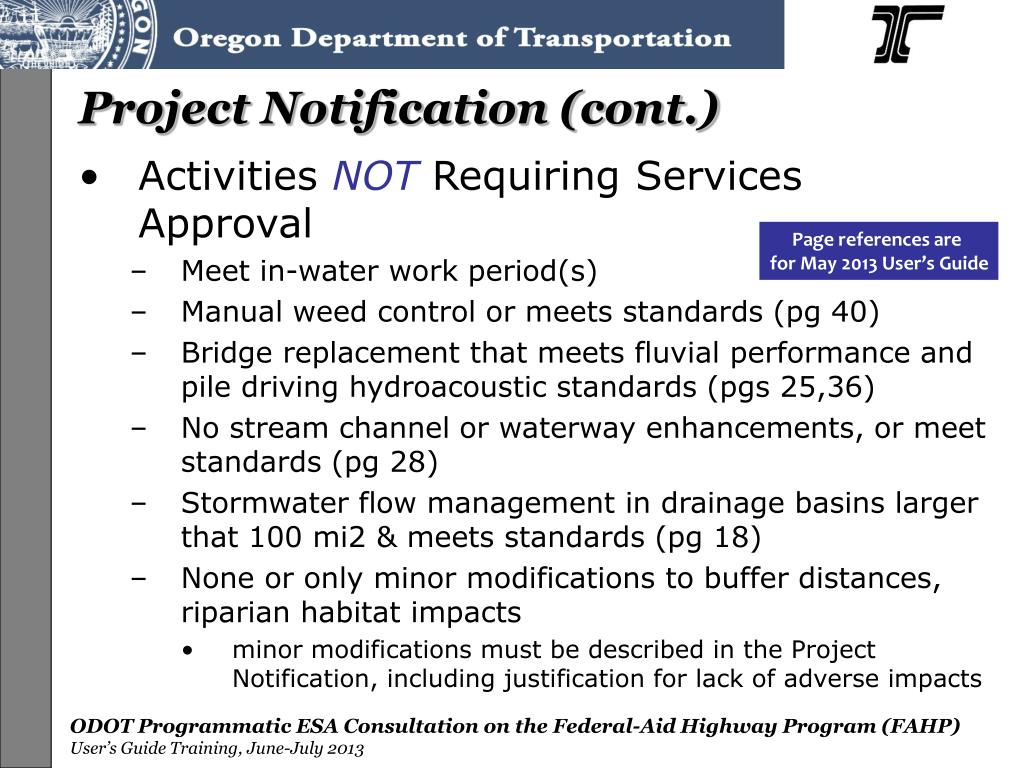

  3. Project Notification (cont.) • Activities NOT Requiring Services Approval • Meet in-water work period(s) • Manual weed control or meets standards (pg 40) • Bridge replacement that meets fluvial performance and pile driving hydroacoustic standards (pgs 25,36) • No stream channel or waterway enhancements, or meet standards (pg 28) • Stormwater flow management in drainage basins larger that 100 mi2 & meets standards (pg 18) • None or only minor modifications to buffer distances, riparian habitat impacts • minor modifications must be described in the Project Notification, including justification for lack of adverse impacts Page references are for May 2013 User’s Guide

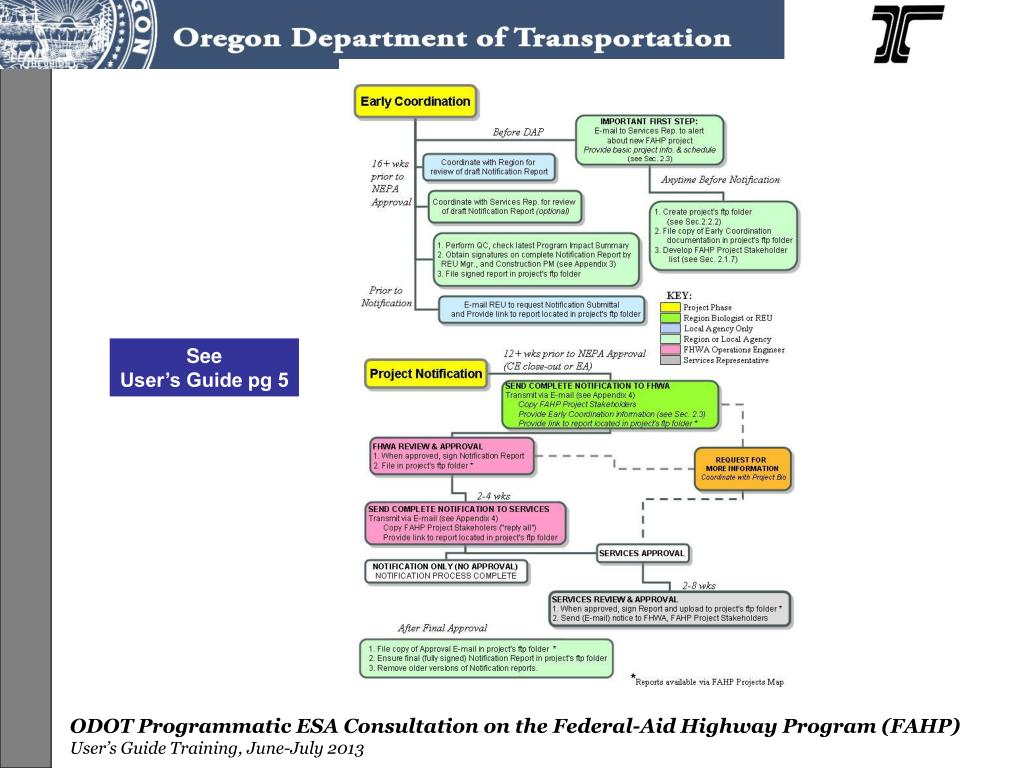

  4. See User’s Guide pg 5

  5. Project Notification (cont.) • Activities Requiring Services Approval • Actions with required mitigation (pg 17) • In-water work extension • Fisheries restoration • Weed control that does not meet standards (pg40) • Blasting in/near aquatic habitats • only allowed when listed species will not be present • Bridge replacement cannot meet fluvial performance or pile driving hydroacoustic standards (pgs 25,36) • Stream channel or waterway enhancements does not meet standards (pg 28) • Flow management in a drainage basin < 100 mi2 • Other modifications to FAHP design standards that may result in direct impacts to listed aquatic resources

  6. Project Notification (cont.) • Check FAHP Website for current template • Attachments? (see pg 11, Table 4) • Quality Control • Check completeness & math; check consistency among Project Activities, Description, Stormwater Management, Habitat Effects, Attachments • Check latest Summary of Take (FAHP website) • Create Project ftp folder • Electronic signatures (Biologist, Constr. Project Manager, REU Manager) • See Append. 4 for digital signature instructions Page & Append. references are for May 2013 User’s Guide

  7. Project Notification (cont.) • Upload completed Notification Report to Project’s ftp folder • REU transmits Notification to FHWA • E-mail notice to Region FHWA Op. Engineer • link Project’s ftp folder • cc FAHP Project stakeholders • See Append. 5 for E-mail content • Must include early coordination information • All Notifications require review/approval by FHWA

  8. Project Notification (cont.) FHWA Operations Engineer’s “duties”: • Review for FAHP scope, not an exclusion • Ensure sufficient early coordination • When approved, digitally sign • If No Services Approval: • save as “FINAL”, upload to ftp • e-mail transmittal “TO” REU, cc stakeholders & NMFS liaison • If Services Approval: • save as “TO_SERVICES”, upload to ftp • E-mail transmittal “TO” NMFS liaison for review and approval, cc stakeholders • See Append. 5 for E-mail content

  9. Project Notification (cont.) NMFS Liaison “duties”: • If No Services Approval, review only • If disagree, coordinate with NRU first to determine recourse • If Services Approval: • Coordinate technical review by NMFS specialists, as applicable • Coordinate digital signature and approval from Branch Manager • Save as new file (“FINAL”), upload to ftp • E-mail notice to FHWA, cc stakeholders

  10. Project Notification (final steps) REU’s final “duties”: • Ideally, within 2 weeks of final approval • Save copy of “approval” E-mail(s), upload to Project’s ftp folder • Delete older versions of Notification form so that ftp folder only has “FINAL” • Check FAHP projects map • coordinate with NRU if status not updated, other information not correct

  11. Illustration by Joseph Tomelleri
