1 / 29

Exploring Software Project Effort versus Duration Trade-offs

Exploring Software Project Effort versus Duration Trade-offs. Prepared by : Hala As’ad - 7014651 Mariam Bastami - 6196298 submitted to Professor Shervin Shirmohammadi in partial fulfillment of the requirements for the course ELG 5100. Agenda. Introduction

santa
Télécharger la présentation

Exploring Software Project Effort versus Duration Trade-offs

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Exploring Software Project Effort versus Duration Trade-offs Prepared by : HalaAs’ad - 7014651 Mariam Bastami - 6196298 submitted to Professor Shervin Shirmohammadi in partial fulfillment of the requirements for the course ELG 5100

  2. Agenda • Introduction • Effort-Duration Estimating Models • Symons’ process for effort -duration trade-off • Symons’ Reference Model • Symons’ Comparisons • Symons’ analysis procedure • Results • Conclusions and future work • References

  3. Introduction • At the beginning of the software project the estimator starts to predict some estimations for the expected : • Time • Effort • Cost …. etc . • These estimations are called central or optimal estimations.

  4. Introduction • In this project , we will study the effect of increasing or decreasing the size of the team on the duration of the project (schedule compression or expansion). • Other factors such as management pressure , requirements changes, or any environmental changes will be eliminated.

  5. Introduction • To measure the the effort versus duration trade-off , the estimators should be able to answer “what if “questions. • The answers of what if questions based on :

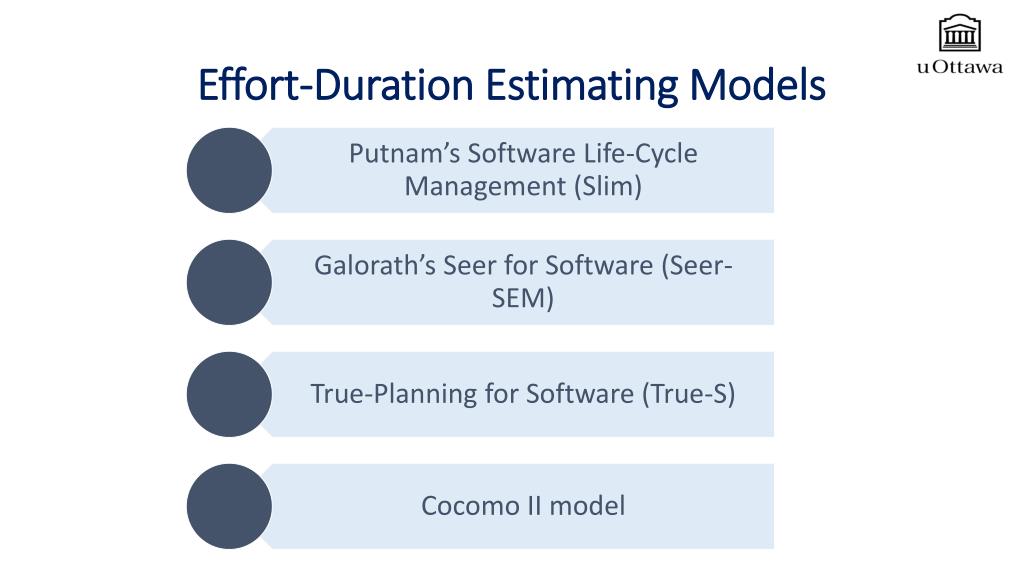

  6. Effort-Duration Estimating Models

  7. Putnam’s Software Life-Cycle Management (Slim) • Created by Lawrence Putnam in 1978 . • Used to estimate effort, time and cost that required to finish a software project according to its size. • This model works by collecting data , and used empirical analysis that based on the productivity level and the size of the project.

  8. Galorath’s Seer for Software (Seer-SEM) • Created by Galorath in the late 1980s • It is a tool that is programmed to allows the estimator to predict the project duration, effort and budget, and determine the probability of project completion on a certain date. • The Seer application has a variety of graphs, charts, and diagrams to illustrate the progress of the project http://www.galorath.com/DirectContent/SEERforSoftware2.pdf, (accessed on October 20𝑡ℎ ,2013)

  9. Symons’ process for effort-duration trade-off http://www.validest.com/img4.gif , (Accessed on November 25th ,2013)

  10. Symons’ Reference Model • Anther form of the equation : Rel. E: Relative effort. Rel. D: Relative duration.

  11. Symons’ Comparisons • Software Life Cycle Management (Slim) • N is 4 for both the compression and expansion sides. http://doi.ieeecomputersociety.org/ 10.1109/MS.2011.126 (Accessed on October 20th,2013)

  12. Symons’ Comparisons • Galorath’s Seer for Software (Seer.SEM) • N equal 2 In the compression side. • N equal -0.55 In the expansion side http://doi.ieeecomputersociety.org/ 10.1109/MS.2011.126 (Accessed on October 20th, 2013)

  13. Symons’ analysis procedure

  14. Step 1: Project acceptance and validation 1. Selecting the projects according to : • Completion dates. • Quality of the projects. • Consistency in the used measurement methods. • Ignoring the enhancement projects that has total enhancement size greater than 1,000 UFP 2.Checking average staffing level

  15. Step 2: Project grouping • why grouping ?

  16. Step 2: Project grouping • For small groups , Combining the groups that used primary programing languages from the same family . • Exclude groups with less than 12 projects. Result: 15 groups

  17. Step 3: Determining effort and the duration with respect to the size • Effort versus size and duration versus size were plotted for 15 groups. • Power curve fitting algorithm were used (norm curve). • Eliminating the outliers that give exponentially large size .

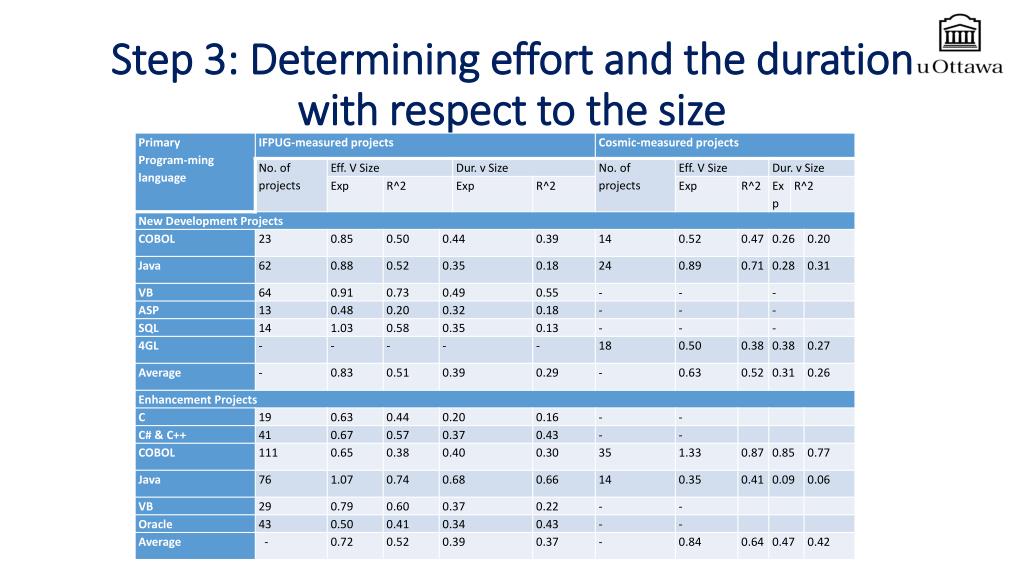

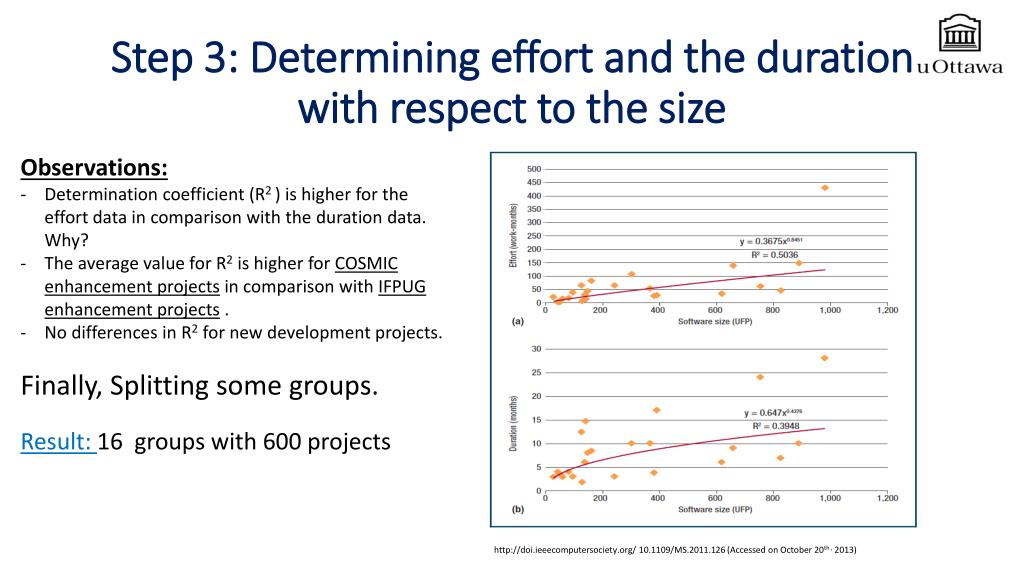

  18. Step 3: Determining effort and the duration with respect to the size • Observations: • Determination coefficient (R2) is higher for the effort data in comparison with the duration data. Why? • The average value for R2is higher for COSMIC enhancement projects in comparison with IFPUG enhancement projects. • No differences in R2 for new development projects. • Finally, Splitting some groups. • Result: 16 groups with 600 projects http://doi.ieeecomputersociety.org/ 10.1109/MS.2011.126 (Accessed on October 20th , 2013)

  19. Step 3: Determining effort and the duration with respect to the size

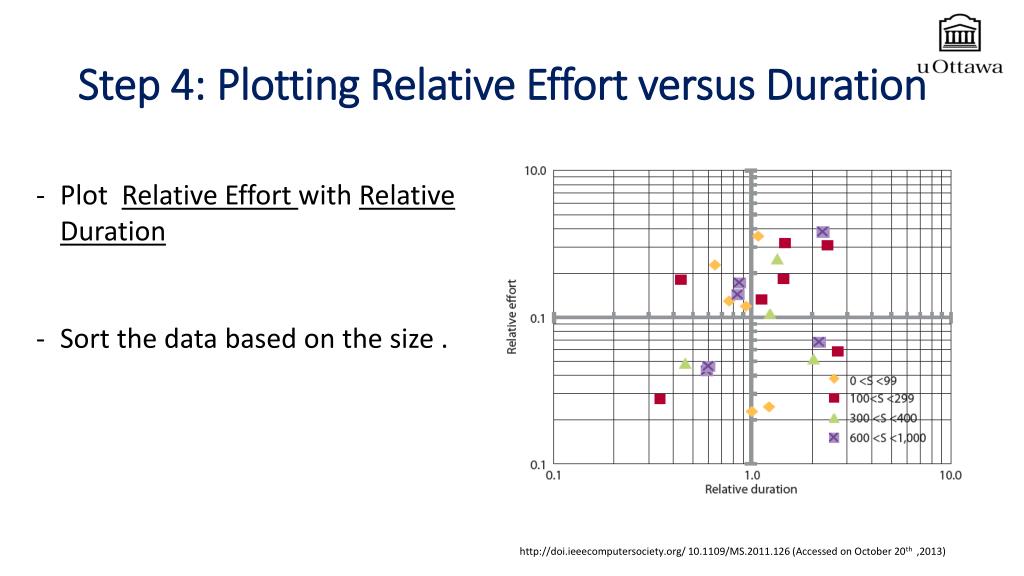

  20. Step 4: Plotting Relative Effort versus Duration • Determine the norm Effort and the norm Duration . • Calculate Relative Effort and Relative Duration by: Note : Assume NormEffort and Duration is the Central estimation in the reference equation.

  21. Step 4: Plotting Relative Effort versus Duration • Plot Relative Effort with Relative Duration • Sort the data based on the size . http://doi.ieeecomputersociety.org/ 10.1109/MS.2011.126 (Accessed on October 20th ,2013)

  22. Step 4: Plotting Relative Effort versus Duration - Calculate the Staffing Level (SL) - Divide the data according to SL into five bands.

  23. Step 4: Plotting Relative Effort versus Duration • http://doi.ieeecomputersociety.org/ 10.1109/MS.2011.126 (Accessed on October 20th ,2013)

  24. Step 5: Computing Exponent N SL is the driving factor • Plot Rel. E with SL and Rel. D with SL. • Use power curve fitting method to find the best fitted power curve for the data. • Calculate N(SL) using the reference equation. • http://doi.ieeecomputersociety.org/ 10.1109/MS.2011.126 (Accessed on October 20th ,2013)

  25. Step 5: Computing Exponent N

  26. Results

  27. Conclusions and Future works • Stuffing level (SL) is a crucial factor in the effort duration trade-off. • Symons’ process only accepts the projects of A and B qualities . Extend this process to test other projects with other qualities might be helpful to prove the robustness of this process. • Increase the number of the data in each group to be at least 30 projects instead of 12; this would validate the statistical analysis. • Many factors rather than the number of staff would cause compressing and expanding in the schedule . Therefore,considering these factors might extend the process to be more practical.

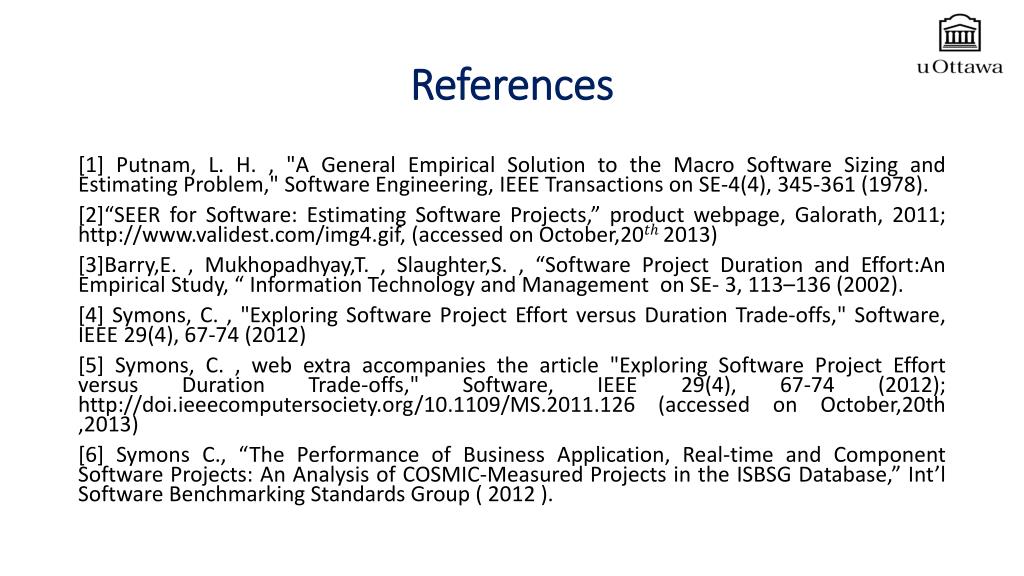

  28. References [1] Putnam, L. H. , "A General Empirical Solution to the Macro Software Sizing and Estimating Problem," Software Engineering, IEEE Transactions on SE-4(4), 345-361 (1978). [2]“SEER for Software: Estimating Software Projects,” product webpage, Galorath, 2011; http://www.validest.com/img4.gif, (accessed on October,202013) [3]Barry,E. , Mukhopadhyay,T. , Slaughter,S. , “Software Project Duration and Effort:An Empirical Study, “ Information Technology and Management on SE- 3, 113–136 (2002). [4] Symons, C. , "Exploring Software Project Effort versus Duration Trade-offs," Software, IEEE 29(4), 67-74 (2012) [5] Symons, C. , web extra accompanies the article "Exploring Software Project Effort versus Duration Trade-offs," Software, IEEE 29(4), 67-74 (2012); http://doi.ieeecomputersociety.org/10.1109/MS.2011.126 (accessed on October,20th ,2013) [6] Symons C., “The Performance of Business Application, Real-time and Component Software Projects: An Analysis of COSMIC-Measured Projects in the ISBSG Database,” Int’l Software Benchmarking Standards Group ( 2012 ).

  29. Thank you Questions
