1 / 22

Scheduling and Coordination of works in restricted areas with IMPACT tool

Scheduling and Coordination of works in restricted areas with IMPACT tool. EN-MEF EN-HE GS-AIS BE-OP PH-AIO. I ntervention M anagement P lanning & A ctivity C oordination T ool AMMW 2013 15 th November 2013. Katy Foraz Damien Lafarge Jurgen De Jonghe Peter Sollander

shalom
Télécharger la présentation

Scheduling and Coordination of works in restricted areas with IMPACT tool

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Scheduling and Coordination of works in restricted areas with IMPACT tool EN-MEF EN-HE GS-AIS BE-OP PH-AIO InterventionManagementPlanning & Activity Coordination Tool AMMW 2013 15th November 2013 Katy Foraz Damien Lafarge Jurgen De Jonghe Peter Sollander Fernando Pedrosa

  2. Contents Origins of the tool Current status Future developments Conclusion Asset and Maintenance Management Workshop

  3. Introduction • Scheduling and coordination vital in restricted areas at CERN • IMPACT (Intervention Management Planning and Activity Coordination Tool) has been developed in-house • IMPACT tool linked with access system • IMPACT tool linked with radioprotection database Asset and Maintenance Management Workshop

  4. Origins of the tool – needs • Legal background (France and Switzerland) • Need to authorize each intervention • Need to trace radiation doses • Most of restricted areas are space-limited • Need to optimize interventions - coordination Asset and Maintenance Management Workshop

  5. Origins of the tool – project • 2010 beginning of LHC operation - 13 different tools in operation (1 per facility) • Intervention Management Working Group (IMWG) launched in 2011 to specify needs for common tool for experiments and accelerators • One single database • A web tool • Integrated with other CERN tools • Coordination with Maintenance Management Project (integrations with CMMS) Asset and Maintenance Management Workshop

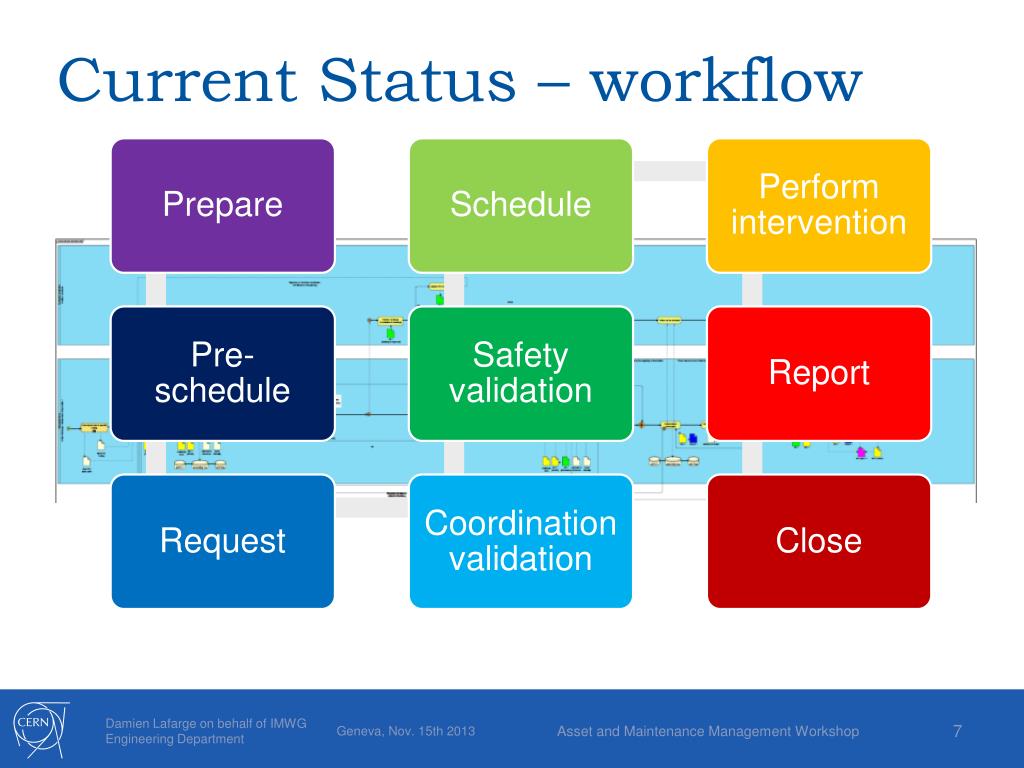

  6. Current Status – workflow Asset and Maintenance Management Workshop

  7. Current Status – workflow 1. Prepare (CMMS, excel..) 2. Pre-schedule 3. Request (IMPACT) 6. Schedule 8. Report to coordination 9. Close Service 4. Approval in TIOC meetings 7. Support for accesses TIOC Operation 5. Approval (fire permits, DIMR…) 4. Approval Schedule Safety Coordination Facility Coordination Asset and Maintenance Management Workshop

  8. Current Status – Step 1 : Prepare • Listsof intervention • Constraints Asset and Maintenance Management Workshop

  9. Current Status – Step 2 : Pre-schedule • Several tools used at CERN, specific to services Asset and Maintenance Management Workshop

  10. Current Status – Step 3 : Request • Service fills request Asset and Maintenance Management Workshop

  11. Current Status – Step 4 : Coordinate Service side Coordination side • Coordination checks co-activity (date & location) Asset and Maintenance Management Workshop

  12. Current Status – Step 5 : Safety • IMPACT allows to pre-fill many safety declarations (fire permits, DIMR, VIC…) handled in other tools Asset and Maintenance Management Workshop

  13. Current Status – Step 6 : Schedule • Validation of feasibility • Fine tuning of the schedule Asset and Maintenance Management Workshop

  14. Current Status – Step 7 : Perform • Access granted only to people declared in an Activity and only between access dates • Attachment of doses to Activity • Weekly report to coordination • Only coordination teams can modify access dates Asset and Maintenance Management Workshop

  15. Current Status – Step 7 : Report • After access end date → status “late” • Status “finish” indicates end of work • Link with CMMS to get comments from technicians Asset and Maintenance Management Workshop

  16. Current Status – Request in 2013 • More than 11’000 activities in 2013 Asset and Maintenance Management Workshop

  17. Current Status – Figures • 20’000 activities since 2012 • 4’200 safety documents attached to activities • 35’000 personal dose records since march 2013 Asset and Maintenance Management Workshop

  18. Future developments • DIMR – access rights • Improved integration with CMMS • Enlargement of IMPACT to non restricted areas • Shutdown notification (« Note de Coupure ») • Lock-outs • Dig permit • AOC - Notification of work start Asset and Maintenance Management Workshop

  19. Future developments - Planbook • Integrated scheduling tool using MS Project • Synchronizes dates from several systems (CMMS, IMPACT, local project file) Asset and Maintenance Management Workshop

  20. Conclusions • Success of the tool – only intervention management system at CERN • Enlargement of the scope => CERN-wide approach • Development still on-going • Training of IMPACT users • Training of CMMS users Asset and Maintenance Management Workshop
