An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. PUBLIC WORKS DEPARTMENT FY 2010-11 Budget Worksession July 21, 2010

  2. Presentation Outline • Organization Chart • Proposed FY 2010-11 Budget • Accomplishments • Budget Challenges • Summary

  3. Presentation Outline • Organization Chart • Proposed FY 2010-11 Budget • Accomplishments • Budget Challenges • Summary

  4. Organization Chart Director – Mark V. Massaro, P.E. Deputy Director – Joseph C. Kunkel, P.E. Public Works Engineering Robin L. Hammel, P.E. Fiscal & Administration Ralphetta Aker, J.D. Highway Construction Julie Naditz, P.E. Development Engineering Diana Almodovar, P.E. Roads & Drainage Deodat Budhu, P.E. Stormwater Management Rodney Lynn, P.E., Interim Manager Traffic Engineering Ruby Dempsey Rozier Transportation Planning Renzo Nastasi, AICP

  5. Presentation Outline • Organization Chart • Proposed FY 2010-11 Budget • Accomplishments • Budget Challenges • Summary

  6. Proposed FY 2010-11 Budget

  7. Stormwater Management $0.8M 1.0% Highway Construction Development Engineering Fiscal & Administration $2.2M $3.0M 2.8% $5.2M 3.7% 6.4% Transportation Planning MSTU $1.5M $3.9M 1.8% 4.9% Traffic Engineering $7.4M 9.1% PW Engineering Roads & Drainage $7.8M $48.8M 9.7% 60.6% Proposed FY 2010-11 Budget Public Works Department Operating Budget FY 10-11 Proposed FY 10-11 Operating Budget: $80.6M

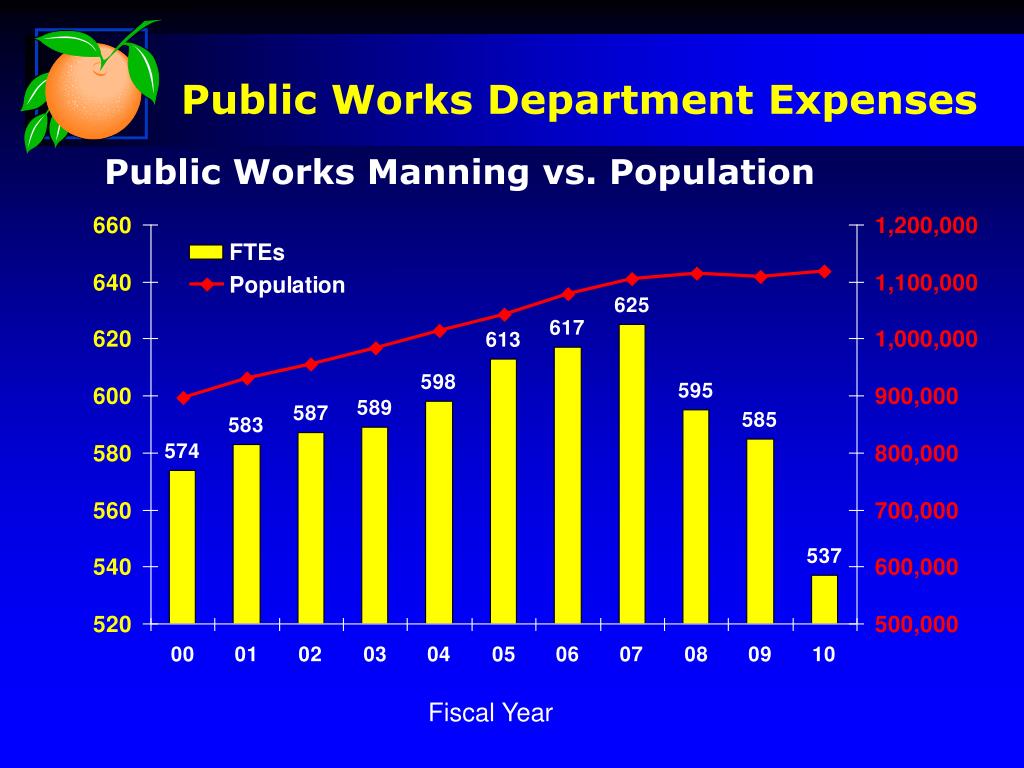

  8. Public Works Department Expenses Public Works Manning vs. Population Fiscal Year

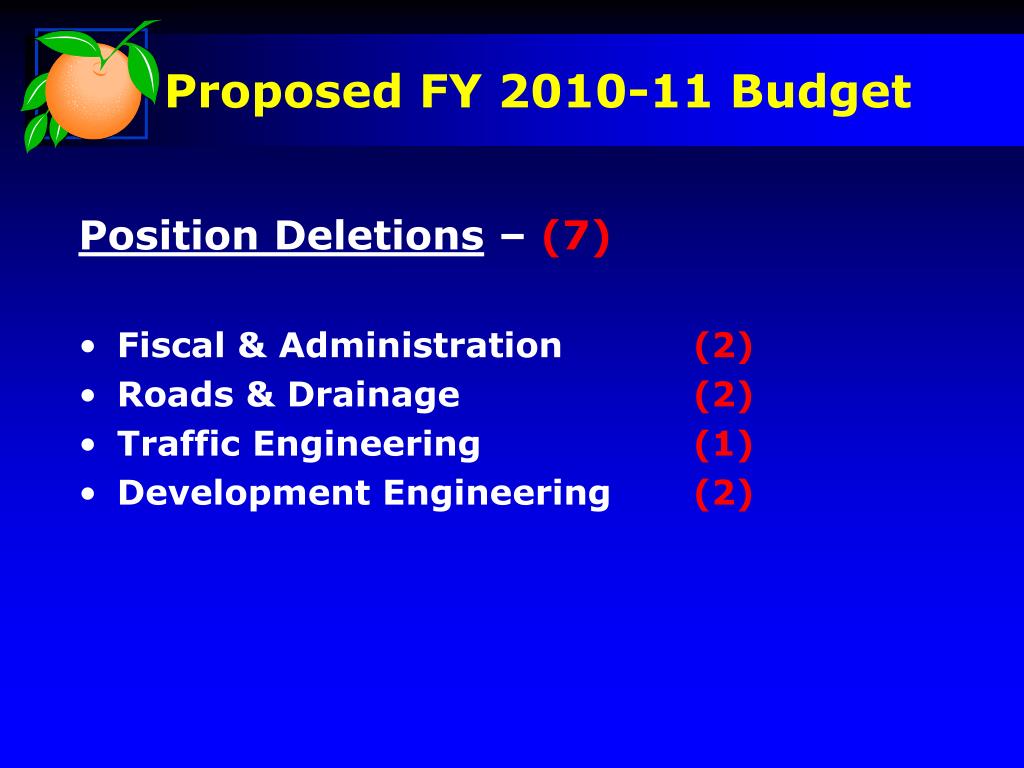

  9. Proposed FY 2010-11 Budget Position Deletions – (7) • Fiscal & Administration (2) • Roads & Drainage (2) • Traffic Engineering (1) • Development Engineering (2)

  10. Proposed FY 2010-11 Budget

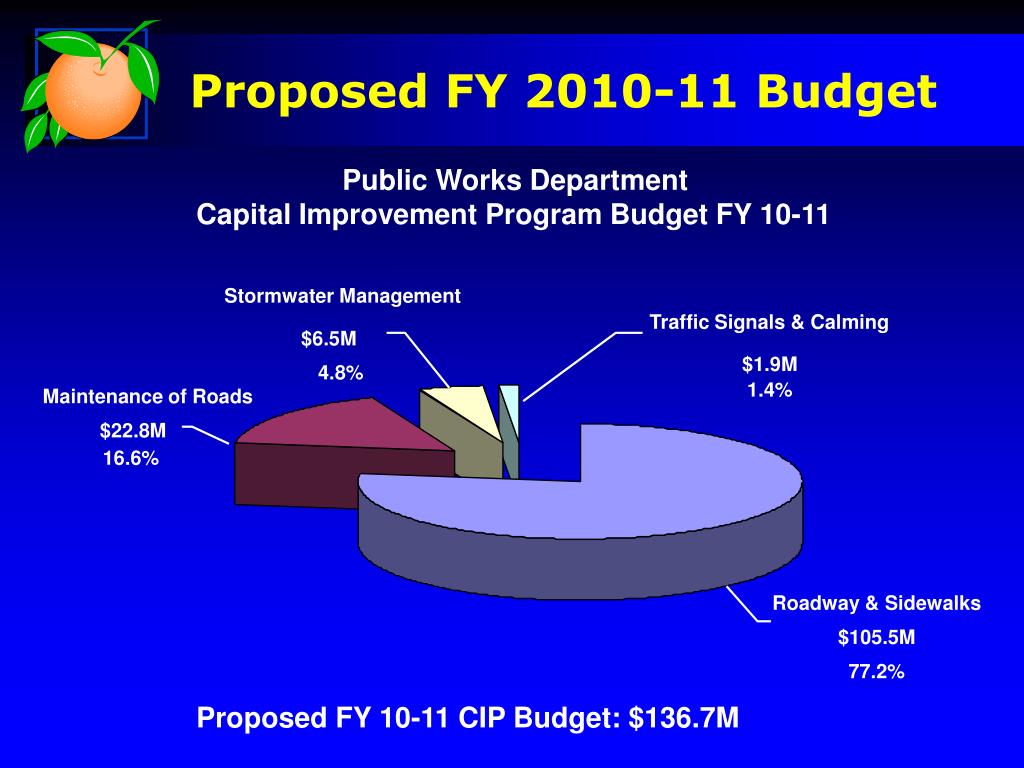

  11. Stormwater Management Traffic Signals & Calming $6.5M $1.9M 4.8% 1.4% Maintenance of Roads $22.8M 16.6% Roadway & Sidewalks $105.5M 77.2% Proposed FY 2010-11 Budget Public Works Department Capital Improvement Program Budget FY 10-11 Proposed FY 10-11 CIP Budget: $136.7M

  12. Presentation Outline • Organization Chart • Proposed FY 2010-11 Budget • Accomplishments • Budget Challenges • Summary

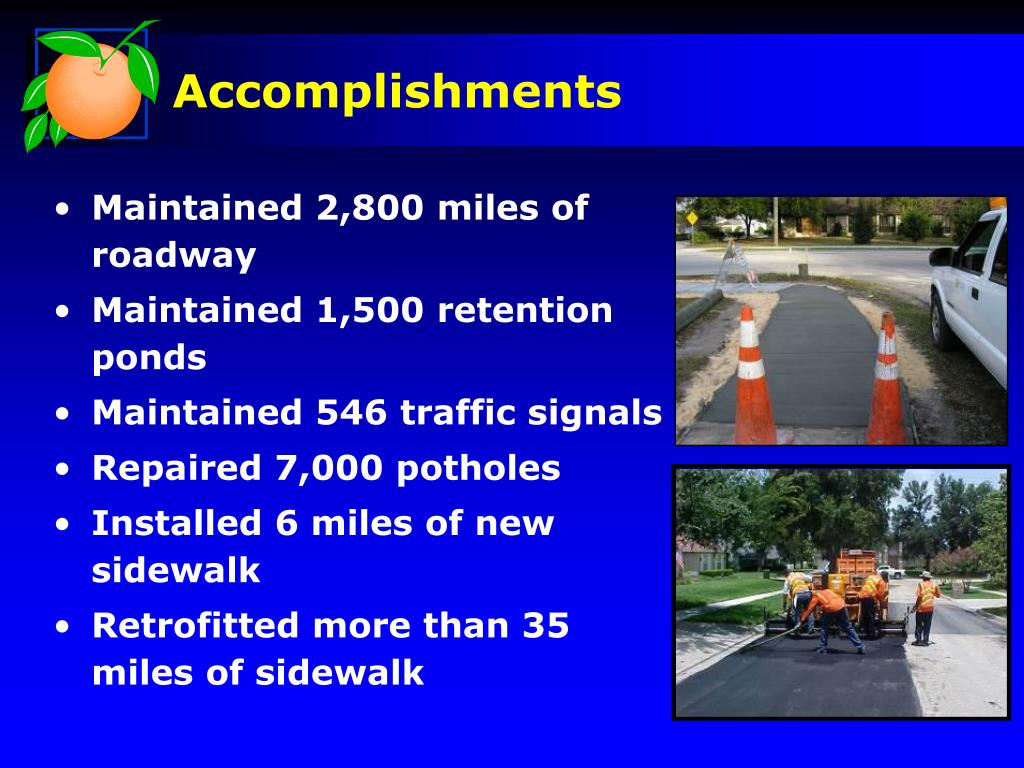

  13. Accomplishments • Maintained 2,800 miles of roadway • Maintained 1,500 retention ponds • Maintained 546 traffic signals • Repaired 7,000 potholes • Installed 6 miles of new sidewalk • Retrofitted more than 35 miles of sidewalk

  14. Installed 130,000 linear feet underdrain Retimed 202 signals Installed 6 new school flashers Replaced/repaired 16,000 traffic signs Resurfaced 190 lane miles of arterial, collector, and subdivisions roads Accomplishments

  15. Relined 9 miles of stormwater pipes NRCS grant totaling $618K for erosion control along Little Wekiwa River Red Light Running Ordinance Red Light Running Contract Awarded Accomplishments

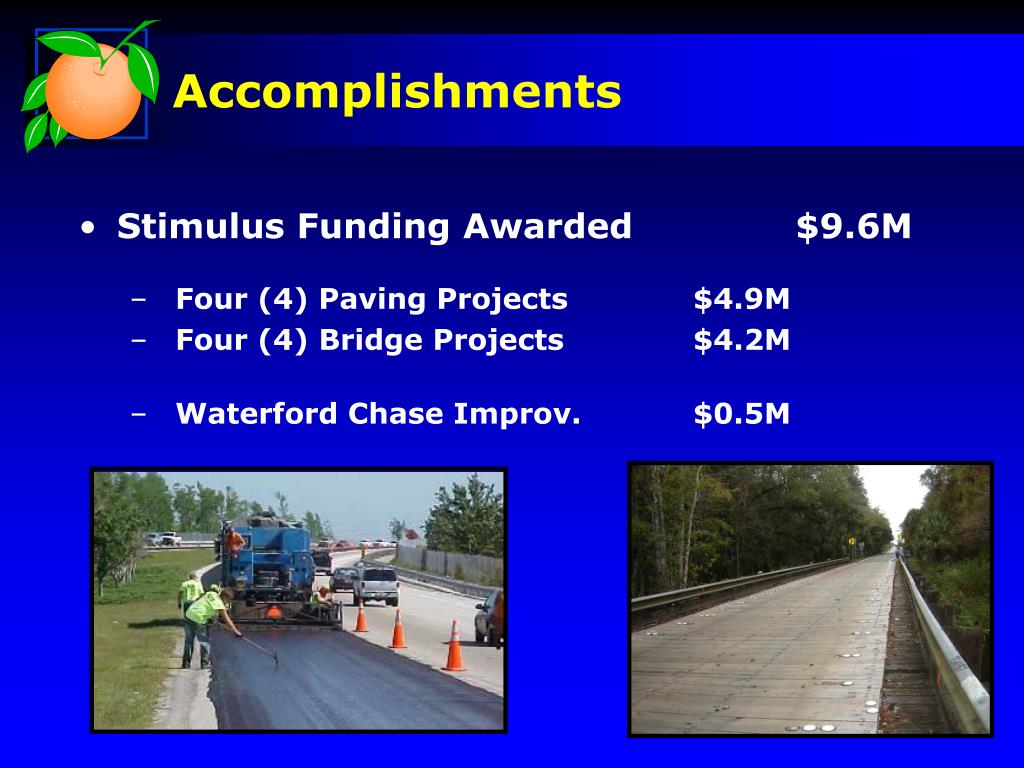

  16. Accomplishments • Stimulus Funding Awarded $9.6M • Four (4) Paving Projects $4.9M • Four (4) Bridge Projects $4.2M • Waterford Chase Improv. $0.5M

  17. Accomplishments Roadway Construction Projects:Roads Completed • Destination Parkway, Sections IA, IIB, IIC • Rouse Road North • Rock Springs Road • Wetherbee Road I, II, and III • Taft Vineland Road – Extension Roads Underway • CR 535 Segments C & E • Narcoossee Road • Clarcona Ocoee Road East • Woodbury Road Extension

  18. Presentation Outline • Organization Chart • Proposed FY 2010-11 Budget • Accomplishments • Budget Challenges • Summary

  19. Budget Challenges • Level of Service • Programs • Roadway CIP • Operational Impacts

  20. Budget Challenges • Level of Service Challenges • Level of Service FY 11 Consistent with FY 10

  21. Level of Service - Roads & Drainage Resurfacing program Right-of-way mowing Retention pond mowing Street sweeping Budget Challenges

  22. Level of Service - Roads & Drainage Resurfacing program - 15-year existing cycle Budget Challenges

  23. Level of Service - Roads & Drainage Right-of-way mowing - 4-5 week existing cycle Budget Challenges

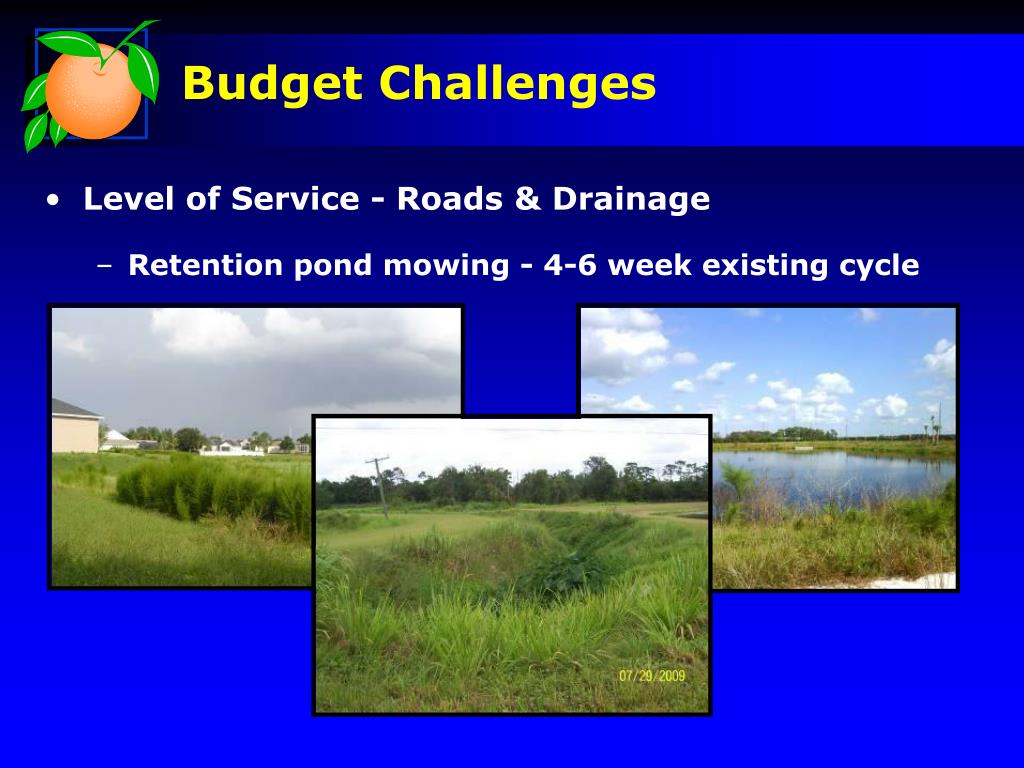

  24. Level of Service - Roads & Drainage Retention pond mowing - 4-6 week existing cycle Budget Challenges

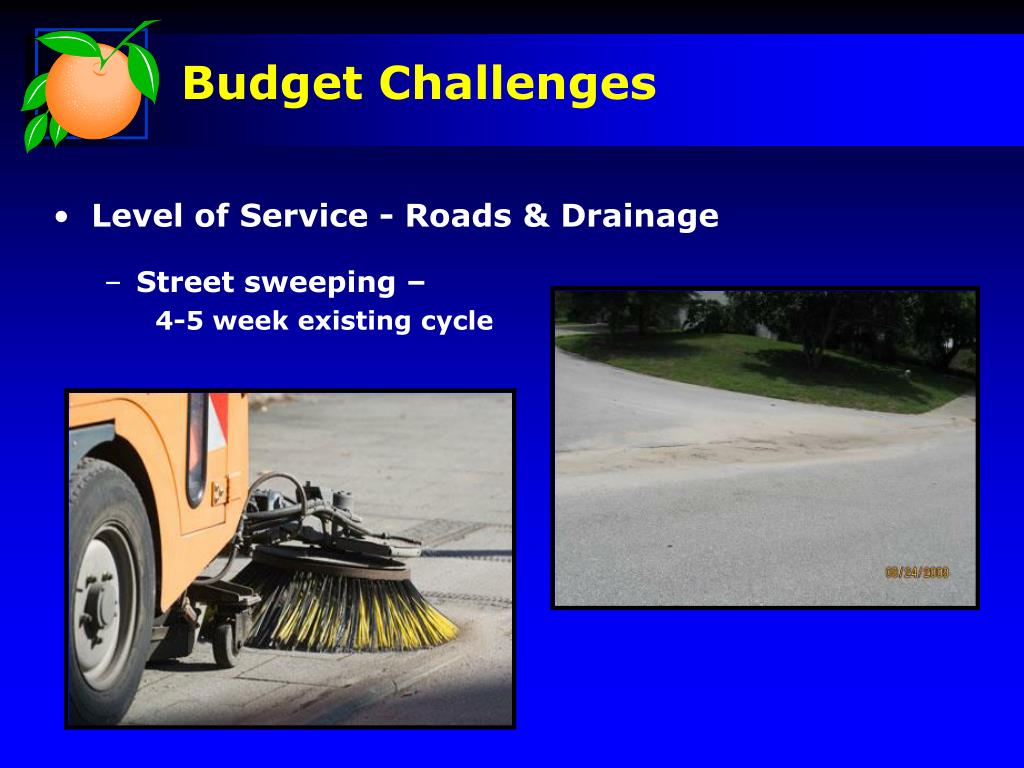

  25. Level of Service - Roads & Drainage Street sweeping – 4-5 week existing cycle Budget Challenges

  26. Level of Service - Roads & Drainage Tree trimming - scheduled if critical Drainage rehabilitation - as needed Budget Challenges

  27. Level of Service – Traffic Engineering School zones and flashers –installed as needed Traffic signals - warranted signals scheduled for installation Pedestrian safety upgrades – modified based on field conditions Traffic calming devices - MSBU's with matching funds Budget Challenges

  28. Budget Challenges • Programs • Pedestrian safety infrastructure • Capital Improvement Projects • Operational Impacts

  29. Budget Challenges • Programs • Pedestrian Safety Improvements • Ability to provide adequate sidewalk for school age pedestrians and address current backlog

  30. Stormwater Management Traffic Signals & Calming $6.5M $1.9M 4.8% 1.4% Maintenance of Roads $22.8M 16.6% Roadway & Sidewalks $105.5M 77.2% Proposed FY 2010-11 Budget Public Works Department Capital Improvement Program Budget FY 10-11 Proposed FY 10-11 CIP Budget: $136.7M

  31. Budget Challenges Roadway CIP Budget • CIP Budgeting Priorities • Construction Contracts • Partnership Agreements • Design Contracts • Right-of-Way acquisition by Eminent Domain • Roadway projects & programs • Total $105.5M FY 10-11

  32. Budget Challenges Roadway CIP Budget • Construction Contracts • Woodbury Road – Completion • CR 535 Segment C & E – Completion • Clarcona Ocoee Road East – Ongoing • Narcoosee Road – Ongoing • Sand Lake Road – Ongoing • Alafaya Trail – Beginning • Destination Pkwy 3A – Beginning

  33. Budget Challenges Roadway CIP Budget • Partnership Agreements • Wildwood Avenue Bridge and Road Network

  34. Budget Challenges Roadway CIP Budget • Design Contracts • Int’l Drive Transit Lanes • Int’l Drive Pedestrian Bridges • John Young Parkway and Sandlake Road Interchange

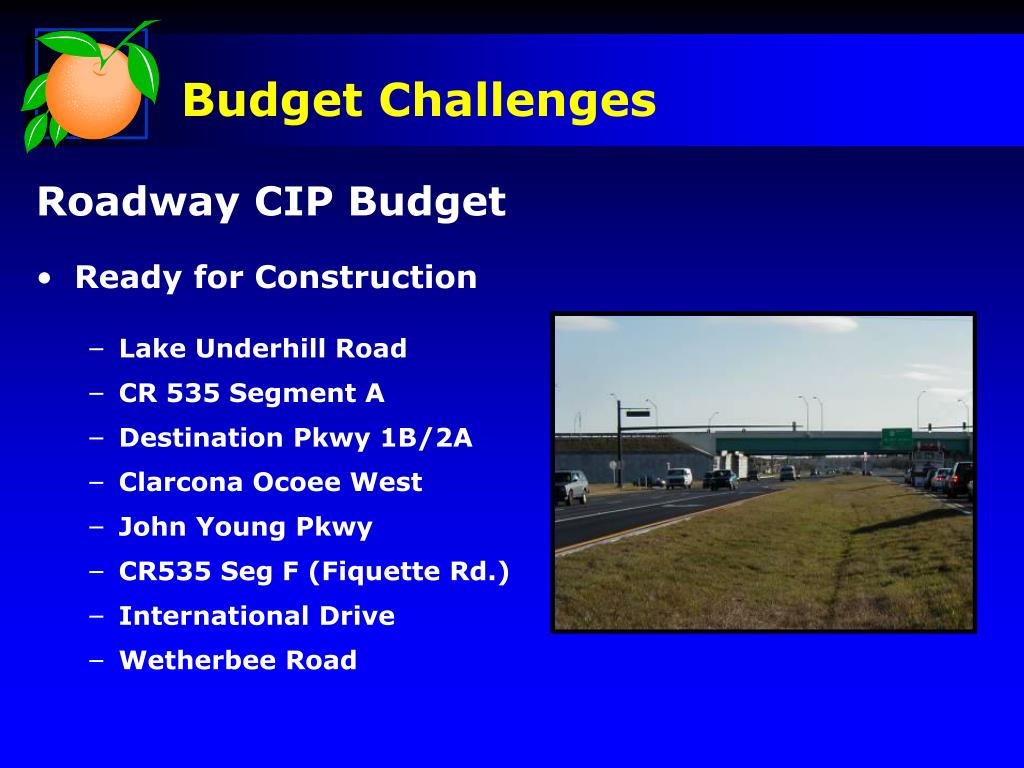

  35. Budget Challenges Roadway CIP Budget • Ready for Construction • Lake Underhill Road • CR 535 Segment A • Destination Pkwy 1B/2A • Clarcona Ocoee West • John Young Pkwy • CR535 Seg F (Fiquette Rd.) • International Drive • Wetherbee Road

  36. Budget Challenges Roadway CIP Budget • Right-of-Way acquisition • Holden Avenue • Boggy Creek Road • Econlockhatchee Trail • Taft Vineland Road

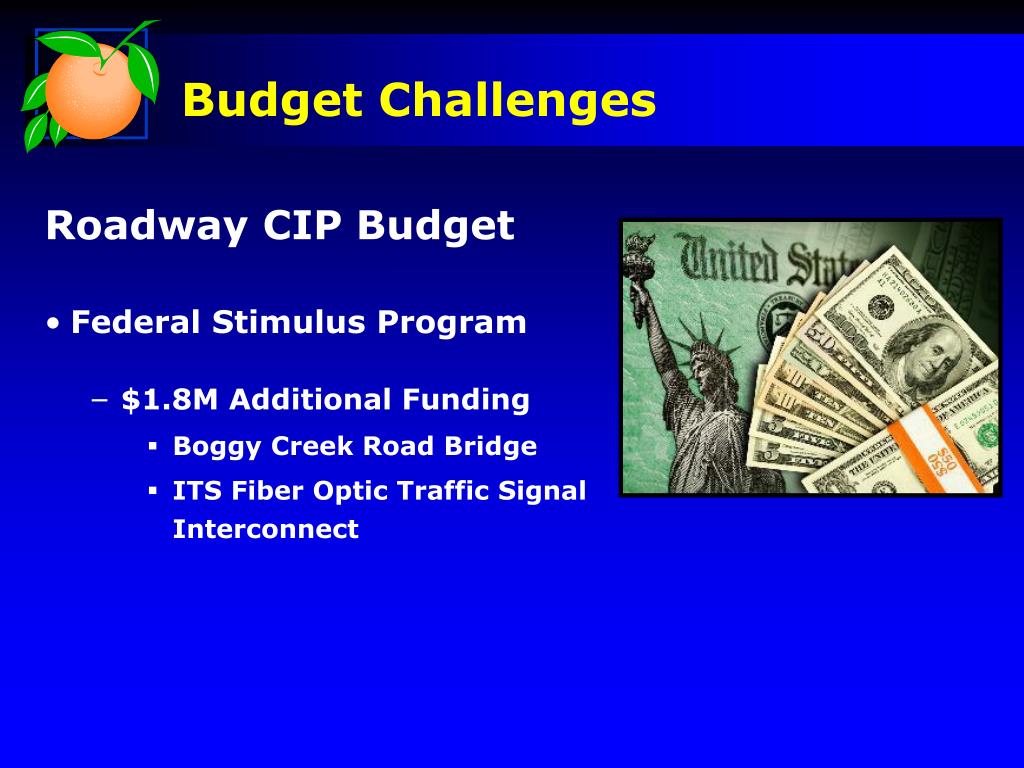

  37. Budget Challenges Roadway CIP Budget • Federal Stimulus Program • $1.8M Additional Funding • Boggy Creek Road Bridge • ITS Fiber Optic Traffic Signal Interconnect

  38. Budget Challenges Roadway CIP Budget • Intersections • $3M funding • Sidewalks • $2M annually

  39. Budget Challenges Roadway CIP Budget • Rouse Road South • Previously delayed • Limits: Lake Underhill Road to south of SR 50 • Widen to a four-lane roadway • Current construction start: FY 14-15 • Revised construction start: FY 15-16 • Additional 1 year delay

  40. Budget Challenges Roadway CIP Budget • All American Boulevard • Previously delayed • Limits: Clarcona-Ocoee Road to Kennedy Boulevard • Re-alignment of a four-lane roadway • Current construction start: FY 15-16 • Revised construction start: FY 17-18 • Additional 2 year delay

  41. Budget Challenges Roadway CIP Budget • Valencia College Lane • Previously delayed • Limits: Goldenrod Road to Econlockhatchee Trail • Widen to a four-lane roadway • Current construction start: FY 16-17 • Revised construction start: FY 18-19 • Additional 2 year delay

  42. Budget Challenges Roadway CIP Budget • Dean Road • Previously delayed • Limits: University Boulevard to Seminole County line • Widen to a four-lane roadway • Current construction start: FY 16-17 • Revised construction start: FY 17-18 • Additional 1 year delay

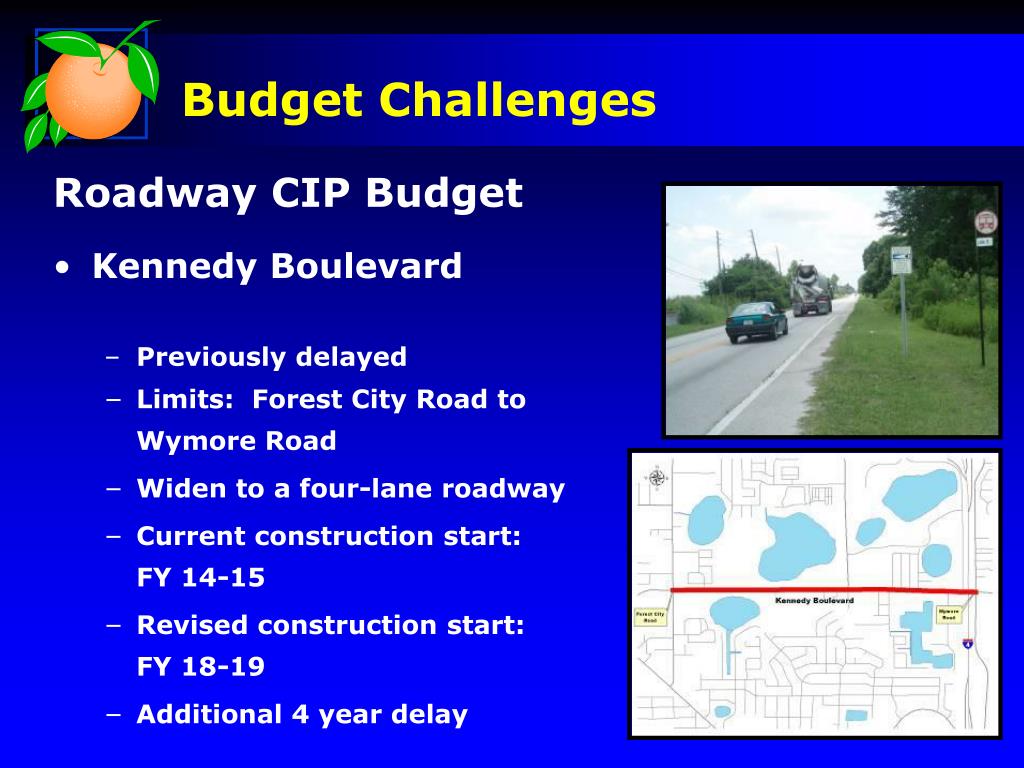

  43. Budget Challenges Roadway CIP Budget • Kennedy Boulevard • Previously delayed • Limits: Forest City Road to Wymore Road • Widen to a four-lane roadway • Current construction start: FY 14-15 • Revised construction start: FY 18-19 • Additional 4 year delay

  44. Budget Challenges Roadway CIP Budget • Econlockhatchee Trail • Previously delayed • Limits: Curry Ford Road to Lake Underhill Road • Widen to a four-lane roadway • Current construction start: FY 18-19 • Revised construction start: FY FY 19-20 • Additional 1 year delay

  45. Budget Challenges Roadway CIP Budget • Econlockhatchee Trail • Previously delayed • Limits: SR 50 to University Boulevard • Widen to a four-lane roadway • Current construction start: FY 18-19 • Revised construction start: FY 19-20 • Additional 1 year delay

  46. Stormwater Management Traffic Signals & Calming $6.5M $1.9M 4.8% 1.4% Maintenance of Roads $22.8M 16.6% Roadway & Sidewalks $105.5M 77.2% Proposed FY 2010-11 Budget Public Works Department Capital Improvement Program Budget FY 10-11 Proposed FY 10-11 CIP Budget: $136.7M

  47. Budget Challenges • Capital Improvement Delays • Landscaping 5 Years • Roadway Lighting 5 Years

  48. Budget Challenges • Operational Challenges • Impact on Level of Service • Infrastructure Maintenance • Prolonged delays increase cost • Require more maintenance

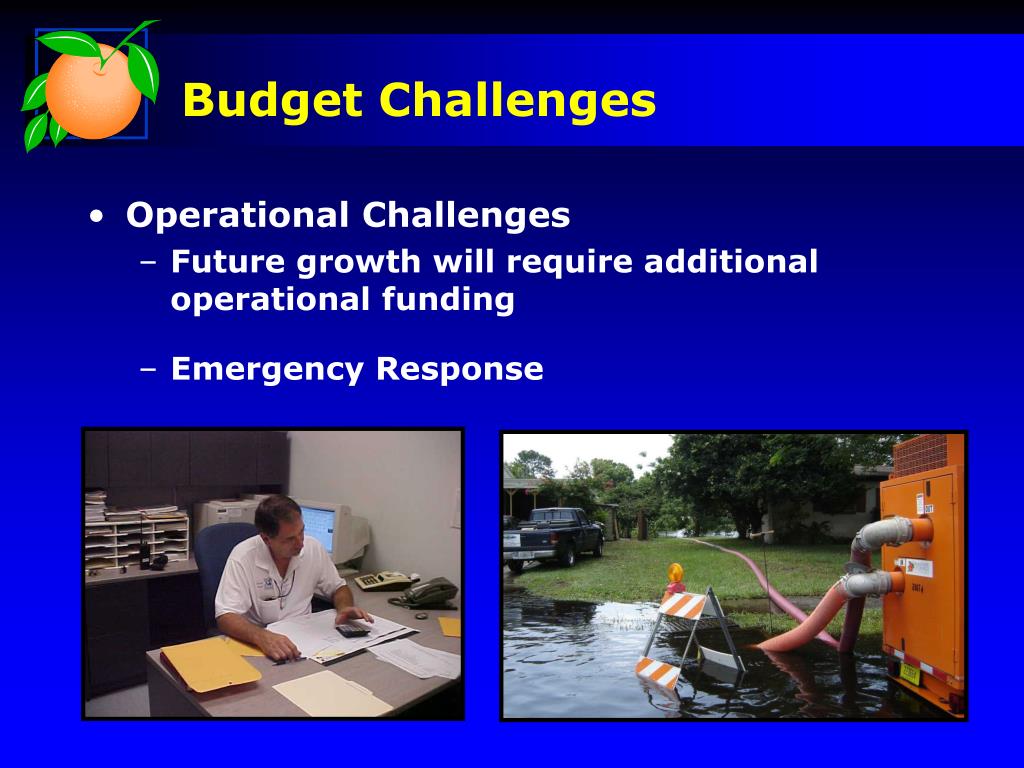

  49. Budget Challenges • Operational Challenges • Future growth will require additional operational funding • Emergency Response

  50. Budget Challenges • Operational Impacts • Staffing requirements • Reached critical mass • FY 2007-2008 (30) Positions eliminated • FY 2008-2009 (10) Positions eliminated • FY 2009-2010 (48) Positions eliminated • FY 2010-2011 (7) Positions eliminated • Heavy Equipment and rolling stock • 3-year delay in replacement • 20 years old • Scheduled replacement $2M to $2.3M • Current $1.3M
