An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. CFAC Review – Title I Design Plan Ove Dyling Assistant Director for Design Conventional Facilities NSLS-II Conventional Facilities Title I Design Plan May 8, 2007

  2. Title I Design Plan • Advanced Conceptual Design Underway • Tasks that are investigative in nature and used to confirm validity of conceptual design • Title I Schedule Milestones • June 2007 Award A/E Contract – Authorize Title I Start • July 2007 Award Agent CM Contract • July 27, 2007 Title I Design 50% Review Submittal • September 14, 2007 Title I Design 90% Review Submittal • October 12, 2007 100% Title I Report

  3. NSLS II Facility • Accelerator Group • BLOC – Booster/LINAC/ Operations Center • RF Area • Accelerator Tunnel Area • Experimental Group • LOB – Lab Office Buildings (3 base scope up to 5 future) • Experimental Floor • General • Service Building 4 5 6 3 4 1 6 2 4 6 6 5 6 4 3 4

  4. Title I Design Plan Cont. • Advanced Conceptual Design - Pre-Title I Activities • May 2nd - Accelerator Lattice Design is fixed • Basic footprint/parameters established • May 16th– Ratchet Wall Design Workshop • Input of key stakeholders – ESH; EFD; ASD • May 24 – 25, 2007 Outstanding Issues meeting HDR/BNL • ArchitecturalLayout & Building Program • Finalize Site Plan Location • LOB Program Spaces • Services Building Locations • Vibration Mitigation Methods • Thermal Stability of Storage Ring • MEP Systems • Booster Ring Layout

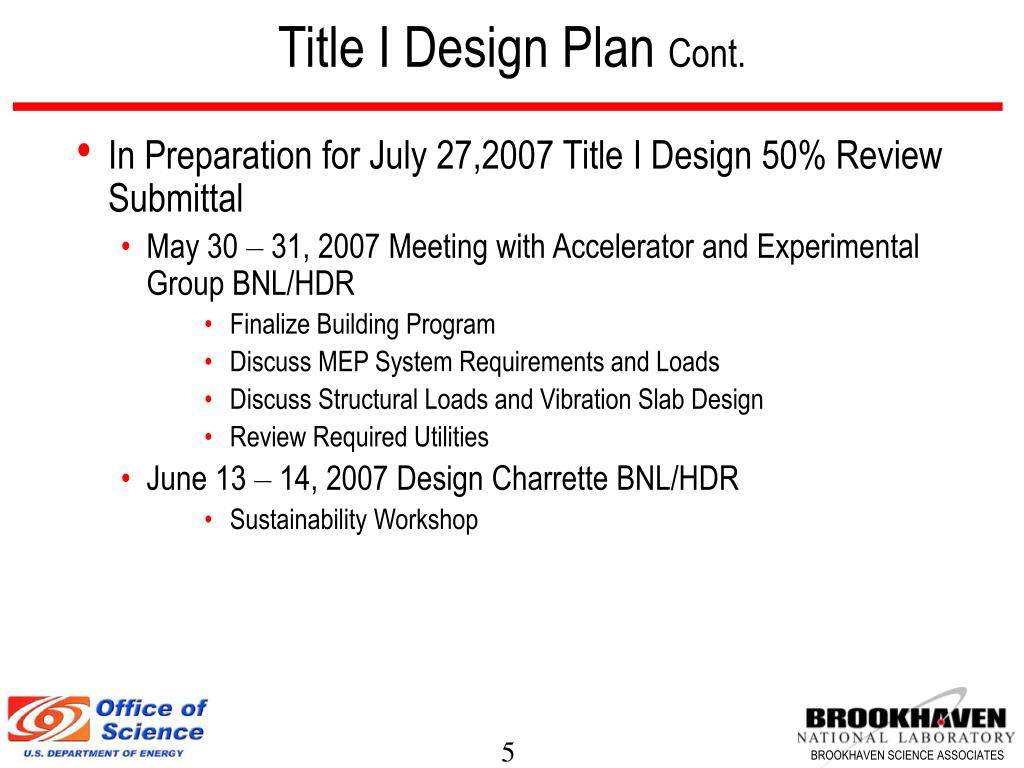

  5. Title I Design Plan Cont. • In Preparation for July 27,2007 Title I Design 50% Review Submittal • May 30 – 31, 2007 Meeting with Accelerator and Experimental Group BNL/HDR • Finalize Building Program • Discuss MEP System Requirements and Loads • Discuss Structural Loads and Vibration Slab Design • Review Required Utilities • June 13 – 14, 2007 Design Charrette BNL/HDR • Sustainability Workshop

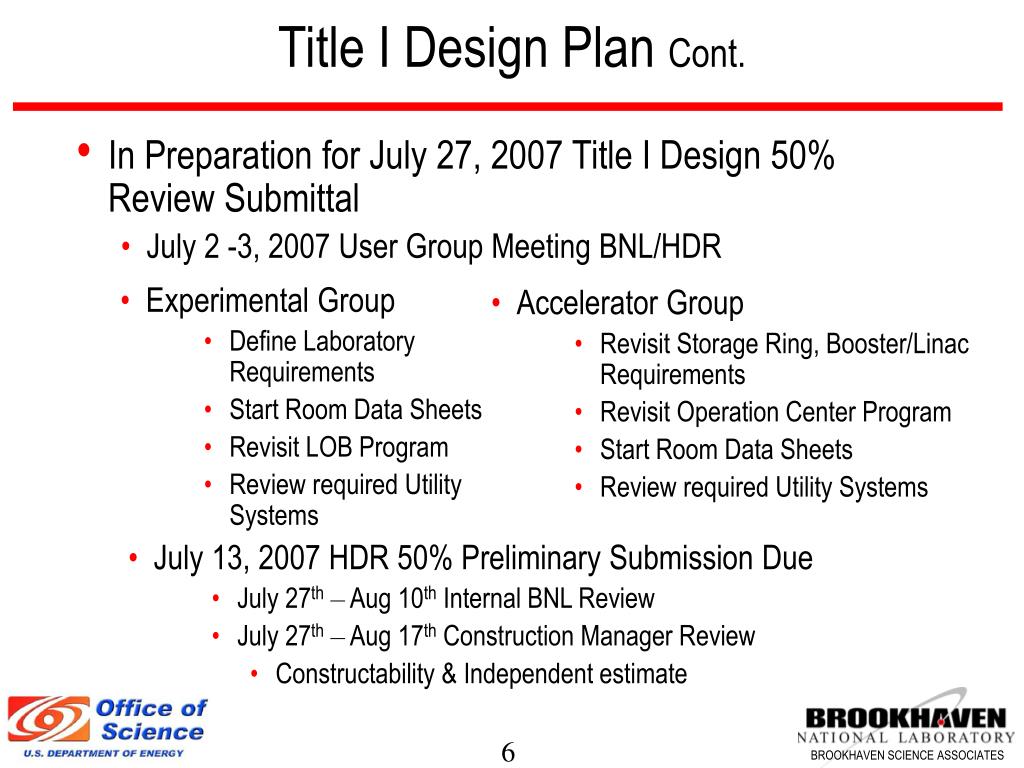

  6. Title I Design Plan Cont. • In Preparation for July 27, 2007 Title I Design 50% Review Submittal • July 2 -3, 2007 User Group Meeting BNL/HDR • Experimental Group • Define Laboratory Requirements • Start Room Data Sheets • Revisit LOB Program • Review required Utility Systems • Accelerator Group • Revisit Storage Ring, Booster/Linac Requirements • Revisit Operation Center Program • Start Room Data Sheets • Review required Utility Systems • July 13, 2007 HDR 50% Preliminary Submission Due • July 27th– Aug 10th Internal BNL Review • July 27th– Aug 17th Construction Manager Review • Constructability & Independent estimate

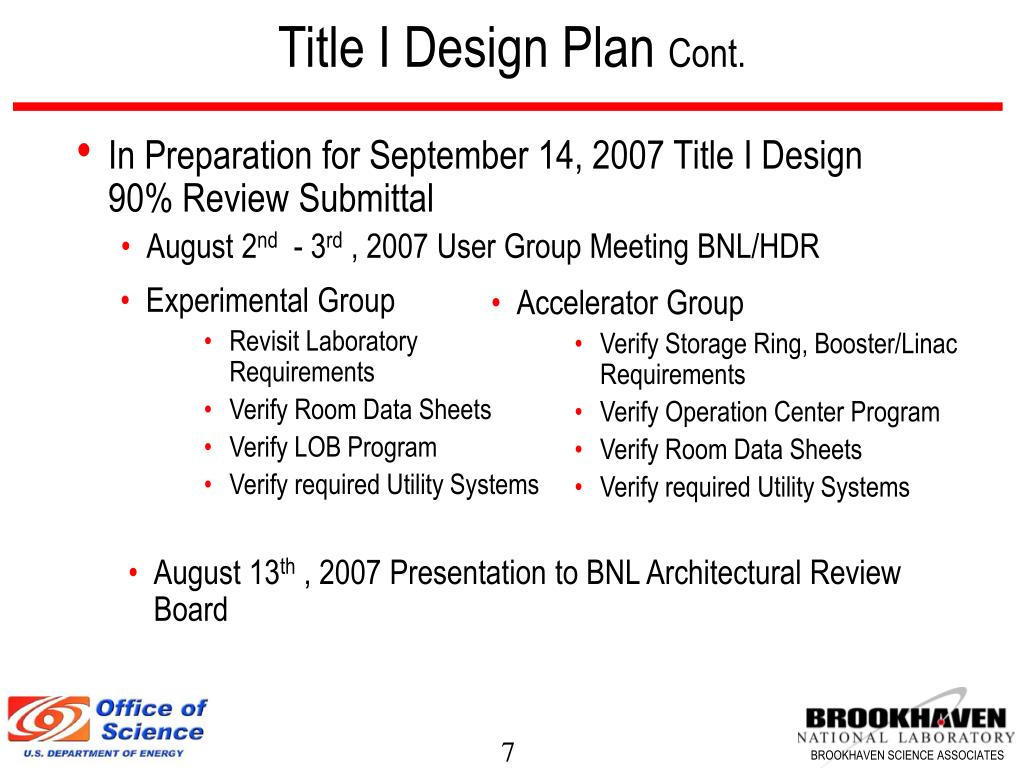

  7. Title I Design Plan Cont. • In Preparation for September 14, 2007 Title I Design 90% Review Submittal • August 2nd - 3rd , 2007 User Group Meeting BNL/HDR • Experimental Group • Revisit Laboratory Requirements • Verify Room Data Sheets • Verify LOB Program • Verify required Utility Systems • Accelerator Group • Verify Storage Ring, Booster/Linac Requirements • Verify Operation Center Program • Verify Room Data Sheets • Verify required Utility Systems • August 13th , 2007 Presentation to BNL Architectural Review Board

  8. Title I Design Plan Cont. • In Preparation for September 14, 2007 Title I Design 90% Review Submittal • August 29 – 31, 2007 Title I Cost/Value Management/Constructability/Safety Review BNL/HDR • September 3, 2007 90% Preliminary Title I Submittal Due HDR • September 4th– 7th , 2007 BNL design team internal review • September 4th– 7th , 2007 Construction Manager Review • September 14, 2007 Title I Final 90% Submittal Due HDR • September 17th– 21st , 2007 BNL-wide Review • September 17th– 21st, 2007 Construction Manager Review

  9. Title I Design Plan Cont. • In Preparation for October 12, 2007 100% Title I 100% Report • October 1, 2007 Progress Review BNL/HDR • October 4th– 8th, 2007 Internal BNL Review • October 4th– 8th, 2007 Construction Manager Review • October 12, 2007 100% Title I Submittal Due HDR

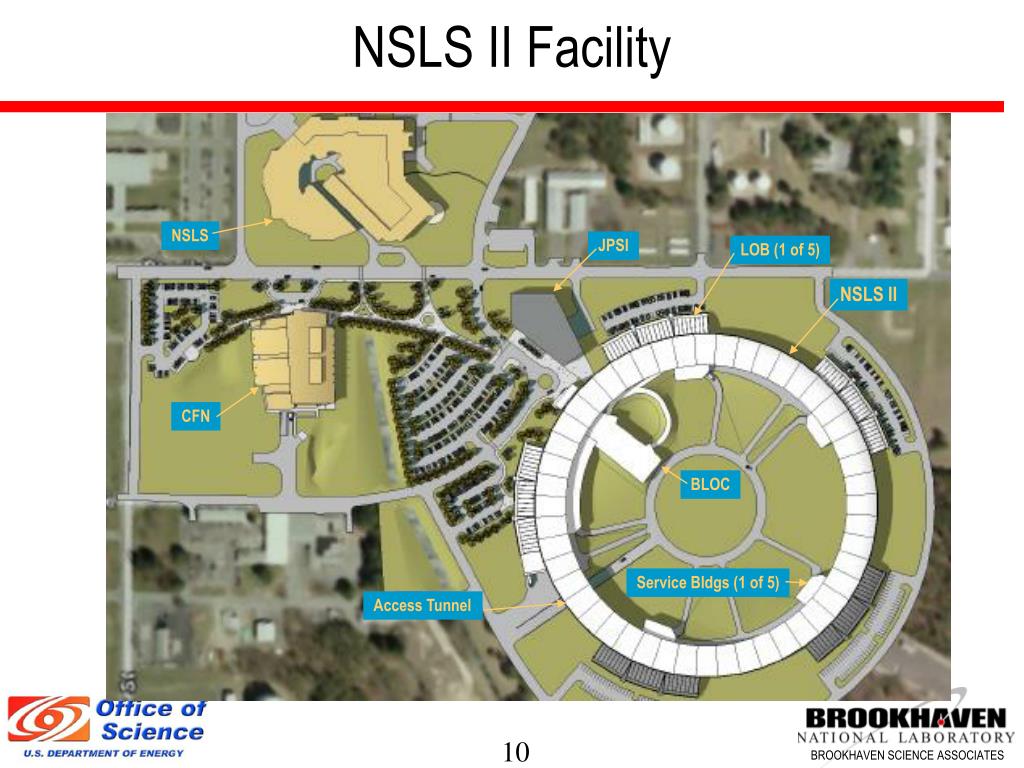

  10. NSLS II Facility NSLS JPSI LOB (1 of 5) NSLS II CFN BLOC Service Bldgs (1 of 5) Access Tunnel

  11. NSLS II Facility Overview cont’d Lab-Office Bldg 8 Access Corridor Experimental Floor 7 6 SR Tunnel Electrical Mezzanine (above tunnel) 5 Service Bldg 1st Floor (earlier concept)

  12. Ring Building Section Bldg structure Isolated from tunnel and experimental Floor Isolation Joint or Void Space Electrical Mezzanine Isolated Grade Beam Tunnel Roof Ratchet or Shield Wall Isolation Joint Earth Shield Berm Access Corridor Experimental Floor “Monolithic Joint” Isolated Pier for Column Tunnel Floor

  13. Tunnel Design - Ring Building Section Need to assure that vibration mitigation measures are carried out at Ring building interfaces with other structures and where systems enter building or tunnel Non-vibrating Equipment Rotating Machinery Non-vibrating Equipment Rotating Machinery Distance determined by modeling & empirical analysis Section at Lab Office Building and Service Building
