DENVER UNION STATION

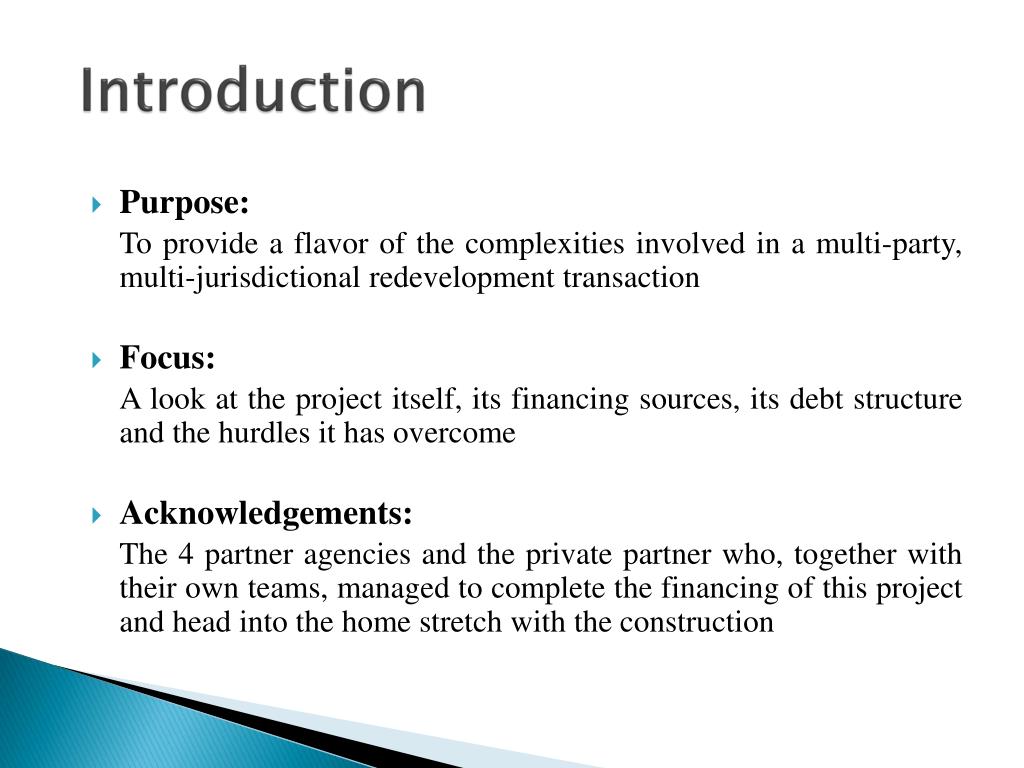

DENVER UNION STATION. $500M Public Transportation Infrastructure Project with 5 Public/Private Partners, and 9 financing Sources. DUS Site. Introduction. Purpose: To provide a flavor of the complexities involved in a multi-party, multi-jurisdictional redevelopment transaction Focus:

vevina
Télécharger la présentation

DENVER UNION STATION

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. DENVER UNION STATION $500M Public Transportation Infrastructure Project with 5 Public/Private Partners, and 9 financing Sources

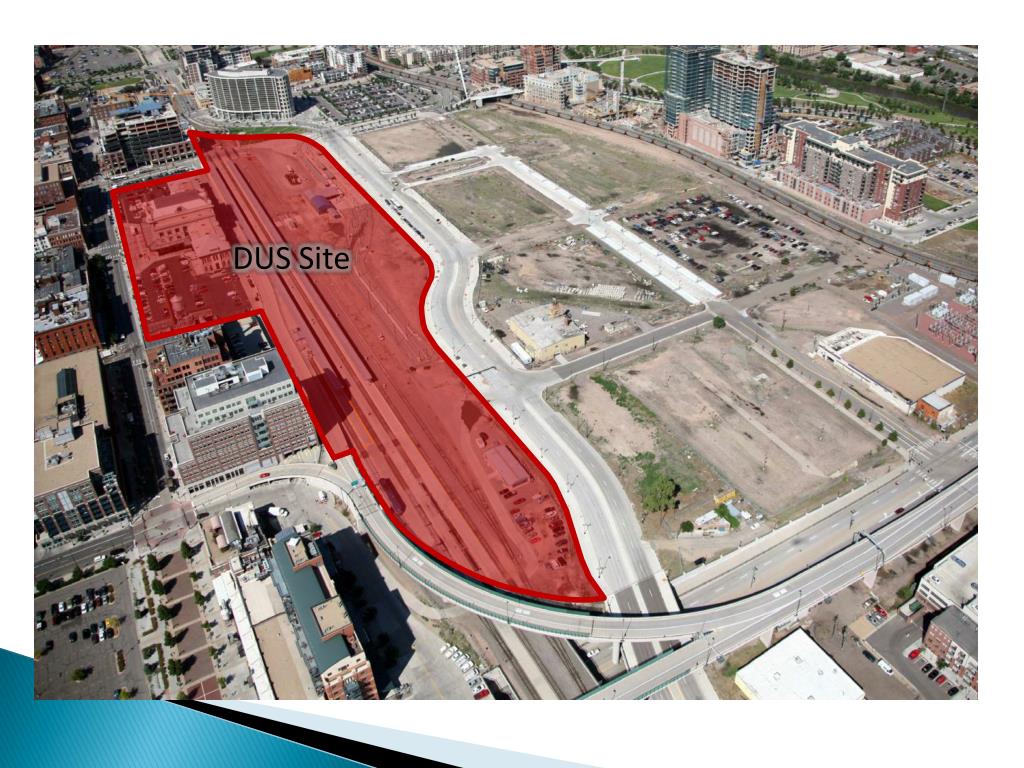

  2. DUS Site

  3. Introduction • Purpose: To provide a flavor of the complexities involved in a multi-party, multi-jurisdictional redevelopment transaction • Focus: A look at the project itself, its financing sources, its debt structure and the hurdles it has overcome • Acknowledgements: The 4 partner agencies and the private partner who, together with their own teams, managed to complete the financing of this project and head into the home stretch with the construction

  4. Four Original Partner Agencies Plus Master Developer • Regional Transportation District (RTD) • City and County of Denver (CCD) • Denver Regional Council of Governments (DRCOG) • Colorado Department of Transportation (CDOT) • Union Station Neighborhood Company (USNC)

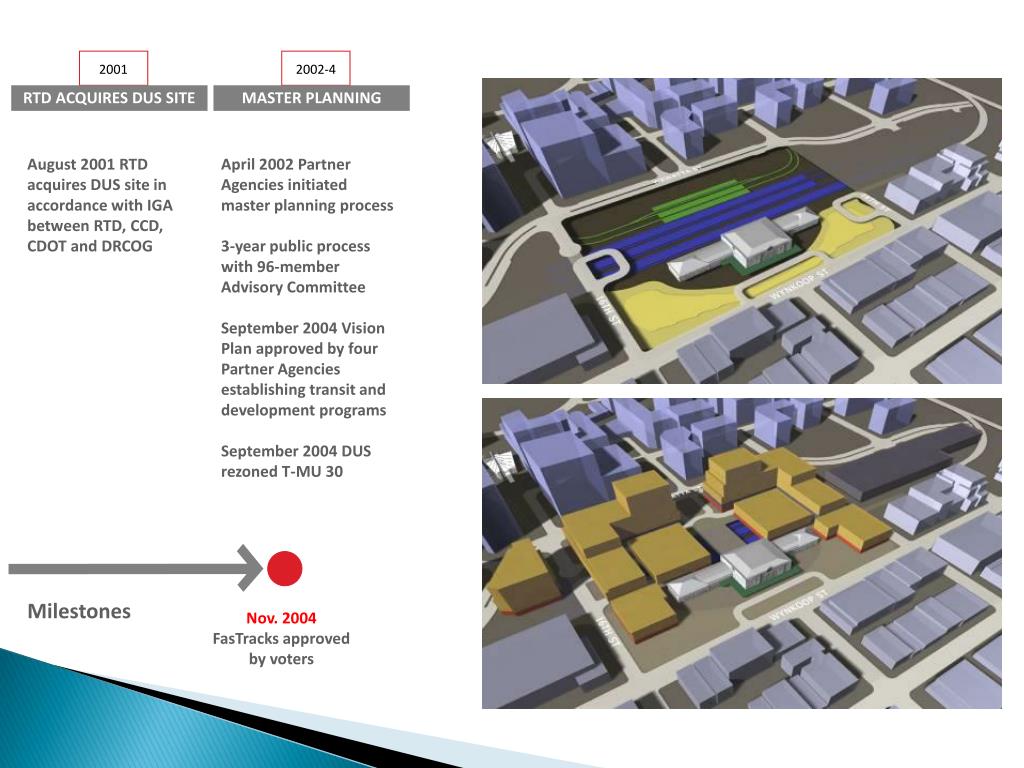

  5. 2001 2002-4 RTD ACQUIRES DUS SITE MASTER PLANNING August 2001 RTD acquires DUS site in accordance with IGA between RTD, CCD, CDOT and DRCOG April 2002 Partner Agencies initiated master planning process 3-year public process with 96-member Advisory Committee September 2004 Vision Plan approved by four Partner Agencies establishing transit and development programs September 2004 DUS rezoned T-MU 30 Milestones Nov. 2004 FasTracks approved by voters

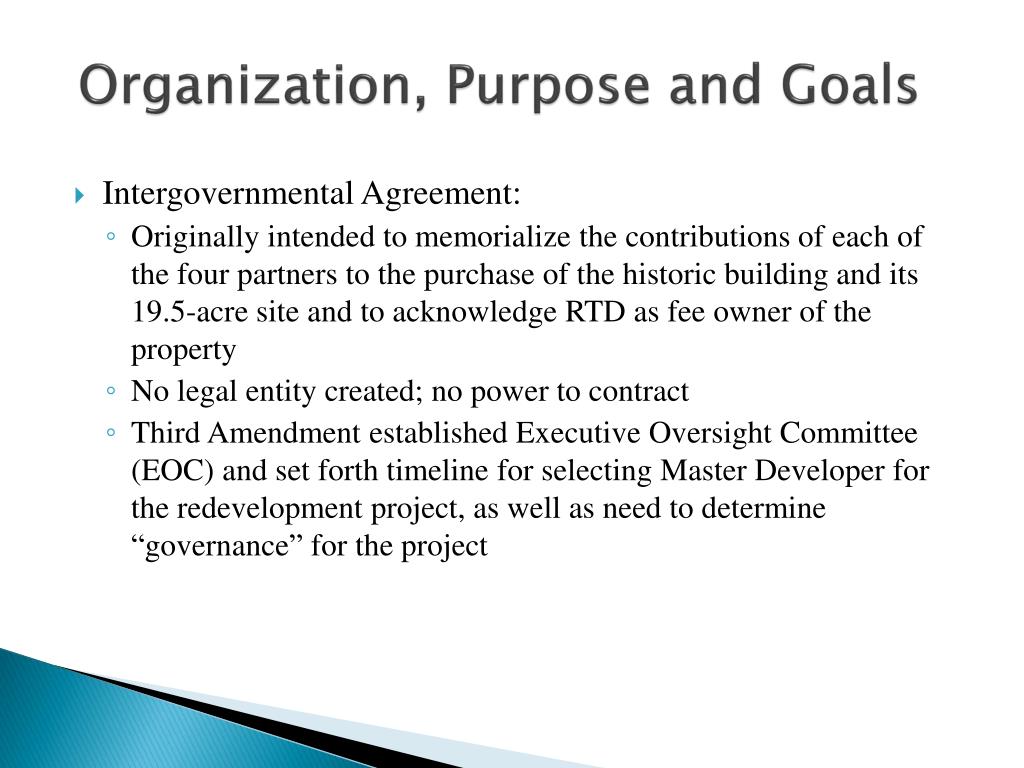

  6. Organization, Purpose and Goals • Intergovernmental Agreement: • Originally intended to memorialize the contributions of each of the four partners to the purchase of the historic building and its 19.5-acre site and to acknowledge RTD as fee owner of the property • No legal entity created; no power to contract • Third Amendment established Executive Oversight Committee (EOC) and set forth timeline for selecting Master Developer for the redevelopment project, as well as need to determine “governance” for the project

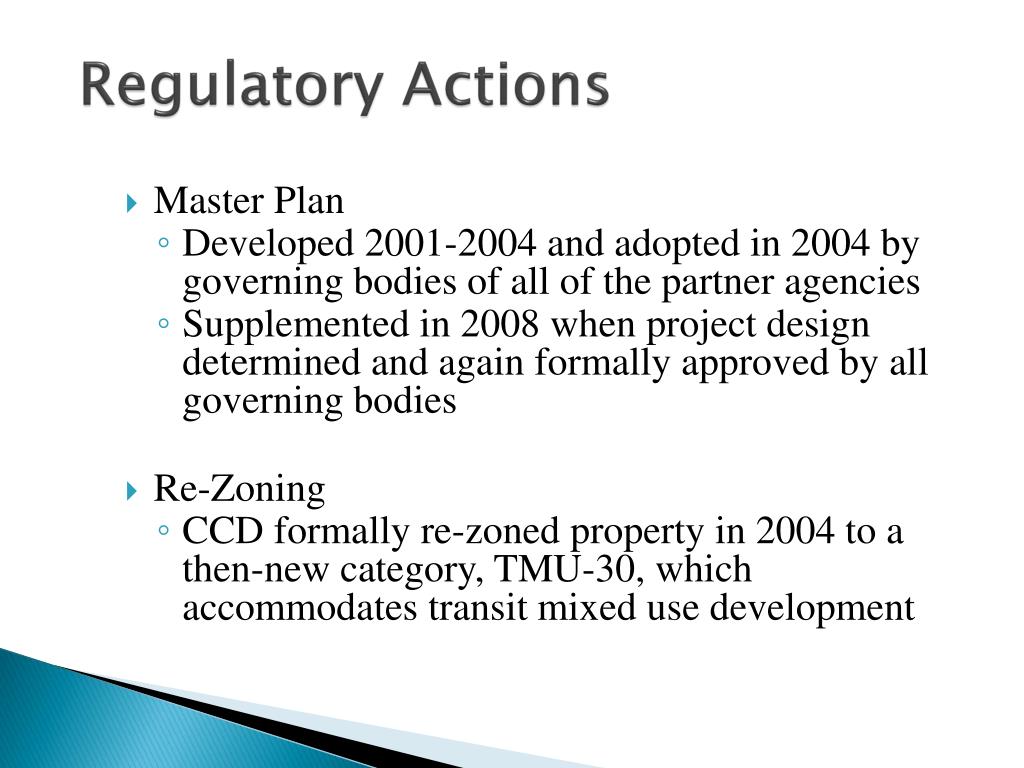

  7. Regulatory Actions • Master Plan • Developed 2001-2004 and adopted in 2004 by governing bodies of all of the partner agencies • Supplemented in 2008 when project design determined and again formally approved by all governing bodies • Re-Zoning • CCD formally re-zoned property in 2004 to a then-new category, TMU-30, which accommodates transit mixed use development

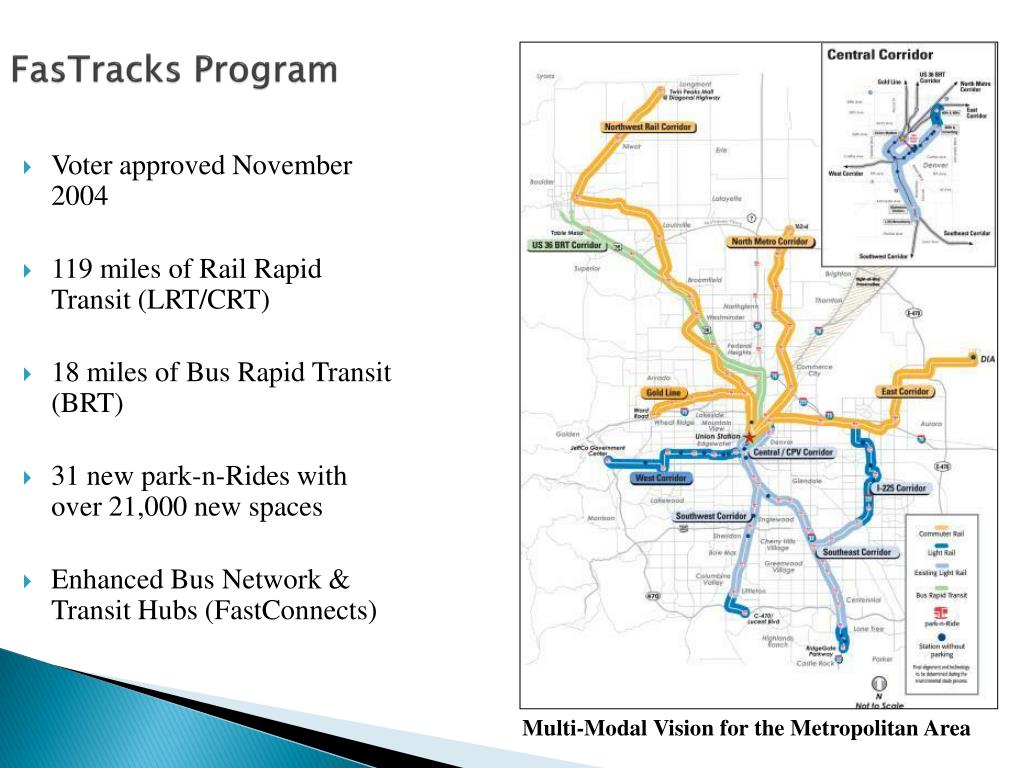

  8. Voter approved November 2004 119 miles of Rail Rapid Transit (LRT/CRT) 18 miles of Bus Rapid Transit (BRT) 31 new park-n-Rides with over 21,000 new spaces Enhanced Bus Network & Transit Hubs (FastConnects) FasTracks Program Multi-Modal Vision for the Metropolitan Area

  9. Major Transit Elements at DUS 8 track CRT (plus expansion) East (DIA) - 2016 North Metro (I-25 North) Northwest (Boulder) Gold (Arvada/Golden) - 2016 Amtrak – 2014 3 track LRT Existing Southwest & Southeast - 2011 West (Lakewood/Golden) – 2013 22 bay regional bus facility - 2014 16 regional 4 Downtown Circulator 2 commercial bus 16th Street Mall Extension – 2011 Downtown Circulator Public Realm Transit Framework

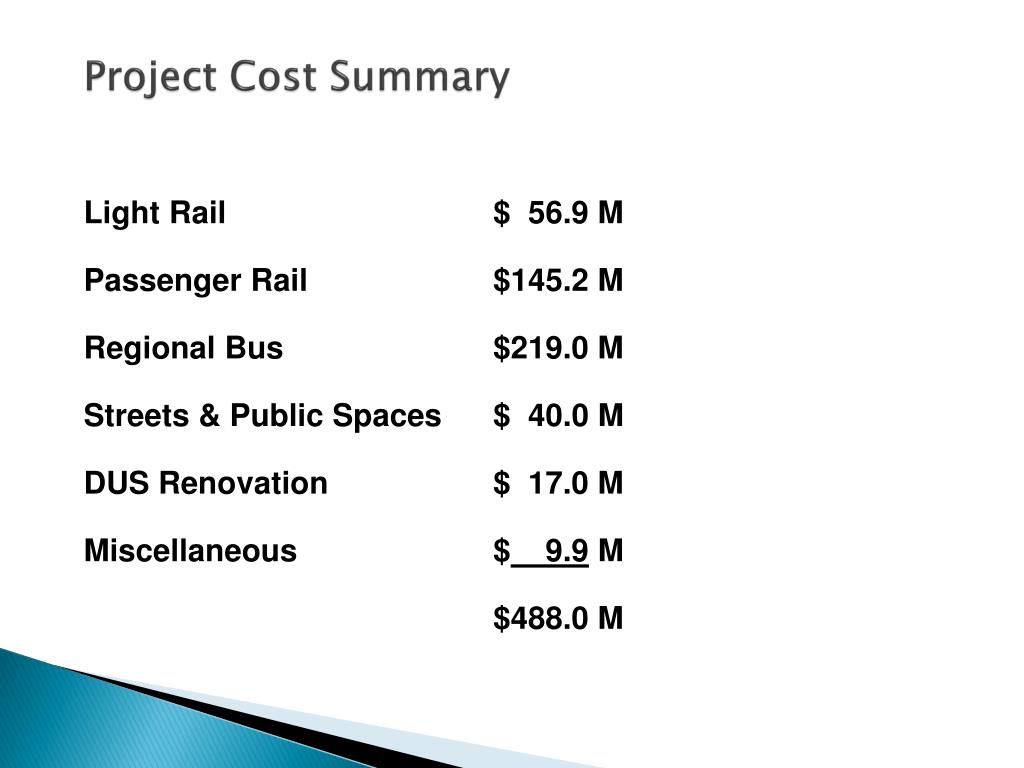

  10. Project Cost Summary Light Rail $ 56.9 M Passenger Rail $145.2 M Regional Bus $219.0 M Streets & Public Spaces $ 40.0 M DUS Renovation $ 17.0 M Miscellaneous $ 9.9 M $488.0 M

  11. 2005-6 2007 2008 DEVELOPER SELECTION DESIGN REFINEMENT PRELIMINARY ENG. USNC led design refinement - team studied alternative configurations At-Grade Solution developed and costed; 15% Conceptual Plans prepared Master Plan amended to reflect new solution EIS advances Design Team prepared 30% Preliminary Engineering EIS completed ROD issued October 2008 DUSPA created DDA created, TIF district established DUS Met Districts created 18 month process of national significance Developer RFQ June 2005 11 teams submit RFP Part 1, February 2006 5 teams submit RFP Part 2, July 2006 Developer Interviews, August 2006 Public Presentations, September 2006 Nov. 2006 USNC Selected as Master Developer, team included SOM, AECOM, and Kiewit Nov. 2007 Revised solution & target budget established Dec. 2008 PE complete Start D/B Negotiations

  12. USNC Sites DUS Site

  13. Light Rail Regional Bus (below) 4 5 3 CRT/Passenger Rail 2 1

  14. LIGHT RAIL + MALL SHUTTLE STATIONS DUS - Transit Infrastructure REGIONAL BUS TERMINAL 18th St. Chestnut Pl. 17th St. Wewatta Plaza Wewatta St. 16th St. COMMUTER RAIL TERMINAL DUS HISTORIC BUILDING Wynkoop Plaza

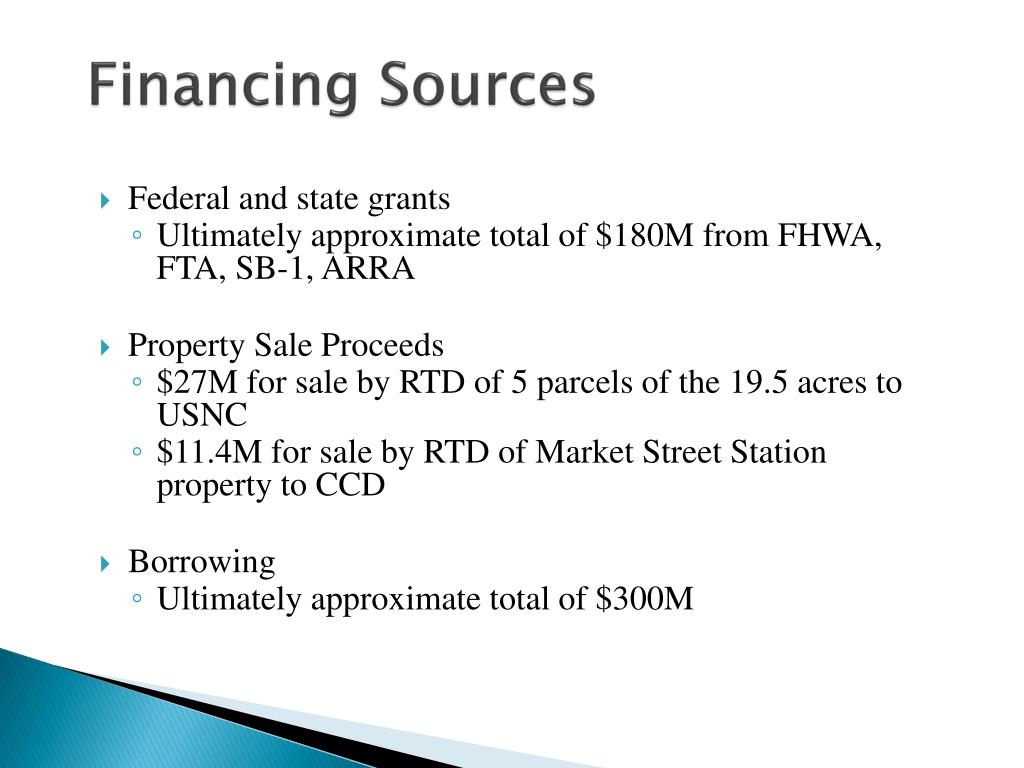

  15. Financing Sources • Federal and state grants • Ultimately approximate total of $180M from FHWA, FTA, SB-1, ARRA • Property Sale Proceeds • $27M for sale by RTD of 5 parcels of the 19.5 acres to USNC • $11.4M for sale by RTD of Market Street Station property to CCD • Borrowing • Ultimately approximate total of $300M

  16. Federal and State Grants • $50M FHWA (CDOT) • $28.6M ARRA Funds (DRCOG and RTD) • $9.6M FTA • $2.5M TIP • $18.6M Senate Bill 1(CO)

  17. Property Sale Proceeds • $1.5M North Wing Parcel • $1.5M South Wing Parcel • $3M Triangle Parcel • $10M A Block Parcel • $10M B Block Parcel • $11.436 Market Street Station

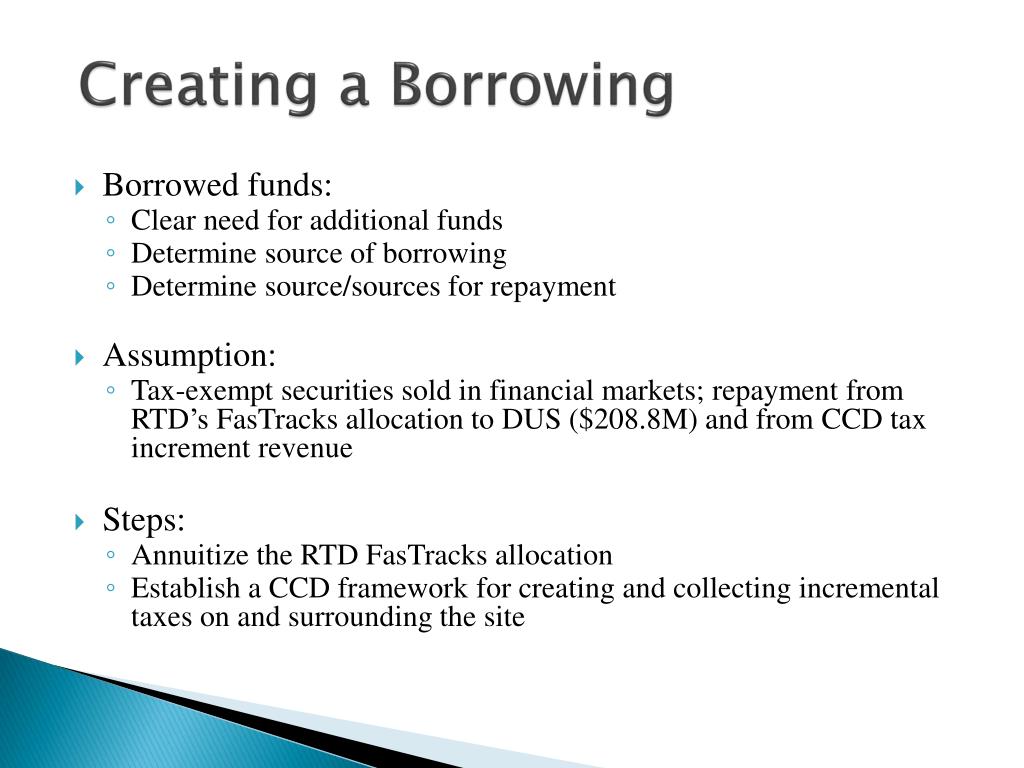

  18. Creating a Borrowing • Borrowed funds: • Clear need for additional funds • Determine source of borrowing • Determine source/sources for repayment • Assumption: • Tax-exempt securities sold in financial markets; repayment from RTD’s FasTracks allocation to DUS ($208.8M) and from CCD tax increment revenue • Steps: • Annuitize the RTD FasTracks allocation • Establish a CCD framework for creating and collecting incremental taxes on and surrounding the site

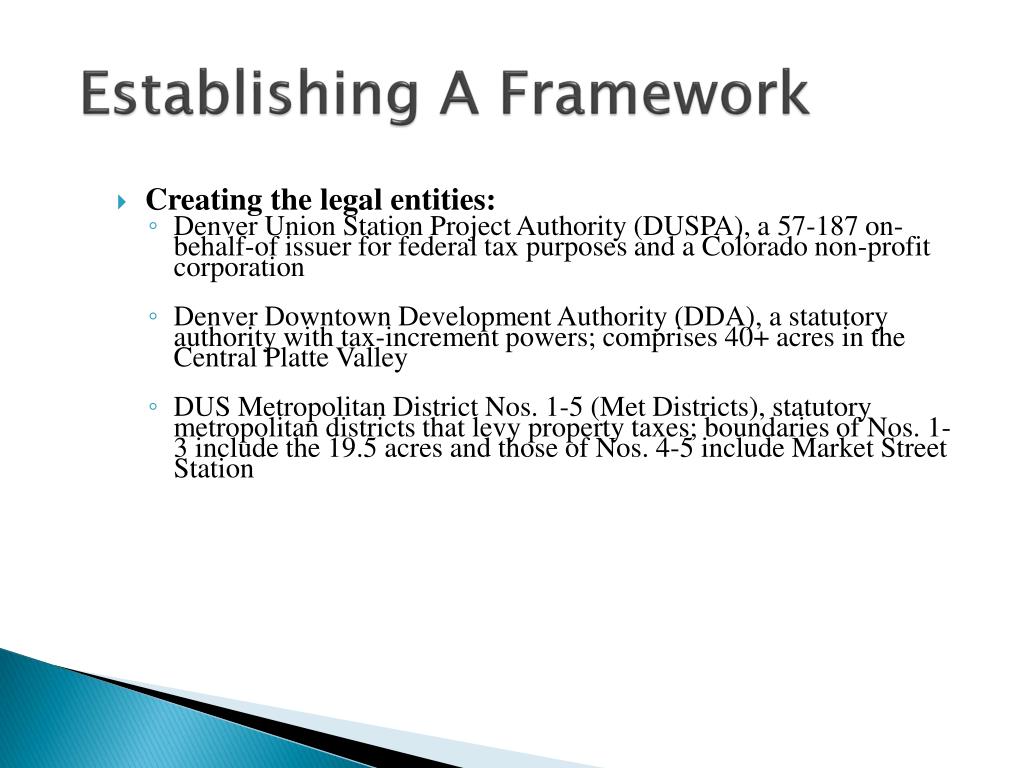

  19. Establishing A Framework • Creating the legal entities: • Denver Union Station Project Authority (DUSPA), a 57-187 on-behalf-of issuer for federal tax purposes and a Colorado non-profit corporation • Denver Downtown Development Authority (DDA), a statutory authority with tax-increment powers; comprises 40+ acres in the Central Platte Valley • DUS Metropolitan District Nos. 1-5 (Met Districts), statutory metropolitan districts that levy property taxes; boundaries of Nos. 1-3 include the 19.5 acres and those of Nos. 4-5 include Market Street Station

  20. Denver Union Station PUBLIC PRIVATE FEDERAL & STATE RTD Regional Transportation District EAST WEST PARTNERS DUS METRO DISTRICT CONTINUUM PARTNERS CCD City & County of Denver DRCOG Denver Regional Council of Governments DDA Downtown Development Authority CDOT Colorado Department of Transportation DUSPA Denver Union Station Project Authority Owner’s Representative: Trammell Crow Company USNC Union Station Neighborhood Company Master Developer Private land and vertical developer of DUS sites Participate in management of transit and public infrastructure project Metro District 1 member DRCOG 1 member RTD 2 members CCD 6 members 2 non-voting members CDOT 1 member DESIGN-BUILD CONTRACT Design, Construction, and Operation of Private Buildings developed on DUS site Kiewit Western Company Transportation/Public Infrastructure Contractor AECOM Transportation Infrastructure Engineer Hargreaves & Associates Landscape Architect SOM Skidmore, Owings, and Merrill, LLP Master Plan & Transit Architect APublic-Private Partnership

  21. Public Finance Summary |DDA & DUS Met District Boundaries 20th Street Consolidated Main Line Wewatta Street 19th Street DUS 18th Street Wynkoop Street 17th Street DDA Boundary DUS Met Districts DUS Site 16th Street 15th Street Market St. Station Market St. Station

  22. 2008 Market Shift • Tax-Exempt Markets • After downturn, capital markets not accessible • Federal Loan Opportunities • Restructured DUS repayment scenarios to accommodate federal requirements

  23. Federal Loans • Transportation Infrastructure Finance and Innovation Act (TIFIA)- $145M • Railroad Rehabilitation and Improvement Finance (RRIF) - $155M

  24. Federal Loan Negotiations • Transportation Infrastructure Finance and Innovation Act (TIFIA) • “Springing lien”; “bankruptcy event” not clearly defined; explored bankruptcy potential RTD/DUSPA; • Springing lien issue necessitates TIFIA be senior lender for first time; participation of private developer unusual

  25. Federal Loan Negotiations • Railroad Rehabilitation and Improvement Financing (RRIF) • No physical collateral; acceleration; first time as subordinate lender

  26. Loan Repayment Sources • FasTracks $208.8M less previous expenditures = $165M • $165M annuitized at 5.65% to $12M annually, pledged by RTD to DUSPA to secure and repay TIFIA loan • Denver Downtown Development Authority (DDA) all tax increment revenue for 30 years pledged by City to DUSPA to secure and repay RRIF loan

  27. Loan Security • Moral Obligation (City Contingent Commitment) from City and County of Denver In the event of a shortfall in revenue available for debt service on the subordinate loan (RRIF), the City and County of Denver will request of its City Council appropriation of up to $8M annually during the term of the loan to make up any such shortfall

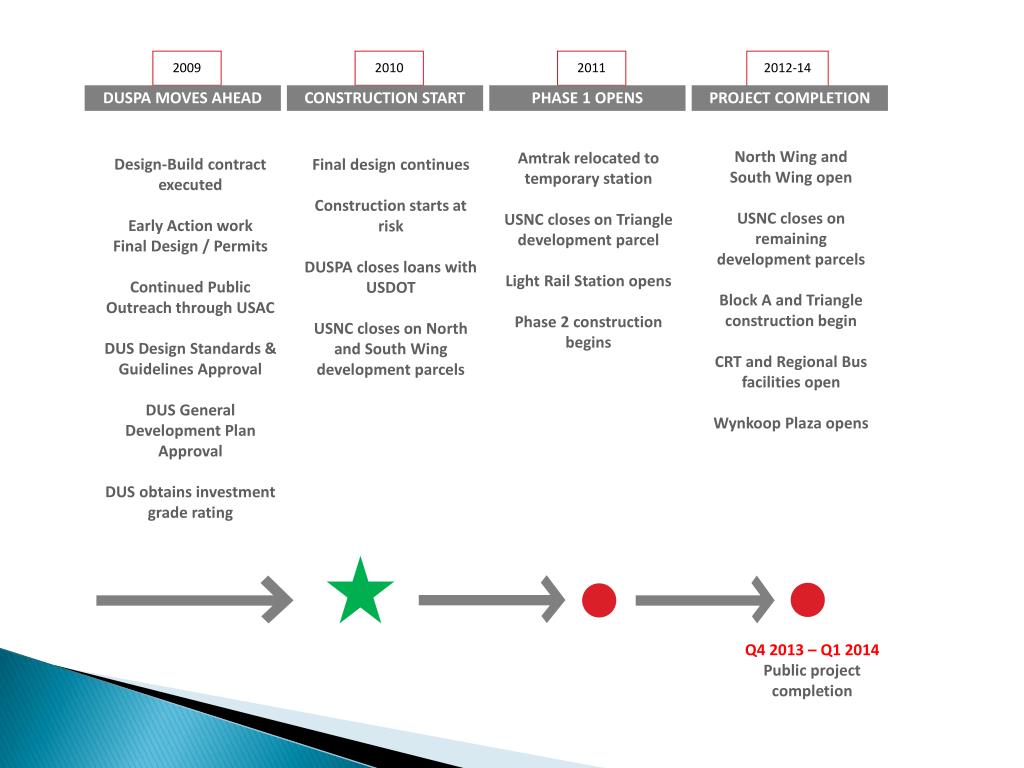

  28. 2009 2010 2011 2012-14 DUSPA MOVES AHEAD CONSTRUCTION START PHASE 1 OPENS PROJECT COMPLETION North Wing and South Wing open USNC closes on remaining development parcels Block A and Triangle construction begin CRT and Regional Bus facilities open Wynkoop Plaza opens Amtrak relocated to temporary station USNC closes on Triangle development parcel Light Rail Station opens Phase 2 construction begins Design-Build contract executed Early Action work Final Design / Permits Continued Public Outreach through USAC DUS Design Standards & Guidelines Approval DUS General Development Plan Approval DUS obtains investment grade rating Final design continues Construction starts at risk DUSPA closes loans with USDOT USNC closes on North and South Wing development parcels Q4 2013 – Q1 2014 Public project completion

  29. Wewatta Plaza View from 17th and Wewatta Streets

  30. Wewatta Plaza – opening day

  31. DUS Light Rail Station and Plaza View toward CML from 17th Street and Chestnut Place

  32. DUS Light Rail Station and Plaza View toward CML from 17th Street and Chestnut Place

  33. Conclusion • The Denver Union Station transportation project opened on May 9, 2014 on schedule and on budget • The successful opening means the region has gained a modern, multi-modal transportation hub, grounded by a magnificent renovation of a beautiful historic building Mantra of the 5 partners: “No is not the answer!”
