EUSO-BALLOON DESIGN REVIEW, 18.12.2012, CNES TOULOUSE. The EUSO-BALLOON AIT-Development plan. Sylvie Dagoret-Campagne LAL, Orsay , Baptiste Mot, IRAP , Toulouse. - Purpose - Main sequences - Resources (manpower and GSE), including location

winona
Télécharger la présentation

- Purpose - Main sequences - Resources (manpower and GSE), including location

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. EUSO-BALLOON DESIGN REVIEW, 18.12.2012, CNES TOULOUSE The EUSO-BALLOON AIT-Development plan Sylvie Dagoret-Campagne LAL, Orsay, Baptiste Mot, IRAP, Toulouse • - Purpose • - Main sequences • - Resources (manpower and GSE), including location • -Main activities of the assembly and integration of the subsystems • -Final integration and tests

  2. EUSO-BALLOON, a HighlyModular instrument • 4 subsystems : • « electrical » (DP,PDM,DP) • 1 mechanical, • DP : 11 components (boards), • PDM : 5 components (boards), • PWP : 1 • Each component under the responsibility (design, fabrication, procurement) of different laboratories world wide spread. • Phase B  Phase C&D  • Need AIT/AIV procedures • Need resource evaluation • Need time evaluation (planning) AIT Development plan and GSE

  3. Main sequences of Integrations Optics Tests: RIKEN-JP/UAH-US tests EC-Unit Integration: MATRA-LAL Instrument Integration: B.I.S CNES Full electronicsintgration: APC PDM integration: APC Final Tests: B.I.S CNES ElectronicIntegration: LAL Mechanicsassembly: B.I.S CNES Data processing Integration: INFN-Naples time AIT Development plan and GSE

  4. Manpower for AIT Full integration : Subsystem/ electronicintegration : DP integration: AIT Development plan and GSE

  5. GSE-PDM AIT Development plan and GSE

  6. GSE-CAL AIT Development plan and GSE

  7. GSE-DP and GSE-Opt AIT Development plan and GSE

  8. PDM AIT activities sequence Integration Tests & Validation Component Pre-assembly Pre- Integration Component test Assembly PAECM1 EC-Unit PAECM2 IEC1 AP1 IEC2 AP3 CAPHEEC1 HVPS THV1 THV2 CAKIEC1 IEC3 TECA1 AP2 EC-ASIC TECA2 IEL1 TrigPDM IEL2 TPD1.. N PDM-B AIT Development plan and GSE

  9. PDM AIT activitieslist AIT Development plan and GSE

  10. PDM-AIT Activitieslist AIT Development plan and GSE

  11. DP-Activitiessequence AIT Development plan and GSE

  12. DP-AIT Activitieslist … ID1 ID5 AIT Development plan and GSE

  13. Pre-Integration EC-ASIC and PDM-B EC-ASIC board Charge injection ASIC Power supply Logic analyzer PDM board EC-ASIC board PDM board Computer Multimeter NI(PC interface) AIT Development plan and GSE

  14. PDM-B-DP Pre-Integration AIT Development plan and GSE

  15. INTERFACES TESTED UP TO NOW FOR HARDWARE DP EC-Front GPSR IR-CAM EC-DYNODE CLKB LVPS-DP1 EXT MAPMT EC-HV CCB EC-ANODE SIREN SPACEWIRE /PCI CNES Telemetry CPU EC-ASIC LVPS-DP2 DST Batteries PDM-B Bat Controller LVPS-PDM HVPS2 PWP HK HVPS1 LVPS-HK Sensors Motors EC-Back PDM DP TLS

  16. Optical AIT Activitieslist TOP 1 TOP 2 AIT Development plan and GSE

  17. PWP Activitiessequence AIT Development plan and GSE

  18. Activities- Taskforms Example of description of a task • All activities are referred by an acronym, • Each activity is performed in a sequence of AIT-AIV of a subsystem of of the instrument • They are tracked in activity forms by AIT managers • Description : • Component, • Configuration, • GSE, • Task details, procedures, results AIT Development plan and GSE

  19. Final AIT-AIV Resp : IRAP location : CNES • Overview of Integration Phases • Sequence of integrations • Global tests • Transport and flight campaign preparation • Flight campaign #1 AIT Development plan and GSE

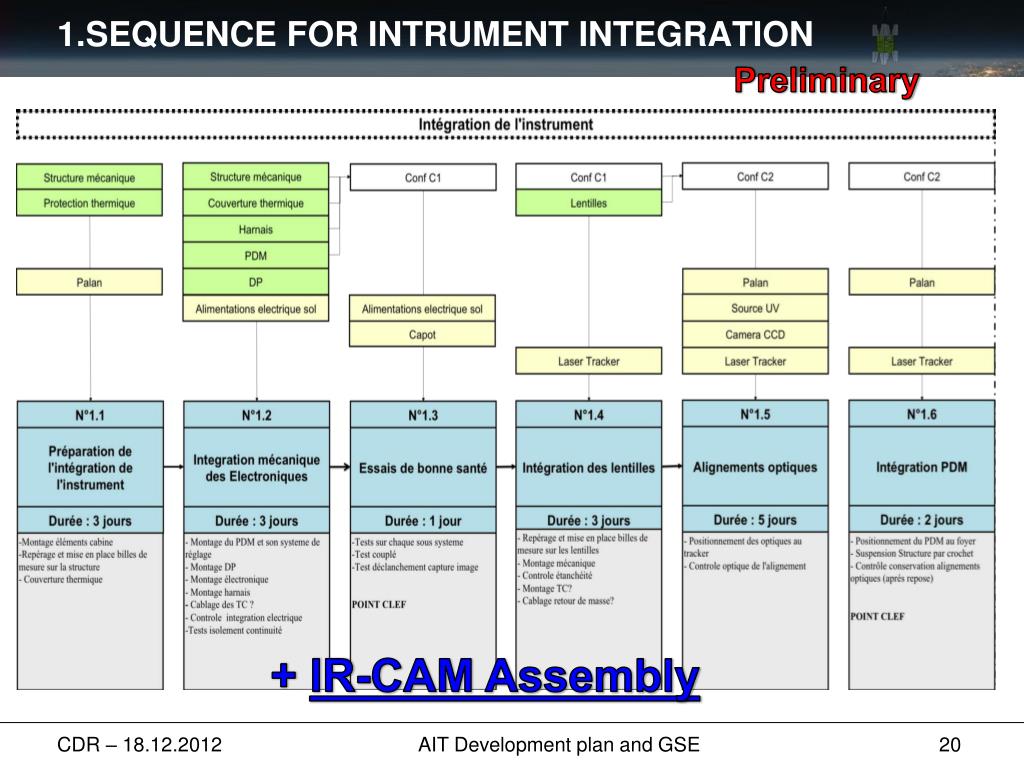

  20. 1.SEQUENCE FOR INTRUMENT INTEGRATION Preliminary + IR-CAM Assembly AIT Development plan and GSE

  21. 2.GLOBAL TESTS Preliminary AIT Development plan and GSE

  22. 3.TRANSPORT AND FLIGHT-CAMPAIGN PREPARATION Preliminary AIT Development plan and GSE

  23. Preliminary Flight campaign #1 AIT Development plan and GSE

  24. Conclusions • Main phases of AIT identified : • Subsystems • Instrument (Final), • Many activities identified for subsystem AIT and their component integration, • Test procedures assessed, • Some activities can be done in parallel, some in sequences. • Merging points. • Activities are inserted in a sequence of AIT of the subsystems, • Types of activities: • Component tests, pre-integration, assembly, integration, tests and validation, calibration. • Resources in manpower for AIT distributed, location of the activities, including the management. • Resources in GSE listed, • Timing estimated, • Activities follow-up: • AIT-AIV will be controlled and tracked by the AIT managers using activities forms. AIT Development plan and GSE
