THEMIS-SCM. SCM SCHEDULE. The CETP maintains a dedicated Schedule for SCM (MS-Project) the most important activities and dates are reported in the Themis Schedule Very simple for the moment, it shall be completed and improved

wyanet
Télécharger la présentation

THEMIS-SCM

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

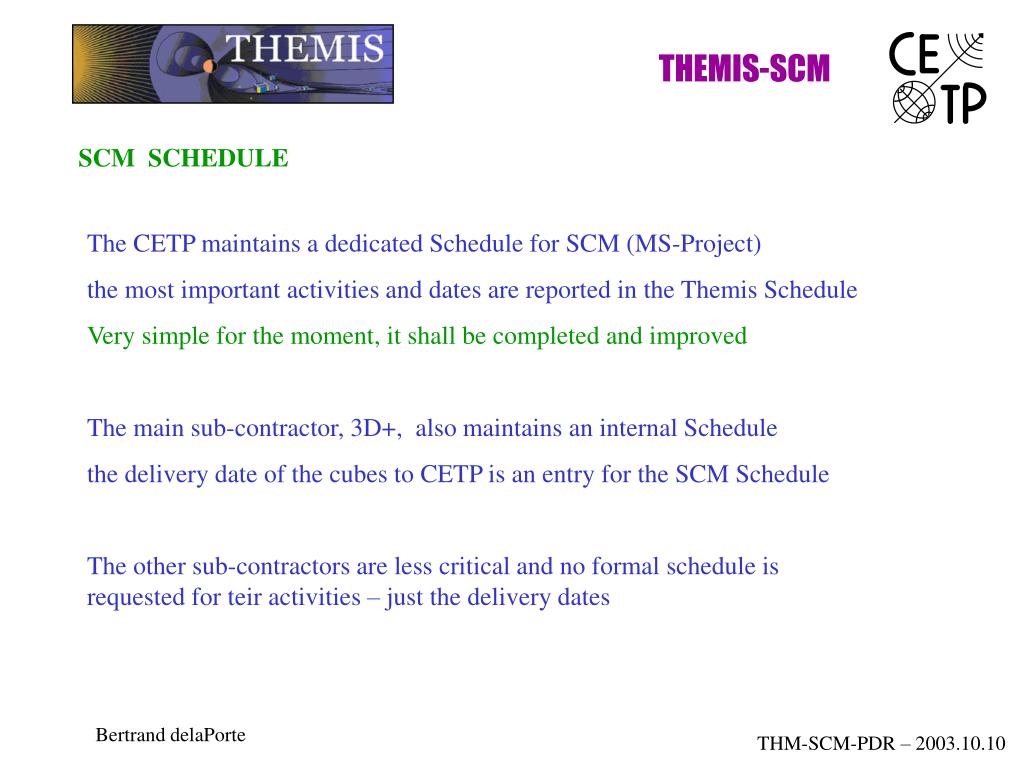

  1. THEMIS-SCM SCM SCHEDULE The CETP maintains a dedicated Schedule for SCM (MS-Project) the most important activities and dates are reported in the Themis Schedule Very simple for the moment, it shall be completed and improved The main sub-contractor, 3D+, also maintains an internal Schedule the delivery date of the cubes to CETP is an entry for the SCM Schedule The other sub-contractors are less critical and no formal schedule is requested for teir activities – just the delivery dates Bertrand delaPorte THM-SCM-PDR – 2003.10.10

  2. THEMIS-SCM SCM SCHEDULE The milestones for SCM are the delivery dates to UCB According to the current schedule: EM delivery to UCB : 16-Apr-04 - no difficulty expected FM-1 30-Jul-04 - very difficult for the PA FM-2+3 24-Sep-04 - very tight for the PA FM-4+5 19-Nov-04 - no difficulty expected FM-6 14-Jan-05 No difficulty is expected for any SC Because there is a screening at the end, all FM cubes (for all Models), will be delivered at the same date – according to the contract: 01-Aug-2004 Bertrand delaPorte THM-SCM-PDR – 2003.10.10

  3. THEMIS-SCM 26-Jan-04 3D+ date 31-Jan-04 EM to UCB 16-Apr-04 PA /EM manufacturing & delivery Bertrand delaPorte THM-SCM-PDR – 2003.10.10

  4. THEMIS-SCM 31-May-04 3D+ date 01-Aug-04 FM-1 to UCB 30-Jul-04 26-Jul-04 FM-2, 3 to UCB 24-Sep-04 PA /FM-1,2,3 manufacturing & delivery Bertrand delaPorte THM-SCM-PDR – 2003.10.10

  5. THEMIS-SCM SCM SCHEDULE - CONCLUSION Real difficulty to delivery the PA /FM1 at the date currently specified Various solutions can be envisaged with UCB or with 3D+ to avoid any impact on the Integration Schedule of the Project All other Models can be delivered in time Bertrand delaPorte THM-SCM-PDR – 2003.10.10
