1 / 1

Updated infrastructure intervention schedule ....

Updated infrastructure intervention schedule. Muon cooling station maintenance Side A: March 6 to 7 (shifted). All muon power off. – Impact on TGC HV tests ? Side C: March 8 to 11 (shifted). All muon power off. Consolidation and pipe replacement for Mixed Water (EM)/Chilled Water (EG)

zoie
Télécharger la présentation

Updated infrastructure intervention schedule ....

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

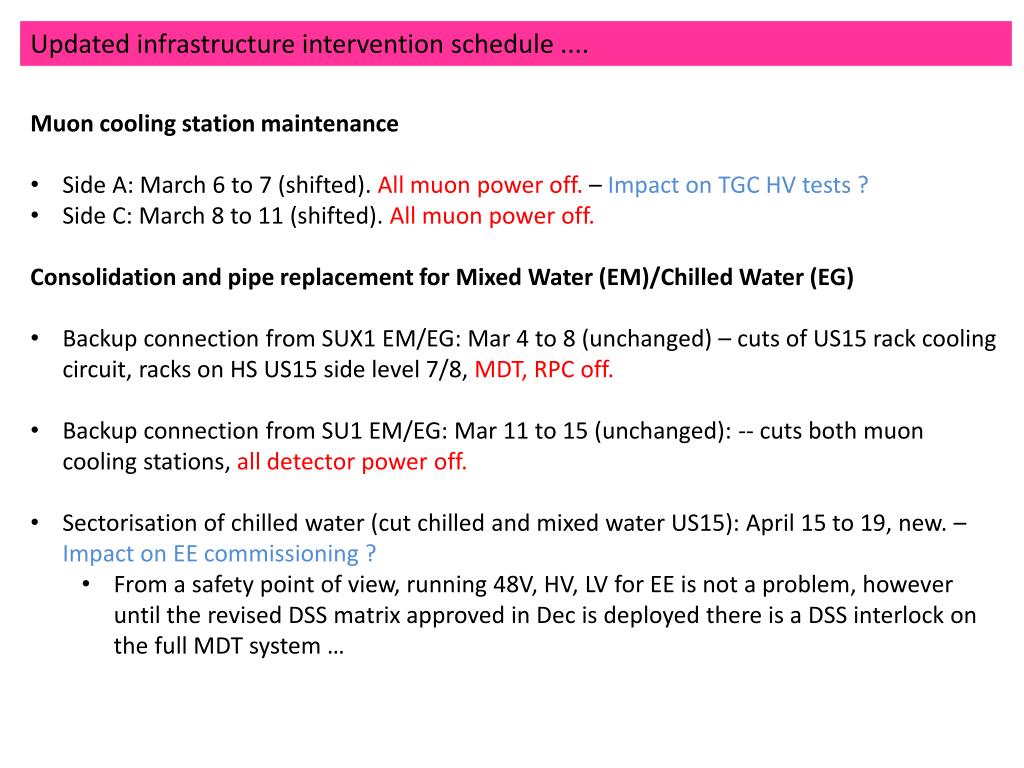

  1. Updated infrastructure intervention schedule .... • Muon cooling station maintenance • Side A: March 6 to 7 (shifted). All muon power off. – Impact on TGC HV tests ? • Side C: March 8 to 11 (shifted). All muon power off. • Consolidation and pipe replacement for Mixed Water (EM)/Chilled Water (EG) • Backup connection from SUX1 EM/EG: Mar 4 to 8 (unchanged) – cuts of US15 rack cooling circuit, racks on HS US15 side level 7/8, MDT, RPC off. • Backup connection from SU1 EM/EG: Mar 11 to 15 (unchanged): -- cuts both muon cooling stations, all detector power off. • Sectorisation of chilled water (cut chilled and mixed water US15): April 15 to 19, new. – Impact on EE commissioning ? • From a safety point of view, running 48V, HV, LV for EE is not a problem, however until the revised DSS matrix approved in Dec is deployed there is a DSS interlock on the full MDT system …

More Related
