Chapter 8 Project Management

Introduction to Management Science 8th Edition by Bernard W. Taylor III. Chapter 8 Project Management. Chapter Topics. The Elements of Project Management The Project Network Probabilistic Activity Times Activity-on-Node Networks and Microsoft Project

Thomas
Télécharger la présentation

Chapter 8 Project Management

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Introduction to Management Science 8th Edition by Bernard W. Taylor III Chapter 8 Project Management Chapter 8 - Project Management

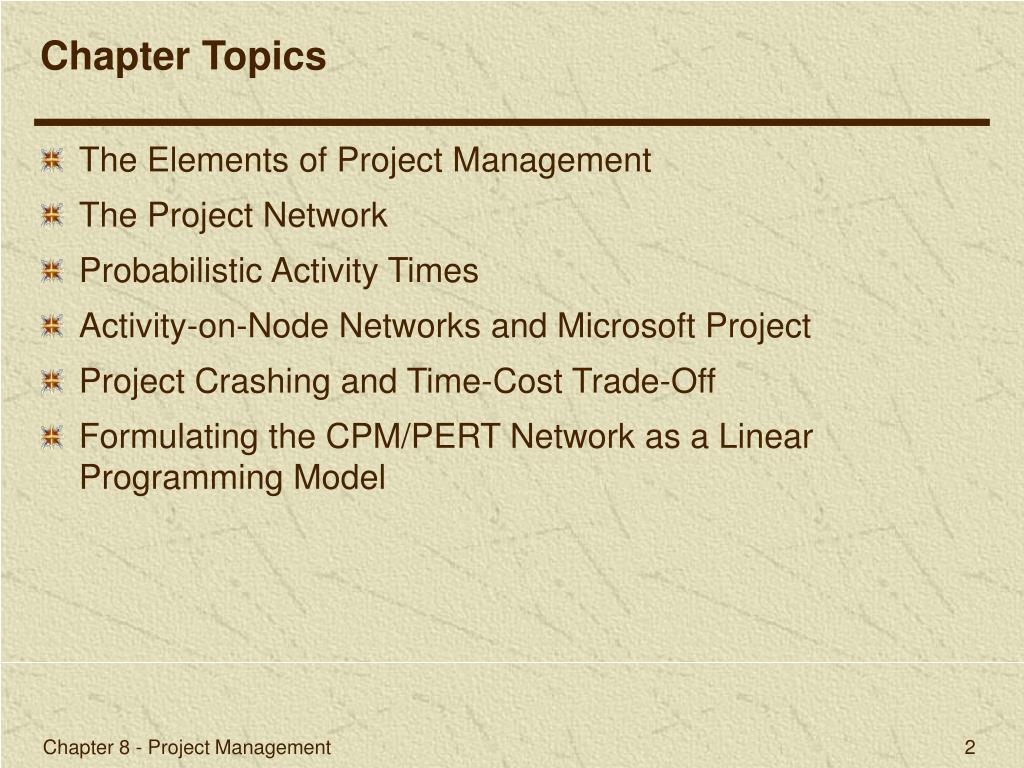

  2. Chapter Topics • The Elements of Project Management • The Project Network • Probabilistic Activity Times • Activity-on-Node Networks and Microsoft Project • Project Crashing and Time-Cost Trade-Off • Formulating the CPM/PERT Network as a Linear Programming Model Chapter 8 - Project Management

  3. Overview • Uses networks for project analysis. • Networks show how projects are organized and are used to determine time duration for completion. • Network techniques used are: • CPM (Critical Path Method) • PERT (Project Evaluation and Review Technique) • Developed during late 1950’s. Chapter 8 - Project Management

  4. Elements of Project Management • Management is generally perceived as concerned with planning, organizing, and control of an ongoing process or activity. • Project Management is concerned with control of an activity for a relatively short period of time after which management effort ends. • Primary elements of Project Management to be discussed: • Project Team • Project Planning • Project Control Chapter 8 - Project Management

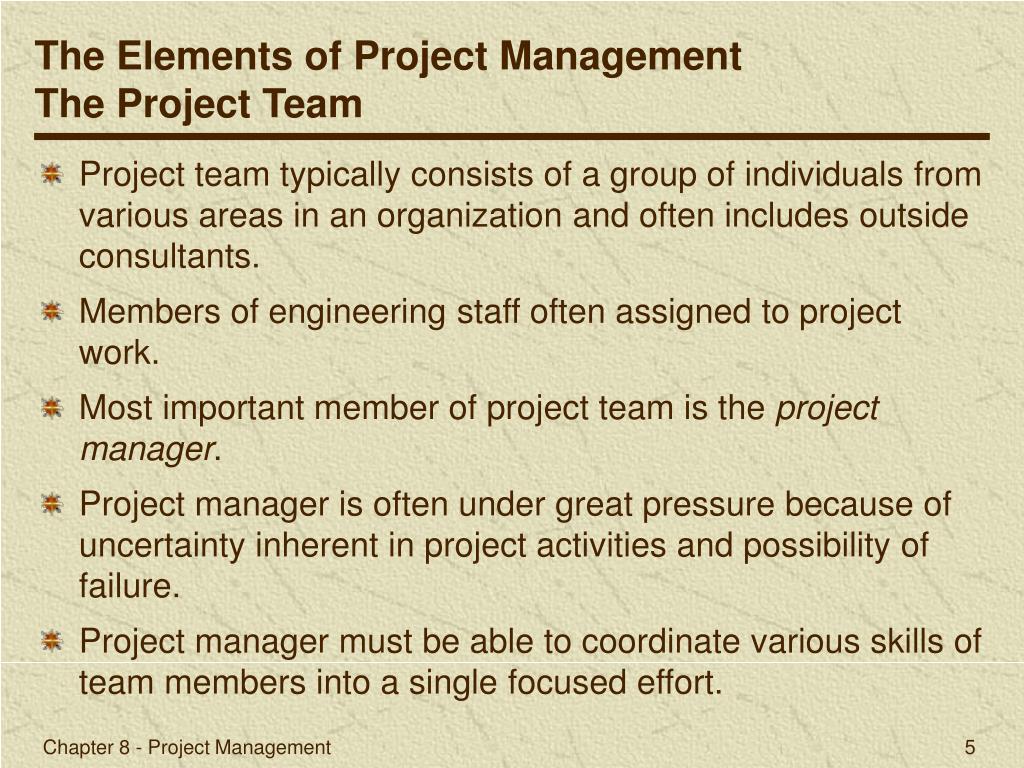

  5. The Elements of Project Management The Project Team • Project team typically consists of a group of individuals from various areas in an organization and often includes outside consultants. • Members of engineering staff often assigned to project work. • Most important member of project team is the project manager. • Project manager is often under great pressure because of uncertainty inherent in project activities and possibility of failure. • Project manager must be able to coordinate various skills of team members into a single focused effort. Chapter 8 - Project Management

  6. The Elements of Project Management The Project Network • A branch reflects an activity of a project. • A node represents the beginning and end of activities, referred to as events. • Branches in the network indicate precedence relationships. • When an activity is completed at a node, it has been realized. Figure 8.2 Network for Building a House Chapter 8 - Project Management

  7. The Project Network Planning and Scheduling • Network aids in planning and scheduling. • Time duration of activities shown on branches: Figure 8.3 Network for Building a House with Activity Times Chapter 8 - Project Management

  8. The Project Network Concurrent Activities • Activities can occur at the same time (concurrently). • A dummy activity shows a precedence relationship but reflects no passage of time. • Two or more activities cannot share the same start and end nodes. Figure 8.4 Expanded Network for Building a House Showing Concurrent Activities Chapter 8 - Project Management

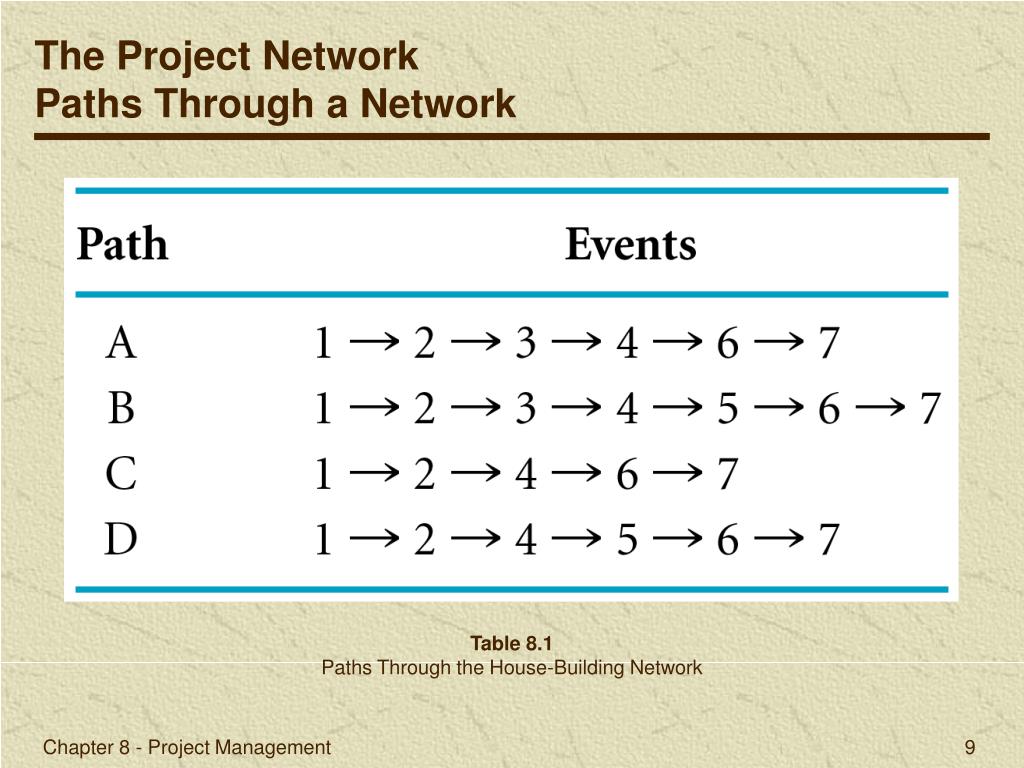

  9. The Project Network Paths Through a Network Table 8.1 Paths Through the House-Building Network Chapter 8 - Project Management

  10. The Project Network The Critical Path (1 of 2) • The critical path is the longest path through the network; the minimum time the network can be completed. In Figure 8.5: • Path A: 1  2  3  4  6  7, 3 + 2 + 0 + 3 + 1 = 9 months • Path B: 1  2  3  4  5  6  7, 3 + 2 + 0 + 1 + 1 + 1 = 8 months • Path C: 1  2  4  6  7, 3 + 1 + 3 + 1 = 8 months • Path D: 1  2  4  5  6  7, 3 + 1 + 1 + 1 + 1 = 7 months Chapter 8 - Project Management

  11. The Project Network The Critical Path (2 of 2) Figure 8.6 Alternative Paths in the Network Chapter 8 - Project Management

  12. The Project Network Activity Scheduling – Earliest Times • ES is the earliest time an activity can start. ESij = Maximum (EFi) • EF is the earliest start time plus the activity time. EFij = ESij + tij Figure 8.7 Earliest Activity Start and Finish Times Chapter 8 - Project Management

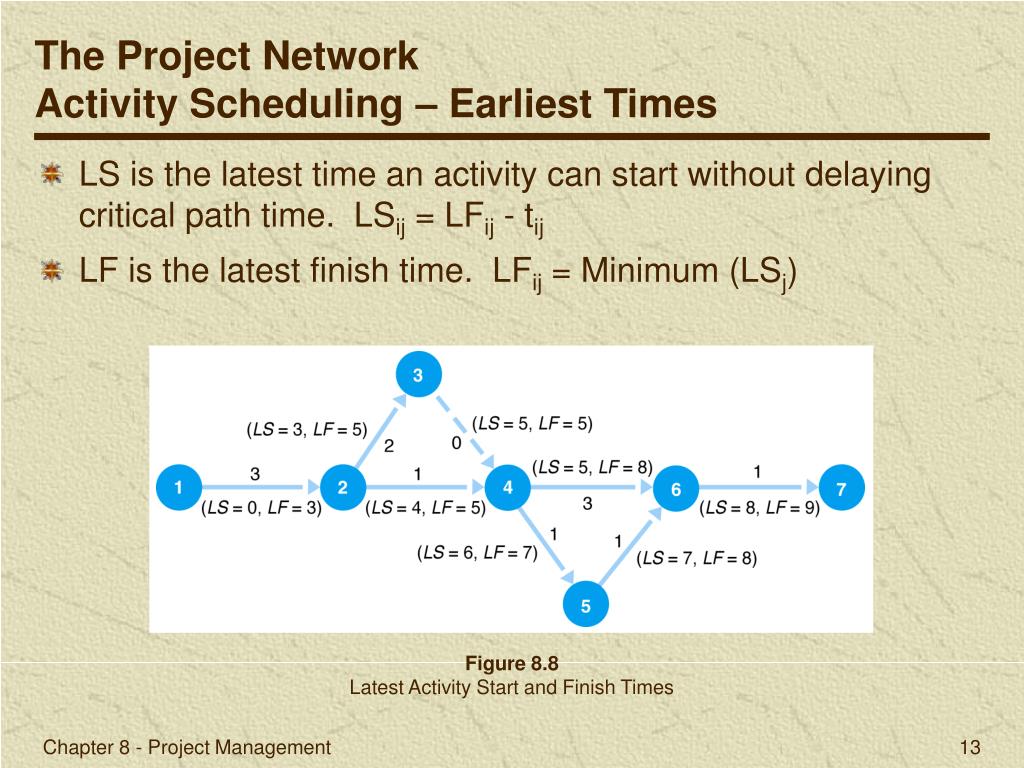

  13. The Project Network Activity Scheduling – Earliest Times • LS is the latest time an activity can start without delaying critical path time. LSij = LFij - tij • LF is the latest finish time. LFij = Minimum (LSj) Figure 8.8 Latest Activity Start and Finish Times Chapter 8 - Project Management

  14. The Project Network Activity Slack • Slack is the amount of time an activity can be delayed without delaying the project. • Slack Time exists for those activities not on the critical path for which the earliest and latest start times are not equal. • Shared Slack is slack available for a sequence of activities. Figure 8.9 Earliest and Latest Activity Start and Finish Times Chapter 8 - Project Management

  15. The Project Network Calculating Activity Slack Time (1 of 2) • Slack, Sij, computed as follows: Sij = LSij - ESij or Sij = LFij - EFij Figure 8.10 Activity Slack Chapter 8 - Project Management

  16. The Project Network Calculating Activity Slack Time (2 of 2) Table 8.2 Activity Slack Chapter 8 - Project Management

  17. Probabilistic Activity Times • Activity time estimates usually can not be made with certainty. • PERT used for probabilistic activity times. • In PERT, three time estimates are used: most likely time (m), the optimistic time (a) , and the pessimistic time (b). • These provide an estimate of the mean and variance of a beta distribution: • mean (expected time): • variance: Chapter 8 - Project Management

  18. Probabilistic Activity Times Example (1 of 3) Figure 8.11 Network for Installation Order Processing System Chapter 8 - Project Management

  19. Probabilistic Activity Times Example (2 of 3) Table 8.3 Activity Time Estimates for Figure 8.11 Chapter 8 - Project Management

  20. Probabilistic Activity Times Example (3 of 3) Figure 8.12 Network with Mean Activity Times and Variances Chapter 8 - Project Management

  21. Probabilistic Activity Times Earliest and Latest Activity Times and Slack Figure 8.13 Earliest and Latest Activity Times Chapter 8 - Project Management

  22. Probabilistic Activity Times Earliest and Latest Activity Times and Slack Table 8.4 Activity Earliest and Latest Times and Slack Chapter 8 - Project Management

  23. Probabilistic Activity Times Expected Project Time and Variance • The expected project time is the sum of the expected times of the critical path activities. • The project variance is the sum of the variances of the critical path activities. • The expected project time is assumed to be normally distributed (based on central limit theorem). • In example, expected project time (tp) and variance (vp) interpreted as the mean () and variance (2) of a normal distribution: • = 25 weeks • 2 = 6.9 weeks Chapter 8 - Project Management

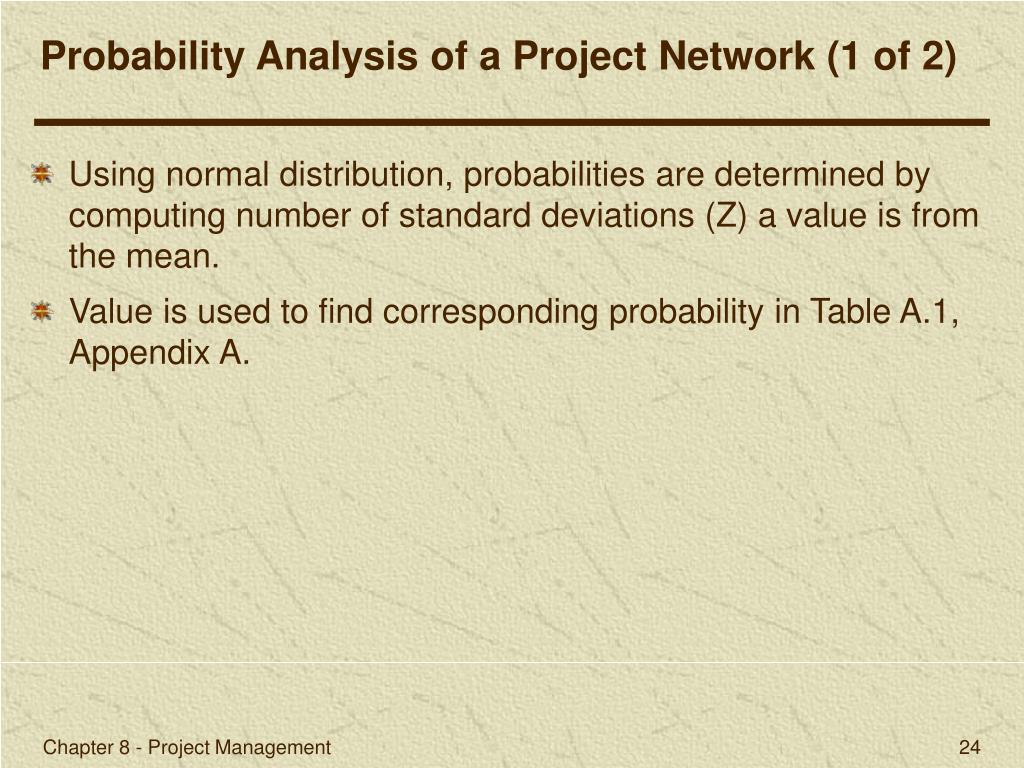

  24. Probability Analysis of a Project Network (1 of 2) • Using normal distribution, probabilities are determined by computing number of standard deviations (Z) a value is from the mean. • Value is used to find corresponding probability in Table A.1, Appendix A. Chapter 8 - Project Management

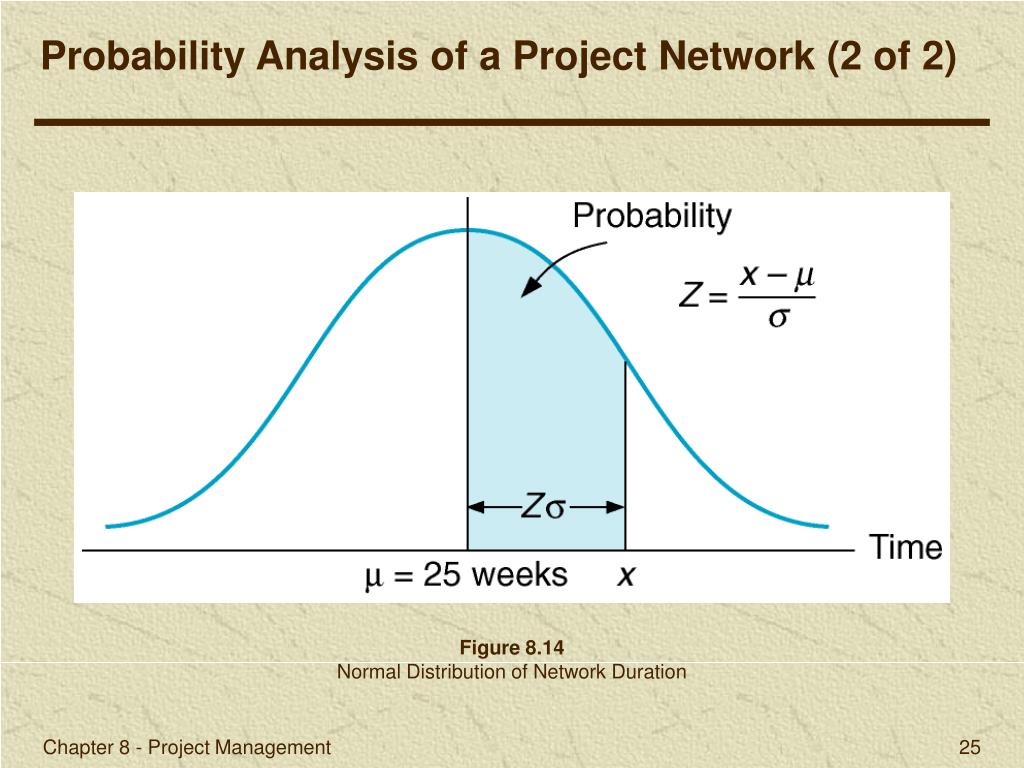

  25. Probability Analysis of a Project Network (2 of 2) Figure 8.14 Normal Distribution of Network Duration Chapter 8 - Project Management

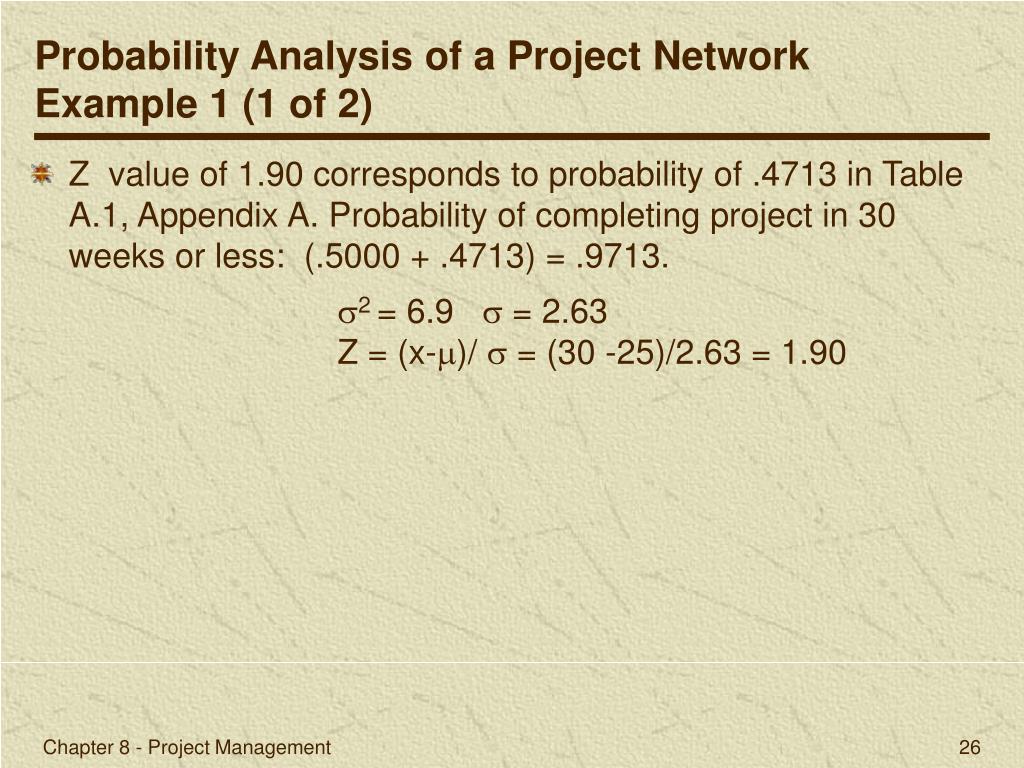

  26. Probability Analysis of a Project Network Example 1 (1 of 2) • Z value of 1.90 corresponds to probability of .4713 in Table A.1, Appendix A. Probability of completing project in 30 weeks or less: (.5000 + .4713) = .9713. • 2 = 6.9  = 2.63 • Z = (x-)/  = (30 -25)/2.63 = 1.90 Chapter 8 - Project Management

  27. Probability Analysis of a Project Network Example 1 (2 of 2) Figure 8.15 Probability the Network Will Be Completed in 30 Weeks or Less Chapter 8 - Project Management

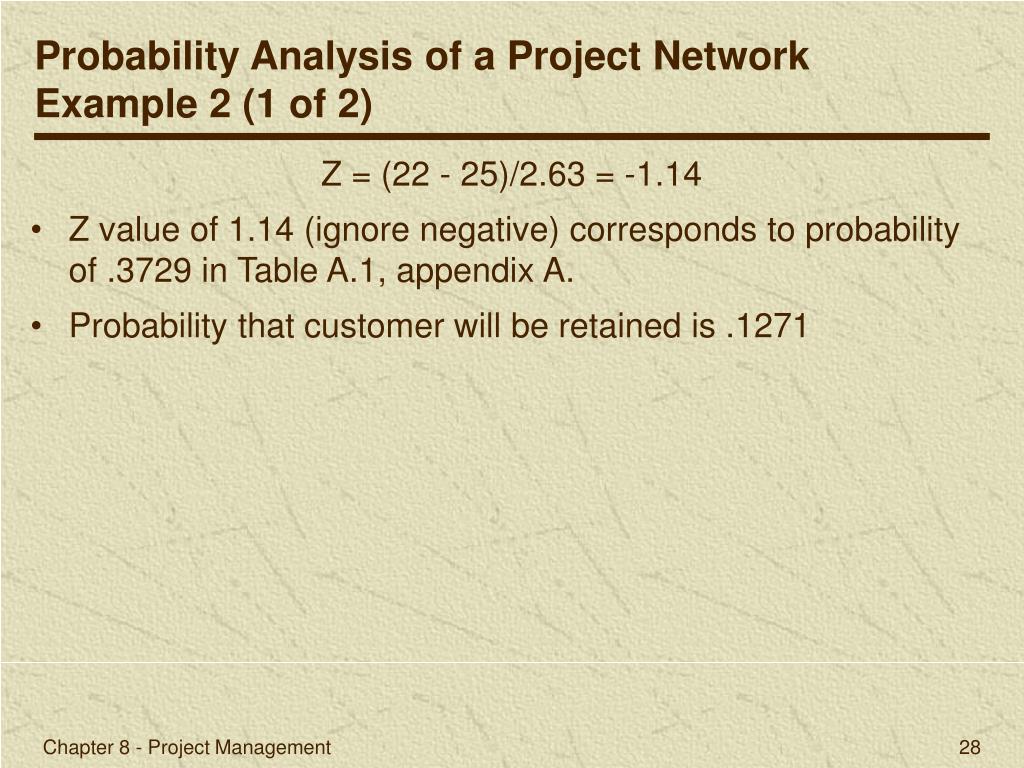

  28. Probability Analysis of a Project Network Example 2 (1 of 2) • Z = (22 - 25)/2.63 = -1.14 • Z value of 1.14 (ignore negative) corresponds to probability of .3729 in Table A.1, appendix A. • Probability that customer will be retained is .1271 Chapter 8 - Project Management

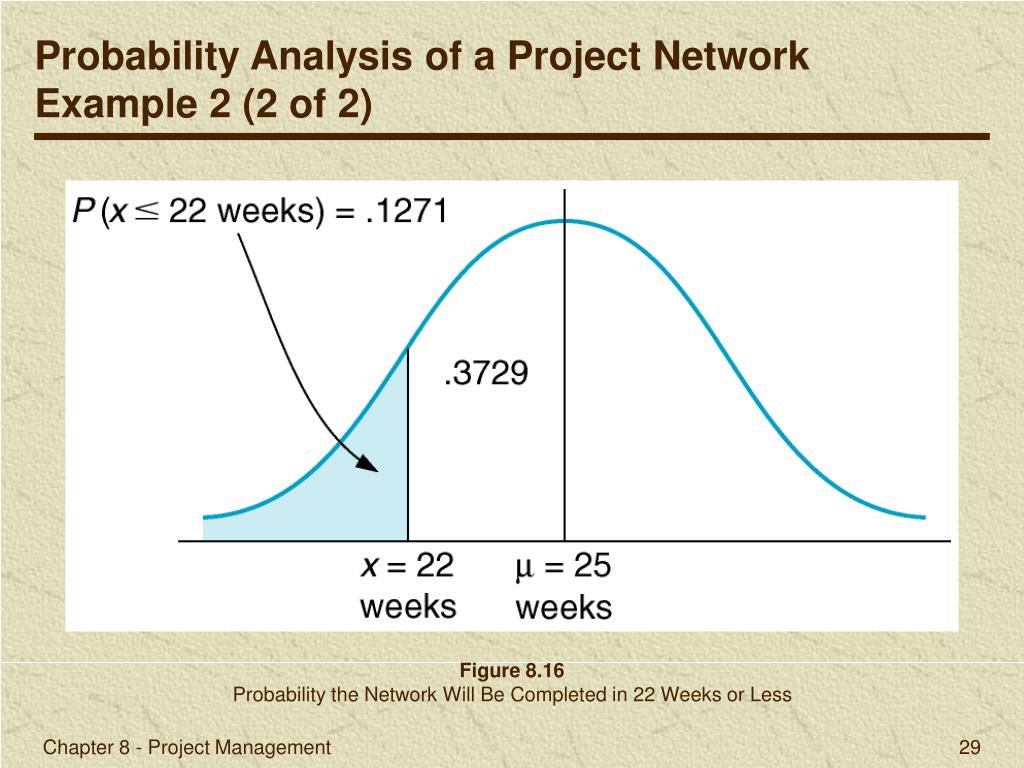

  29. Probability Analysis of a Project Network Example 2 (2 of 2) Figure 8.16 Probability the Network Will Be Completed in 22 Weeks or Less Chapter 8 - Project Management

  30. Probability Analysis of a Project Network CPM/PERT Analysis with QM for Windows Exhibit 8.1 Chapter 8 - Project Management

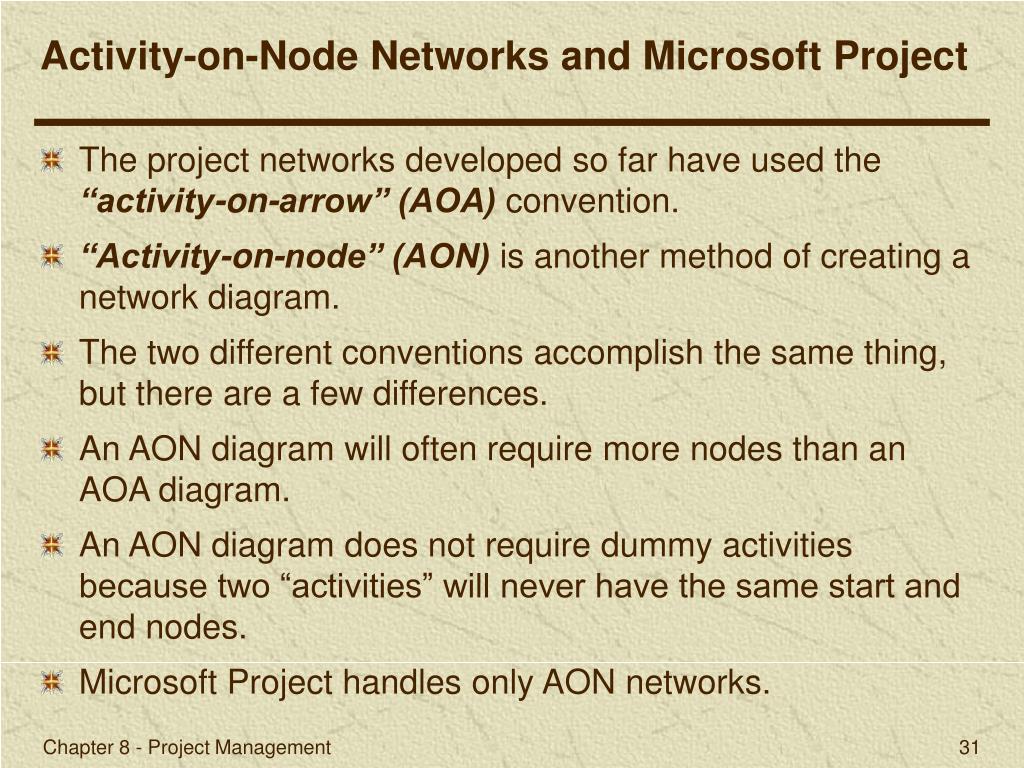

  31. Activity-on-Node Networks and Microsoft Project • The project networks developed so far have used the “activity-on-arrow” (AOA) convention. • “Activity-on-node” (AON) is another method of creating a network diagram. • The two different conventions accomplish the same thing, but there are a few differences. • An AON diagram will often require more nodes than an AOA diagram. • An AON diagram does not require dummy activities because two “activities” will never have the same start and end nodes. • Microsoft Project handles only AON networks. Chapter 8 - Project Management

  32. Activity-on-Node Networks and Microsoft Project Node Structure This node includes the activity number in the upper left-hand corner, the activity duration in the lower left-hand corner, and the earliest start and finish times, and latest start and finish times in the four boxes on the right side of the node. Figure 8.17 Activity-on-Node Configuration Chapter 8 - Project Management

  33. Activity-on-Node Networks and Microsoft Project AON Network Diagram Figure 8.18 House-Building Network with AON Chapter 8 - Project Management

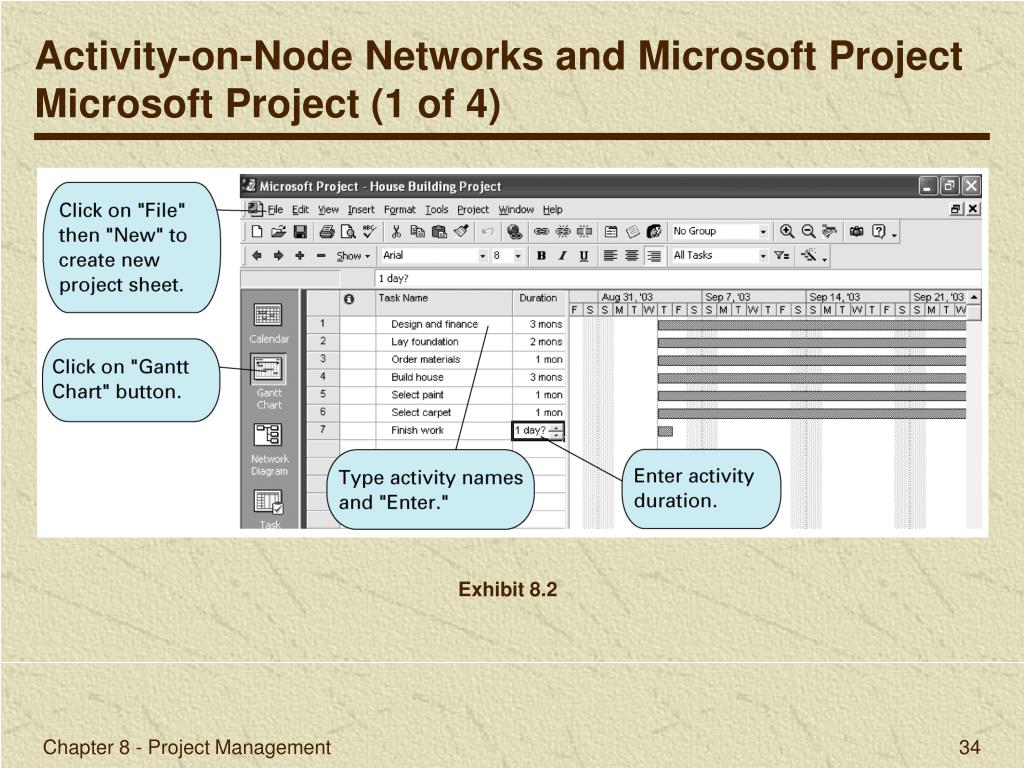

  34. Activity-on-Node Networks and Microsoft Project Microsoft Project (1 of 4) Exhibit 8.2 Chapter 8 - Project Management

  35. Activity-on-Node Networks and Microsoft Project Microsoft Project (2 of 4) Exhibit 8.3 Chapter 8 - Project Management

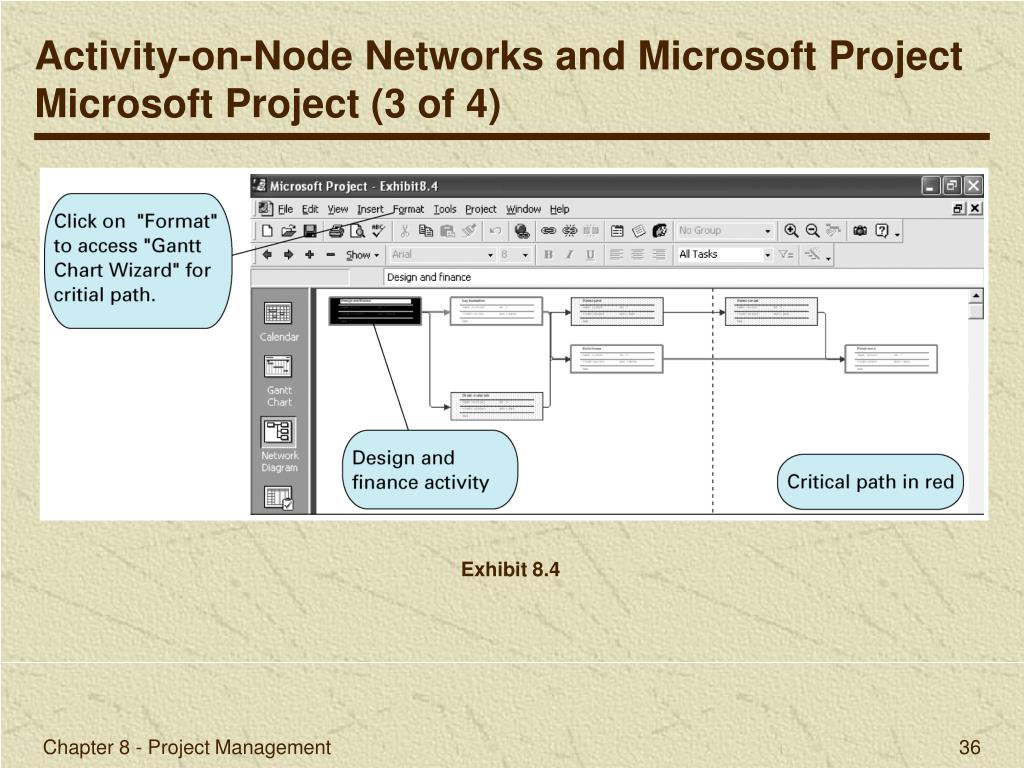

  36. Activity-on-Node Networks and Microsoft Project Microsoft Project (3 of 4) Exhibit 8.4 Chapter 8 - Project Management

  37. Activity-on-Node Networks and Microsoft Project Microsoft Project (4 of 4) Exhibit 8.5 Chapter 8 - Project Management

  38. Project Crashing and Time-Cost Trade-Off Definition • Project duration can be reduced by assigning more resources to project activities. • Doing this however increases project cost. • Decision is based on analysis of trade-off between time and cost. • Project crashing is a method for shortening project duration by reducing one or more critical activities to a time less than normal activity time. • Crashing achieved by devoting more resources to crashed activities. Chapter 8 - Project Management

  39. Project Crashing and Time-Cost Trade-Off Example Problem (1 of 5) Figure 8.19 Network for Constructing a House Chapter 8 - Project Management

  40. Project Crashing and Time-Cost Trade-Off Example Problem (2 of 5) Crash cost and crash time have linear relationship: total crash cost/total crash time = $2000/5 = $400/wk Figure 8.20 Time-Cost Relationship for Crashing Activity 12 Chapter 8 - Project Management

  41. Project Crashing and Time-Cost Trade-Off Example Problem (3 of 5) Table 8.5 Normal Activity and Crash Data for the Network in Figure 8.19 Chapter 8 - Project Management

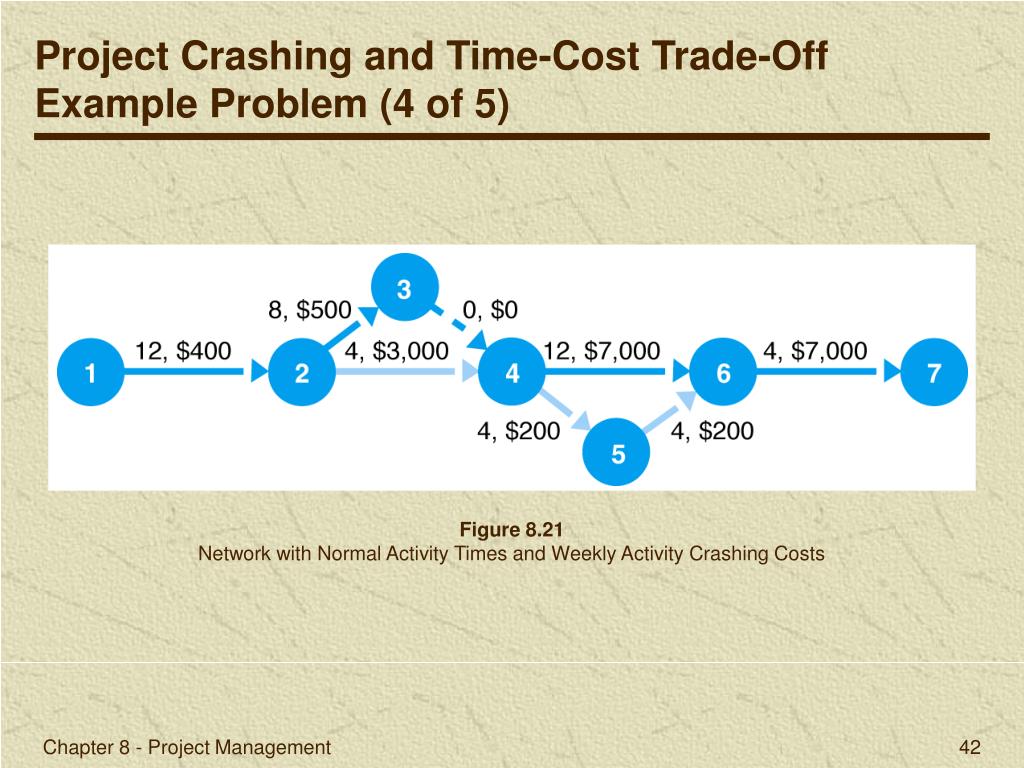

  42. Project Crashing and Time-Cost Trade-Off Example Problem (4 of 5) Figure 8.21 Network with Normal Activity Times and Weekly Activity Crashing Costs Chapter 8 - Project Management

  43. Project Crashing and Time-Cost Trade-Off Example Problem (5 of 5) • As activities are crashed, the critical path may change and several paths may become critical. Figure 8.22 Revised Network with Activity 12 Crashed Chapter 8 - Project Management

  44. Project Crashing and Time-Cost Trade-Off Project Crashing with QM for Windows Exhibit 8.6 Chapter 8 - Project Management

  45. Project Crashing and Time-Cost Trade-Off General Relationship of Time and Cost (1 of 2) • Project crashing costs and indirect costs have an inverse relationship. • Crashing costs are highest when the project is shortened. • Indirect costs increase as the project duration increases. • Optimal project time is at minimum point on the total cost curve. Chapter 8 - Project Management

  46. Project Crashing and Time-Cost Trade-Off General Relationship of Time and Cost (2 of 2) Figure 8.23 A Time-Cost Trade-Off Chapter 8 - Project Management

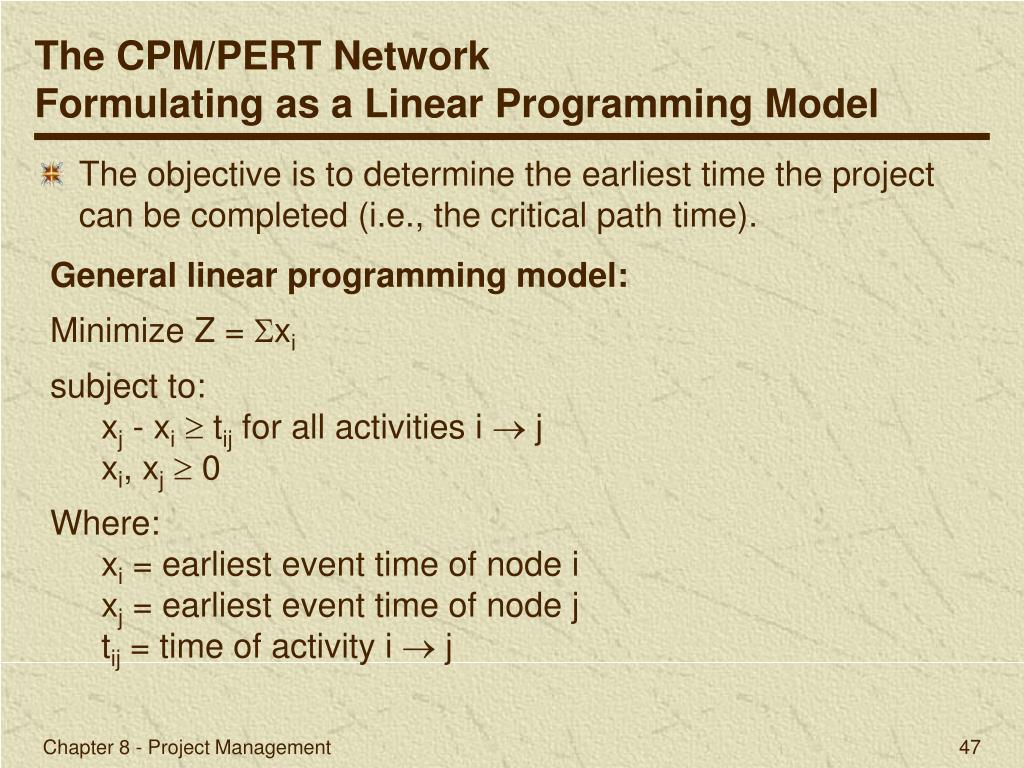

  47. The CPM/PERT Network Formulating as a Linear Programming Model • The objective is to determine the earliest time the project can be completed (i.e., the critical path time). General linear programming model: Minimize Z = xi subject to: xj - xi tij for all activities i  j xi, xj 0 Where: xi = earliest event time of node i xj = earliest event time of node j tij = time of activity i  j Chapter 8 - Project Management

  48. The CPM/PERT Network Example Problem Formulation and Data (1 of 2) Minimize Z = x1 + x2 + x3 + x4 + x5 + x6 + x7 subject to: x2 - x1 12 x3 - x2  8 x4 - x2  4 x4 - x3 0 x5 - x4 4 x6 - x4 12 x6 - x5  4 x7 - x6 4 xi, xj 0 Chapter 8 - Project Management

  49. The CPM/PERT Network Example Problem Formulation and Data (2 of 2) Figure 8.24 CPM/PERT Network for the House-Building Project with Earliest Event Times Chapter 8 - Project Management

  50. The CPM/PERT Network Example Problem Solution with Excel (1 of 4) Exhibit 8.7 Chapter 8 - Project Management
