An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Monitoring and Information Systems • Project monitoring defined • The plan-monitor-control cycle • Designing the monitoring system • Behavioral aspects of monitoring • Earned value analysis • Earned value examples

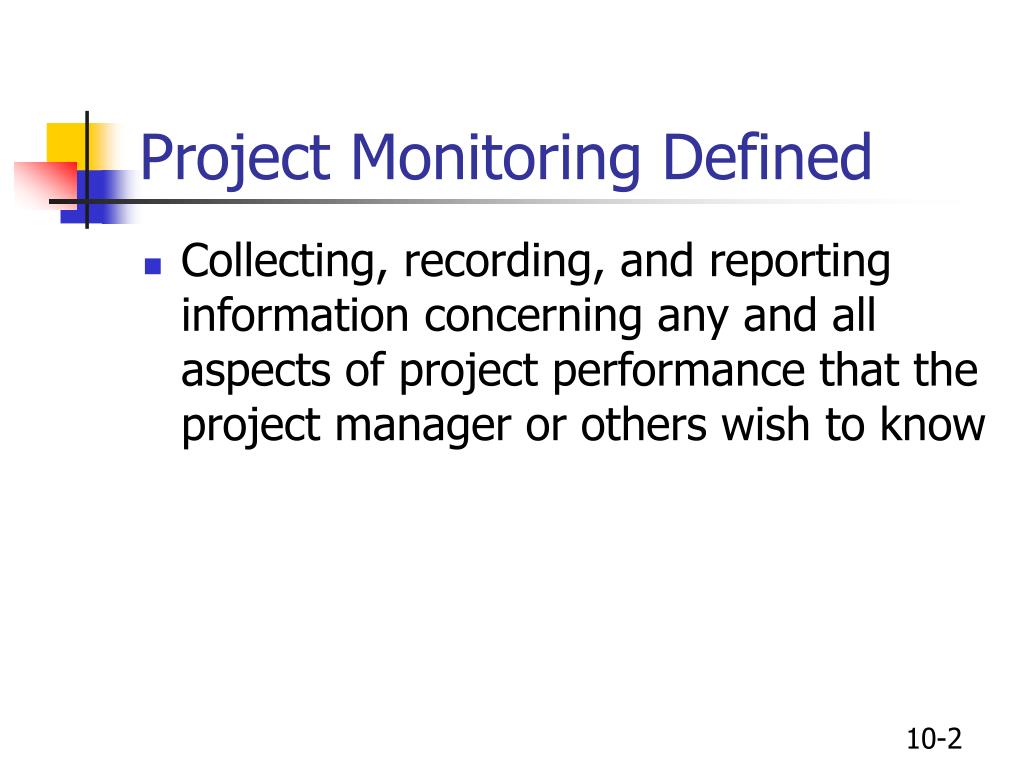

  2. Project Monitoring Defined • Collecting, recording, and reporting information concerning any and all aspects of project performance that the project manager or others wish to know

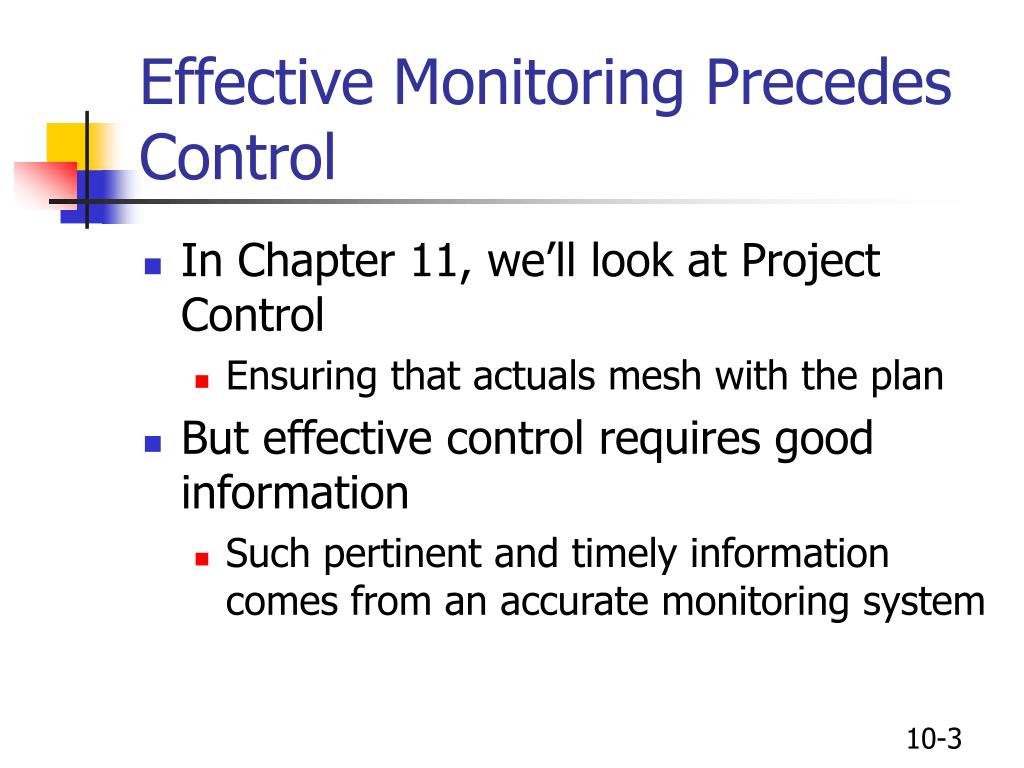

  3. Effective Monitoring Precedes Control • In Chapter 11, we’ll look at Project Control • Ensuring that actuals mesh with the plan • But effective control requires good information • Such pertinent and timely information comes from an accurate monitoring system

  4. Monitoring Has Several Uses • The primary use is projectcontrol • Ensuring that decision-makers have timely information enabling effective control over the project • Project Monitoring has secondary uses • Project auditing • “Lessons learned” • Reporting to client and senior management

  5. The Planning-Monitoring-Controlling Cycle • Effective monitoring and control begins with good project planning • What are the critical areas? • How and when can progress be measured? • Who gathers and reports info, to whom? • The plan-monitor-control cycle continues through the entire project

  6. Project Control Information Flow, Figure 10-1

  7. Designing the Monitoring System • 1. Start with the key factors to be controlled • Pareto analysis: a relatively few activities determine most of the project’s success • Use the project plan to identify items to be monitored • Although other areas might be added also

  8. Designing the Monitoring System (cont’d) • 2. Develop measurement systems • Measure results, not activity; outputs, rather than inputs • Extract performance, time and cost goals from project plans • Avoid tendency to focus on that which is easily measurable

  9. Designing the Monitoring System (cont’d) • 3. Collecting Data: Most data falls into one of five categories, as follows (with examples) • Frequency counts: tally of occurrences . . . • Raw numbers: dates, dollars, percents, specs . . . • Subjective ratings: numerical ranking, red-yellow-green assessments . . . • Indicators: surrogate measures of merit . . . • Verbal measurement: oral or written characterizations . . .

  10. Designing the Monitoring System (cont’d) • 4. Reporting on Data Collected: To turn data into information, it must be contextualized: • Reporting must be timely • Data must be analyzed • Trends: Getting better or worse? • Comparables: Performance compared to specs, past performance, standard hours, etc. • Statistical analysis • Causation and correction

  11. Reporting and Information Flows, Figure 10-5

  12. Some Behavioral Aspects of Monitoring Systems • Effective monitoring reduces surprises, and this can increase trust, morale • Some reporting bias is inevitable, but dishonesty is unacceptable • “Shooting the messenger” today just creates concealment tomorrow

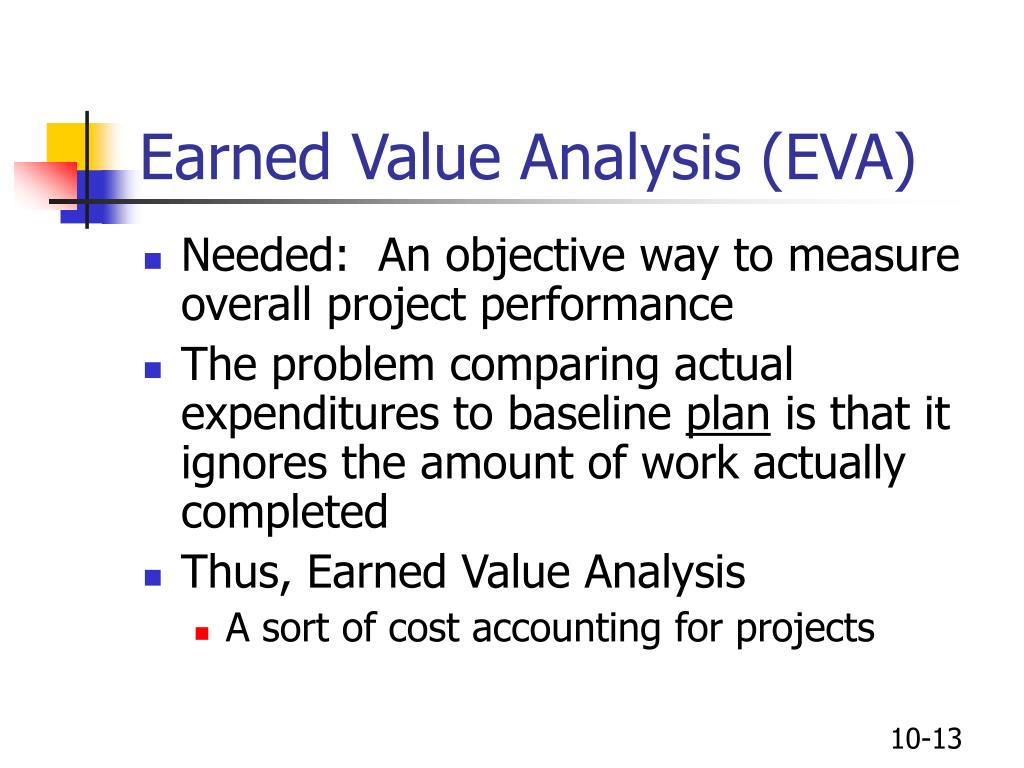

  13. Earned Value Analysis (EVA) • Needed: An objective way to measure overall project performance • The problem comparing actual expenditures to baseline plan is that it ignores the amount of work actually completed • Thus, Earned Value Analysis • A sort of cost accounting for projects

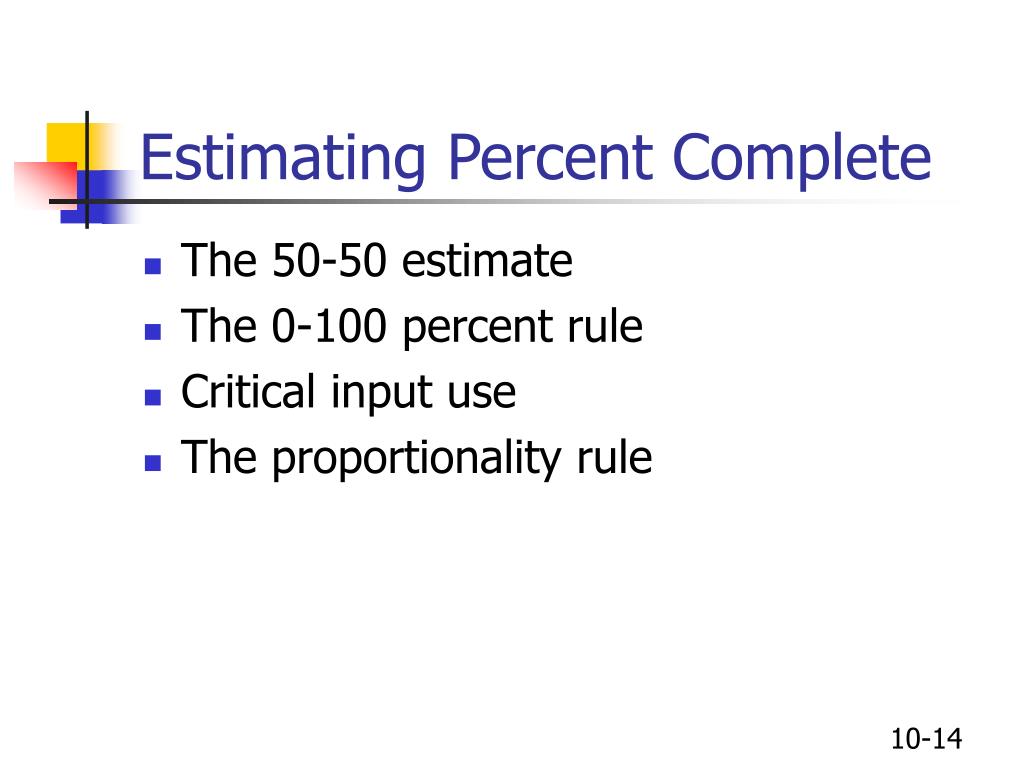

  14. Estimating Percent Complete • The 50-50 estimate • The 0-100 percent rule • Critical input use • The proportionality rule

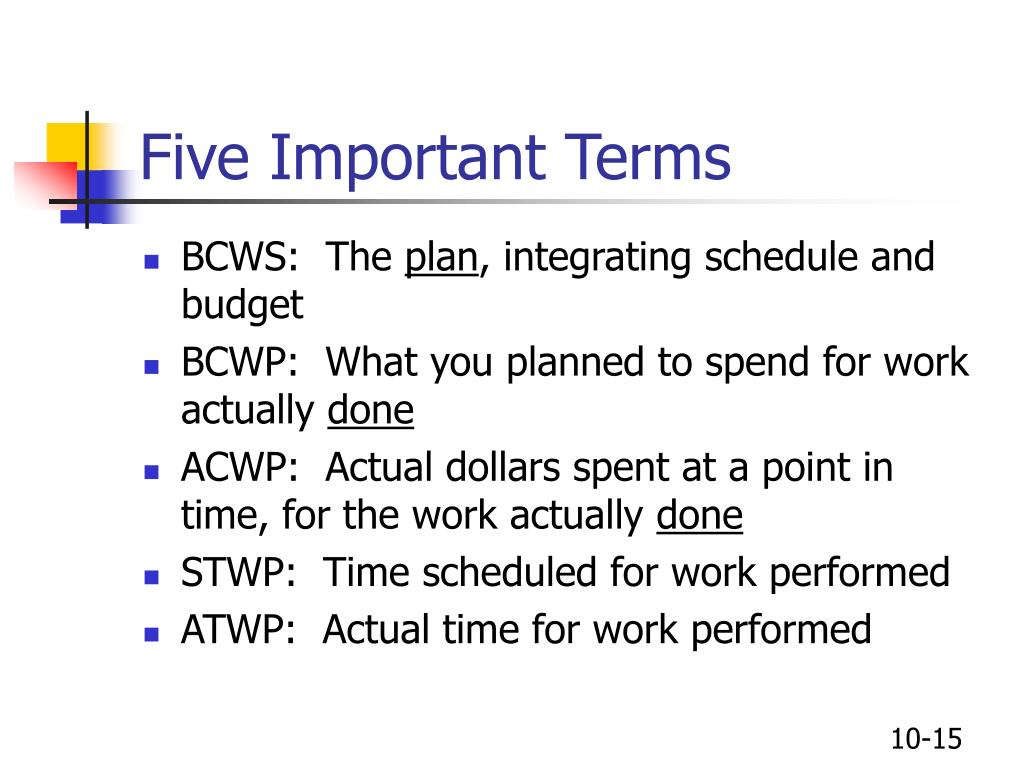

  15. Five Important Terms • BCWS: The plan, integrating schedule and budget • BCWP: What you planned to spend for work actually done • ACWP: Actual dollars spent at a point in time, for the work actually done • STWP: Time scheduled for work performed • ATWP: Actual time for work performed

  16. More Terms • BAC: Budget at completion • EAC: Estimated cost at completion • ETC: Estimated cost to complete

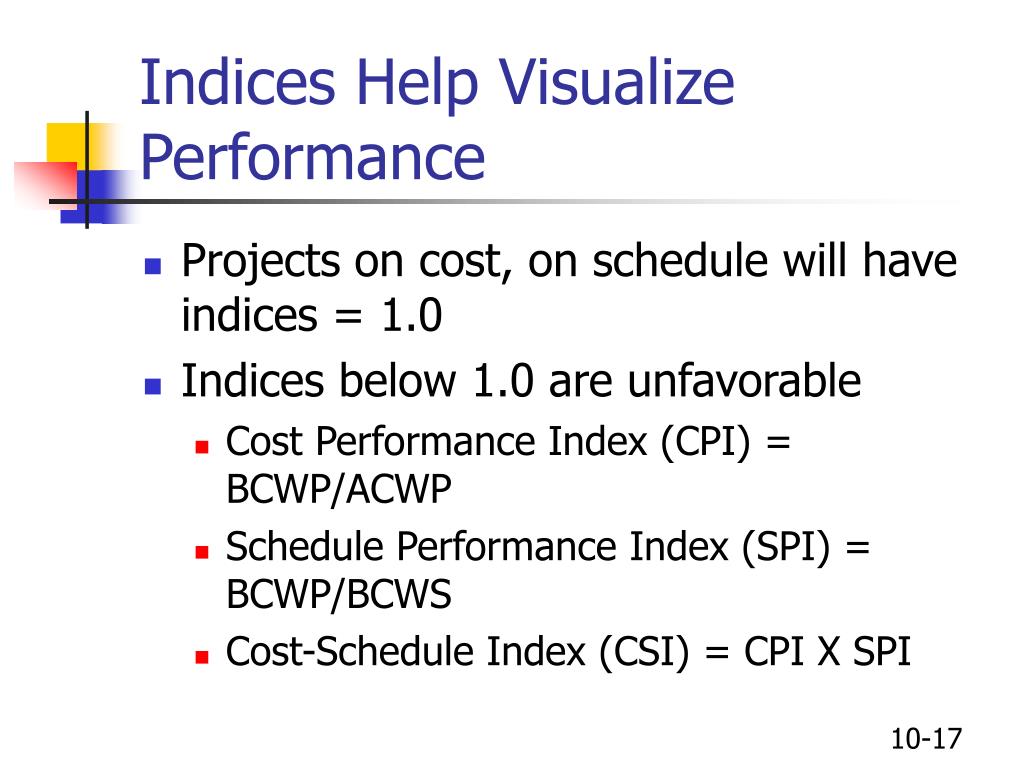

  17. Indices Help Visualize Performance • Projects on cost, on schedule will have indices = 1.0 • Indices below 1.0 are unfavorable • Cost Performance Index (CPI) = BCWP/ACWP • Schedule Performance Index (SPI) = BCWP/BCWS • Cost-Schedule Index (CSI) = CPI X SPI

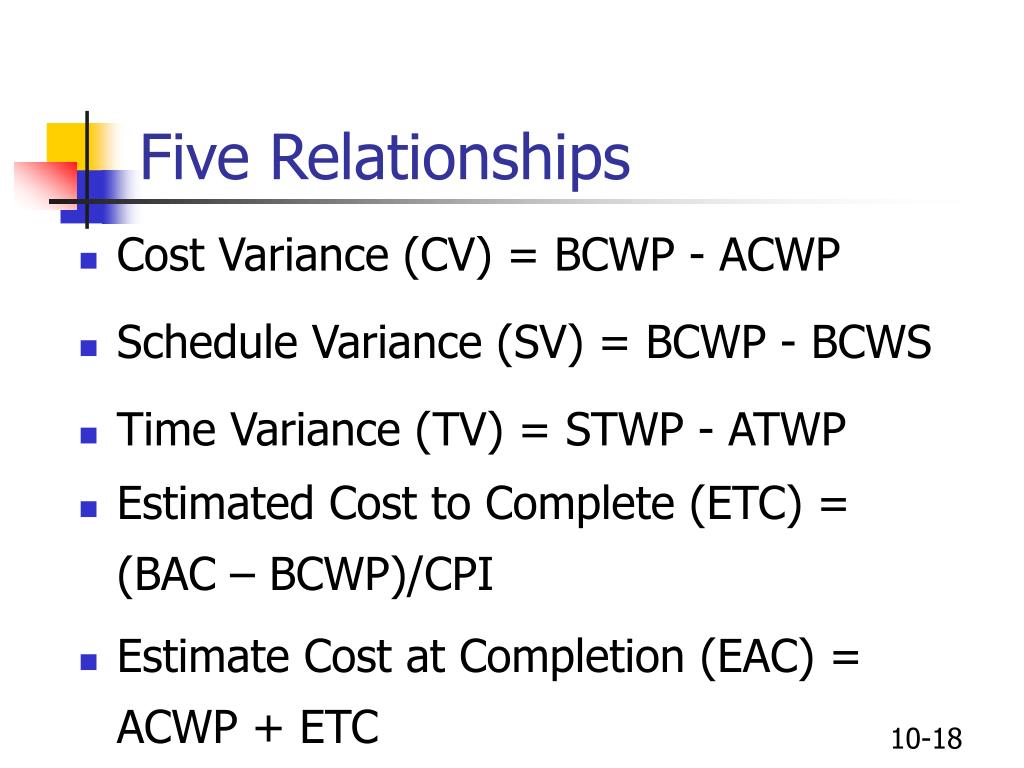

  18. Five Relationships • Cost Variance (CV) = BCWP - ACWP • Schedule Variance (SV) = BCWP - BCWS • Time Variance (TV) = STWP - ATWP • Estimated Cost to Complete (ETC) =(BAC – BCWP)/CPI • Estimate Cost at Completion (EAC) = ACWP + ETC

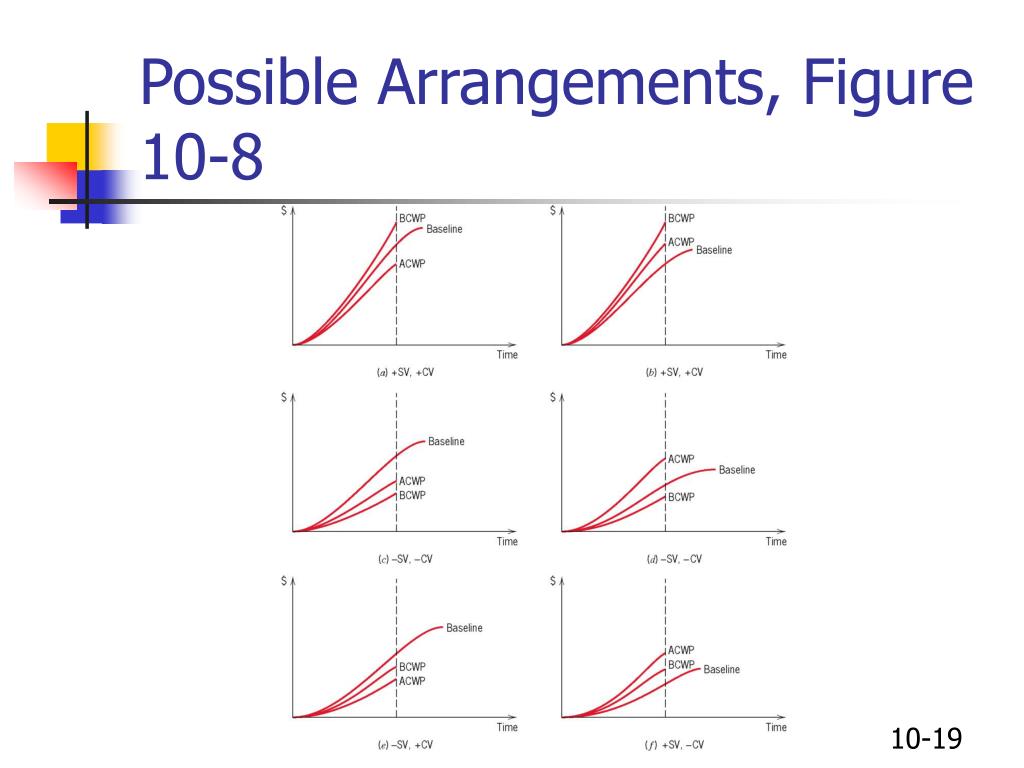

  19. Possible Arrangements, Figure 10-8

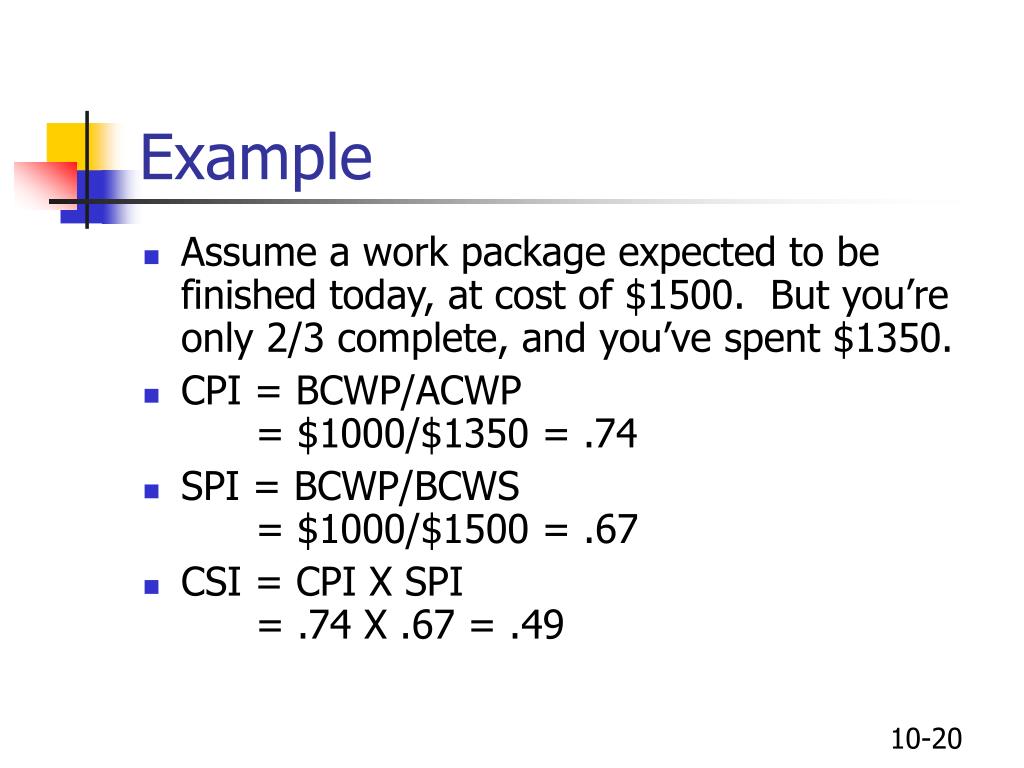

  20. Example • Assume a work package expected to be finished today, at cost of $1500. But you’re only 2/3 complete, and you’ve spent $1350. • CPI = BCWP/ACWP = $1000/$1350 = .74 • SPI = BCWP/BCWS = $1000/$1500 = .67 • CSI = CPI X SPI = .74 X .67 = .49

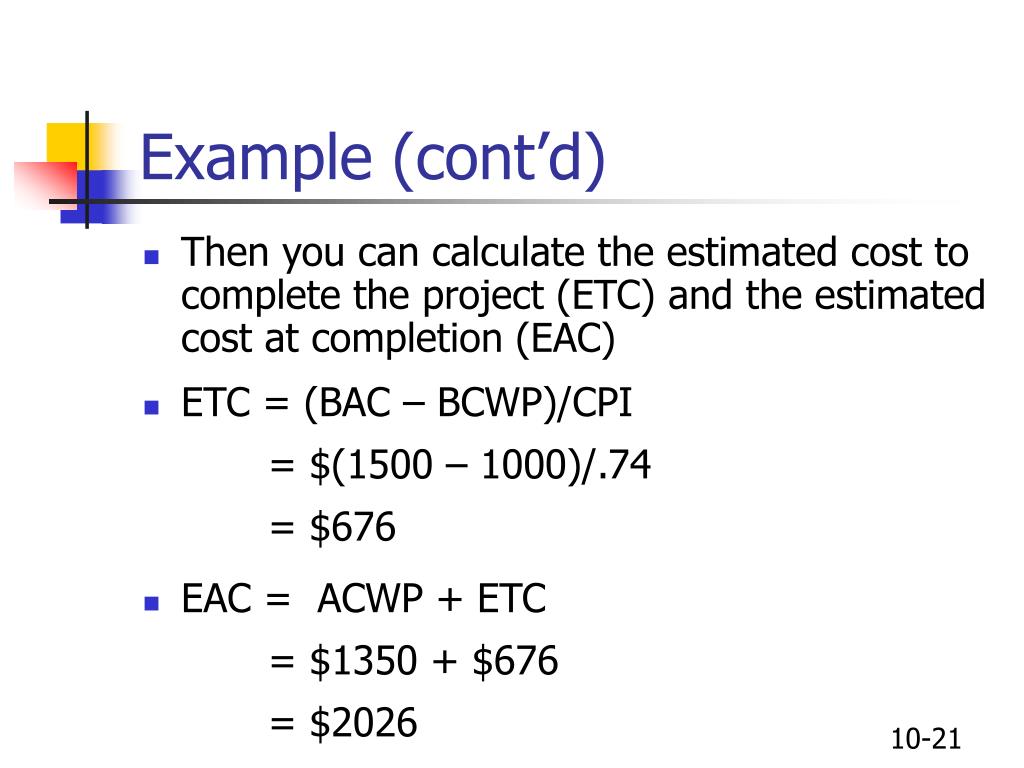

  21. Example (cont’d) • Then you can calculate the estimated cost to complete the project (ETC) and the estimated cost at completion (EAC) • ETC = (BAC – BCWP)/CPI = $(1500 – 1000)/.74 = $676 • EAC = ACWP + ETC = $1350 + $676 = $2026

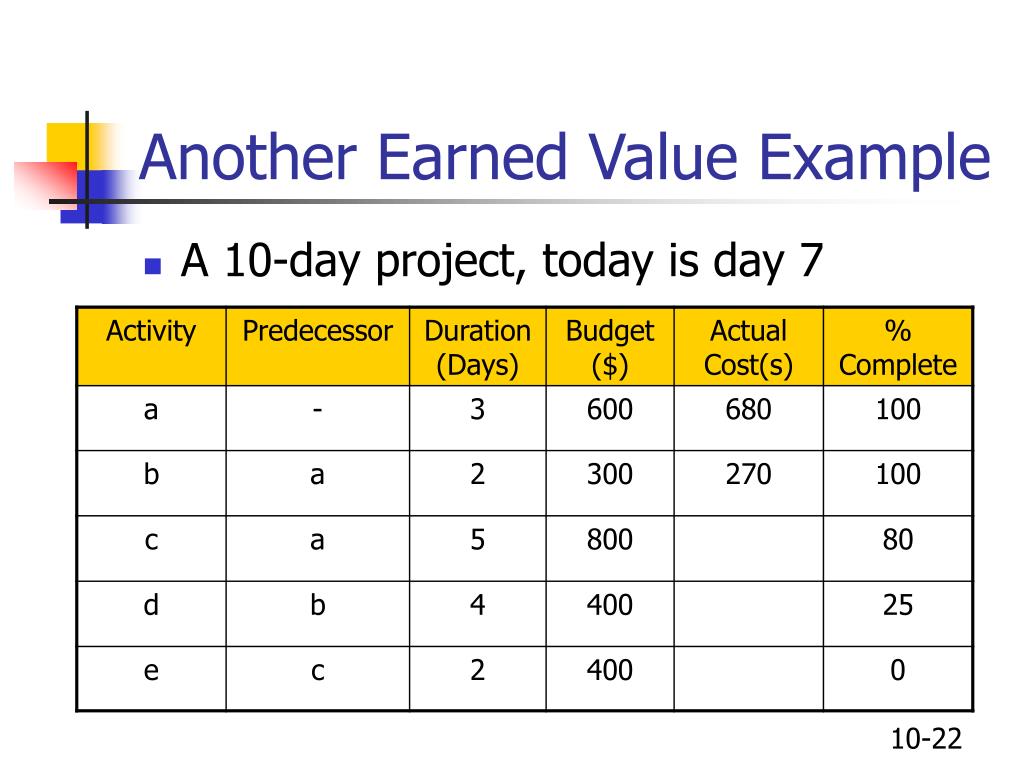

  22. Another Earned Value Example • A 10-day project, today is day 7

  23. PERT AON Diagram, Figure 10-9

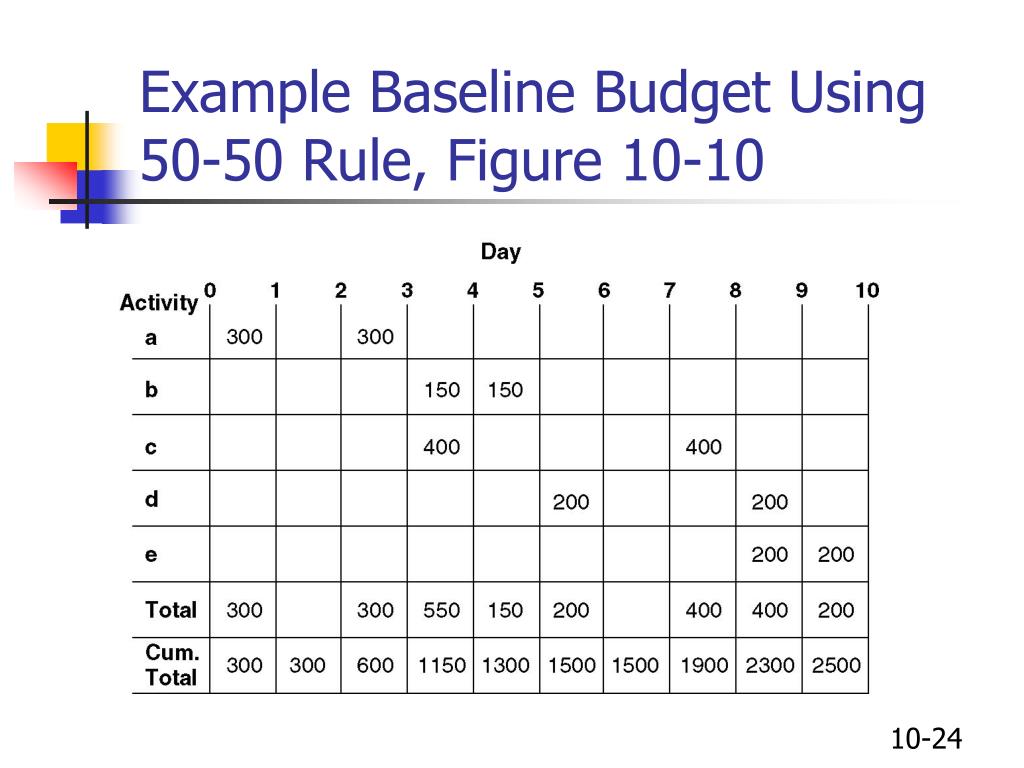

  24. Example Baseline Budget Using 50-50 Rule, Figure 10-10

  25. Example Status at Day 7, Figure 10-11

  26. Example Earned Value Chart Day 7, Figure 10-12

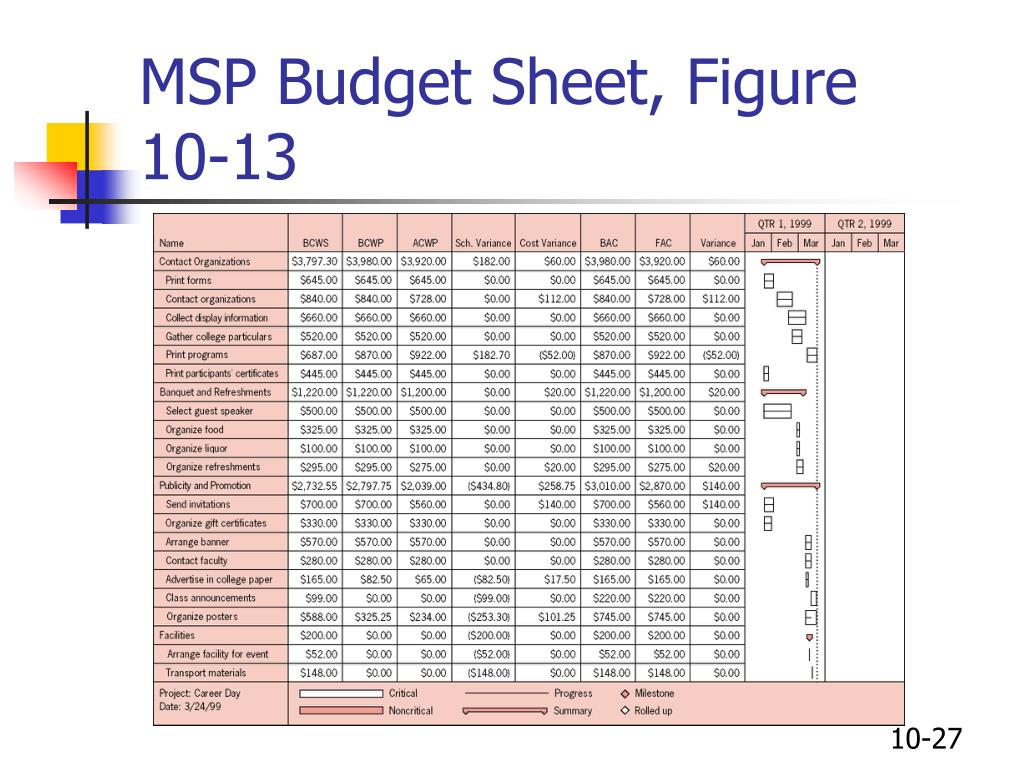

  27. MSP Budget Sheet, Figure10-13

  28. Case: Earned Value at Texas Instruments

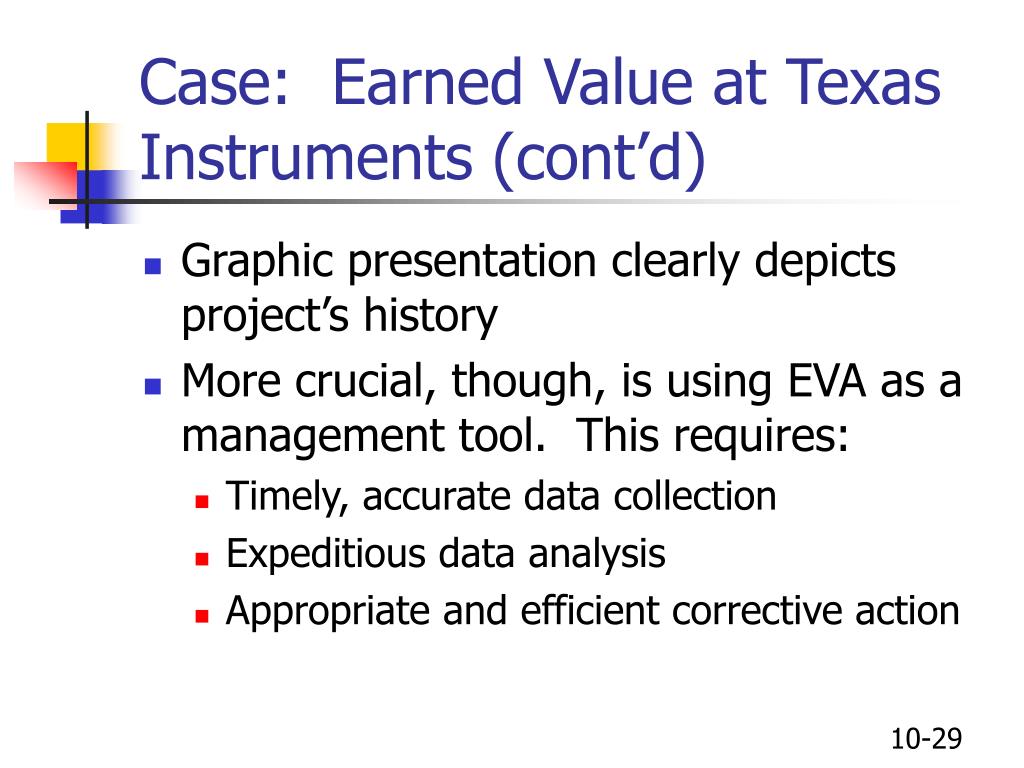

  29. Case: Earned Value at Texas Instruments (cont’d) • Graphic presentation clearly depicts project’s history • More crucial, though, is using EVA as a management tool. This requires: • Timely, accurate data collection • Expeditious data analysis • Appropriate and efficient corrective action
