Project Management An Introduction to Terry Winnington
Lecture Aims • What are Projects and how do you manage them • To Give an Insight into “Good Practice” • Introduce some Project Management tools
A Working Definition ofA PROJECT A temporary endeavour undertaken to create a unique product or service that has: Specific objectives to be completed within a certain specification Defined start & end dates Funding limits and consumes resources
YOUR TIME MODULE DEADLINE ASSIGNMENT BRIEF FOR A STUDENT PROJECT
Needs Tidying Up At The End Gets Very Busy Starts Slow Typical Project Life Cyclee.g. A Good Student Project

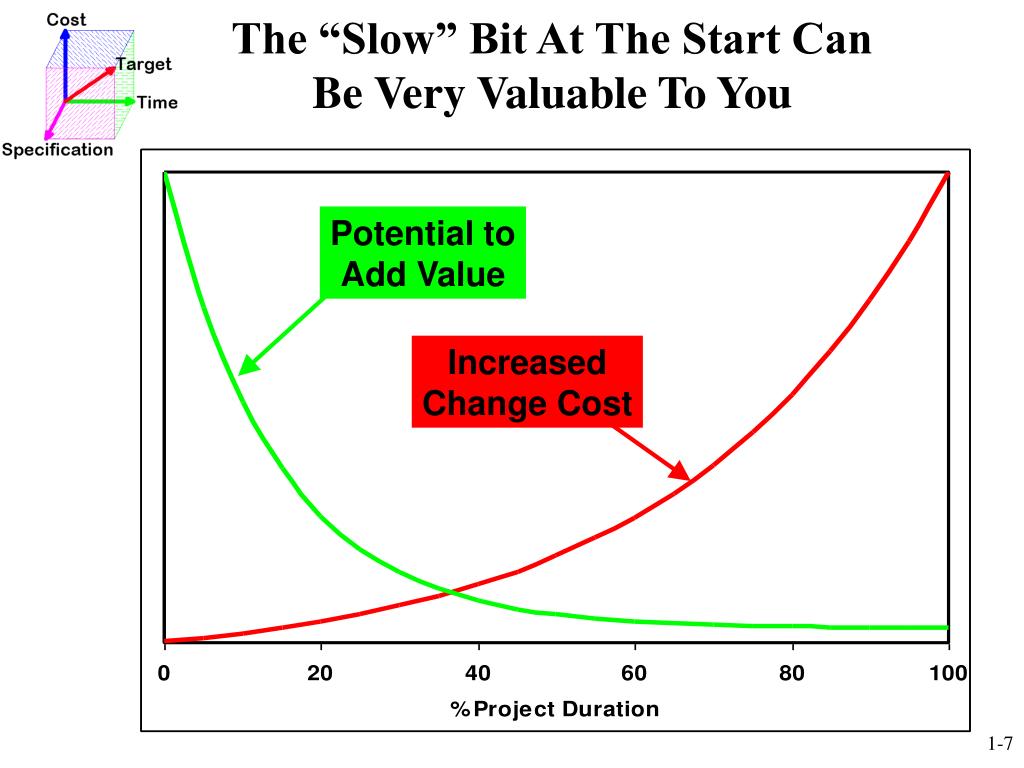

The “Slow” Bit At The Start CanBe Very Valuable To You Potential to Add Value Increased Change Cost
SOME GUIDLINES • Start Promptly – NOW!! • Your Project Definition Should Be Well Founded And Agreed • Any Changes To The Project Definition And Your Objectives Need To Be Made In the Early Stages Of The Project • Identify Individual Tasks • Established The Sequence Of They Need to be Undertaken • Determine The Risks And Accommodate Them In Your Plan • Recognise That Changes In Any One Element Will Affect Some Or All The Other Activities - Don’t Underestimate The Trivial

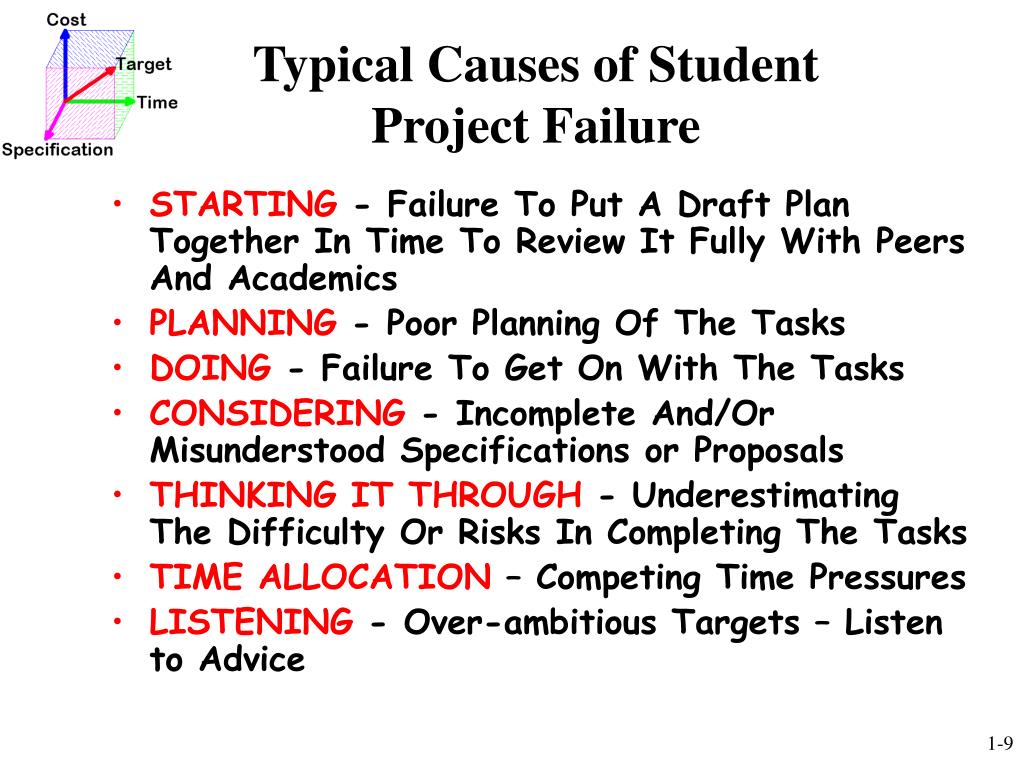

Typical Causes of StudentProject Failure • STARTING - Failure To Put A Draft Plan Together In Time To Review It Fully With Peers And Academics • PLANNING - Poor Planning Of The Tasks • DOING - Failure To Get On With The Tasks • CONSIDERING - Incomplete And/Or Misunderstood Specifications or Proposals • THINKING IT THROUGH - Underestimating The Difficulty Or Risks In Completing The Tasks • TIME ALLOCATION – Competing Time Pressures • LISTENING - Over-ambitious Targets – Listen to Advice

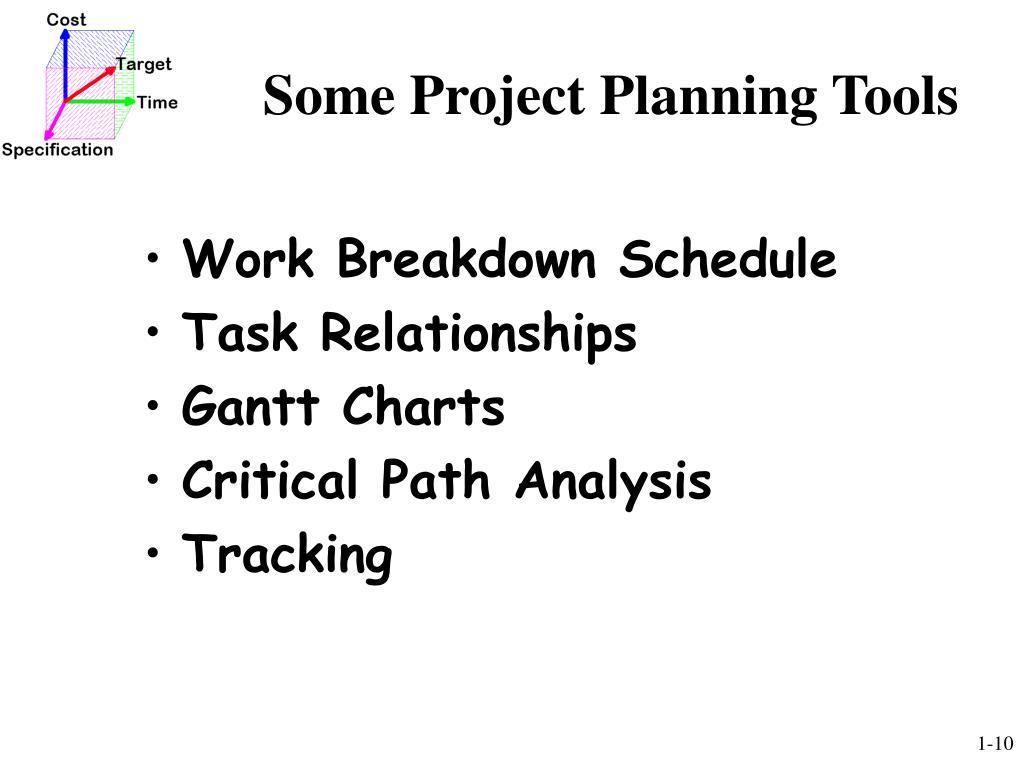

Some Project Planning Tools • Work Breakdown Schedule • Task Relationships • Gantt Charts • Critical Path Analysis • Tracking
Breaking Tasks Into Bite Sized ChunksWork Breakdown Structure • Humans Find It Difficult To Analyse, Plan And Execute Large, Complex Tasks • Complex Tasks Take A Long Time To Complete • Deadlines That Are A Long Way Away Tend Not To Trigger Immediate Action • It’s Difficult To Know Where To Start • It’s Difficult To Know How Much More You Have Got To Do • Answer >> Break It Down To “Bite Size” Chunks You Can Deal With

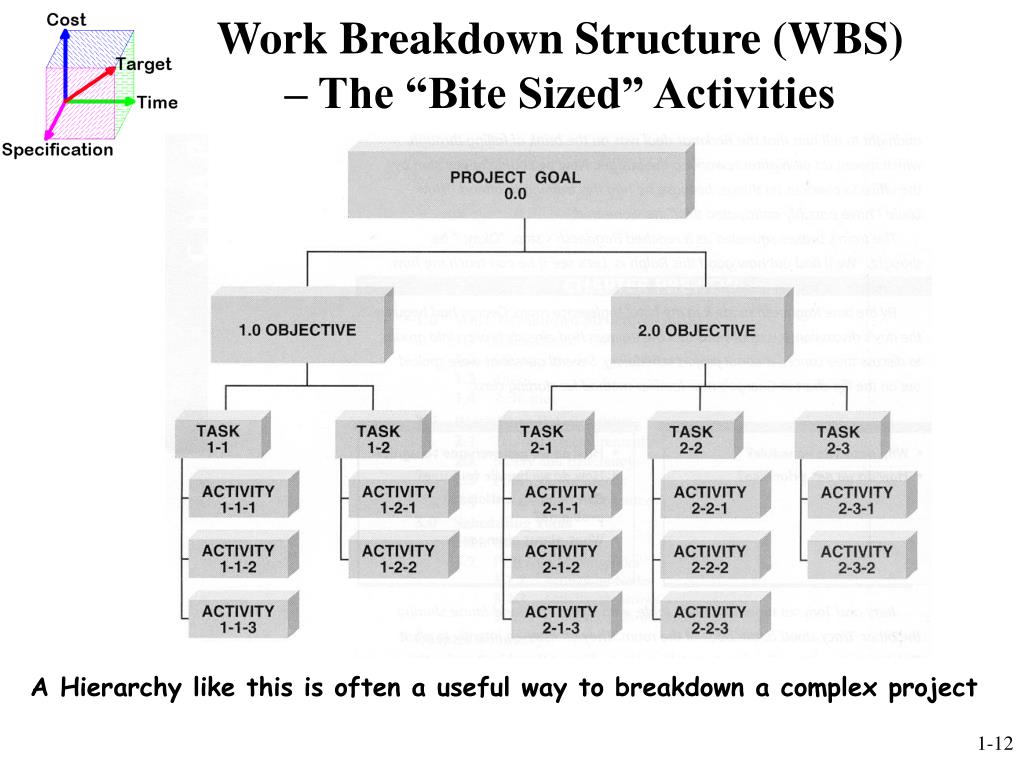

Work Breakdown Structure (WBS)– The “Bite Sized” Activities A Hierarchy like this is often a useful way to breakdown a complex project
Task Sizing • Work out how long you think each task will take • If you are unsure think about the shortest time they are likely to take and then the longest (optimistic and pessimistic estimates) • Having done that re-estimate the most likely length of time • If it is absolutely critical – perhaps use the pessimistic time • What about iterations? – two or more development stages

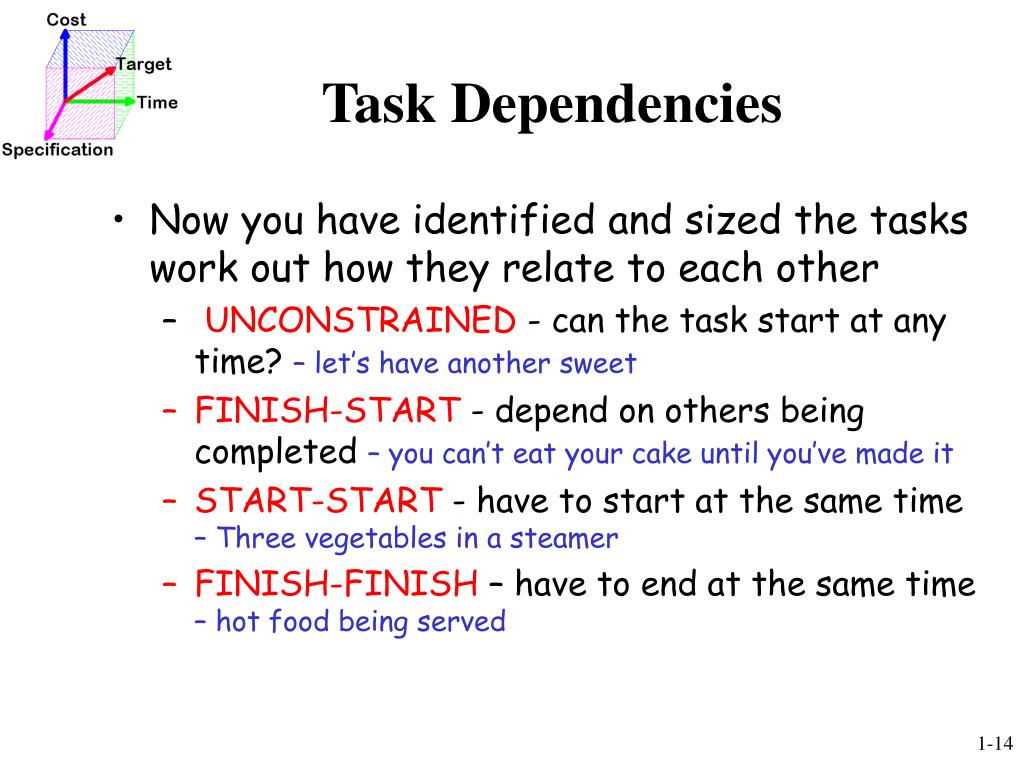

Task Dependencies • Now you have identified and sized the tasks work out how they relate to each other • UNCONSTRAINED - can the task start at any time? – let’s have another sweet • FINISH-START - depend on others being completed – you can’t eat your cake until you’ve made it • START-START -have to start at the same time – Three vegetables in a steamer • FINISH-FINISH – have to end at the same time – hot food being served
Task Planning • The dependencies will force some tasks into sequences • If you make a network of the tasks you will start to see how long the project will take • But don’t forget that you only have a limited resource available • This limits the number of tasks you can do at the same time • You also need to think how many hours you are prepared to work a week!!

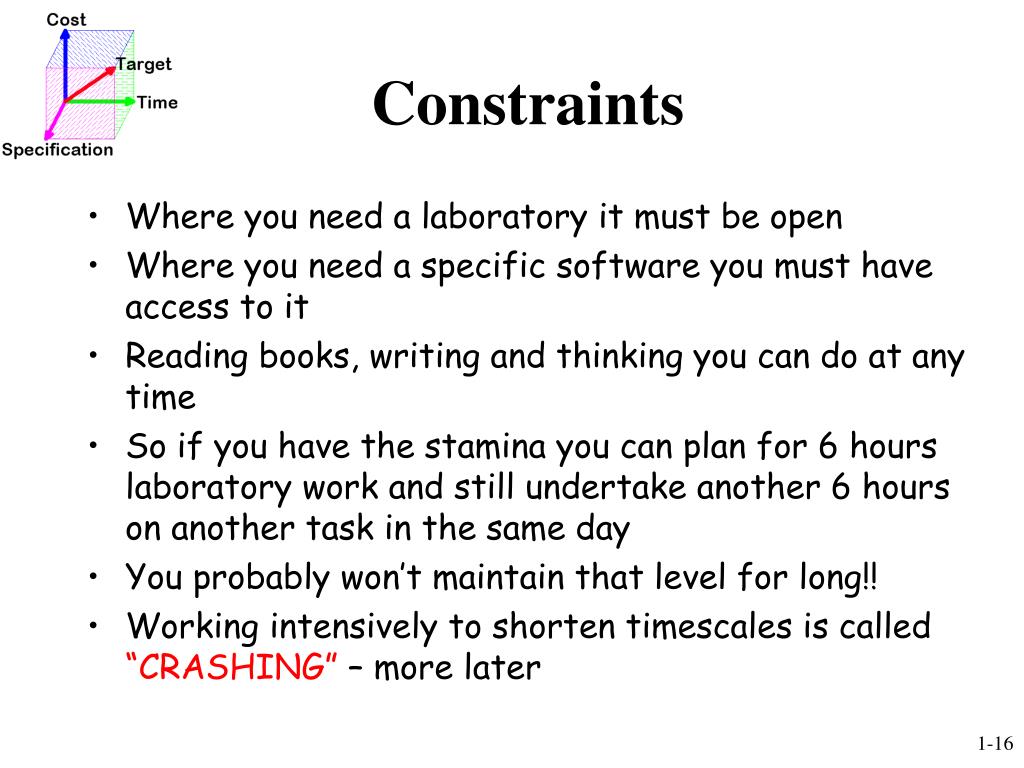

Constraints • Where you need a laboratory it must be open • Where you need a specific software you must have access to it • Reading books, writing and thinking you can do at any time • So if you have the stamina you can plan for 6 hours laboratory work and still undertake another 6 hours on another task in the same day • You probably won’t maintain that level for long!! • Working intensively to shorten timescales is called “CRASHING” – more later

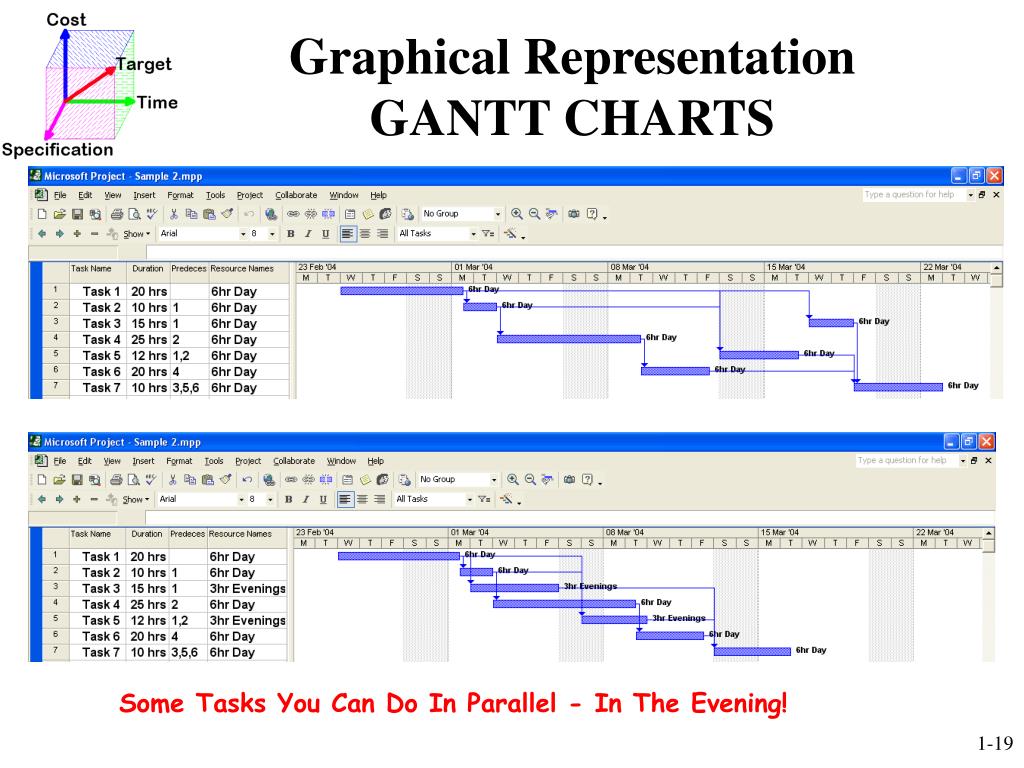

Task 1 – 20hrs Task 2 – 10hrs - FS 1 Task 3 – 15hrs – FS 1 Task 4 – 25hrs – FS 2 Task 5 – 12hrs – FS 1,2 Task 6 – 20 hrs – FS 4,2 Task 7 – 10 hrs – FS 3,5,6 Graphical RepresentationsNETWORK CHARTS The Red Tasks Are On The CRITICAL PATH A Delay In These Delays Completion
Graphical RepresentationGANTT CHARTS MICROSOFT PROJECT IN ROOMS 4E16, 3E39 AND 3Q69 Note – Parallel Tasks – May Be Difficult to Achieve! However If You Can Only Work on One Task at a Time!
Graphical RepresentationGANTT CHARTS Some Tasks You Can Do In Parallel - In The Evening!

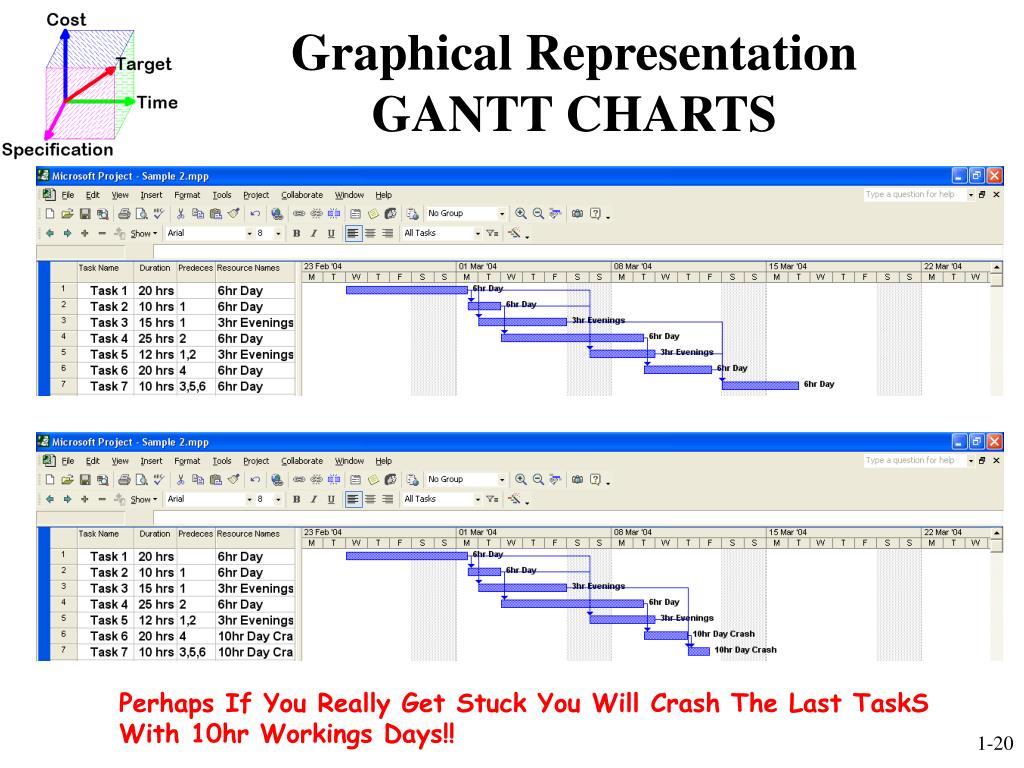

Graphical RepresentationGANTT CHARTS Perhaps If You Really Get Stuck You Will Crash The Last TaskS With 10hr Workings Days!!

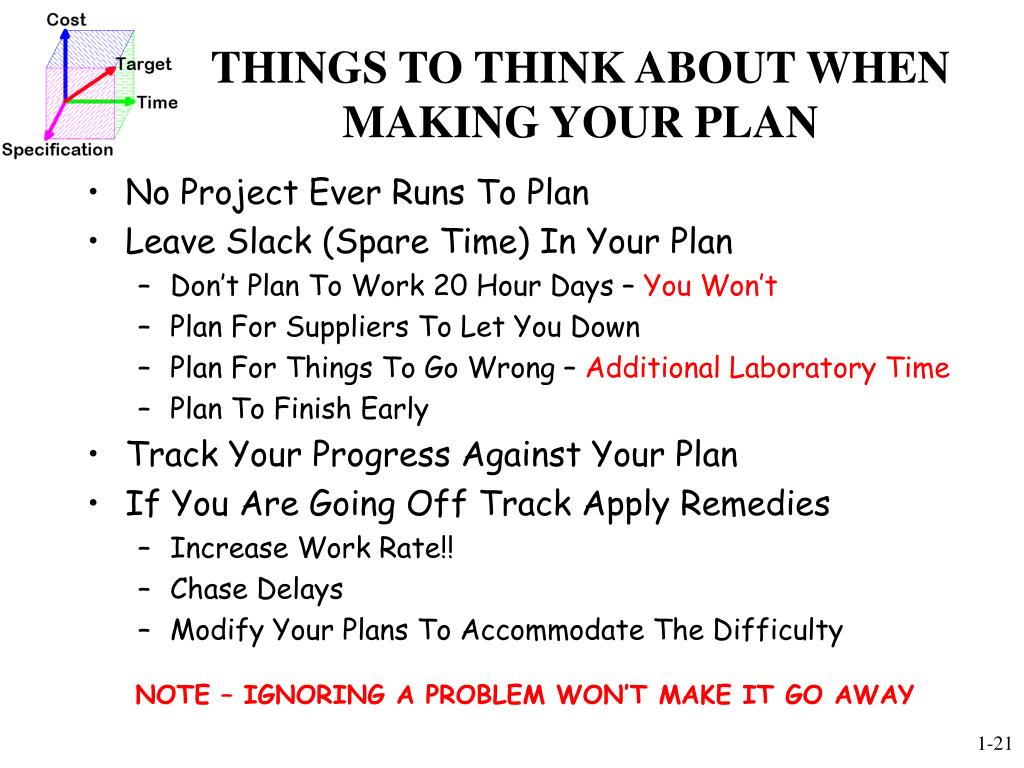

THINGS TO THINK ABOUT WHEN MAKING YOUR PLAN • No Project Ever Runs To Plan • Leave Slack (Spare Time) In Your Plan • Don’t Plan To Work 20 Hour Days – You Won’t • Plan For Suppliers To Let You Down • Plan For Things To Go Wrong – Additional Laboratory Time • Plan To Finish Early • Track Your Progress Against Your Plan • If You Are Going Off Track Apply Remedies • Increase Work Rate!! • Chase Delays • Modify Your Plans To Accommodate The Difficulty NOTE – IGNORING A PROBLEM WON’T MAKE IT GO AWAY

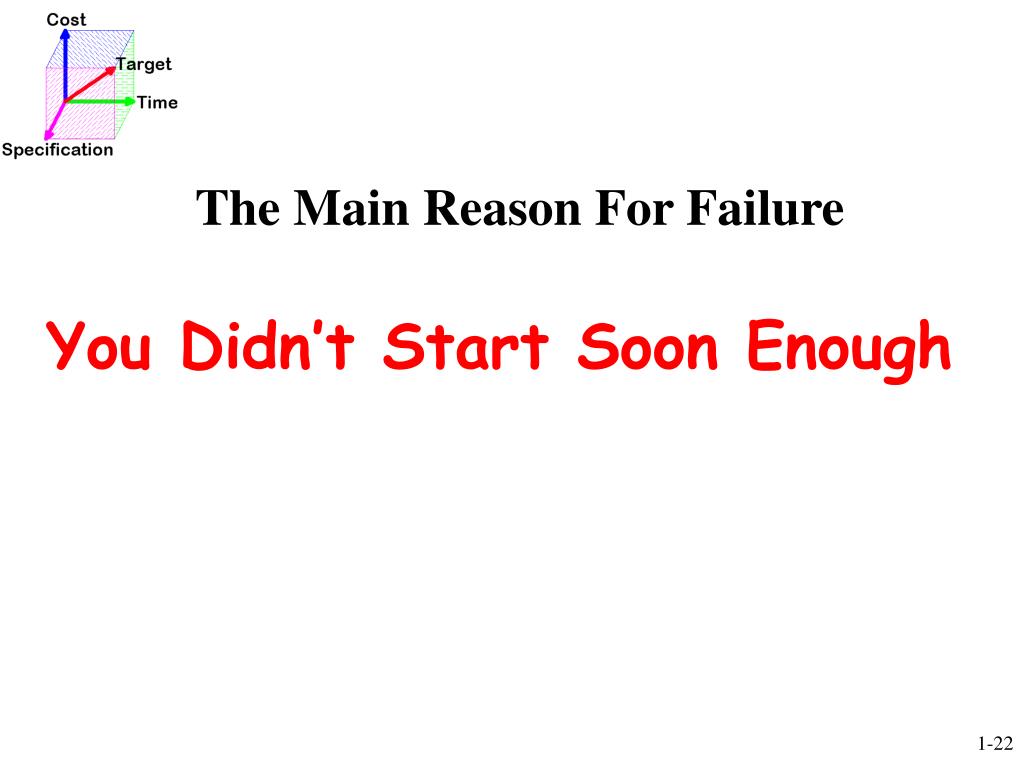

The Main Reason For Failure You Didn’t Start Soon Enough
Readings Meredith JR, Mantel SJ, Shafer SM & Sutton MM, (2001), Project Management in Practice Kerzner H, (2003), Project Management – A systems approach…, Wiley – (AVAILABLE ELECTRONICALLY) Meredith JR & Mantel SJ, (2000), Project Management – A managerial approach… Angus RB, et al, (2000), Planning, Performing & Controlling Projects PMI Guide to the Body of Knowledge available in Standard IEEE 1490-2003 via IEEEXplore using Athens
Tutorials • Your Next Tutorial Will Be In 4E19 (This means TODAY for Helena’s group!!) (except for Ramin’s and Sally’s Groups who will be in 4E16)
