110 likes | 223 Vues
This document provides a comprehensive overview of the responsibilities of the ICT with regard to Transmission Service Requests (TSRs) as discussed during the 2008 Transmission Summit in New Orleans, LA. It details the process for maintaining, administering, and posting long-term service requests, as well as the coordination of system impact and facilities studies. Additionally, it covers the protocol for responding to customer inquiries and documentation posting as per Entergy's Tariff. The report highlights significant activities and studies performed by both ICT and Entergy.
E N D
Transmission Service Requests Overview 2008 Transmission Summit July 29, 2008 New Orleans, LA
ICT TSR Responsibilities • Maintain, Administer, and Post for Long-Term Transmission Service Requests • Long-term service requests (≥1 year) or requests outside the Study Horizon (18 months) • Schedule, send, receive, and validate all Study Agreements • System Impact Study Agreement (SISA) • Facilities Study Agreement (FSA) • Affected System Agreements • Respond to any inquiries by the Transmission Service Customer via phone, email, and IssueTrak.

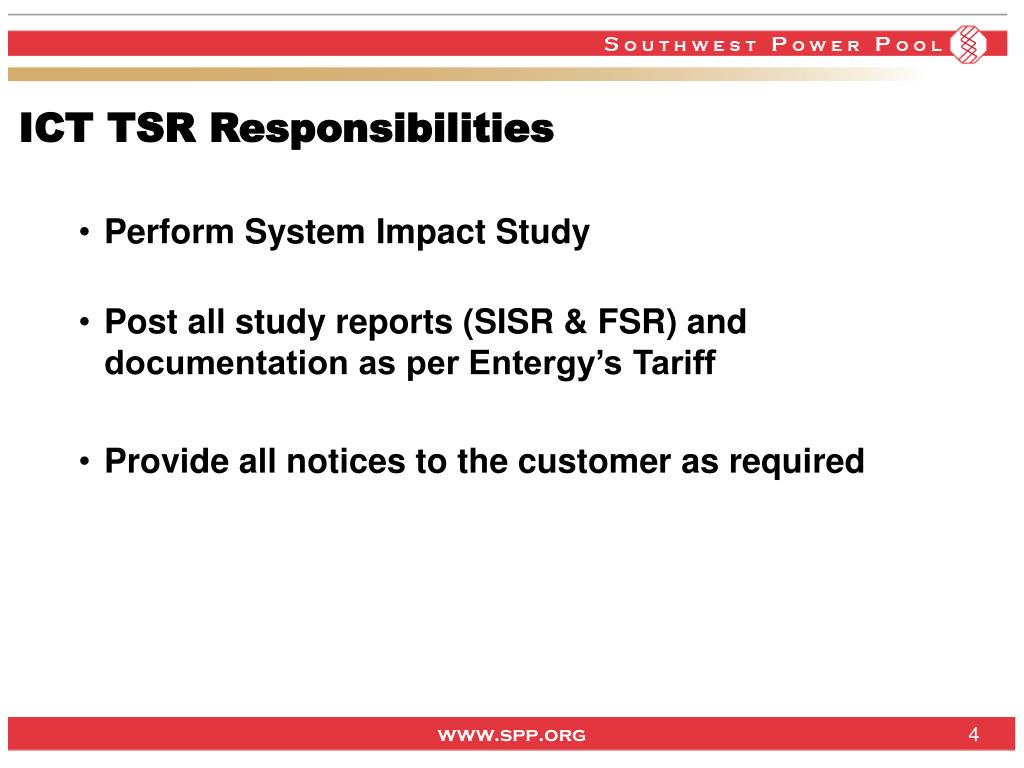

ICT TSR Responsibilities • Perform System Impact Study • Post all study reports (SISR & FSR) and documentation as per Entergy’s Tariff • Provide all notices to the customer as required
ICT TSR Responsibilities • Review and validate the results of the Facilities Study • Classify upgrades as Base Plan or Supplemental as per Attachment T of Entergy’s Tariff • Coordinate studies with any Affected Systems
Entergy TSR Responsibilities • Review System Impact Study Report (SISR) • Tender, enter into, and file all Transmission Service Agreements • Enter into 3rd party Facilities Study Agreement (FSA) with ICT and Customer • Perform Facilities Study
Transmission Service Requests (Since 2007 Summit) • ICT has sent out 248 SISAs • ICT has performed and posted 154 SISRs on time • ICT has 17 SIS in process • Entergy has performed 48 FSRs on time • Entergy has 5 FS in process
System Impact Studies • ICT has performed and posted 154 SISRs • 53 Point to Point Requests • 9 Monthly Requests • 101 Network Requests • 4 Monthly Requests • 3 Affected System Requests • ICT has 17 SIS in process • 2 Monthly Firm PTP • 1 Monthly Network • 6 Long Term Firm PTP • 3 Long Term Network • 5 Affected System
Facilities Studies • Entergy has performed 48 FSRs • 14 Point to Point Requests • 13 Long Term Firm Requests • 1 Affected System Request • 34 Network Requests • 31 Yearly Network Requests • 3 Affected System Requests • Entergy has 5 FS in progress • 5 Yearly Network Requests
Questions / Commentsspp.issuetrak.comQuick Pick: ICT Planning– Transmission James Lyle501-614-3561JLyle@SPP.org English Cook501-614-3555ECook@SPP.org
