240 likes | 393 Vues
Defence Capability Plan (DCP) Challenges in managing the portfolio: Doing the same for less How can portfolio prioritisation be achieved? Tim Hogan – Acting Director Program Analysis. Topics. DCP Overview and DCP 2012 Prioritisation framework and planning
E N D
Defence Capability Plan (DCP)Challenges in managing the portfolio: Doing the same for lessHow can portfolio prioritisation be achieved?Tim Hogan – Acting Director Program Analysis
Topics • DCP Overview and DCP 2012 • Prioritisation framework and planning • Financial Planning approaches in the DCP • Planning constraints and realities • Fitting more in – Management approaches • Planning risks • Human Judgement in Prioritisation
DCP Overview • The Defence Capability Plan (DCP) provides an outline of the major capital equipment initiatives that are planned for Government Approval. • The DCP is developed taking into account that available funding guidance from Government, the delivery schedule required for the capability and the capacity of Defence and Industry. • The Public Defence Capability Plan (DCP) 2012 is a five year rolling ‘working’ capital investment plan of Australia’s military capabilities. It lists the projects that have yet to be 1st or 2nd pass approved by Government. • Internal to the Department, we manage a program over a longer ten year period.
DCP 2012 Overview • Minister Smith directed a full review of the DCP in July 2011 driven by realignment of the DCP by programme slippage and reduction to over-programming as a DCP management principle • Defence announced Budget 2012-13 • Removed $3.5 billion of Forward Estimates funding • About 35 percent of funding • Affected around 75 projects • The DCP 2012 incorporates five main outcomes: • Government’s key strategic priorities, over the next 2-5 years • Reducing over-programming and over-promising • Is coherent • Is achievable and executable • Underpinned by robust set of initiatives • Further pressures identified requiring rigorous analysis as part of 2013 White Paper.

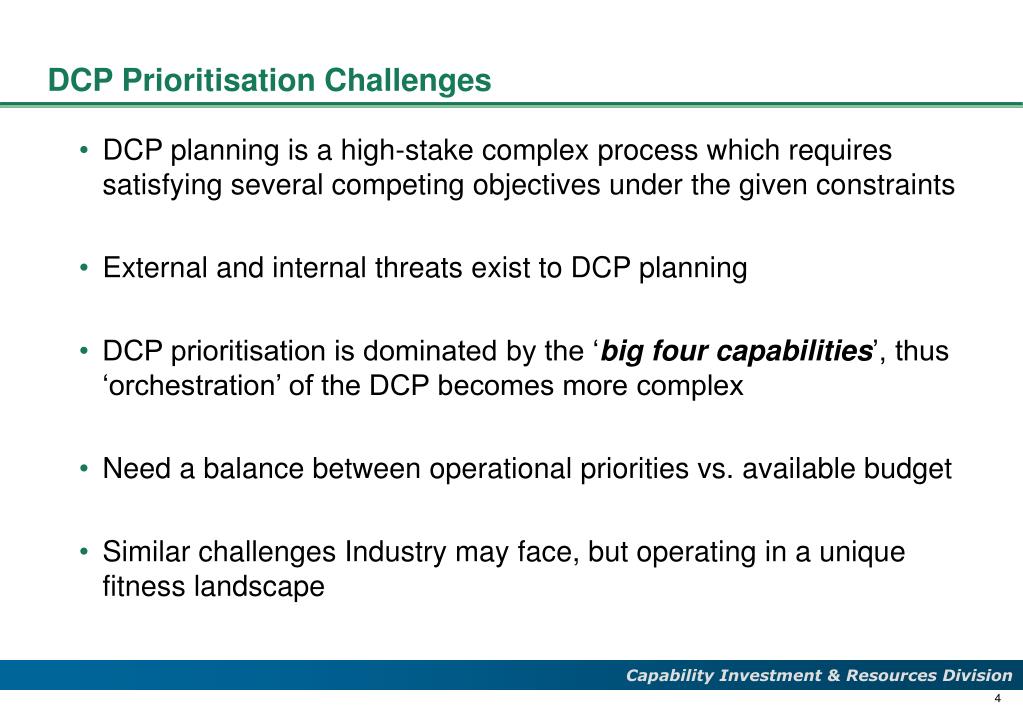

DCP Prioritisation Challenges • DCP planning is a high-stake complex process which requires satisfying several competing objectives under the given constraints • External and internal threats exist to DCP planning • DCP prioritisation is dominated by the ‘big four capabilities’, thus ‘orchestration’ of the DCP becomes more complex • Need a balance between operational priorities vs. available budget • Similar challenges Industry may face, but operating in a unique fitness landscape
DCP View: Existing Approved Capital Projects being delivered AMCIP
DCP View: Approved and Unapproved Capital Projects Top 10 projects comprise the majority of the DCP portfolio Remaining projects below the Top 10 AMCIP
DCP View: Defence Capital Program over ten years vs. Capital Budget Budget Top 10 projects comprise the majority of the DCP portfolio Remaining projects below the Top 10 AMCIP
DCP Make-up: Four DCP capabilities represent almost 60% of total programme cost Project estimated cost as a % of total programme estimated cost • 99 projects % total programme cost 100 95% of cost • 57 projects 80 80% of cost • 16 projects 60 57% of cost 40 • 4 strategic capabilities • SEA 1000 • LAND 400 • AIR 6000 • SEA 5000 20 0 20 projects take up 80% of total programme budget, 99 projects take up 5%
DCP Prioritisation Challenges • The DCP looks to model this programming problem as multi-objective optimisation problem through: • Balancing Government’s key strategic priorities • Reducing over-programming and over-promising • Dealing with optimism bias in cost estimation • Human judgement • What are the decision making trade-offs/ prioritisation decisions that can be made in the portfolio: • Delay • Remove • Accelerate • Re-scope • Merge/ Split Project Phases
Prioritisation framework built around two dimensions: strategic importance and urgency Input Working Definition What is the relative strategicimportance of DCP projects? • Alignment long-term force structure requirements as defined in the DPG • Impact on Defence's preparedness in the next 10 years • Number and criticality of dependencies on other capabilities (e.g., "glue" projects) • Low: At least 2yr buffer btwn IOC & PWD • Med: 1yr buffer to 2 yr gap btwn IOC & PWD • High: >2yr gap btwn IOC & PWD Force structure Short-to-medium term preparedness Interdependencies Degree of urgency 1 2 3 4 What is the sequencingpriority?
The aim of prioritisation is for a robust, repeatable results from a well defined approach and organised information • A formal rigorous prioritisation model Outcome: repeatable and robust DCP prioritisation Prioritisation process High-level process steps for repeatable prioritisation exercise Prioritisation approach Prioritisation framework Urgency Strategic Importance Scheduling tool Integrated Decision Support Tool Forward Work Program Project financials Current System Retirement Date Initial Operating Capability Prepared-ness assessment Force Structure assessment Dependencies Key Underlying Input data Prioritisation information
DCP Planning Constraints and Uncertainty • “Crystal ball dilemma” - Unfortunately, we do not know which projects will become more risky or more uncertain as they progress through the approval process. • Financial constraints: • Most cost estimates that set DCP provisions are actually low quality • Building the DCP is based on uncertain baseline information • Projects with large cash demands can restrict DCP building activities and prioritisation of other projects • Financial risks: • Underspend: poor estimates and optimism means we are at risk of not spending early cash • Overspend: unexpected large cash demands risk blowing DCP budget; go to jail under FMA Act
DCP Planning Constraints and Uncertainty • Capability constraints: • Capabilities more difficult to accelerate • Project independencies with other DCP capabilities • Capabilities can driven by foreign partnership/programs • Capability risks to the portfolio: • Capability not delivered: unacceptable capability gaps created, risk to delivering Defence’s strategic priorities • Capability prioritisation: less important capabilities approved, capability immature for Industry to deliver • The challenge is to strike a balance between managing the risk and uncertainty in the DCP and applying an adaptive DCP modelling to allow the DCP to remain achievable

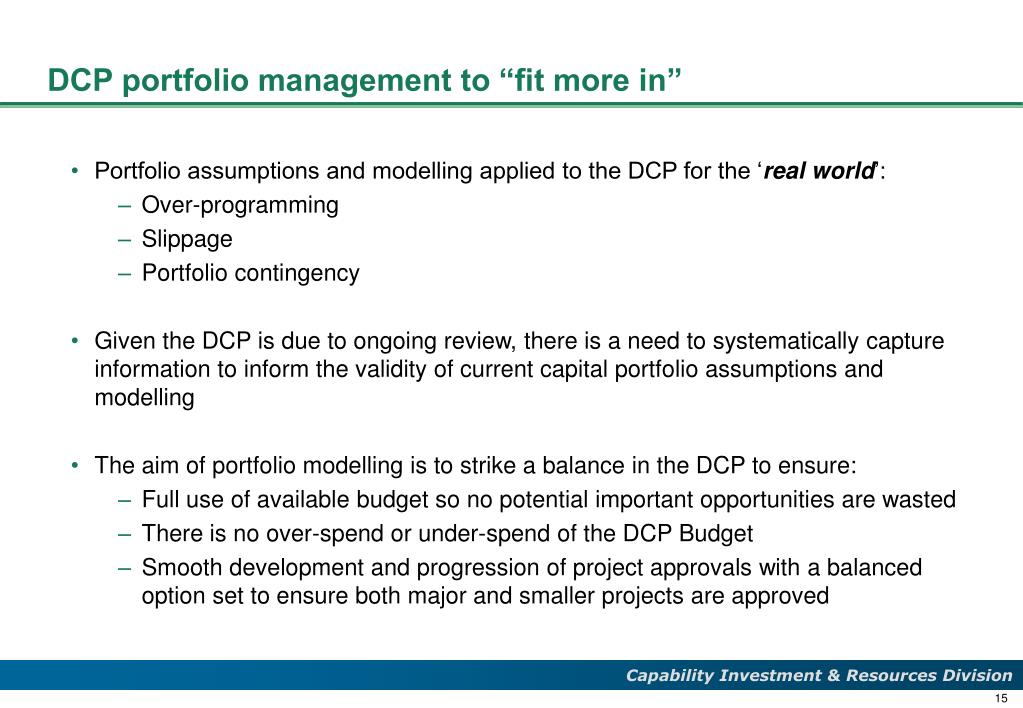

DCP portfolio management to “fit more in” • Given the complexity, ‘orchestration’ of DCP, development of the portfolio can be inherently difficult as any other Capital investment program • Objectives of portfolio management aim to adjust for DCP-wide financial uncertainty including estimation biases and financial slippage, and schedule uncertainty • The DCP is constantly evolving, if somewhat volatile, and being updated to reflect: • Changes of capability priorities • Revised cost estimate/ acquisition strategies • Schedule adjustments • Approval of projects • Portfolio modelling can be applied to allow for these ‘real world’ considerations
DCP portfolio management to “fit more in” • Portfolio assumptions and modelling applied to the DCP for the ‘real world’: • Over-programming • Slippage • Portfolio contingency • Given the DCP is due to ongoing review, there is a need to systematically capture information to inform the validity of current capital portfolio assumptions and modelling • The aim of portfolio modelling is to strike a balance in the DCP to ensure: • Full use of available budget so no potential important opportunities are wasted • There is no over-spend or under-spend of the DCP Budget • Smooth development and progression of project approvals with a balanced option set to ensure both major and smaller projects are approved
DCP portfolio management risks • Slippage modelling • If more early cash required, it means in short term that something else needs to wait • If costs blow-out – need offsets from elsewhere in the plan • Delays on approvals • Without over-programming, we no longer have a buffer • Lose opportunity to use cash for capability outcomes/ too late to spend funds in time • Contingency calls • Lean programming – ensure sufficient funding held to cover contingency needs • If someone needs contingency cash, they have a priority
Collecting this information together to target value-based DCP prioritisation • Bringing together each of the elements to target prioritisation: • Schedule tightly linked to DCP • Resourcing pressures can be quantified • Capability impacts understood • Portfolio assumptions are linked to build a ‘plan’ • Whilst bringing these elements help inform prioritisation, the value of each project cannot be measured on the same scale: Human Judgement required!!! DCP Prioritisation Human Judgment MinSub/ CabSub Actual project spend NPOC Budget Capital Budget Workforce Price basis and forex Approval constraints Force structure Preparedness Planned end of service date Project cost templates Interdependency Project schedule risk assessment Acceleration assessment Planning Rules -Out-turning -Slippage -Contingency Project Prioritisation Data Guidance Data Project Information Portfolio Assumptions

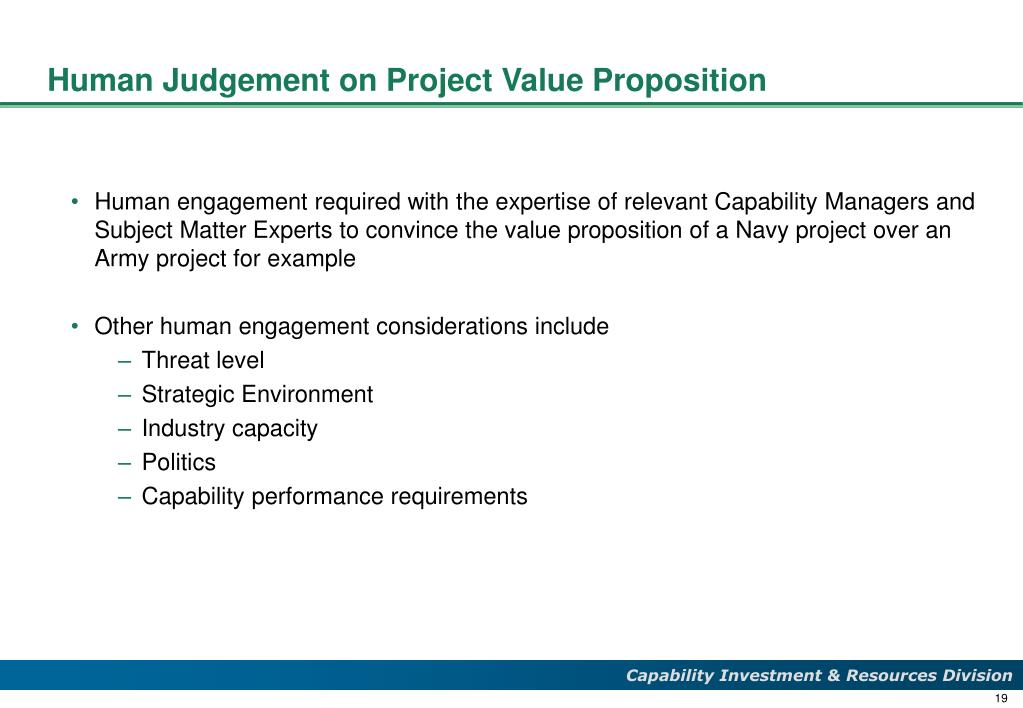

Human Judgement on Project Value Proposition • The aim of human judgement on a project value proposition is to: • Understand the true nature of a projects value and its prioritisation • There is no over-spend or under-spend of the DCP Budget • Smooth development and progression of project approvals with a balanced option set to ensure both major and smaller projects are approved • This framework provides portfolio prioritisation to a start state, but requires an element of human engagement to define the capability value proposition of each project • The value of a Navy project cannot be measured on the same scale as a Army project. There is a need to consider the collective demands from Services to determine the value of a project
Human Judgement on Project Value Proposition • Human engagement required with the expertise of relevant Capability Managers and Subject Matter Experts to convince the value proposition of a Navy project over an Army project for example • Other human engagement considerations include • Threat level • Strategic Environment • Industry capacity • Politics • Capability performance requirements
Summary • Given the complexity, ‘orchestration’ of DCP prioritisation can be inherently difficult as any other Capital investment program • The ‘big four capabilities’ make up the majority of the DCP which determine how the DCP is shaped • DCP prioritisation framework aims to maximise capability outcomes against an available Defence capital budget and a project information/value/data • This framework provides portfolio prioritisation to a start state, but requires an element of human engagement to define the capability value proposition of each project
QUESTIONS?? • THANK YOU

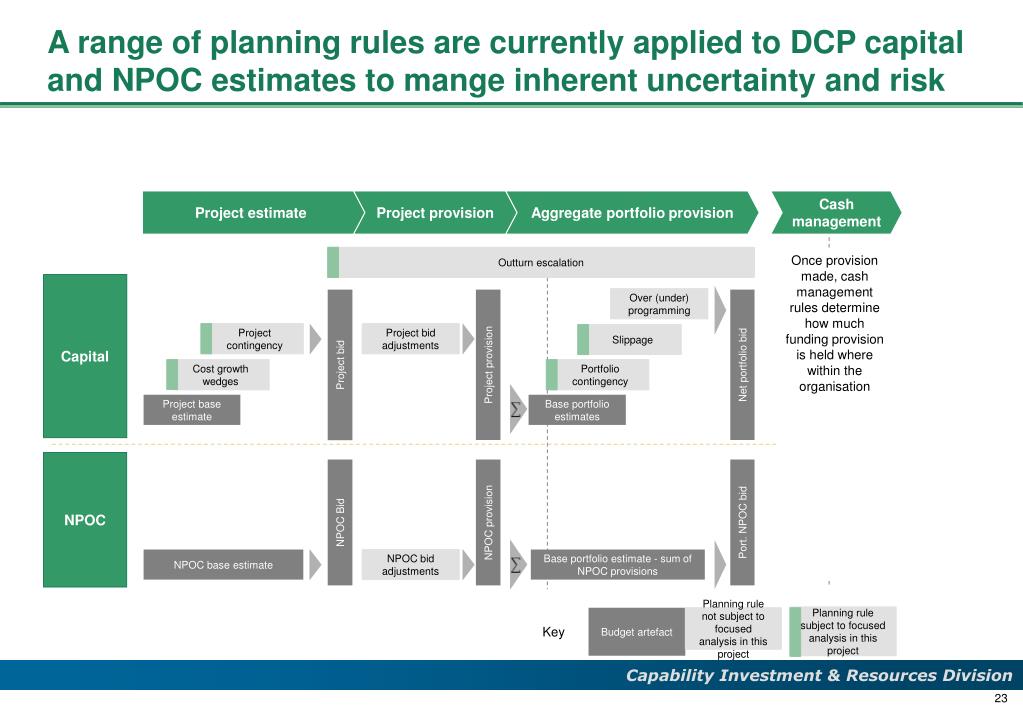

A range of planning rules are currently applied to DCP capital and NPOC estimates to mange inherent uncertainty and risk Project estimate Project provision Aggregate portfolio provision Cash management Outturn escalation Once provision made, cash management rules determine how much funding provision is held where within the organisation Capital Over (under) programming Project contingency Project bid adjustments Slippage Project provision Project bid Net portfolio bid Cost growth wedges Portfolio contingency Project base estimate Base portfolio estimates NPOC NPOC Bid NPOC provision Port. NPOC bid NPOC base estimate NPOC bid adjustments Base portfolio estimate - sum of NPOC provisions Planning rule subject to focused analysis in this project Budget artefact Planning rule not subject to focused analysis in this project Key
