Regulatory Overview

Regulatory Overview. Presented By: Wayne T. Craney, P.E. Engineering Manager Industrial Wastewater Enforcement Section Water Quality Division Department of Environmental Quality. Outline. Regulatory History ODEQ Delegation Types of Permits in Oklahoma OKR10 History

Télécharger la présentation

Regulatory Overview

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Regulatory Overview Presented By: Wayne T. Craney, P.E. Engineering Manager Industrial Wastewater Enforcement Section Water Quality Division Department of Environmental Quality

  2. Outline Regulatory History ODEQ Delegation Types of Permits in Oklahoma OKR10 History Future Regulatory Issues

  3. Regulatory History • Clean Water Act • Passed in 1972 • Focus on point source discharges • Pipes, drains, other easily identified points of discharge • Established the National Pollutant Discharge Elimination System (NPDES) • Amended in 1987 • Addressed more diffuse sources of pollution, such as stormwater discharges

  4. Regulatory History • Stormwater Regulations • Phase I • Promulgated in 1990 • Required the following to be permitted: • Medium and large municipal separate storm sewer systems (MS4s) – generally with populations ≥100,000 • Construction activities disturbing ≥5 acres • Industrial activities

  5. Regulatory History • Stormwater Regulations • Phase II • Established December 8, 1999 • Required the following to be permitted: • Small and medium MS4s and those within urbanized area • Construction activities disturbing ≥1 acre or part of a larger common plan of development

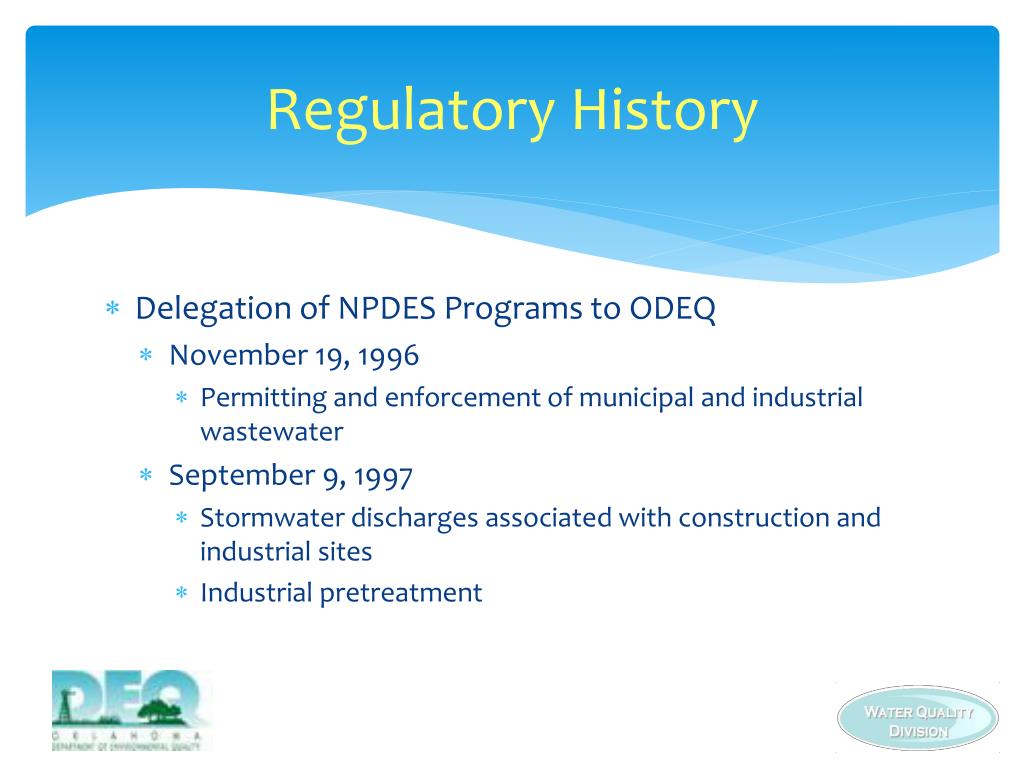

  6. Regulatory History • Delegation of NPDES Programs to ODEQ • November 19, 1996 • Permitting and enforcement of municipal and industrial wastewater • September 9, 1997 • Stormwater discharges associated with construction and industrial sites • Industrial pretreatment

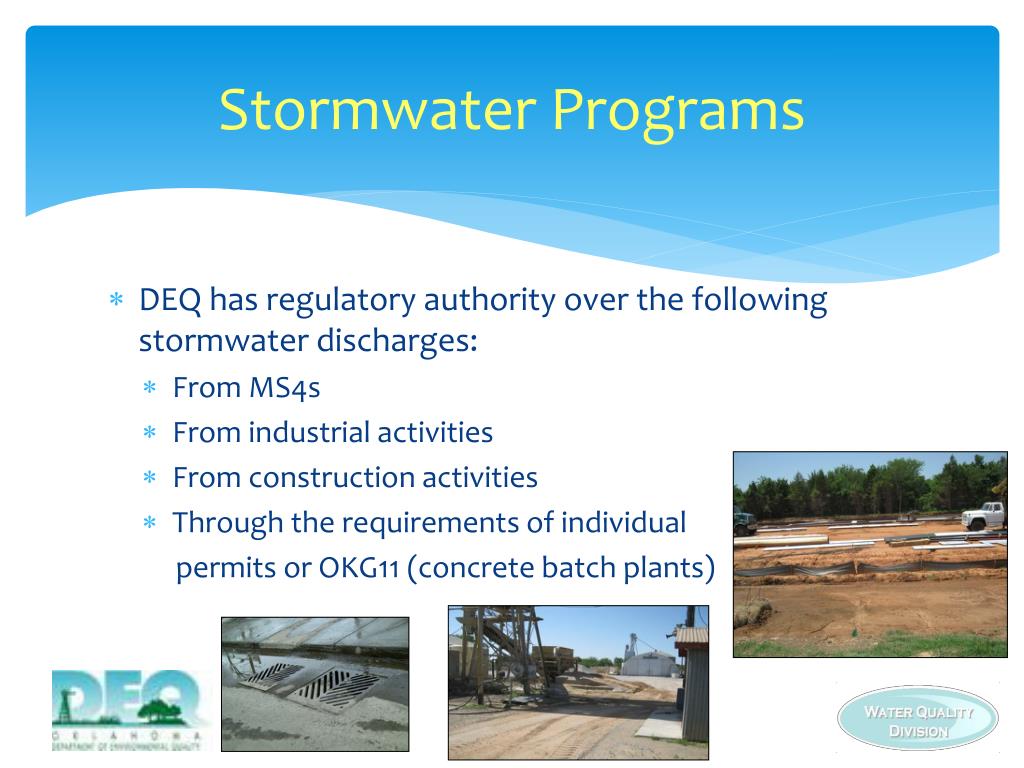

  7. Stormwater Programs • DEQ has regulatory authority over the following stormwater discharges: • From MS4s • From industrial activities • From construction activities • Through the requirements of individual permits or OKG11 (concrete batch plants)

  8. MS4s

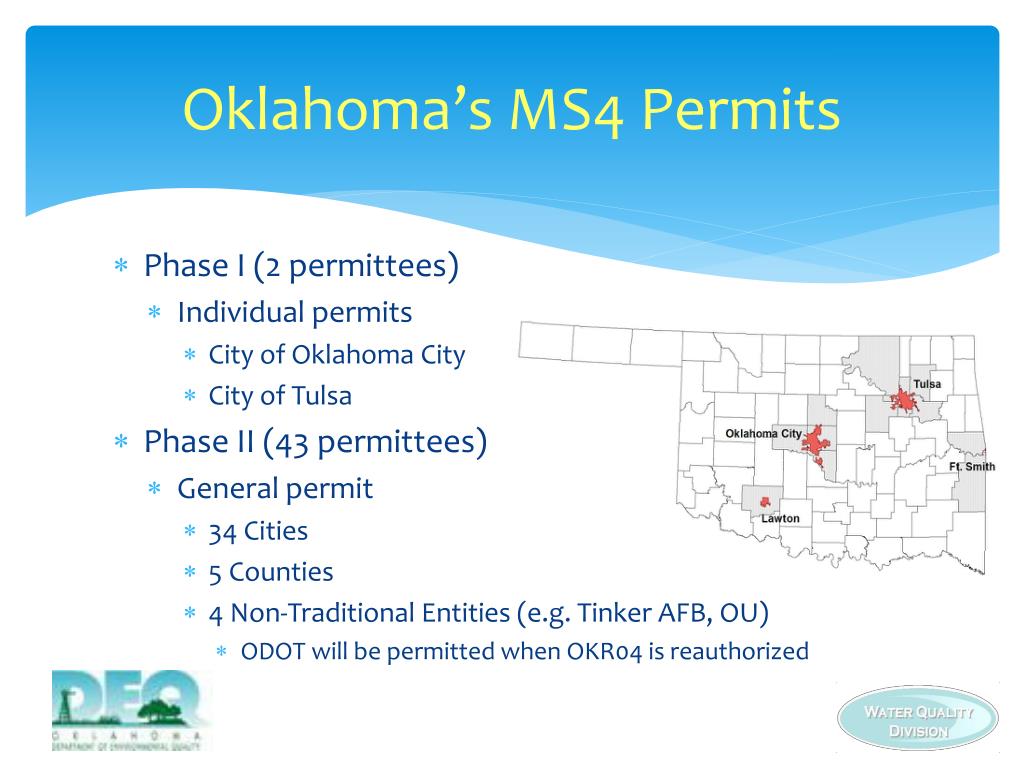

  9. Oklahoma’s MS4 Permits • Phase I (2 permittees) • Individual permits • City of Oklahoma City • City of Tulsa • Phase II (43 permittees) • General permit • 34 Cities • 5 Counties • 4 Non-Traditional Entities (e.g. Tinker AFB, OU) • ODOT will be permitted when OKR04 is reauthorized

  10. Oklahoma’s Phase I MS4 Permits • Individual Permits • Oklahoma City first issued September 1, 1995 • Tulsa first issued April 1, 1997 • Both are co-permittees with ODOT and OTA • Pollution Prevention Approach • Stormwater Management Program (SWMP) • Developed by MS4 • Spells out how MS4 will address/manage stormwater discharges

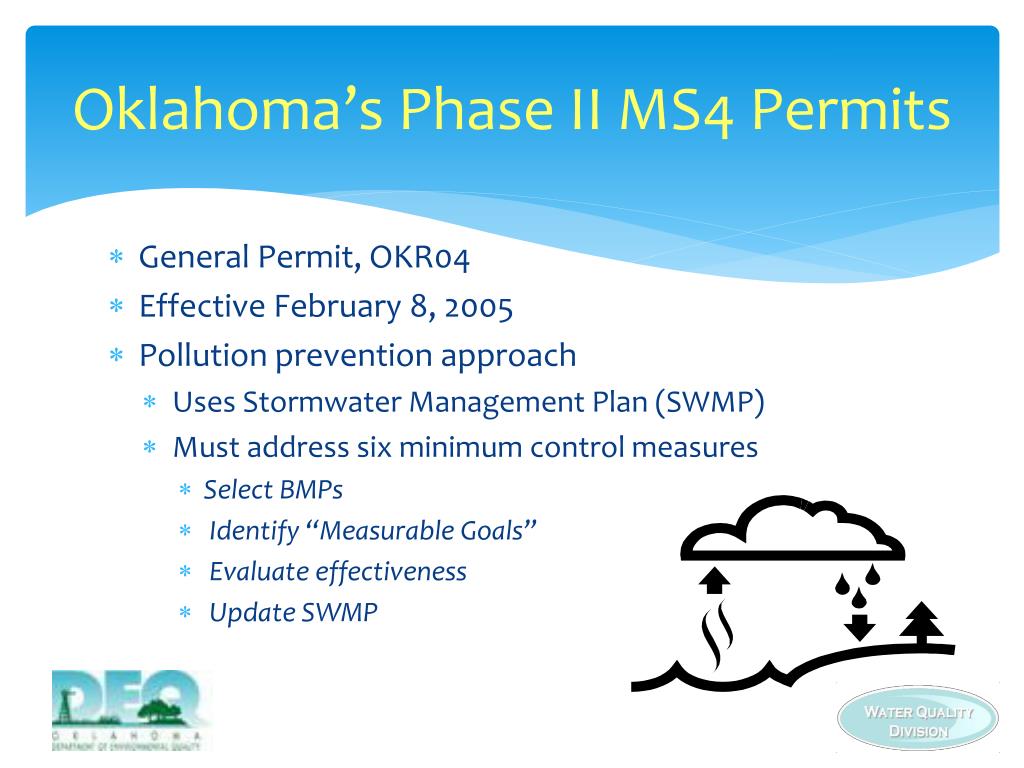

  11. Oklahoma’s Phase II MS4 Permits • General Permit, OKR04 • Effective February 8, 2005 • Pollution prevention approach • Uses Stormwater Management Plan (SWMP) • Must address six minimum control measures • Select BMPs • Identify “Measurable Goals” • Evaluate effectiveness • Update SWMP

  12. Industrial Stormwater

  13. Oklahoma’s Multi-Sector General Permit, OKR05 • Only applies to certain industrial activities • Defined by the Standard Industrial Classification (SIC) code • Listed in Table 1-2 of permit by sector • Only those industrial activities with SIC code in Table 1-2 need to have permit coverage • Can cross-reference SIC code with NAICS code

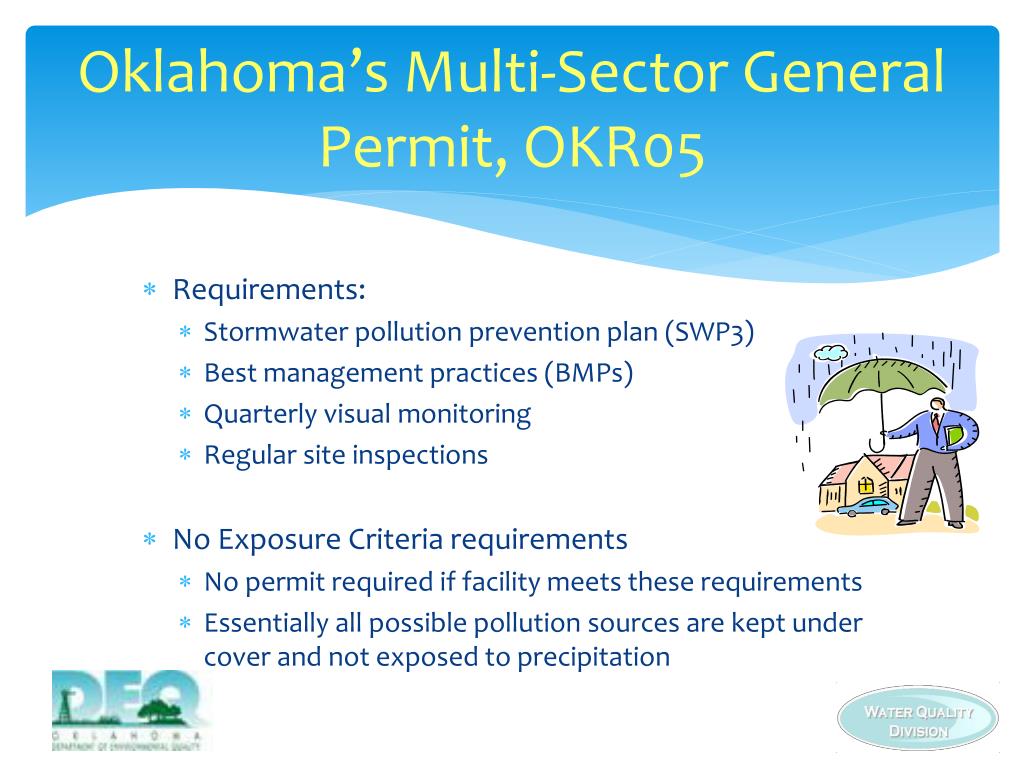

  14. Oklahoma’s Multi-Sector General Permit, OKR05 • Requirements: • Stormwater pollution prevention plan (SWP3) • Best management practices (BMPs) • Quarterly visual monitoring • Regular site inspections • No Exposure Criteria requirements • No permit required if facility meets these requirements • Essentially all possible pollution sources are kept under cover and not exposed to precipitation

  15. Construction Stormwater

  16. EPA’s Construction Stormwater General Permit (CGP) • Applies where EPA is permitting authority • i.e. Indian Lands • First CGP issued in 1992 • Current CGP issued on February 16, 2012 • Effective for 5-year period • Includes new requirements to implement Effluent Limitation Guidelines and New Source Performance Standards for Construction and Development point sources – aka C&D Rule

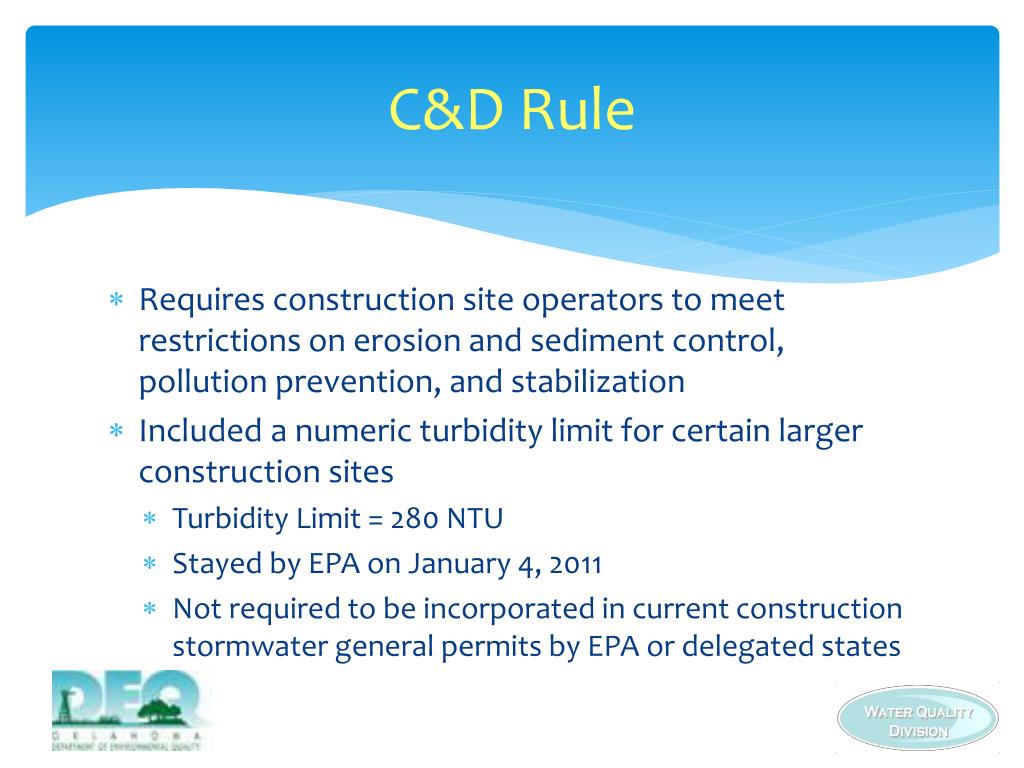

  17. C&D Rule • Requires construction site operators to meet restrictions on erosion and sediment control, pollution prevention, and stabilization • Included a numeric turbidity limit for certain larger construction sites • Turbidity Limit = 280 NTU • Stayed by EPA on January 4, 2011 • Not required to be incorporated in current construction stormwater general permits by EPA or delegated states

  18. Oklahoma’s Construction Stormwater General Permit, OKR10 Is Oklahoma’s version of EPA’s CGP Effective for 5-year period Includes non-numeric effluent limitation guidelines from C&D Rule

  19. Oklahoma’s Construction Stormwater General Permit, OKR10 • Applies to construction activities that disturb an acre or greater or are part of a common plan of development that disturbs an acre or greater • Requirements • SWP3 • Regular site inspections • BMPs • Buffers

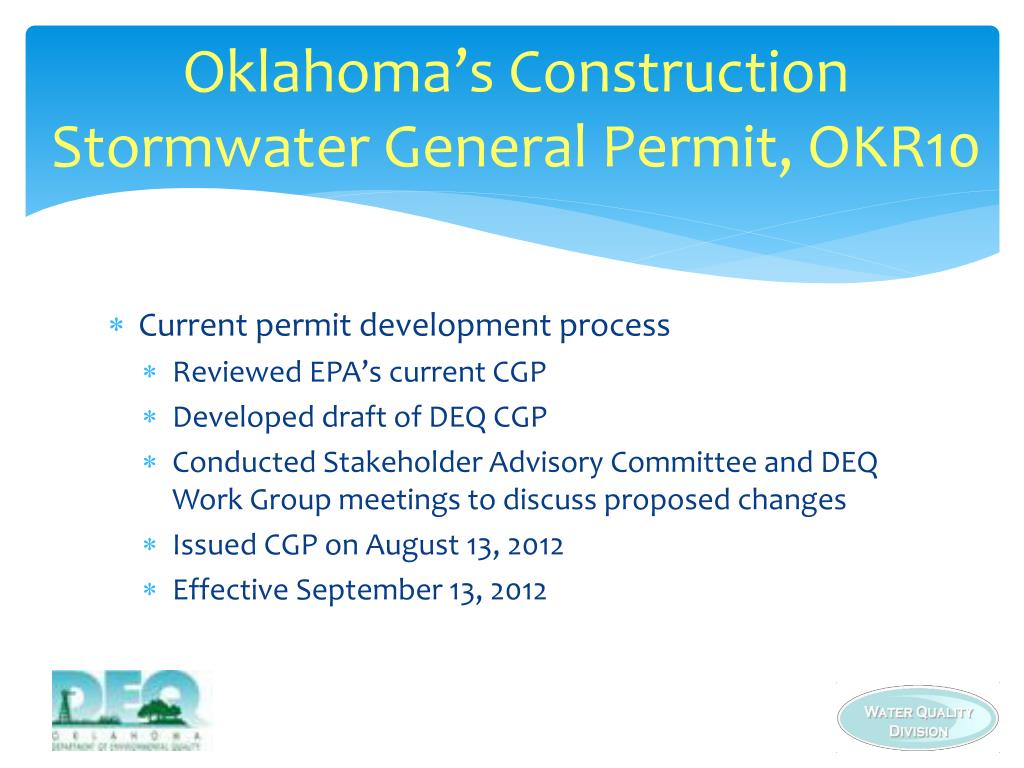

  20. Oklahoma’s Construction Stormwater General Permit, OKR10 • Current permit development process • Reviewed EPA’s current CGP • Developed draft of DEQ CGP • Conducted Stakeholder Advisory Committee and DEQ Work Group meetings to discuss proposed changes • Issued CGP on August 13, 2012 • Effective September 13, 2012

  21. Local Construction Permits • Each MS4 has its own construction stormwater permitting requirements • Required as part of MS4 program • Can be more stringent than state requirements • Some require permits for sites disturbing less than one acre • Be sure to check with local authorities to ensure you have the appropriate permits and are meeting all local stormwater regulations

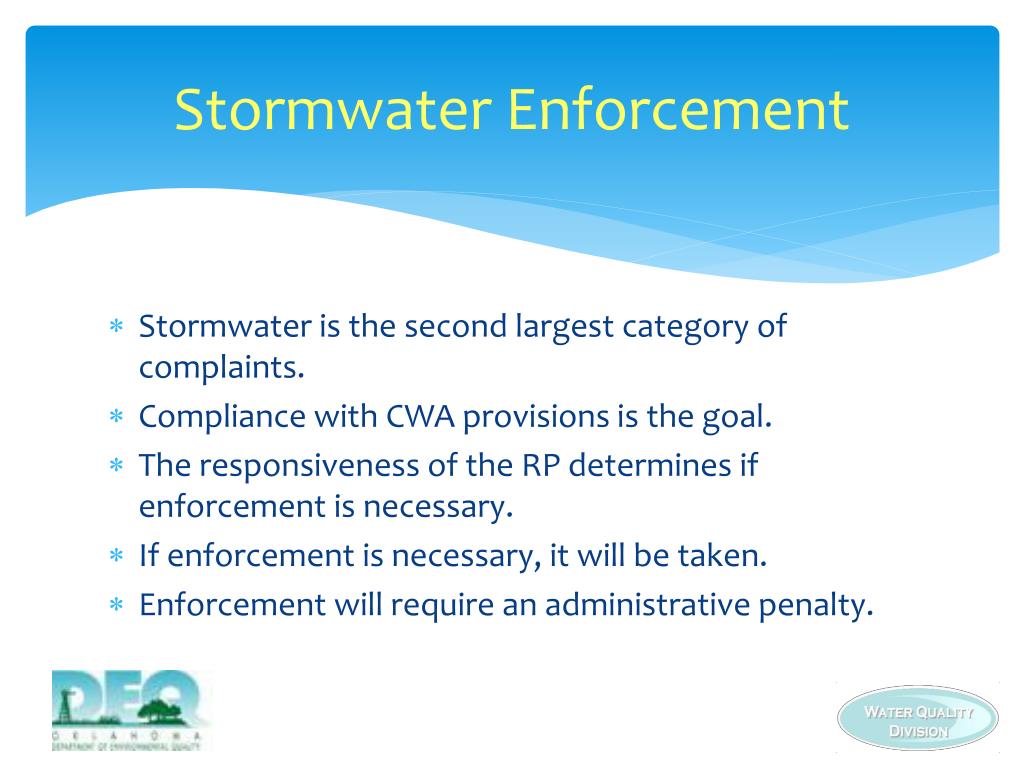

  22. Stormwater Enforcement Stormwater is the second largest category of complaints. Compliance with CWA provisions is the goal. The responsiveness of the RP determines if enforcement is necessary. If enforcement is necessary, it will be taken. Enforcement will require an administrative penalty.

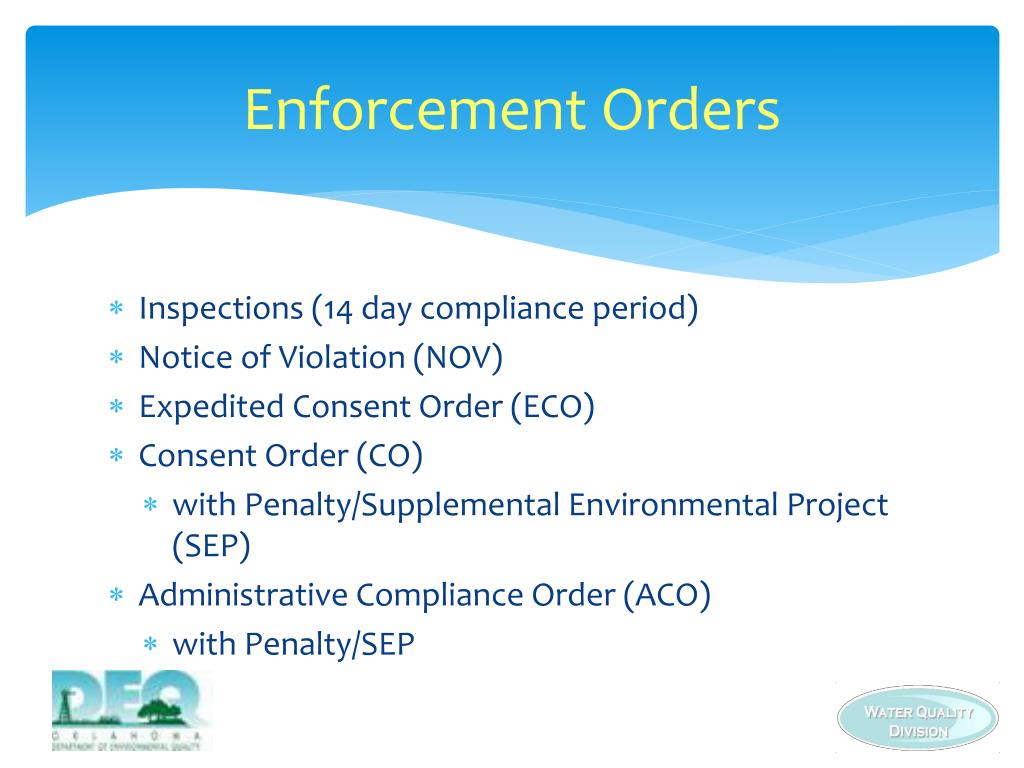

  23. Enforcement Orders • Inspections (14 day compliance period) • Notice of Violation (NOV) • Expedited Consent Order (ECO) • Consent Order (CO) • with Penalty/Supplemental Environmental Project (SEP) • Administrative Compliance Order (ACO) • with Penalty/SEP

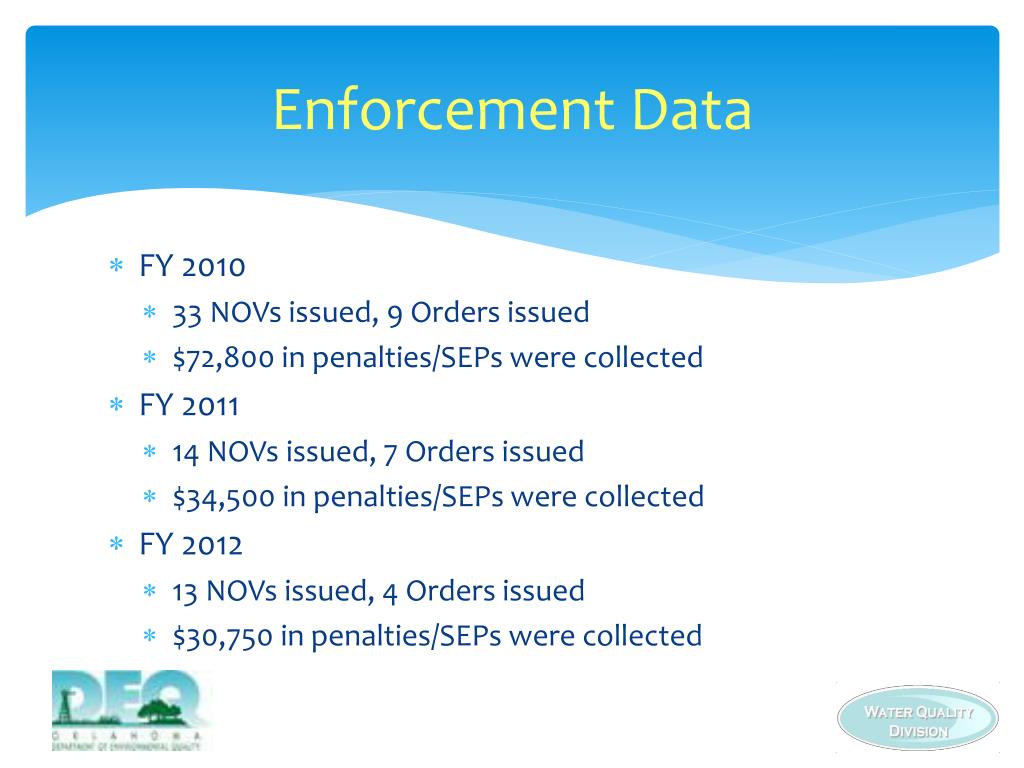

  24. Enforcement Data • FY 2010 • 33 NOVs issued, 9 Orders issued • $72,800 in penalties/SEPs were collected • FY 2011 • 14 NOVs issued, 7 Orders issued • $34,500 in penalties/SEPs were collected • FY 2012 • 13 NOVs issued, 4 Orders issued • $30,750 in penalties/SEPs were collected

  25. Future Regulatory Issues • EPA Stormwater Rulemaking • Rule to be proposed by June 10, 2013 • Most apply to MS4s • Of general note: • Exploring options for establishing specific requirements for transportation facilities; and • Evaluating additional provisions specific to the Chesapeake Bay watershed • Not applicable in Oklahoma

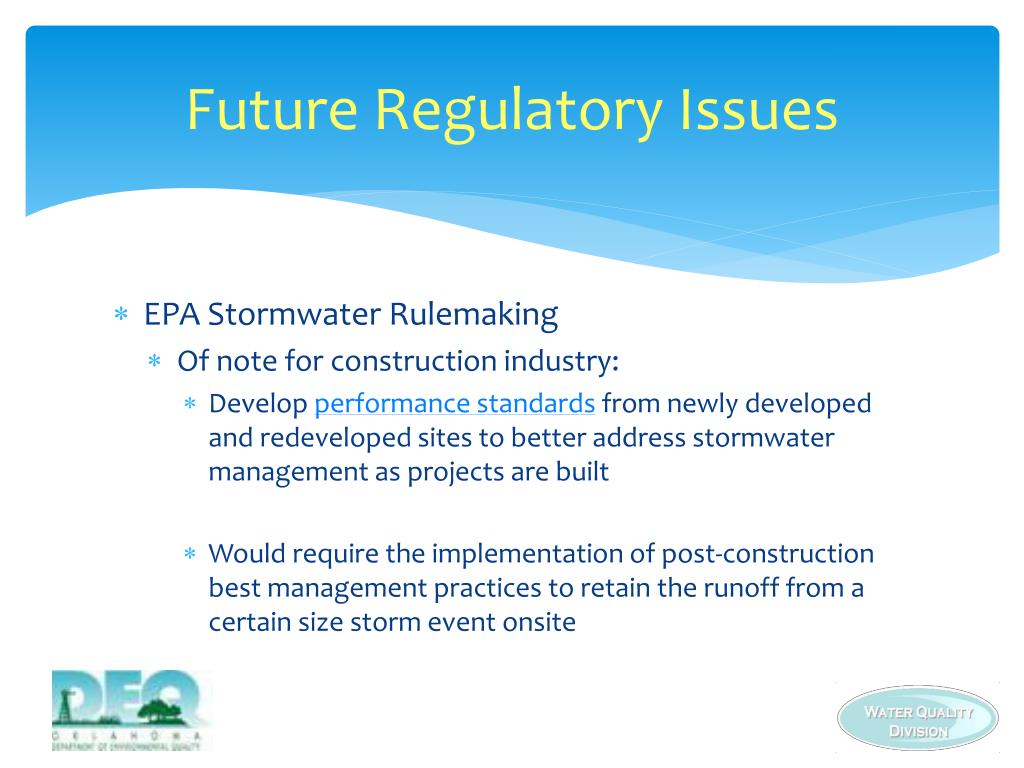

  26. Future Regulatory Issues • EPA Stormwater Rulemaking • Of note for construction industry: • Develop performance standards from newly developed and redeveloped sites to better address stormwater management as projects are built • Would require the implementation of post-construction best management practices to retain the runoff from a certain size storm event onsite

  27. Future Regulatory Issues • EPA Stormwater Rulemaking • Of note for MS4s: • Explore options for expanding the protections of the MS4 program; • Evaluate options for establishing and implementing a municipal program to reduce discharges from existing development (aka “Retrofit”); • Evaluate establishing a single set of minimum measures requirements for regulated MS4s.

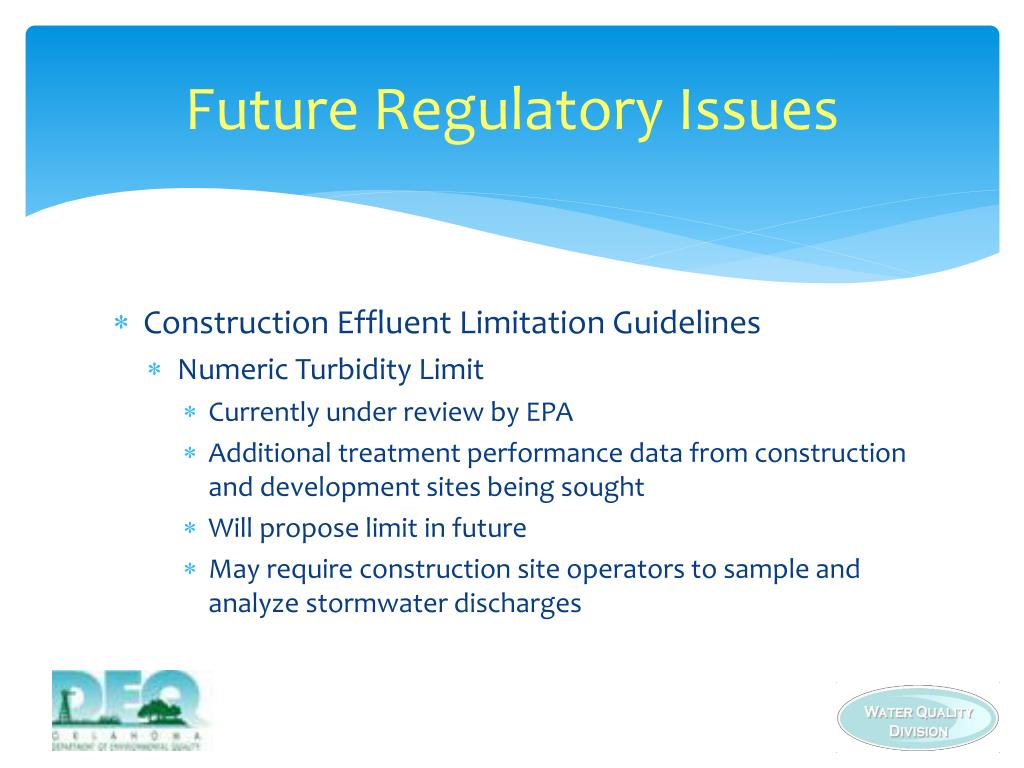

  28. Future Regulatory Issues • Construction Effluent Limitation Guidelines • Numeric Turbidity Limit • Currently under review by EPA • Additional treatment performance data from construction and development sites being sought • Will propose limit in future • May require construction site operators to sample and analyze stormwater discharges

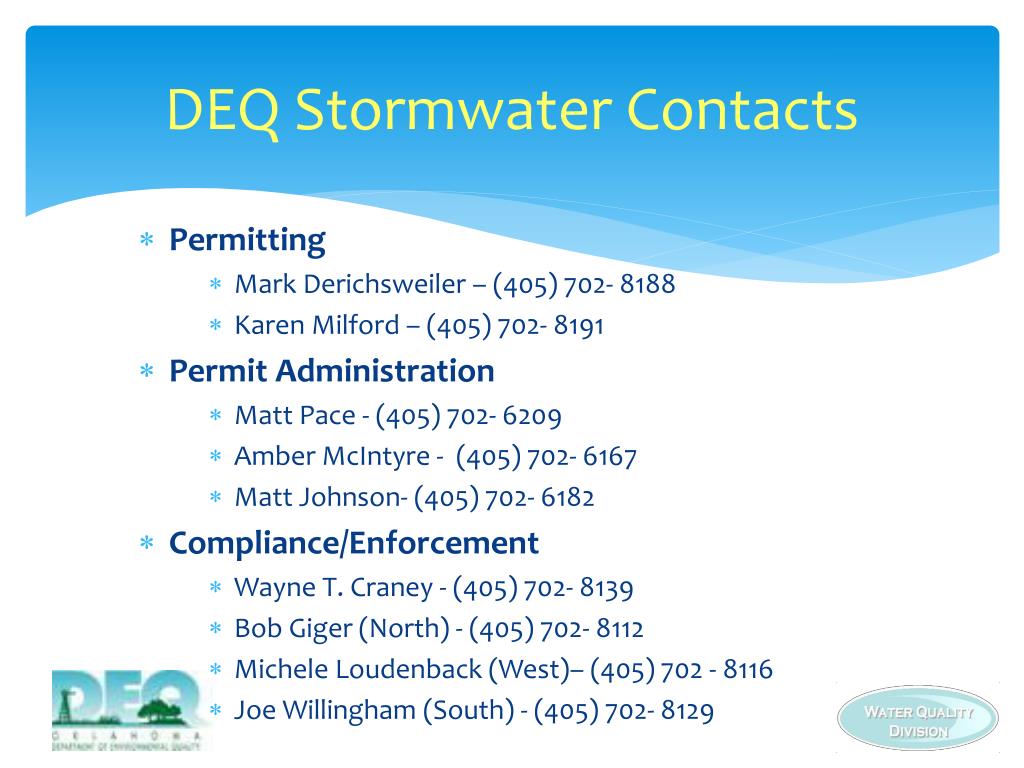

  29. DEQ Stormwater Contacts • Permitting • Mark Derichsweiler – (405) 702- 8188 • Karen Milford – (405) 702- 8191 • Permit Administration • Matt Pace - (405) 702- 6209 • Amber McIntyre - (405) 702- 6167 • Matt Johnson- (405) 702- 6182 • Compliance/Enforcement • Wayne T. Craney - (405) 702- 8139 • Bob Giger (North) - (405) 702- 8112 • Michele Loudenback (West)– (405) 702 - 8116 • Joe Willingham (South) - (405) 702- 8129

  30. Questions, Comments, Discussion
