DESCRIPTION

MTR Project ACCENT. T.O. van Staveren, NRG A.J. de Koning, NRG M. Davies, Frazer Nash Consultancy. September 18, 2013. MTR Project ACCENT. Goal Status of project Design Samples Irradiation PreIE and PIE program. MTR Project ACCENT. MTR: Materials Test Reactor

1 / 20

Download Presentation
Télécharger la présentation

MTR Project ACCENT

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. MTR Project ACCENT T.O. van Staveren, NRG A.J. de Koning, NRG M. Davies, Frazer Nash Consultancy September 18, 2013

  2. MTR Project ACCENT • Goal • Status of project • Design • Samples • Irradiation • PreIEand PIE program

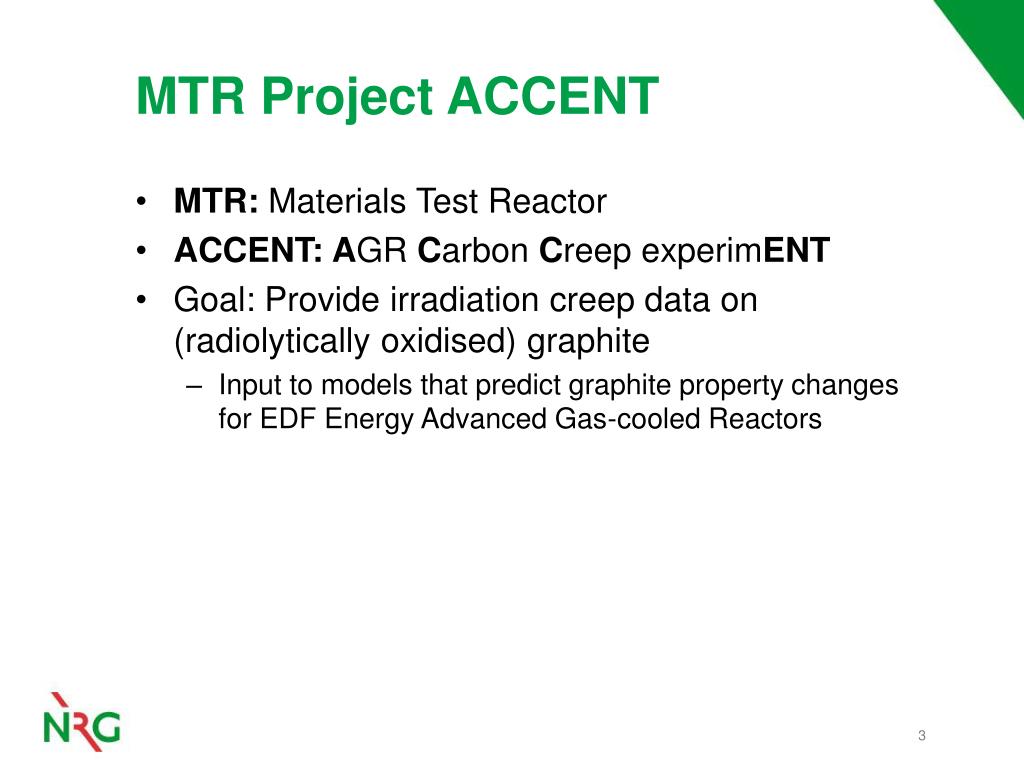

  3. MTR Project ACCENT • MTR: Materials Test Reactor • ACCENT: AGR Carbon Creep experimENT • Goal: Provideirradiation creep data on (radiolyticallyoxidised) graphite • Input tomodelsthatpredictgraphite property changes for EDF Energy Advanced Gas-cooled Reactors

  4. Plan • Irradiategraphite samples at high temperatureunder stress in the High Flux Reactor in Petten • Perform multiple irradiationand post-irradiationcharacterisation stages todeterminegraphiteproperties at different dpavalues • Load virginandradiolyticallyoxidised samples todetermineirradiation creep behaviour at low / high neutron doseandweightloss

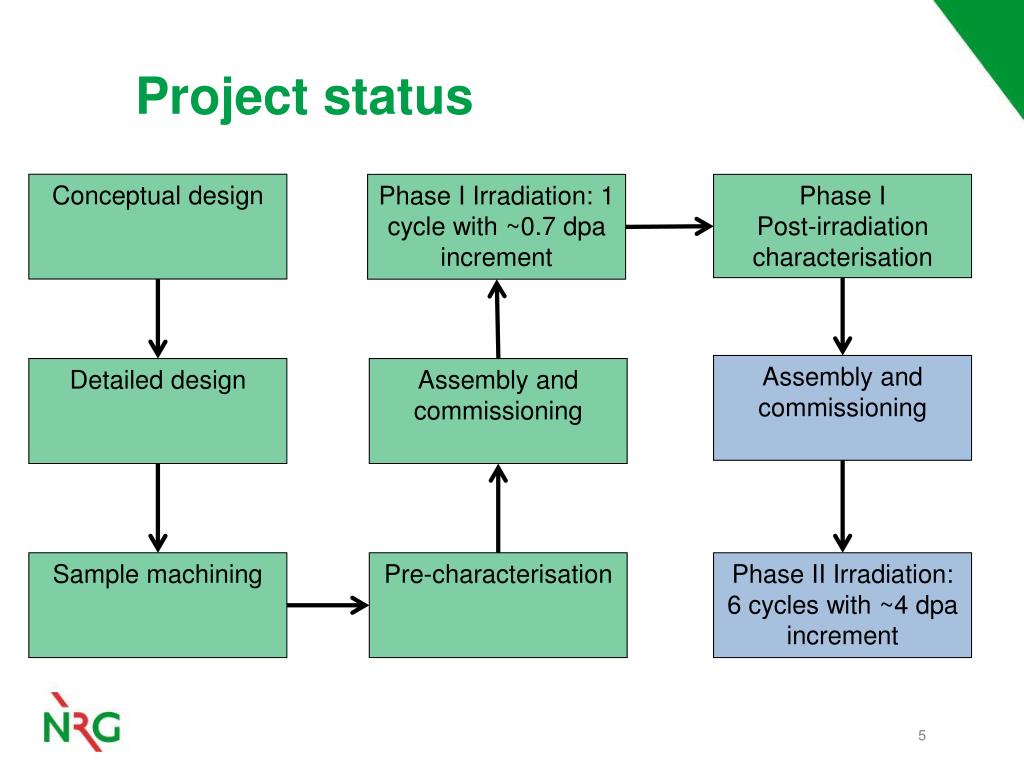

  5. Project status Conceptual design Phase I Irradiation: 1 cycle with ~0.7 dpa increment Phase I Post-irradiation characterisation Assembly and commissioning Detailed design Assembly and commissioning Sample machining Pre-characterisation Phase II Irradiation: 6 cycles with ~4 dpa increment

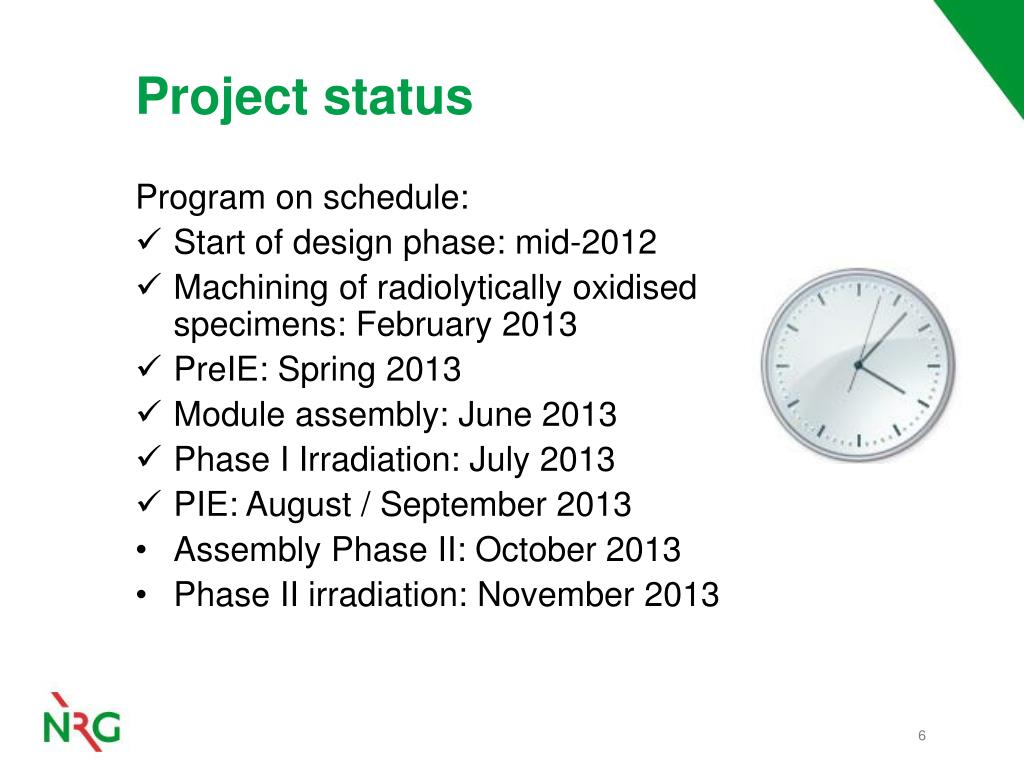

  6. Project status Program on schedule: • Start of design phase: mid-2012 • Machiningof radiolyticallyoxidisedspecimens: February 2013 • PreIE: Spring 2013 • Module assembly: June 2013 • Phase I Irradiation: July 2013 • PIE: August / September 2013 • Assembly Phase II: October 2013 • Phase II irradiation: November 2013

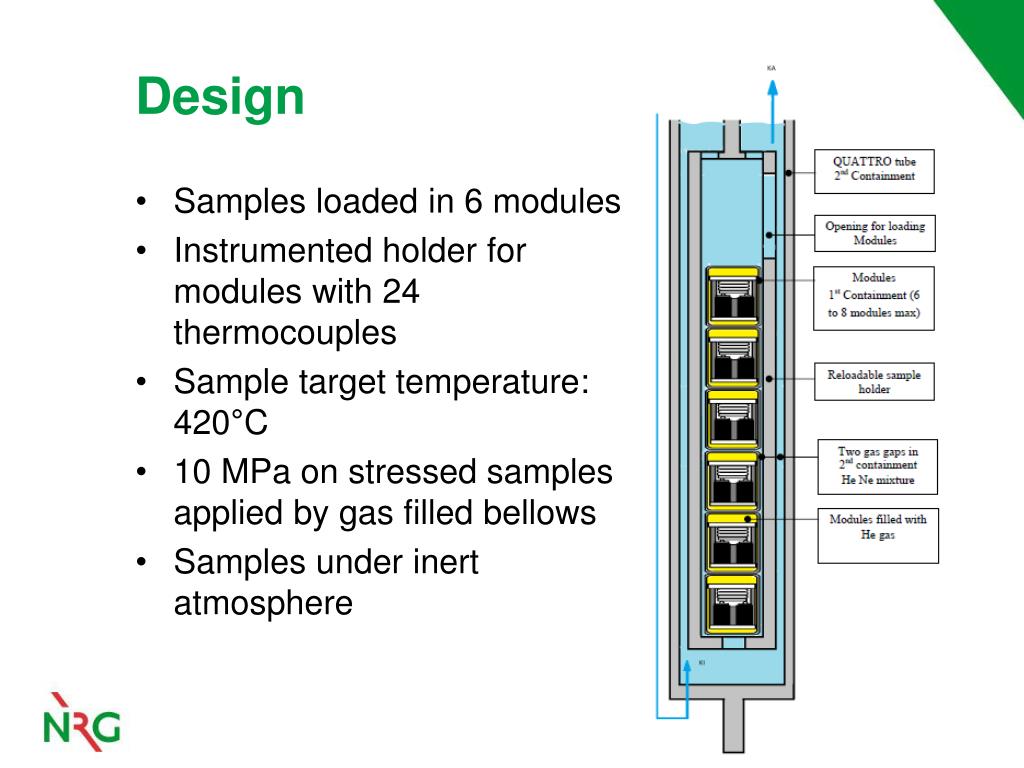

  7. Design • Samples loaded in 6 modules • Instrumentedholderfor modules with 24 thermocouples • Sample target temperature: 420°C • 10 MPa on stressed samples appliedby gas filledbellows • Samples under inert atmosphere

  8. Temperature control • Instrumentedholderwith 24 thermocouples → online temperature monitoring • Temperaturecontrolledby He/Ne gas mixture in 2nd containment • SiCtemperature monitors → post mortemtemperature analysis of samples andbellows

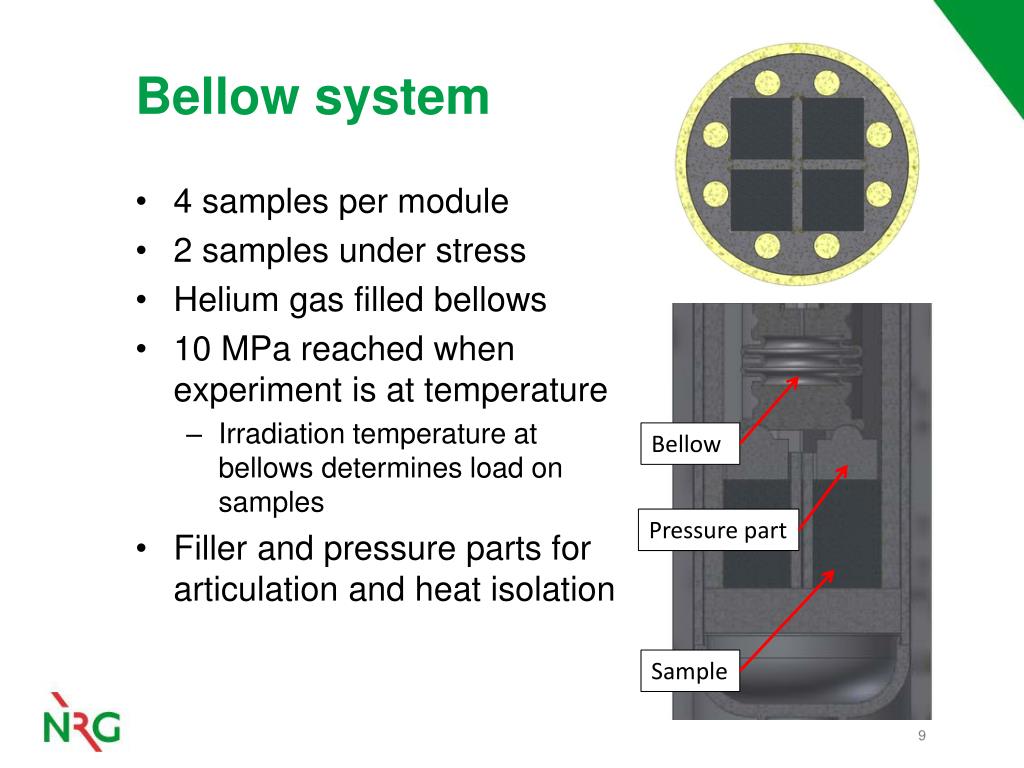

  9. Bellow system • 4 samples per module • 2 samples under stress • Helium gas filledbellows • 10 MPareachedwhen experiment is at temperature • Irradiationtemperature at bellowsdetermines load on samples • Filler andpressurepartsforarticulationand heat isolation Bellow Pressure part Sample

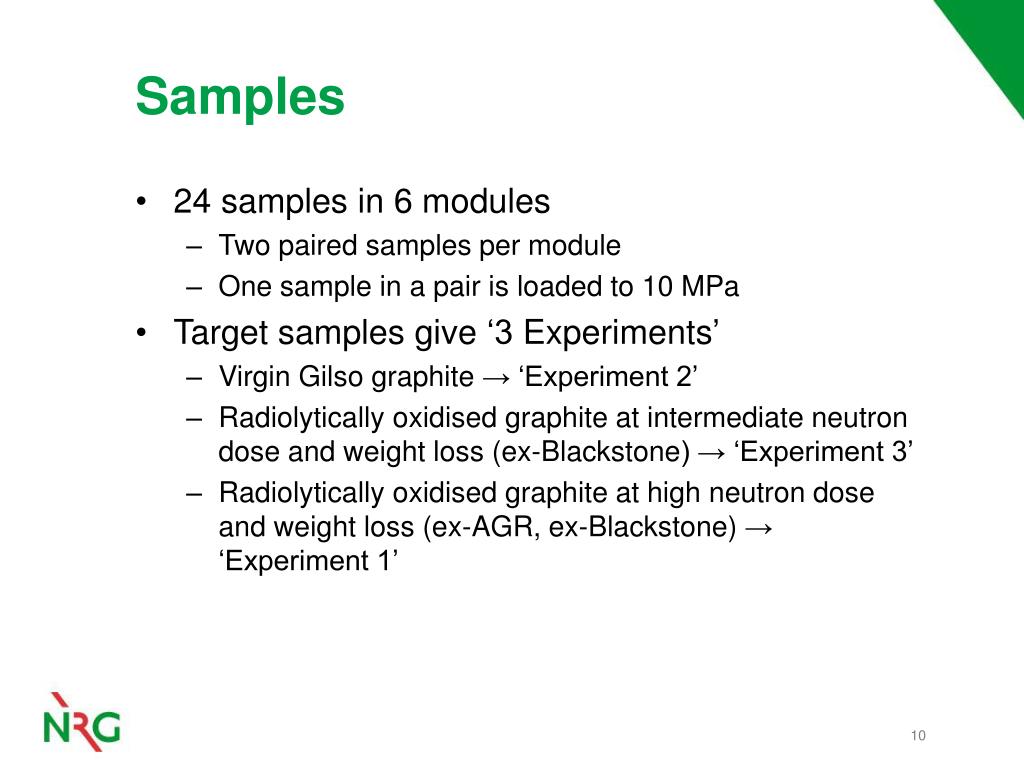

  10. Samples • 24 samples in 6 modules • Twopaired samples per module • One sample in a pair is loadedto 10 MPa • Target samples give ‘3 Experiments’ • Virgin Gilsographite → ‘Experiment 2’ • Radiolyticallyoxidisedgraphite at intermediate neutron doseandweightloss (ex-Blackstone) → ‘Experiment 3’ • Radiolyticallyoxidisedgraphite at high neutron doseandweightloss (ex-AGR, ex-Blackstone) → ‘Experiment 1’

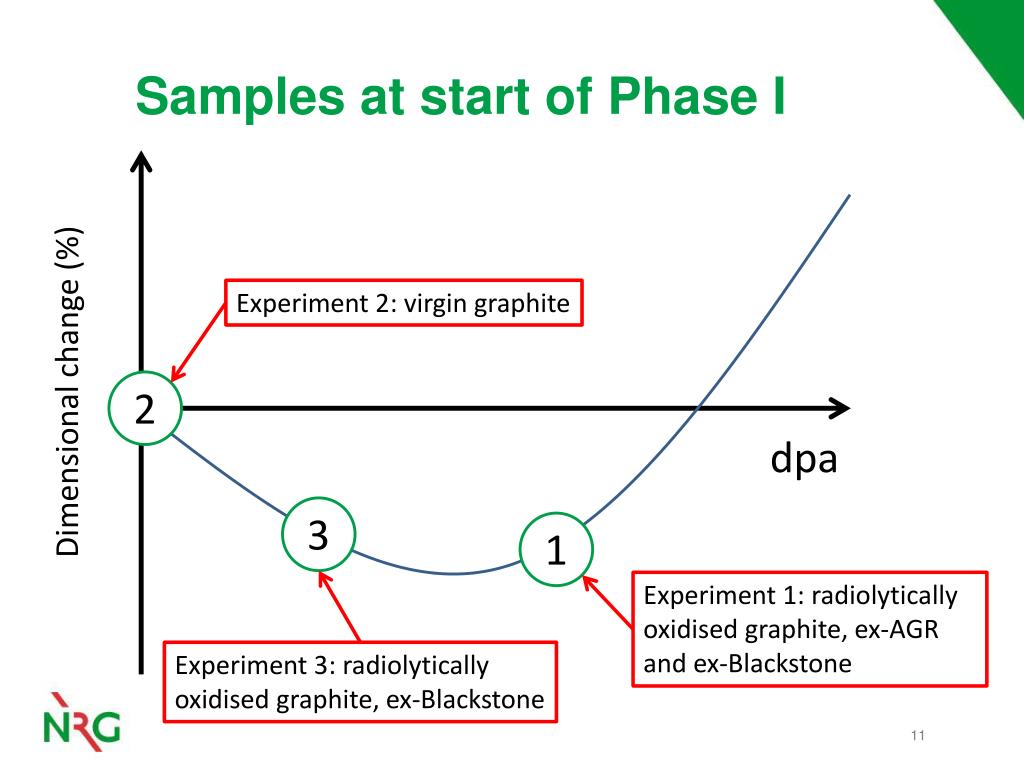

  11. Samples at start of Phase I Experiment 2: virgin graphite Dimensional change (%) 2 dpa 3 1 Experiment 1: radiolyticallyoxidised graphite, ex-AGR and ex-Blackstone Experiment 3: radiolyticallyoxidised graphite, ex-Blackstone

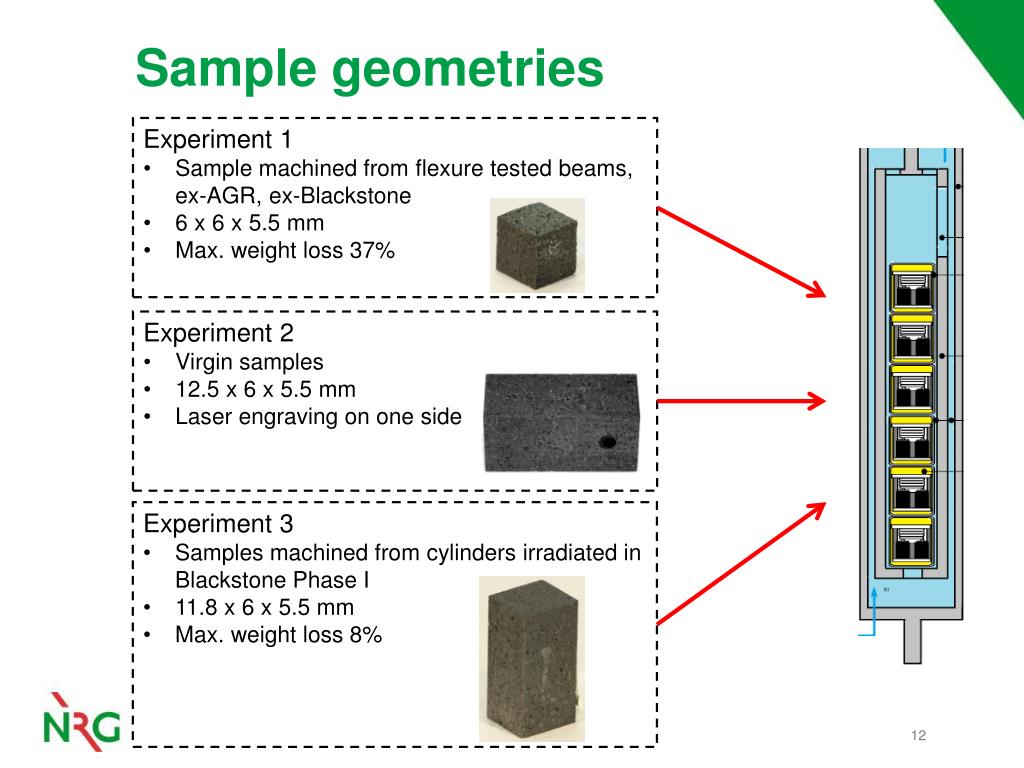

  12. Sample geometries • Experiment 1 • Sample machined from flexure tested beams, ex-AGR, ex-Blackstone • 6 x 6 x 5.5 mm • Max. weight loss 37% • Experiment 2 • Virgin samples • 12.5 x 6 x 5.5 mm • Laser engraving on one side • Experiment 3 • Samples machined from cylinders irradiated in Blackstone Phase I • 11.8 x 6 x 5.5 mm • Max. weight loss 8%

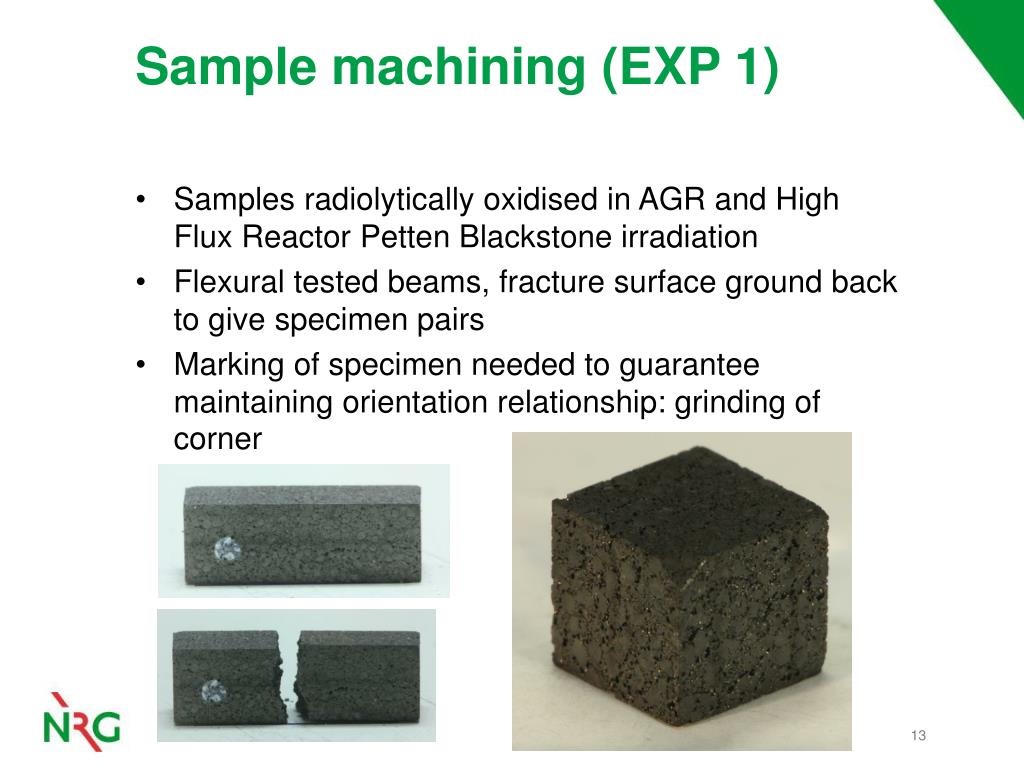

  13. Sample machining (EXP 1) • Samples radiolyticallyoxidised in AGR and High Flux Reactor Petten Blackstone irradiation • Flexural tested beams, fracture surface ground back to give specimen pairs • Marking of specimen needed to guarantee maintaining orientation relationship: grinding of corner

  14. Pre-characterisation After pre-stress testing Before pre-stress testing Pre-stress testing • Photography • Dimensions • Mass • CTE (3 directions) • DYM (3 directions) • Electrical resistivity • ‘Standard’ XRD • XRD texture • Tomography • Loading samples to 10 MPa • DIC data recording • Photography • Dimensions • Mass • CTE (3 directions) • DYM (3 directions) • Electrical resistivity • ‘Standard’ XRD • XRD texture • Tomography 10 MPa

  15. Assembly • Module partsandradioactive samples assembled in glove box • Bellowspressurisedwith helium • Orbital welding of modules • Leaktightnesstesting

  16. Phase I irradiation • Irradiationfrom 13 Julyto 6 August 2013 • dpa target reached: 0.7 dpa • Stabletemperaturesthroughoutirradiation • Analysis SiCtemperature monitor ongoing • AnnealSiC monitors at increasingtemperatures • Measureelectricalresistivity of SiCaftereachannealing step

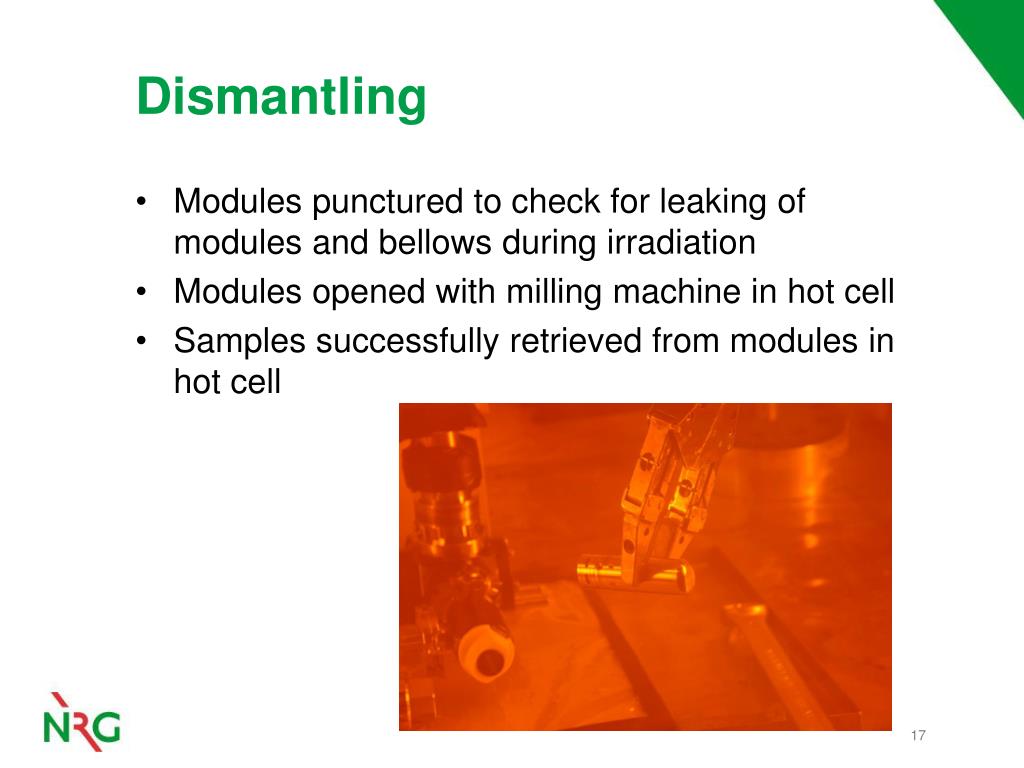

  17. Dismantling • Modules puncturedto check forleaking of modules andbellowsduringirradiation • Modules openedwithmilling machine in hot cell • Samples successfullyretrievedfrom modules in hot cell

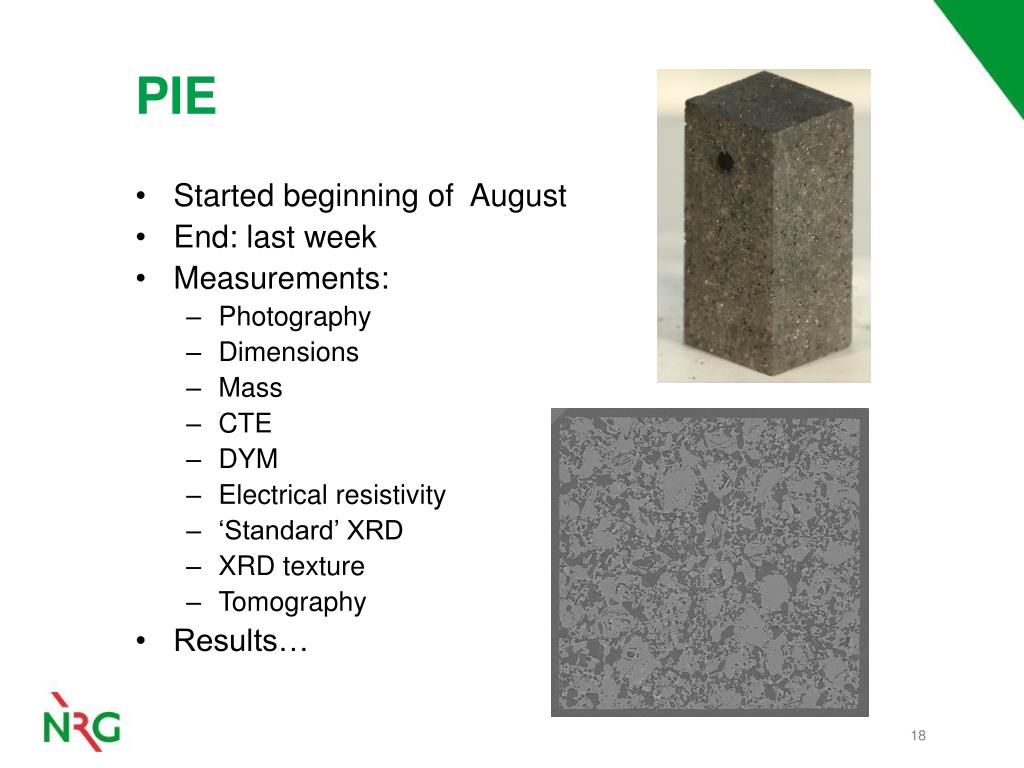

  18. PIE • Startedbeginning of August • End: last week • Measurements: • Photography • Dimensions • Mass • CTE • DYM • Electrical resistivity • ‘Standard’ XRD • XRD texture • Tomography • Results…

  19. Next steps • Continue assessment of Phase I irradiation • Analysis of SiCtemperature monitor sets • Analysis of neutron dosimetry sets • Report post-irradiationcharacterisationmeasurements • Assemble ACCENT Phase II irradiation experiment • Start Phase II irradiation

  20. Conclusions • Successfullmachiningand pre-characterisation of radiolyticallyoxidisedgraphite samples • Phase I irradiationcompleted: • dpa target reached • Stabletemperaturesthroughoutirradiation • Confirmation of irradiationtemperature on-going • Successfullcompletion of PIE measurements • Project on scheduleforPhase II irradiation
