Chilmark
DESCRIPTION
Chilmark. Menemsha Harbor Phase 3. Menemsha Boathouse Fire July 2010. PHASE 1 - 2010. Removal of fire damaged facilities and installation of Concrete Floating Dock. PHASE 2 - 2011. Construction of Pier Connector and Utilities. PHASE 3 – FALL 2012.
1 / 17
Télécharger la présentation
Chilmark
An Image/Link below is provided (as is) to download presentation
Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author.
Content is provided to you AS IS for your information and personal use only.
Download presentation by click this link.
While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server.
During download, if you can't get a presentation, the file might be deleted by the publisher.
E N D
Presentation Transcript

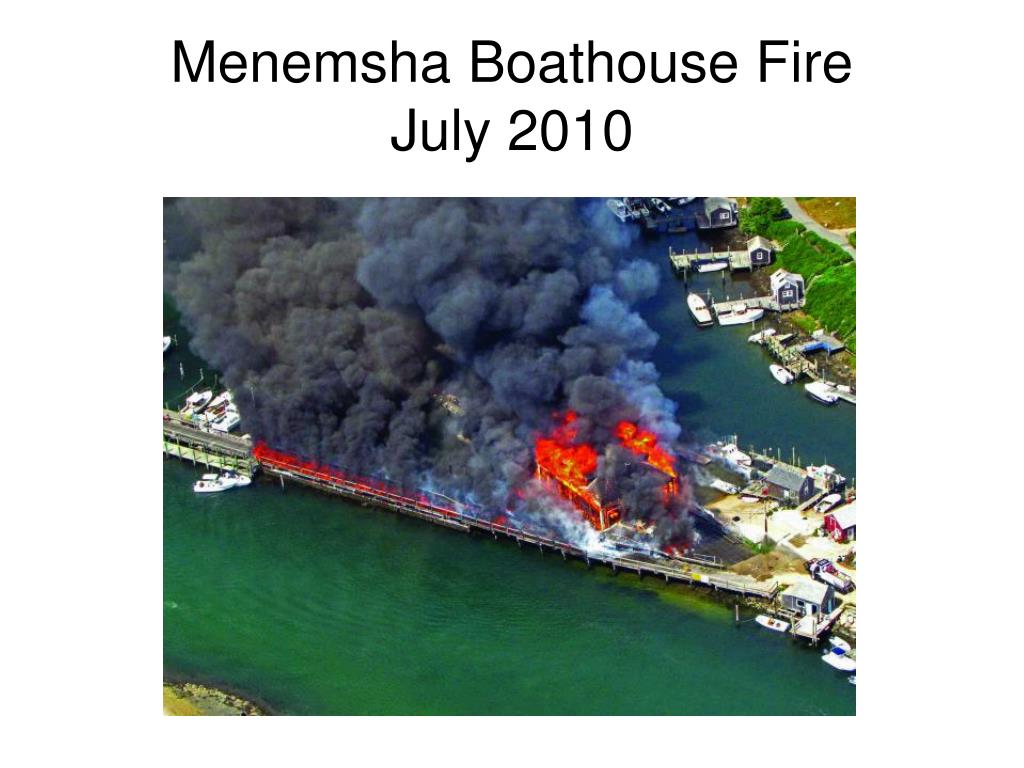

Chilmark Menemsha Harbor Phase 3

PHASE 1 - 2010 Removal of fire damaged facilities and installation of Concrete Floating Dock.

PHASE 2 - 2011 Construction of Pier Connector and Utilities.

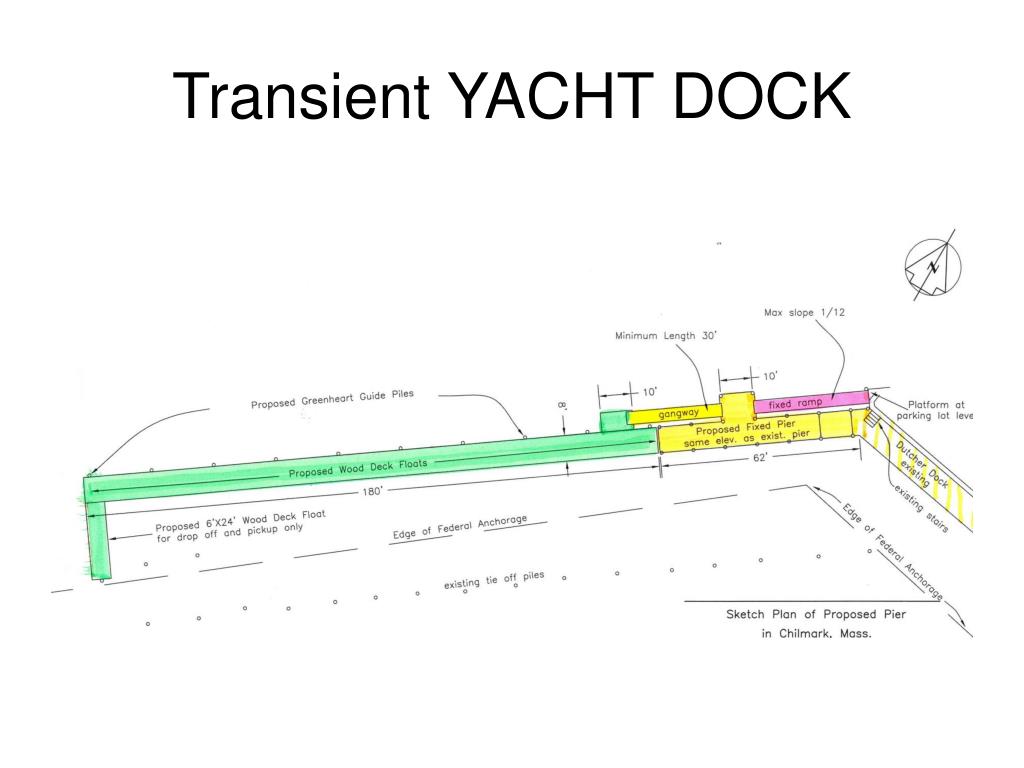

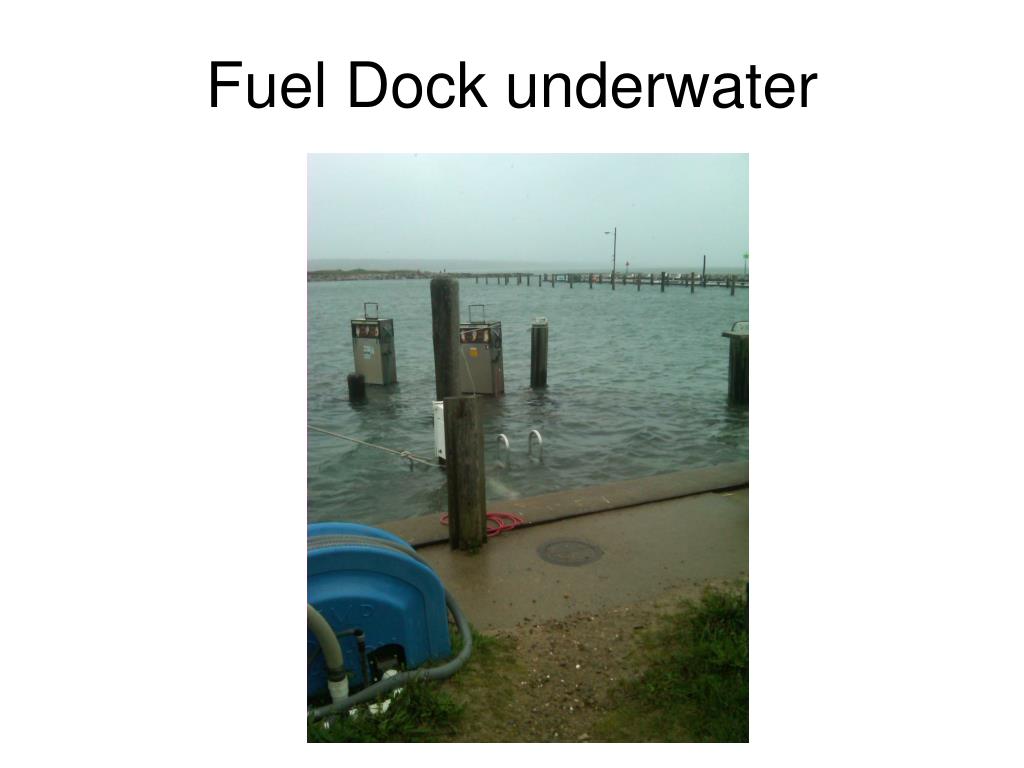

PHASE 3 – FALL 2012 • Replacement of 230 foot Transient Yacht Dock • Replacement of 50 foot Fuel Dock • Various repairs to town docks

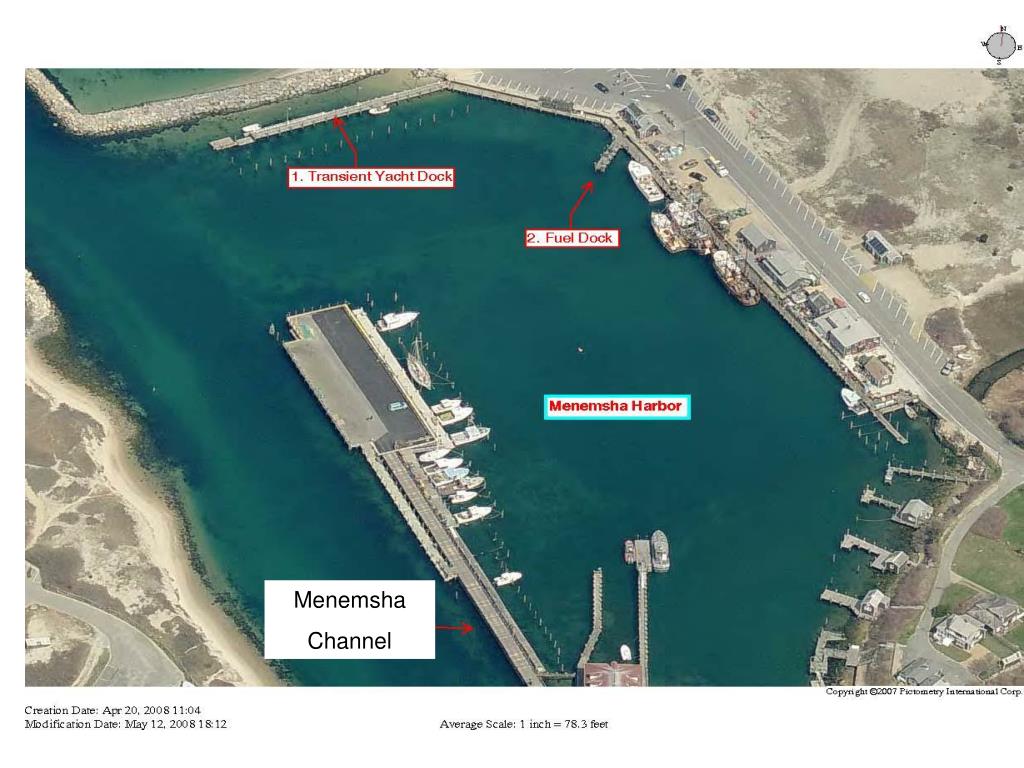

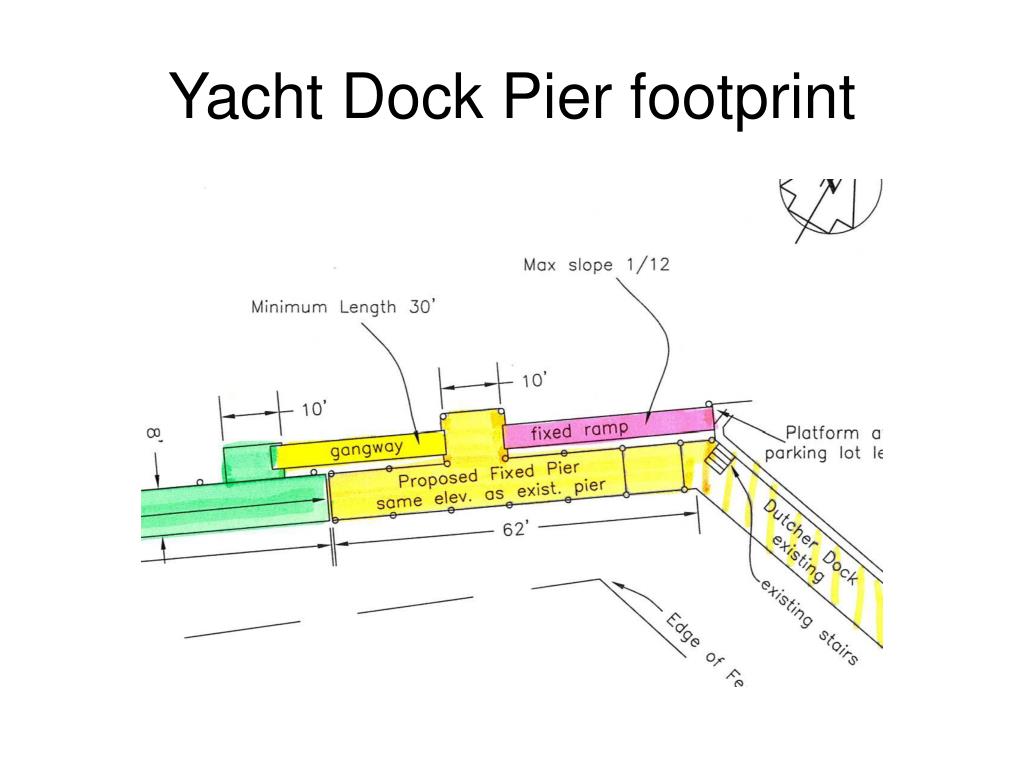

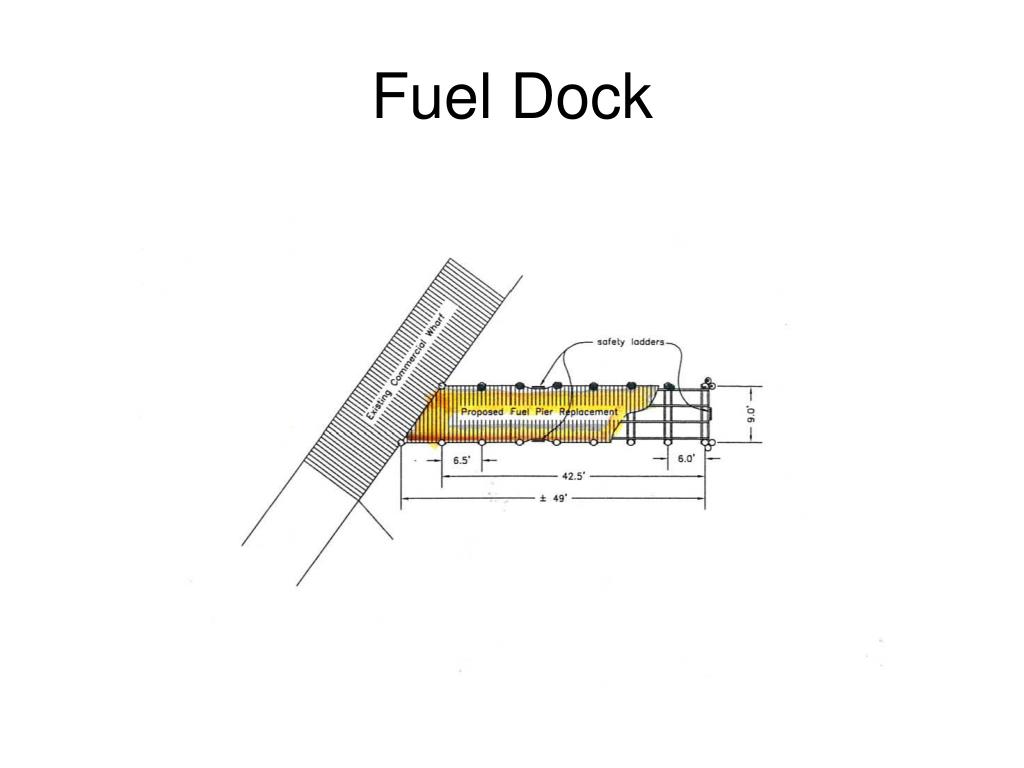

1 Menemsha Harbor Phase 3 LOCATIONS • Transient Dock • Fuel Dock 2
