  1. OMD Operations Metrics Data warehouse -Weekly update meeting 02 November, 2011

  2. OMD 2

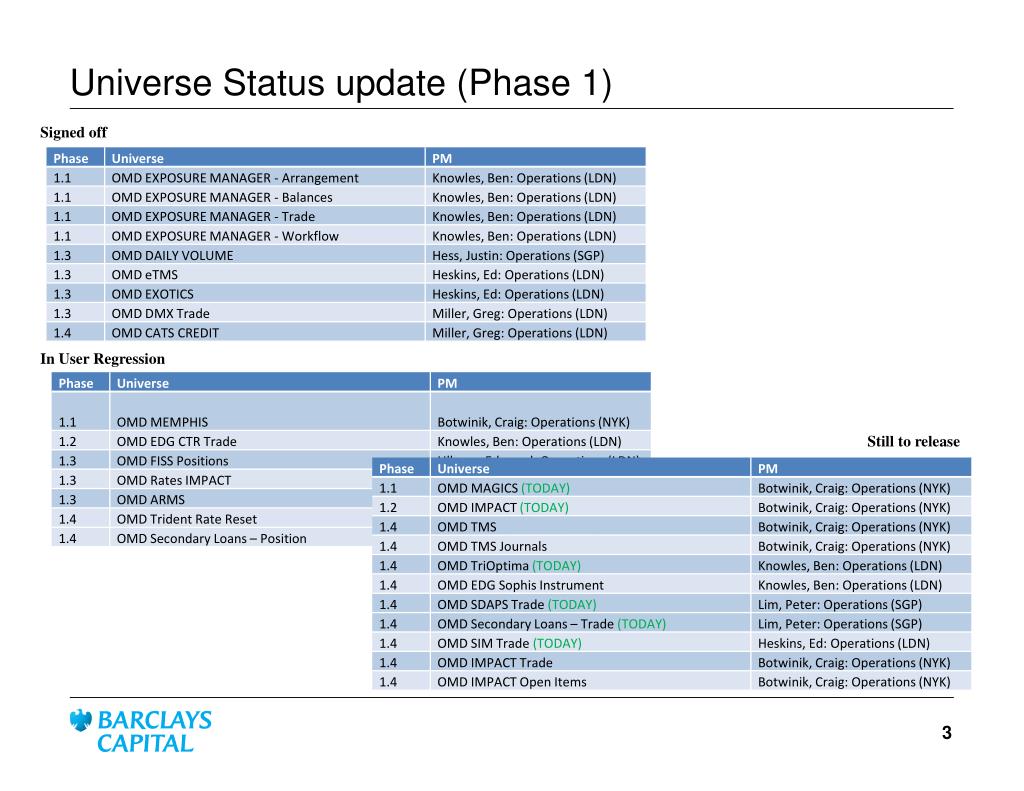

  3. Universe Status update (Phase 1) Signed off In User Regression Still to release

  4. This weeks actions – from 23 November 2011 • Remaining phase 1 universes will be moved to user regression • Phase 2 development has started • Move SecuritiesSettlment into phase 3 • Performance tune • Raise all DRQs once servers on site and space required for production servers • Continue performance tuning techniques in UAT environment

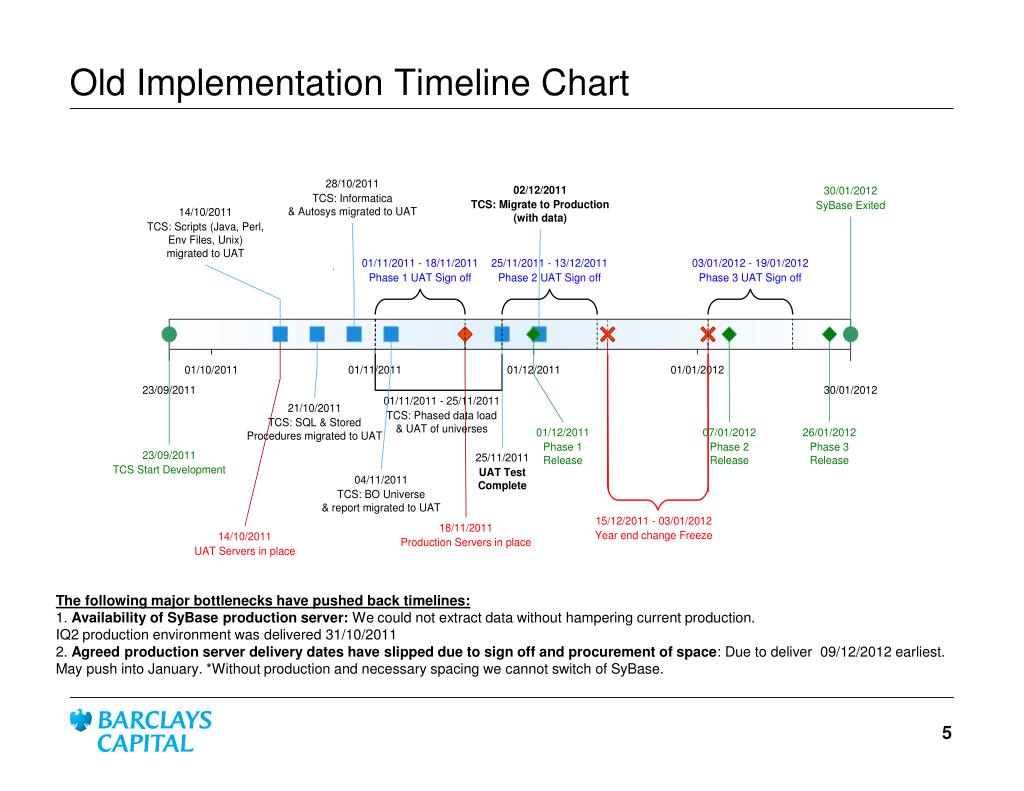

  5. Old Implementation Timeline Chart The following major bottlenecks have pushed back timelines: 1. Availability of SyBase production server: We could not extract data without hampering current production. IQ2 production environment was delivered 31/10/2011 2. Agreed production server delivery dates have slipped due to sign off and procurement of space: Due to deliver 09/12/2012 earliest. May push into January. *Without production and necessary spacing we cannot switch of SyBase.

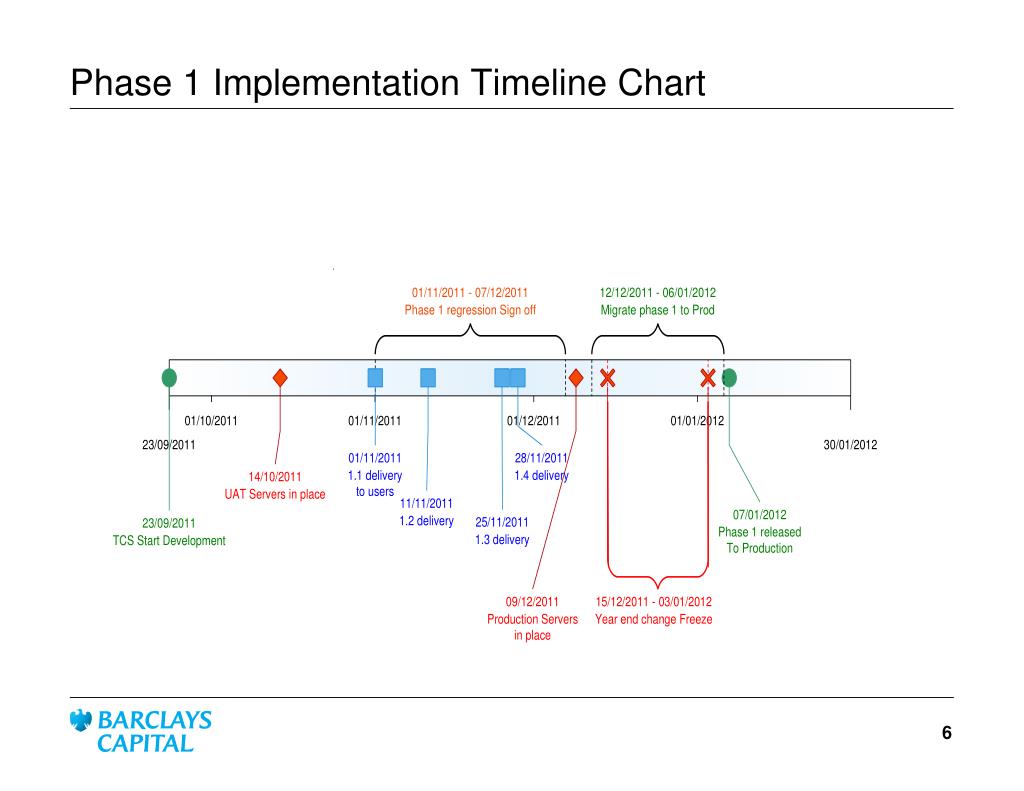

  6. Phase 1 Implementation Timeline Chart

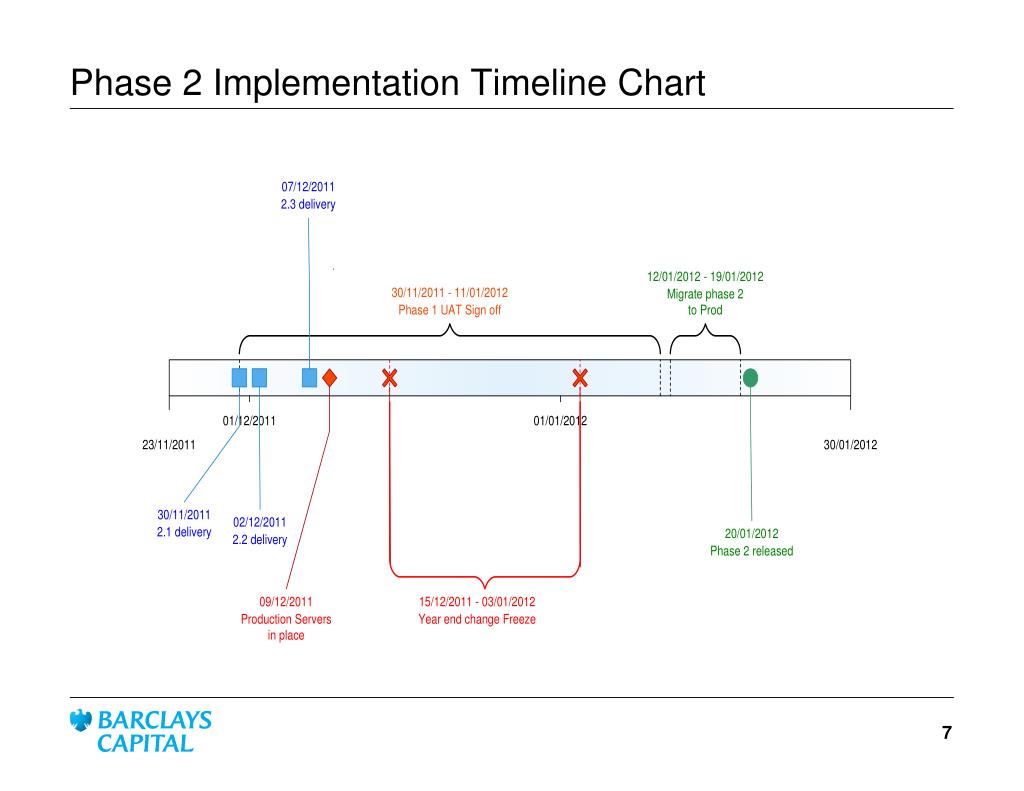

  7. Phase 2 Implementation Timeline Chart

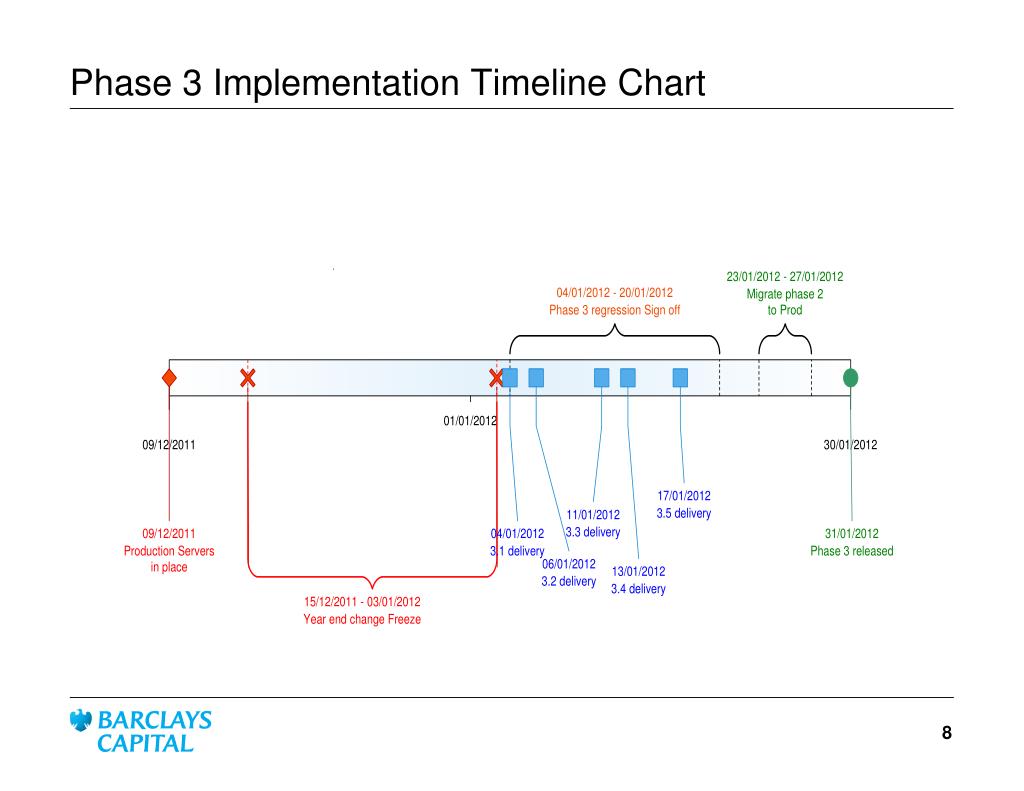

  8. Phase 3 Implementation Timeline Chart
