CD-1 Executive Session LHC CMS Upgrade Project CD-1 Alternative Selection and Cost Range Steve Webster Federal Project Director August 26, 2013

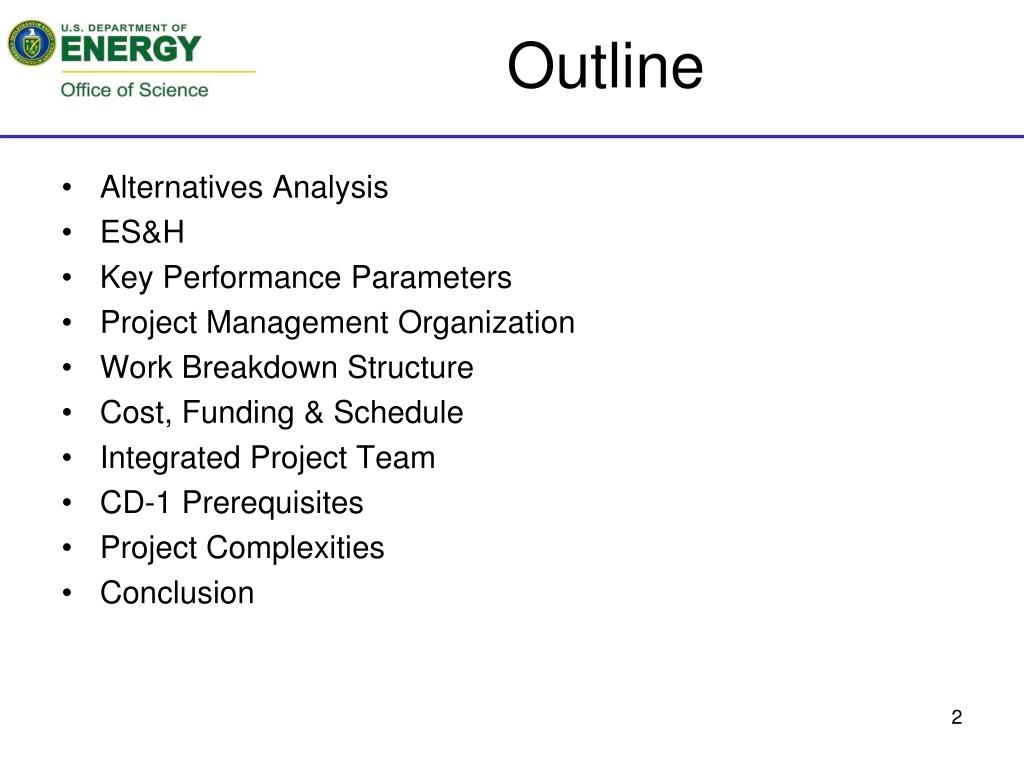

Outline • Alternatives Analysis • ES&H • Key Performance Parameters • Project Management Organization • Work Breakdown Structure • Cost, Funding & Schedule • Integrated Project Team • CD-1 Prerequisites • Project Complexities • Conclusion

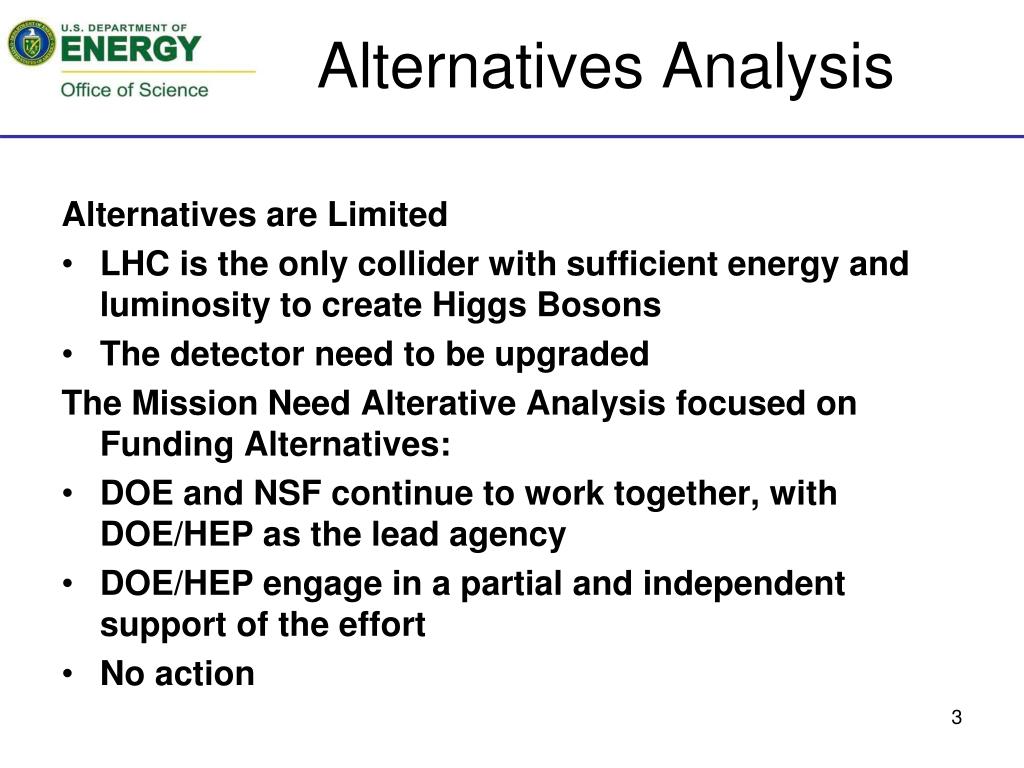

Alternatives Analysis Alternatives are Limited • LHC is the only collider with sufficient energy and luminosity to create Higgs Bosons • The detector need to be upgraded The Mission Need Alterative Analysis focused on Funding Alternatives: • DOE and NSF continue to work together, with DOE/HEP as the lead agency • DOE/HEP engage in a partial and independent support of the effort • No action

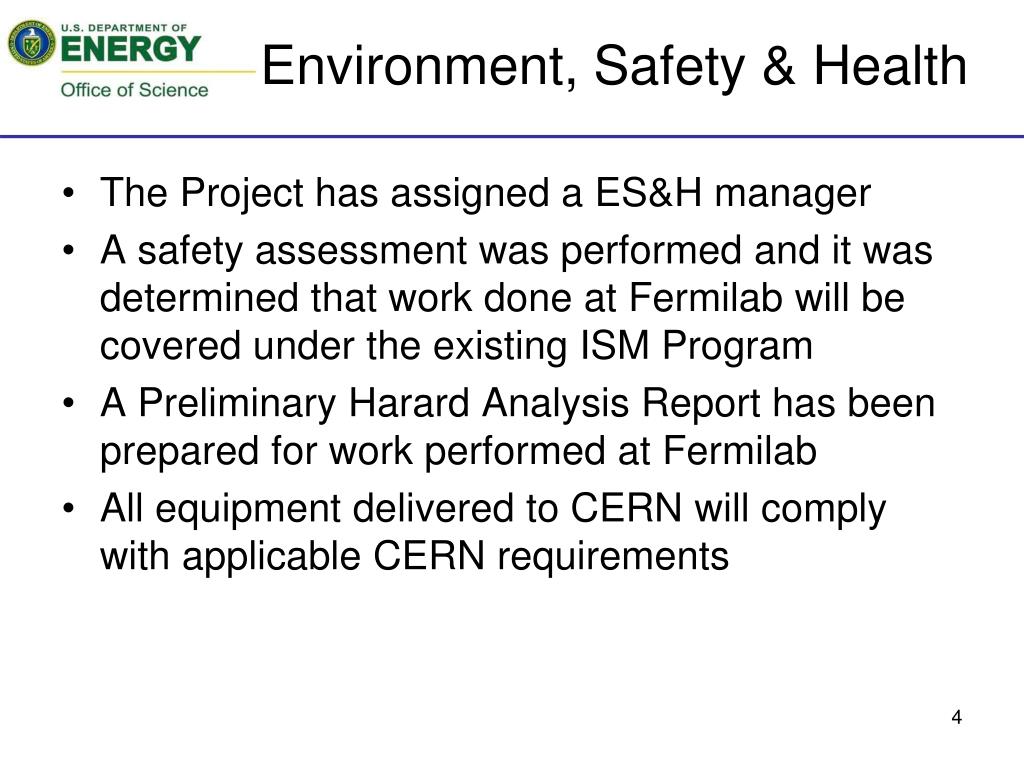

Environment, Safety & Health • The Project has assigned a ES&H manager • A safety assessment was performed and it was determined that work done at Fermilab will be covered under the existing ISM Program • A Preliminary Harard Analysis Report has been prepared for work performed at Fermilab • All equipment delivered to CERN will comply with applicable CERN requirements

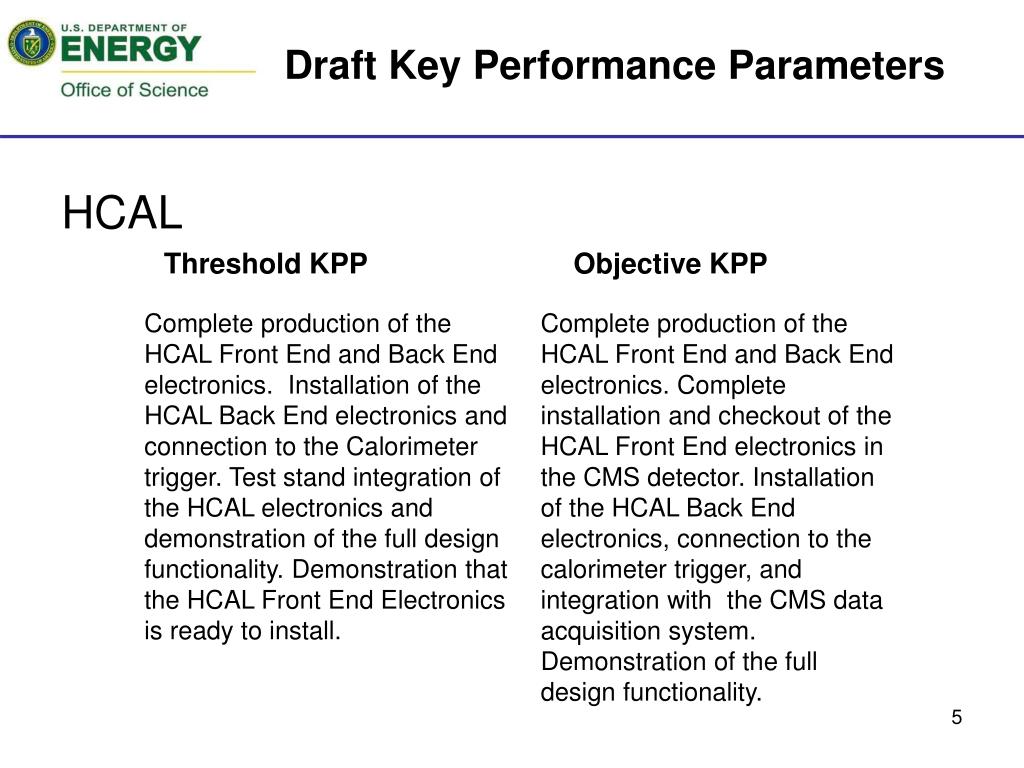

Draft Key Performance Parameters HCAL Threshold KPPObjective KPP

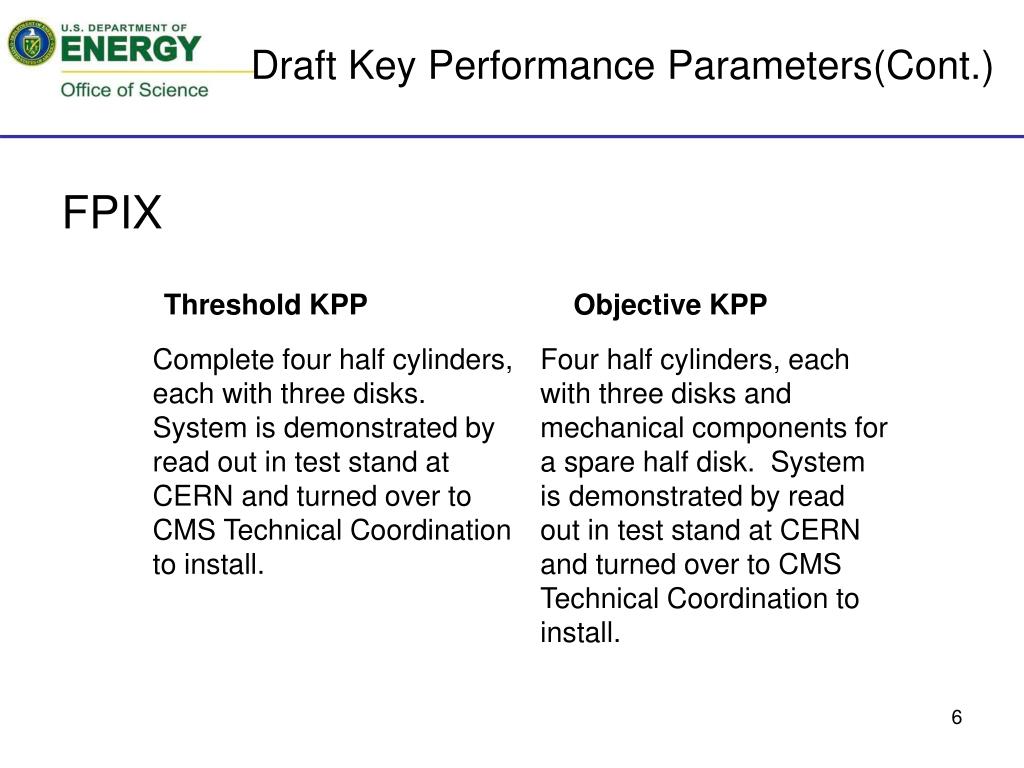

Draft Key Performance Parameters(Cont.) FPIX Threshold KPPObjective KPP

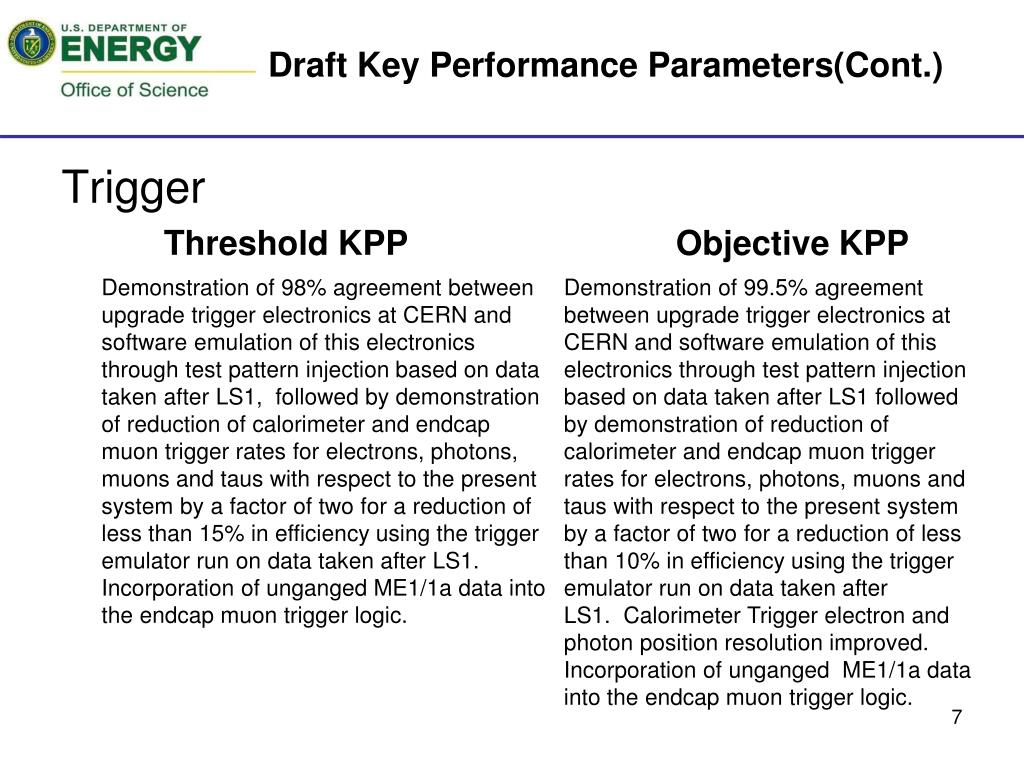

Draft Key Performance Parameters(Cont.) Trigger Threshold KPPObjective KPP

Planned Funding (AY $M) Contingency is $9.0M, 37% (39% of work remaining)

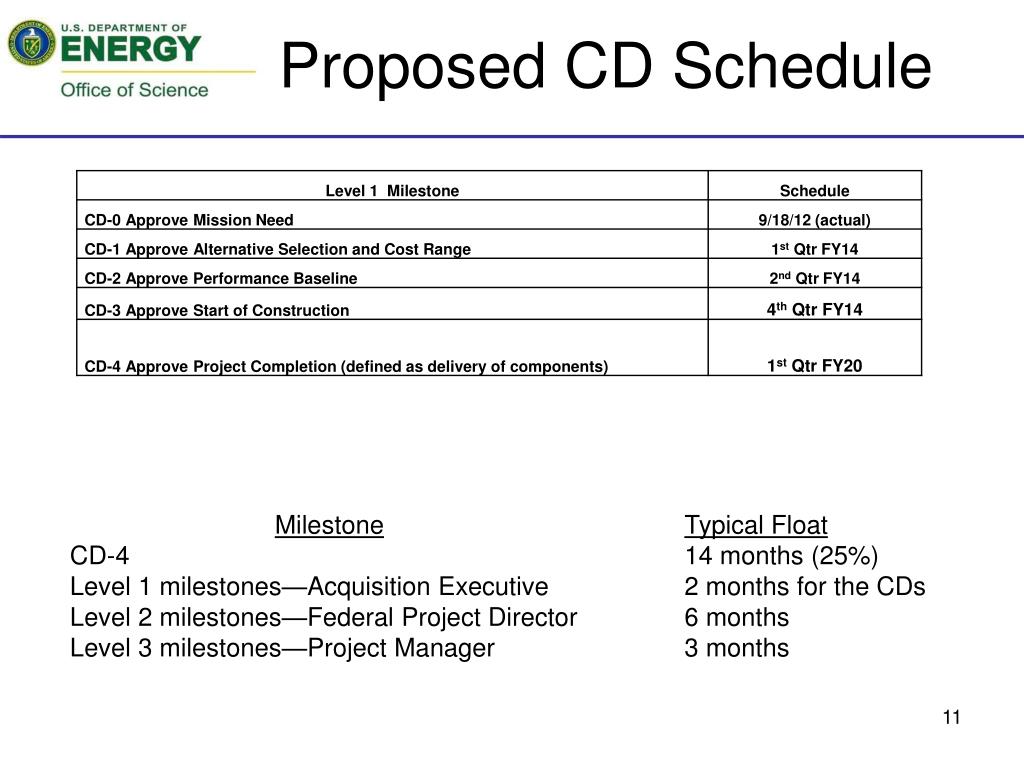

Proposed CD Schedule MilestoneTypical Float CD-4 14 months (25%) Level 1 milestones—Acquisition Executive 2 months for the CDs Level 2 milestones—Federal Project Director 6 months Level 3 milestones—Project Manager 3 months

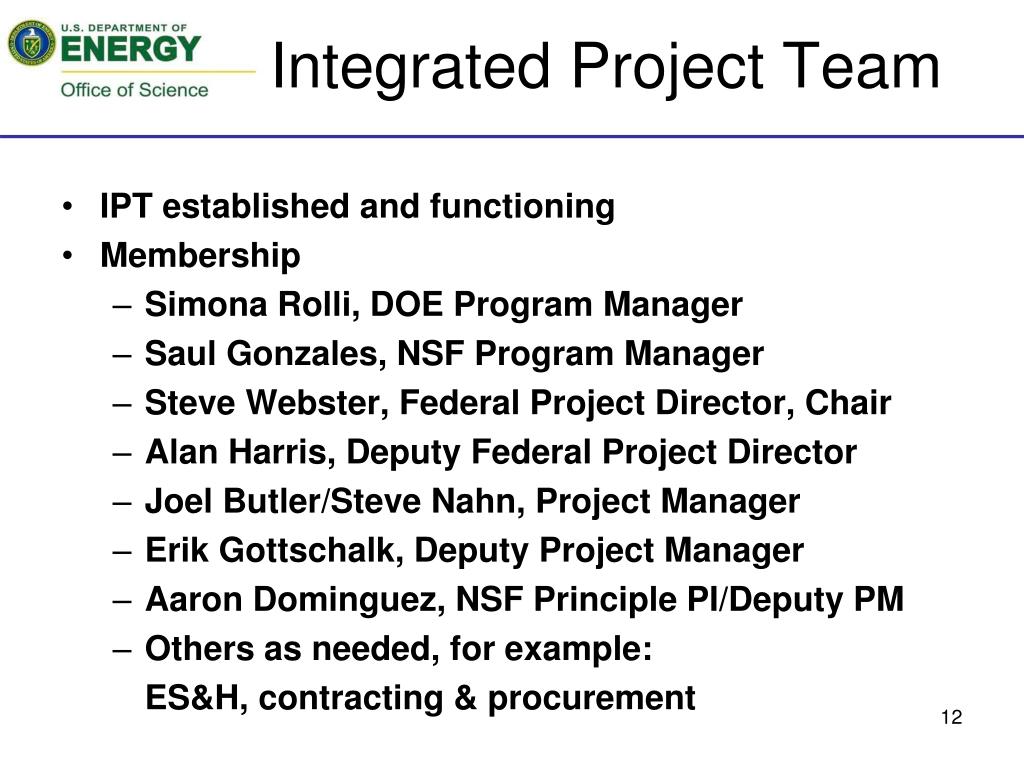

Integrated Project Team • IPT established and functioning • Membership • Simona Rolli, DOE Program Manager • Saul Gonzales, NSF Program Manager • Steve Webster, Federal Project Director, Chair • Alan Harris, Deputy Federal Project Director • Joel Butler/Steve Nahn, Project Manager • Erik Gottschalk, Deputy Project Manager • Aaron Dominguez, NSF Principle PI/Deputy PM • Others as needed, for example: ES&H, contracting & procurement

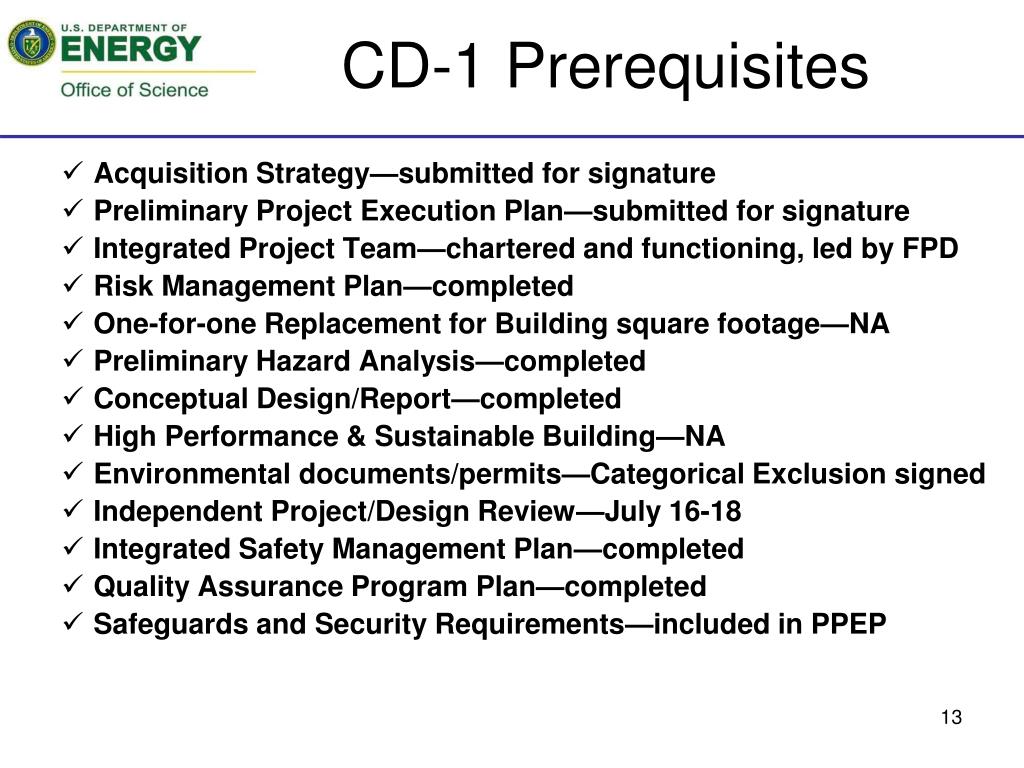

CD-1 Prerequisites • Acquisition Strategy—submitted for signature • Preliminary Project Execution Plan—submitted for signature • Integrated Project Team—chartered and functioning, led by FPD • Risk Management Plan—completed • One-for-one Replacement for Building square footage—NA • Preliminary Hazard Analysis—completed • Conceptual Design/Report—completed • High Performance & Sustainable Building—NA • Environmental documents/permits—Categorical Exclusion signed • Independent Project/Design Review—July 16-18 • Integrated Safety Management Plan—completed • Quality Assurance Program Plan—completed • Safeguards and Security Requirements—included in PPEP
Project Complexities • DOE/NSF/CERN Coordination • CERN Schedule • DOE Funding Profile

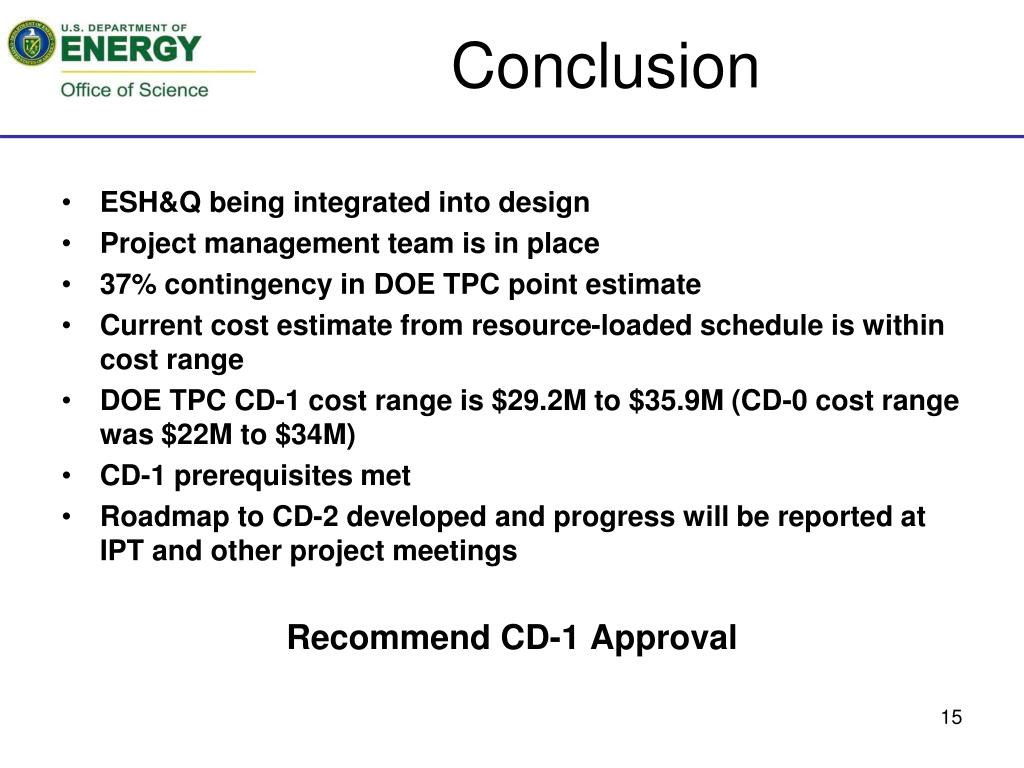

Conclusion • ESH&Q being integrated into design • Project management team is in place • 37% contingency in DOE TPC point estimate • Current cost estimate from resource-loaded schedule is within cost range • DOE TPC CD-1 cost range is $29.2M to $35.9M (CD-0 cost range was $22M to $34M) • CD-1 prerequisites met • Roadmap to CD-2 developed and progress will be reported at IPT and other project meetings Recommend CD-1 Approval
