An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Small Structure Design 101 Purdue University Road School 2011

  2. Small Structure Design 101 Presenters: Mark Williams, PE INDOT Design, Vincennes District Richard Thomas, PE INDOT Design, Vincennes District

  3. Site Criteria • A culvert should be used • Where a bridge is not hydraulically required. • Where debris and ice are tolerable. • Where it is more economical than a bridge.

  4. Site Criteria (Cont.) • Length and Slope • Approximate existing topography. • Invert should be aligned with channel bottom and skew angle of stream. • Clear-zone and embankment geometry may dictate length.

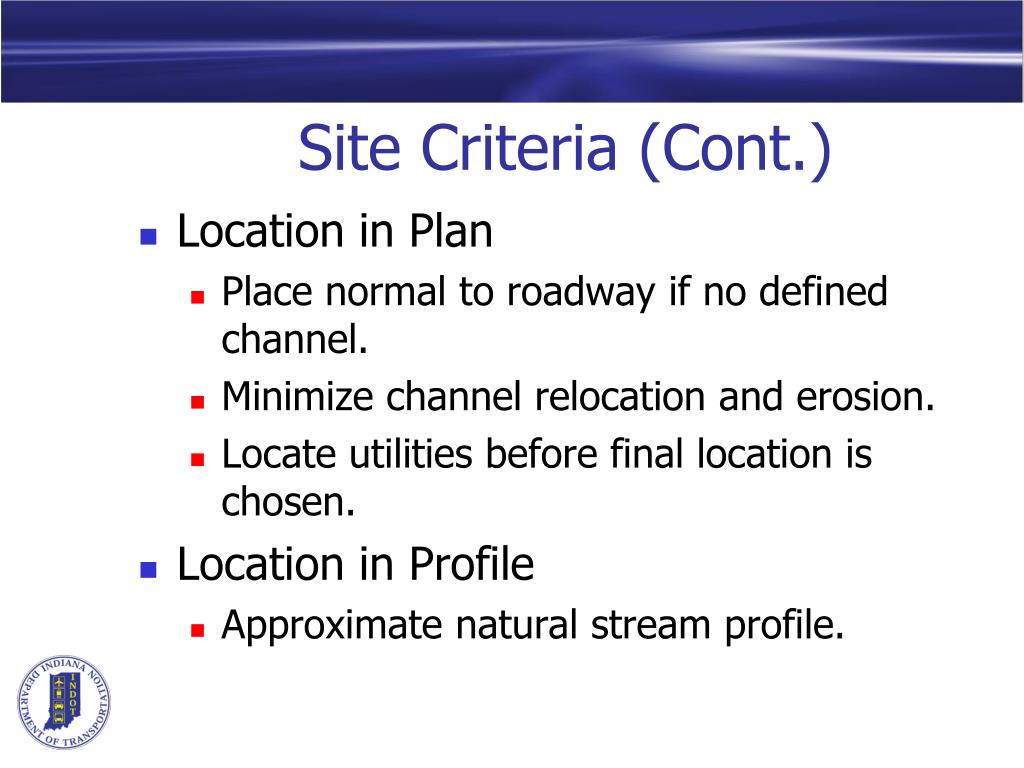

  5. Site Criteria (Cont.) • Location in Plan • Place normal to roadway if no defined channel. • Minimize channel relocation and erosion. • Locate utilities before final location is chosen. • Location in Profile • Approximate natural stream profile.

  6. Hydraulic Design Criteria • Allowable Headwater (AHW) • Roadway Serviceability • Maximum Velocity • Minimum Velocity

  7. Allowable Headwater (AHW) • New Alignment • 1.5 in. Maximum Backwater. • Exceptions • Backwater Dissipates to 1.5 in. or less at R/W. • Backwater is Contained in the Channel.

  8. Allowable Headwater (Cont.) • Existing Conditions • Proposed Surcharge ≤ Existing Surcharge. • If Existing Surcharge > 1 ft., Proposed must not be > 1 ft. above the Natural Channel Flood Profile.

  9. Allowable Headwater (Cont.) • Right of Way • The Ponding Limit Cannot Exceed the R/W for New Alignment. • Upstream Channel • The Ponding Limit Cannot Exceed the Banks of Upstream Channel for New Alignment.

  10. Allowable Headwater (Cont.) • Other Constraints • Grades of Adjacent Drives. • Finished Floor Elevations of Buildings. • Elevation of Existing Cropland or Other Property.

  11. Design Storm Frequency

  12. Roadway Serviceability • For Q100 Design Storm • Headwater must be at least 2 ft below edge of pavement • For Design Storm less than Q100 • Headwater cannot exceed edge of pavement

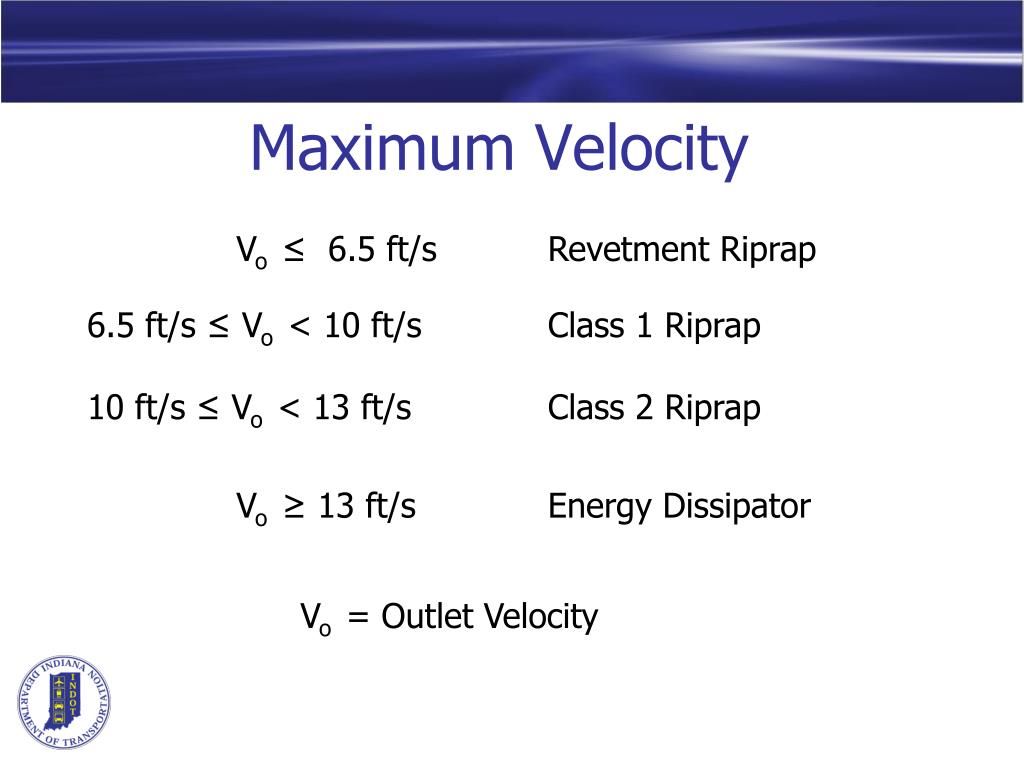

  13. Maximum Velocity Vo = Outlet Velocity

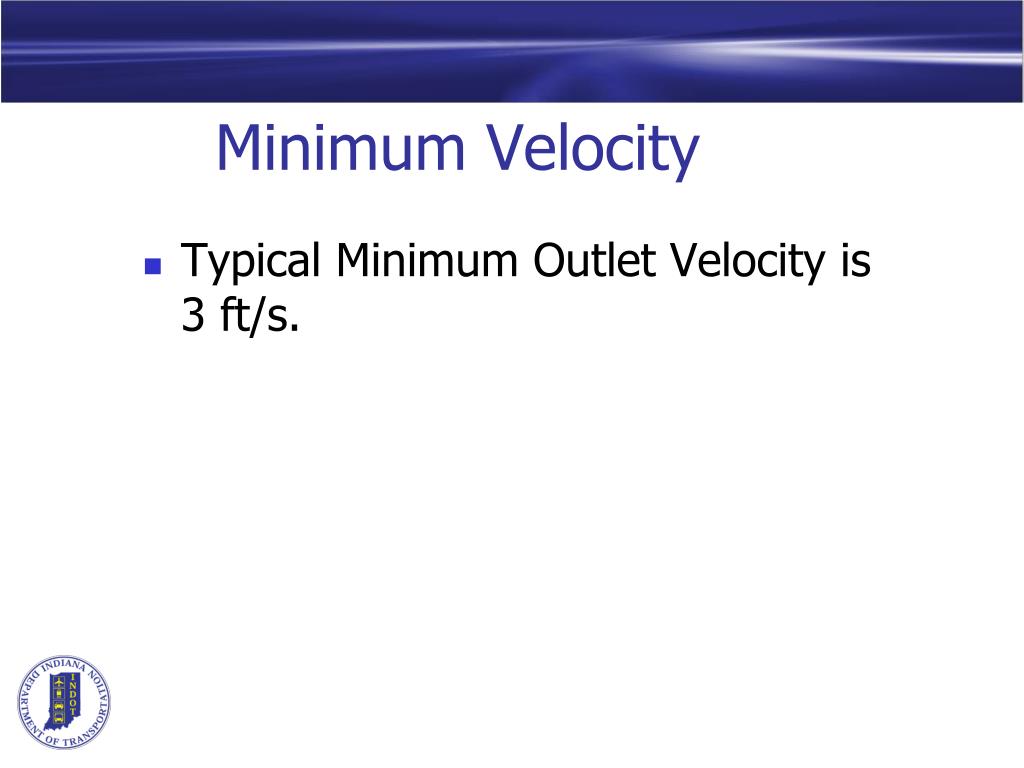

  14. Minimum Velocity • Typical Minimum Outlet Velocity is 3 ft/s.

  15. Culvert Sizing Process • Priority System • Interior Designation • Minimum Culvert Size • Cover

  16. Priority System • Trial 1. Single Circular Pipe. • Trial 2. Single Deformed Pipe. • Trial 3. Single Specialty Structure. • Trial 4. Multiple Circular Pipes. • Trial 5. Multiple Deformed Pipes. • Trial 6. Multiple Specialty Structures.

  17. Interior Designation • Run Hydraulic Design for both Smooth Interior and Corrugated Interior. • Four Possible Situations.

  18. Interior Designation (Cont.) • Situation 1. Required Smooth and Corrugated Sizes are Identical. • Situation 2. Required Smooth and Corrugated Sizes are Different. • Situation 3. Acceptable Size for one but not the other. • Situation 4. No Acceptable Size.

  19. Minimum Culvert Size

  20. Pipe Cover

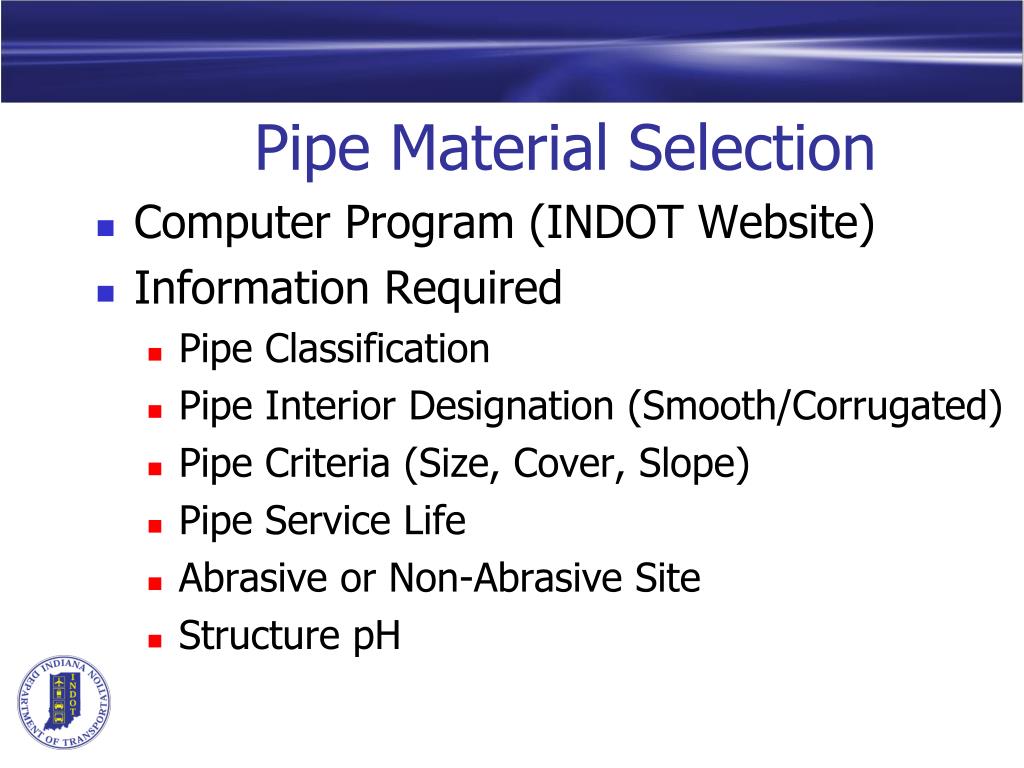

  21. Pipe Material Selection • Computer Program (INDOT Website) • Information Required • Pipe Classification • Pipe Interior Designation (Smooth/Corrugated) • Pipe Criteria (Size, Cover, Slope) • Pipe Service Life • Abrasive or Non-Abrasive Site • Structure pH

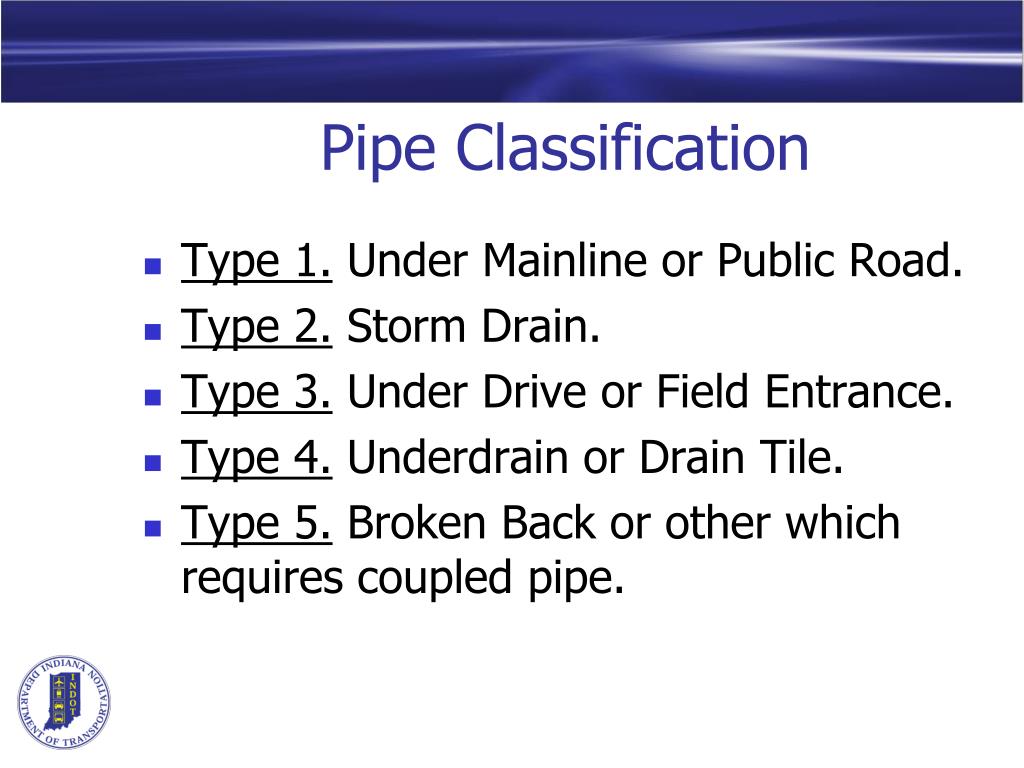

  22. Pipe Classification • Type 1. Under Mainline or Public Road. • Type 2. Storm Drain. • Type 3. Under Drive or Field Entrance. • Type 4. Underdrain or Drain Tile. • Type 5. Broken Back or other which requires coupled pipe.

  23. Pipe Service Life • Based on Functional Classification of Mainline Roadway • 75 Years- Freeway, Expressway, Arterial • 50 Years- Collector or Local Road

  24. Abrasive or Non-Abrasive • Abrasive • Mainline Culvert • Public Road or Drive Culvert Installed in a Natural Channel. • Non-Abrasive • Storm-Drain, Public Road, or Drive Culvert on a Constructed Side Ditch Line.

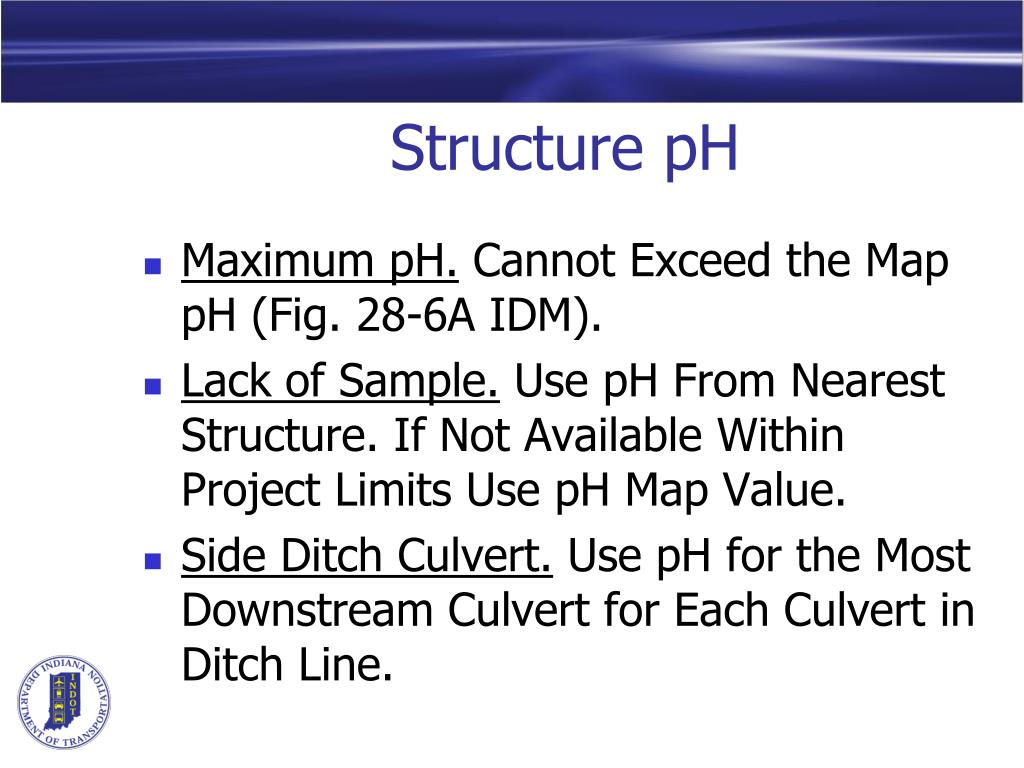

  25. Structure pH • Maximum pH. Cannot Exceed the Map pH (Fig. 28-6A IDM). • Lack of Sample. Use pH From Nearest Structure. If Not Available Within Project Limits Use pH Map Value. • Side Ditch Culvert. Use pH for the Most Downstream Culvert for Each Culvert in Ditch Line.

  26. Plans • Plan & Profile Sheet. Appropriate Location for Drainage Structure Identification. • Detail Sheet. Detail Drainage Structures and Features that are not included in the Standard Drawings.

  27. Plans (Cont.) • Structure Data Sheet. • Backfill Method, Structure Backfill (CYS), Type. • Flowable Backfill (CYS), Type. • Scour Protection Information • Sump Depth (IN), Geotextile (SYS), • Riprap (Type & Tons) • Video Inspection Length. • Pipe Material Sheet. List Acceptable Pipe Materials for each Pipe Structure.

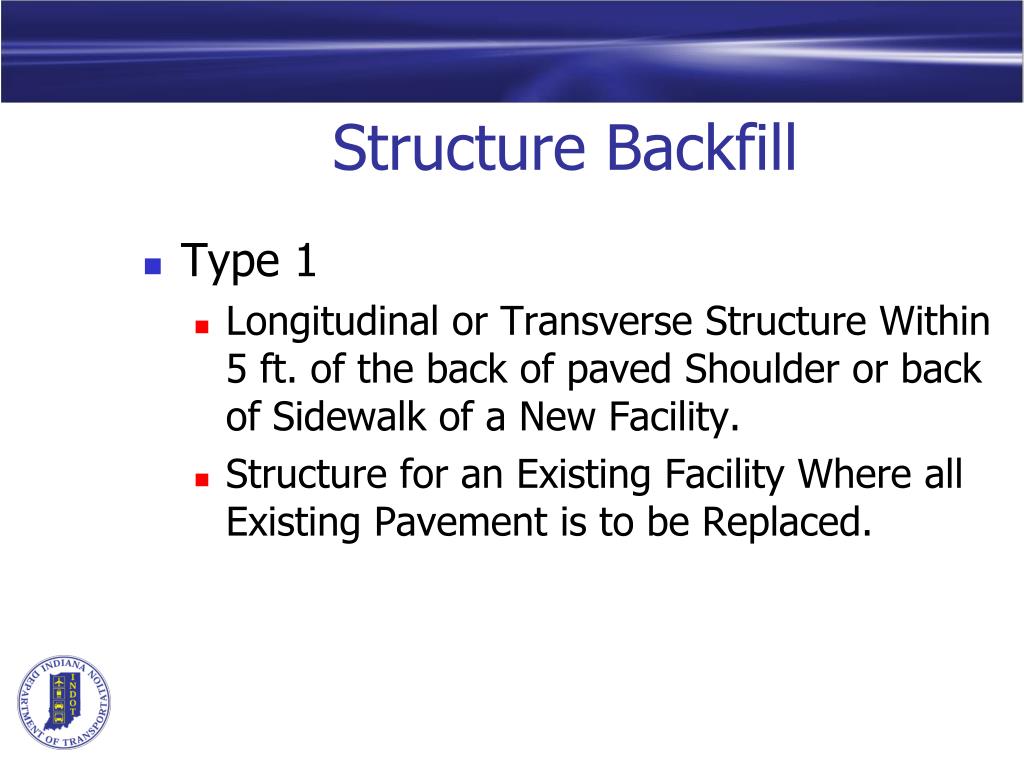

  28. Structure Backfill • Type 1 • Longitudinal or Transverse Structure Within 5 ft. of the back of paved Shoulder or back of Sidewalk of a New Facility. • Structure for an Existing Facility Where all Existing Pavement is to be Replaced.

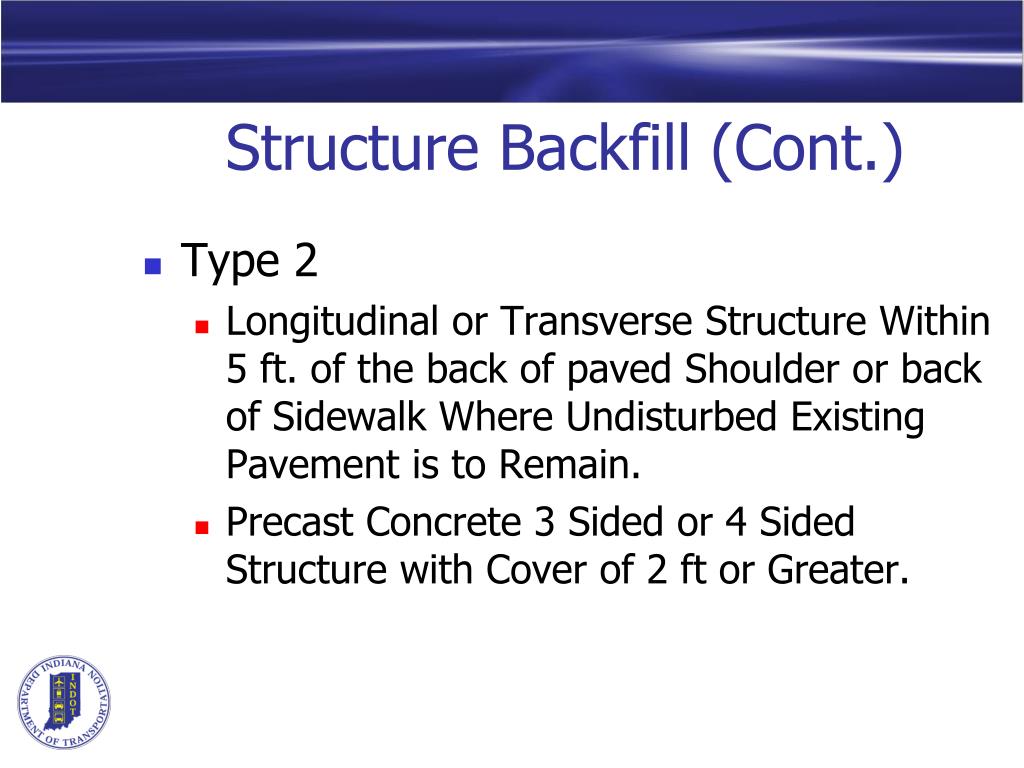

  29. Structure Backfill (Cont.) • Type 2 • Longitudinal or Transverse Structure Within 5 ft. of the back of paved Shoulder or back of Sidewalk Where Undisturbed Existing Pavement is to Remain. • Precast Concrete 3 Sided or 4 Sided Structure with Cover of 2 ft or Greater.

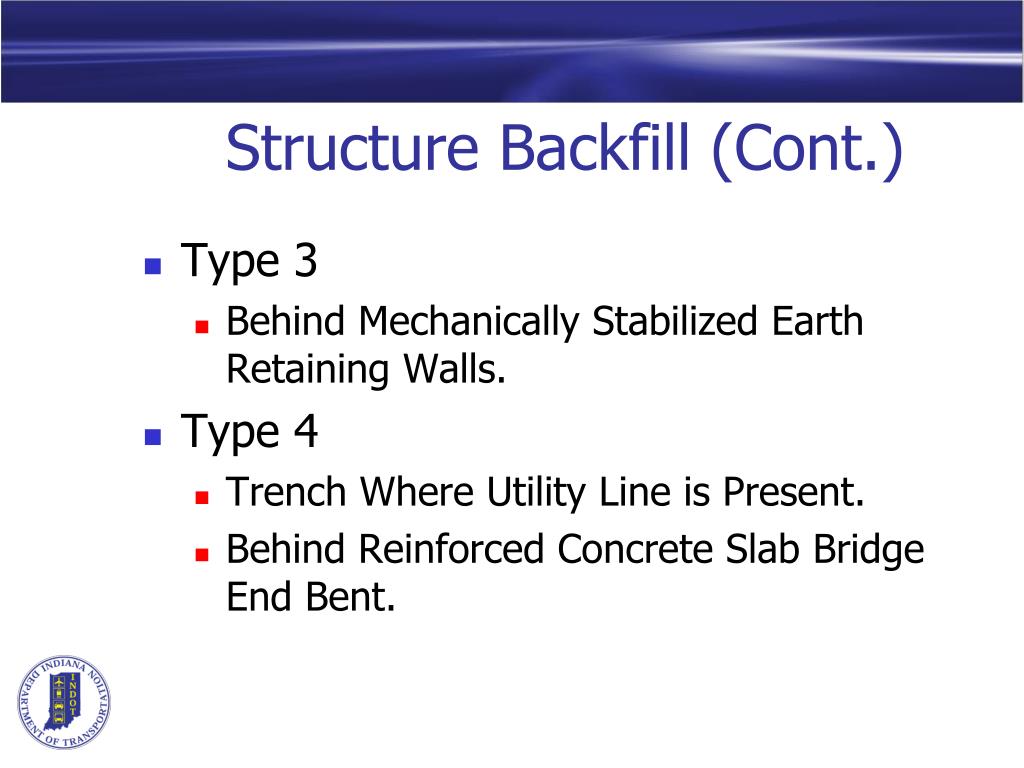

  30. Structure Backfill (Cont.) • Type 3 • Behind Mechanically Stabilized Earth Retaining Walls. • Type 4 • Trench Where Utility Line is Present. • Behind Reinforced Concrete Slab Bridge End Bent.

  31. Structure Backfill (Cont.) • Type 5 • Precast Concrete 3 Sided or 4 Sided Structure with Cover Less than 2 ft. • Filling Voids in an Underground Facility. • Filling an Abandoned Pipe or Structure. • Other Application that does not Require Excavation.

  32. Backfill Methods • Method 1 • Under New or Replacement Mainline or Public Road. • Under Median Embankment. • New Structure Under Existing Mainline or Public Road.

  33. Backfill Methods (Cont.) • Method 2 • Placed Under a Drive in New or Replacement Work. • Method 3 • Under New or Replacement Median Trench.

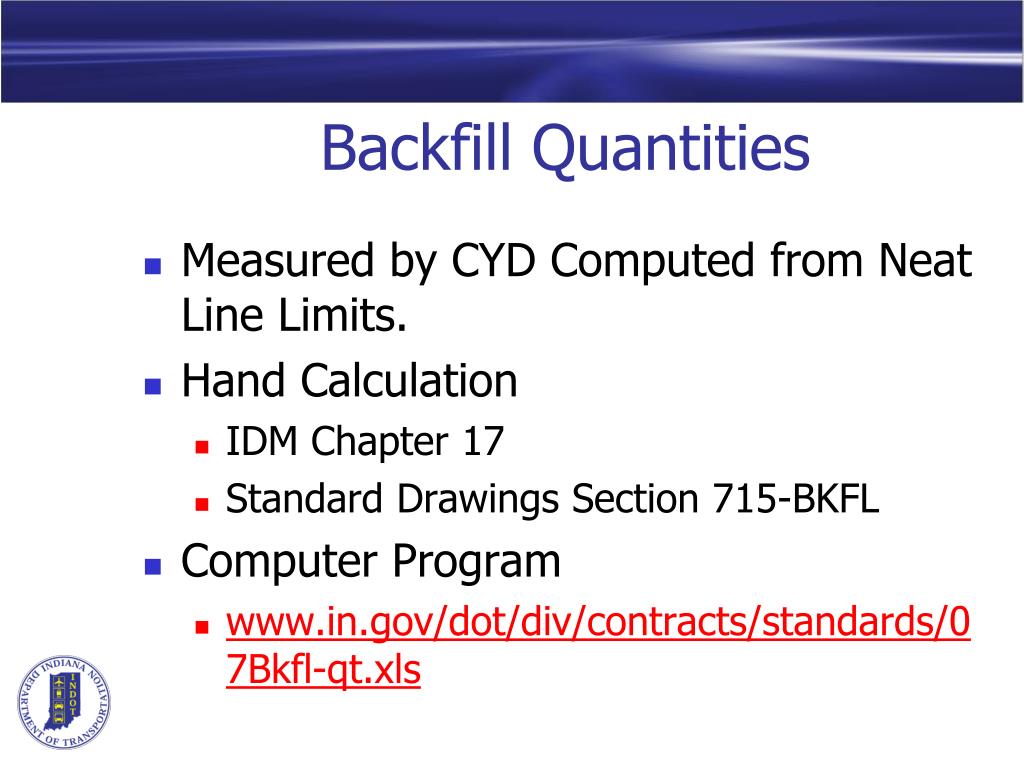

  34. Backfill Quantities • Measured by CYD Computed from Neat Line Limits. • Hand Calculation • IDM Chapter 17 • Standard Drawings Section 715-BKFL • Computer Program • www.in.gov/dot/div/contracts/standards/07Bkfl-qt.xls

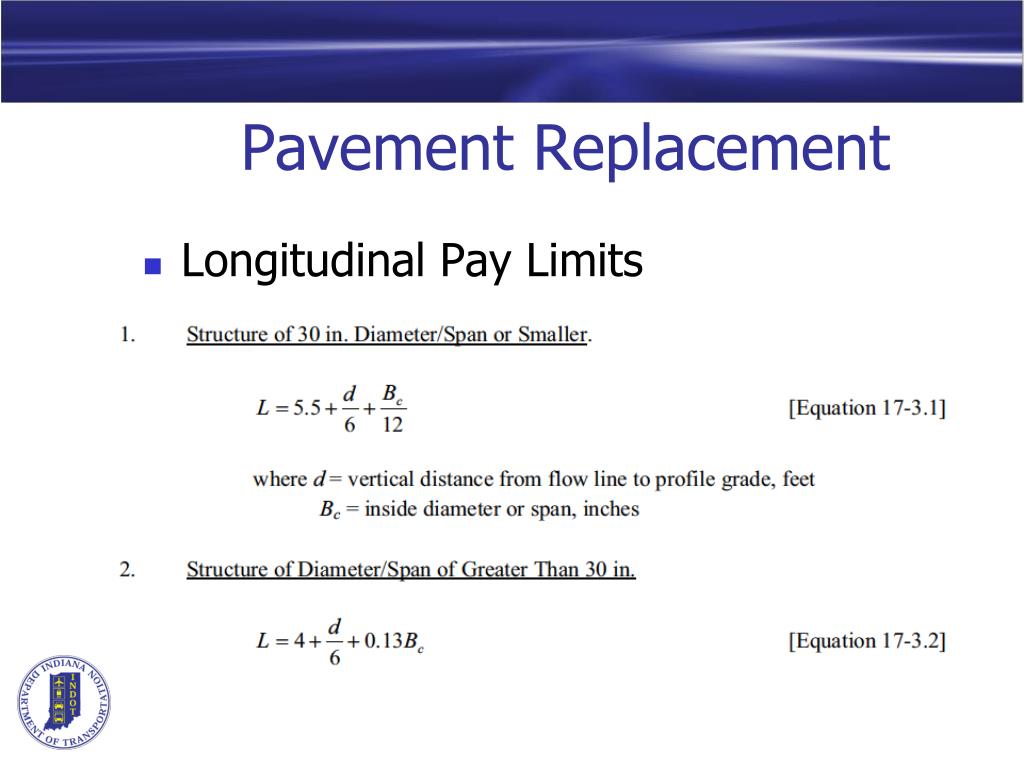

  35. Pavement Replacement • Longitudinal Pay Limits

  36. Pipe Under Existing Roadway

  37. Culvert Modifications • Culvert Slip Lining • Culvert Extension • Culvert End Treatment • Headwalls and Anchors

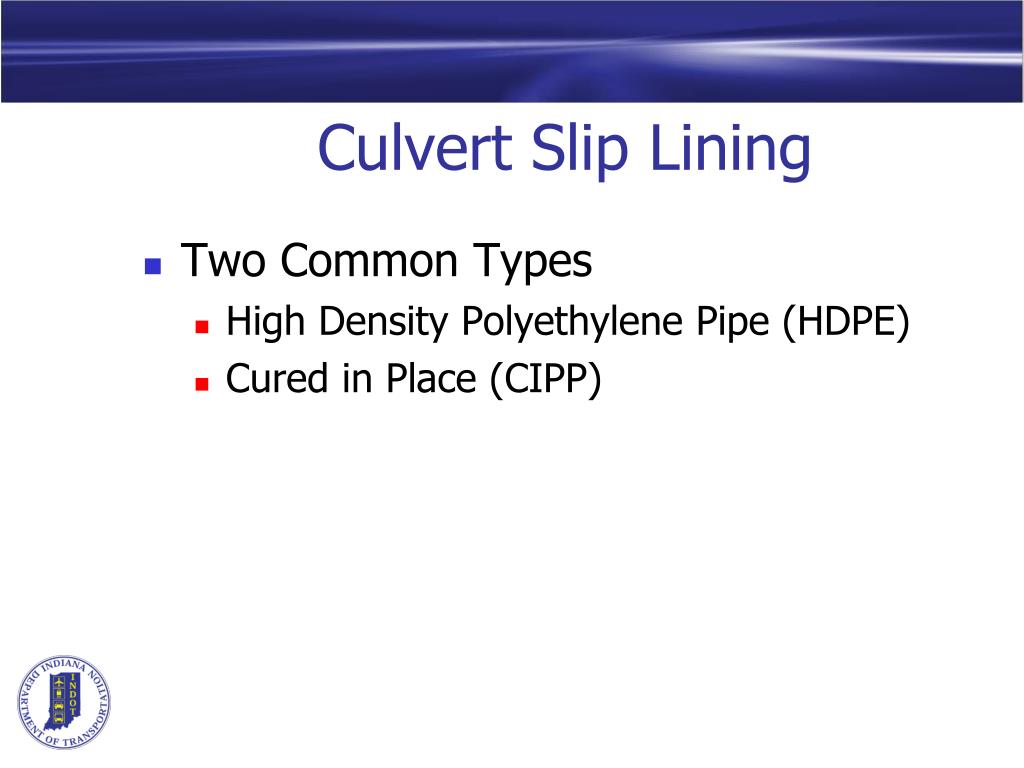

  38. Culvert Slip Lining • Two Common Types • High Density Polyethylene Pipe (HDPE) • Cured in Place (CIPP)

  39. Culvert Slip Lining (Cont.) • Review Pipe Inspection Report • Structures with an overall rating of 2 to 5 should be considered for lining. • Overall ratings of 0 or 1 are normally structures that need to be replaced. • Field Review • Pictures • Measurements

  40. Culvert Slip Lining (Cont.) • Factors to Consider • Structure barrel should be relatively straight and not significantly deformed. • Existing backfill free from large voids. • Should be sufficient room to work from at least one end of the existing structure. • In a location where road closure is undesirable or impractical. • Hydraulic capacity of liner. • Liner cost vs. replacement cost

  41. Lining Design Criteria • Time of Concentration < 1 Hour • May increase backwater over existing if: • Headwater maintains road serviceability. • Headwater does not reach fixed private property structures. • Time of Concentration > 1 Hour • May not increase backwater, unless contained within channel banks or R/W. • Check Outlet Velocity

  42. Lining Design Procedure • HDPE Liners • Manning’s n=0.012. • Use maximum pipe liner size from tables in Standard Specification Section 725. • Use largest possible liner, even if smaller liner is hydraulically adequate.

  43. Lining Design Procedure (Cont.) • CIPP Liners • Only considered if HDPE will not work (cost). • Manning’s n=0.012. • Structures < 96” diameter or equivalent. • Will reduce existing structure size as follows: • Dia. ≤ 24”, reduce by 1” • Dia. from 27” to 48”, reduce by 2” • Dia. from 54” to 72”, reduce by 3” • Dia. from 78” to 96”, reduce by 4”

  44. Culvert Extensions • Match Existing Pipe Size and Interior Designation. • Perform Appropriate Hydraulic Analysis.

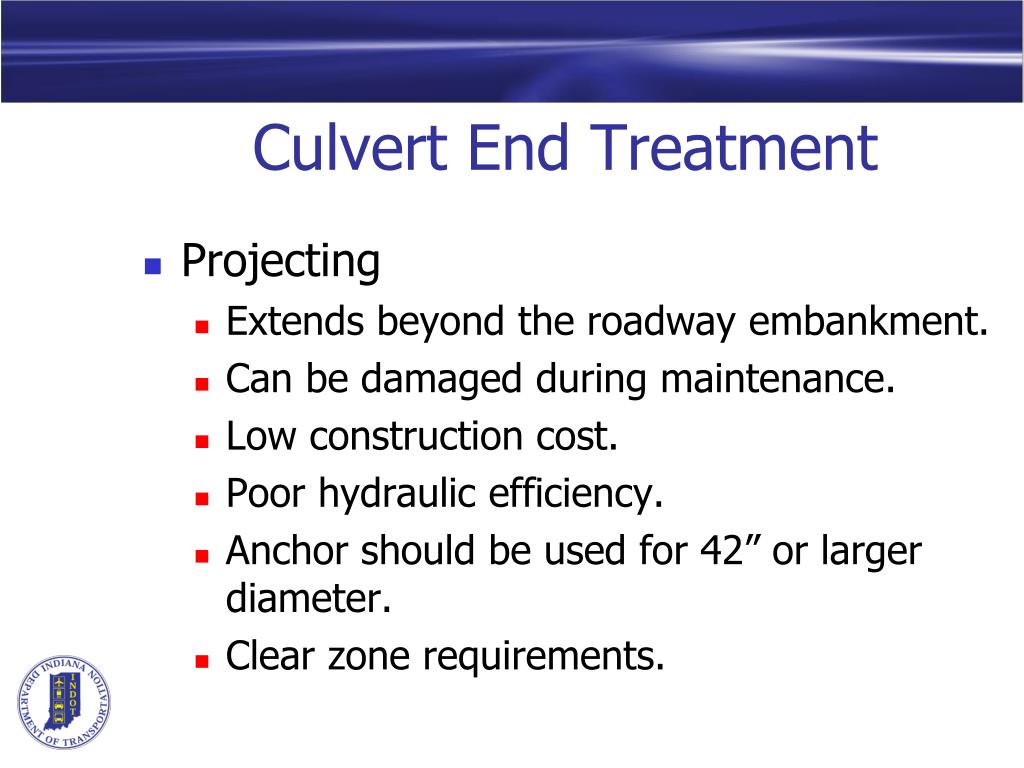

  45. Culvert End Treatment • Projecting • Extends beyond the roadway embankment. • Can be damaged during maintenance. • Low construction cost. • Poor hydraulic efficiency. • Anchor should be used for 42” or larger diameter. • Clear zone requirements.

  46. Culvert End Treatment (Cont.) • Mitered • Hydraulically more efficient than projecting. • Mitered to match fill slope. • Pipe End Section • For corrugated metal or concrete pipe. • Retards embankment erosion. • May improve hydraulic efficiency.

  47. Culvert End Treatment (Cont.) • Wingwall • Retain roadway embankment • Used where side slopes of channel are unstable. • Best hydraulic efficiency if flare angle is between 30° and 60°. • Should be used on precast concrete drainage structures.

  48. Culvert End Treatment (Cont.) • Apron • Reduce scour • Should extend at least one pipe diameter. • Should not protrude above normal streambed elevation. • May be constructed of riprap and geotextile or concrete.

  49. Culvert End Treatment (Cont.) • Cutoff Wall • Prevent piping along culvert barrel. • Should be used for culverts with headwalls. • Should be minimum of 20” depth.

  50. Specialty Structures • Precast Concrete Box Culvert • Maximum span is 12 ft. • The recommended layout is to extend the box to the point where the roadway sideslope intercepts stream flowline. • End of box culvert should be protected with guardrail or located beyond the clear zone.
