Data Access Framework All Hands Community Meeting
130 likes | 224 Vues
Data Access Framework All Hands Community Meeting. June 25, 2014. Meeting Etiquette. Remember: If you are not speaking, keep your phone on mute Do not put your phone on hold – if you need to take a call, hang up and dial in again when finished with your other call
Data Access Framework All Hands Community Meeting
E N D
Presentation Transcript
Data Access Framework All Hands Community Meeting June 25, 2014
Meeting Etiquette • Remember: If you are not speaking, keep your phone on mute • Do not put your phone on hold – if you need to take a call, hang up and dial in again when finished with your other call • Hold = Elevator Music = very frustrated speakers and participants • This meeting, like all of our meeting is being recorded • Another reason to keep your phone on mute when not speaking • Feel free to use the “Chat” feature for questions, comments or any items you would like the moderator or participants to know. From S&I Framework to Participants: Hi everyone: remember to keep your phone on mute NOTE: This meeting is being recorded and will be posted on the DAF Wikipage, under “Materials” “Past Meetings”

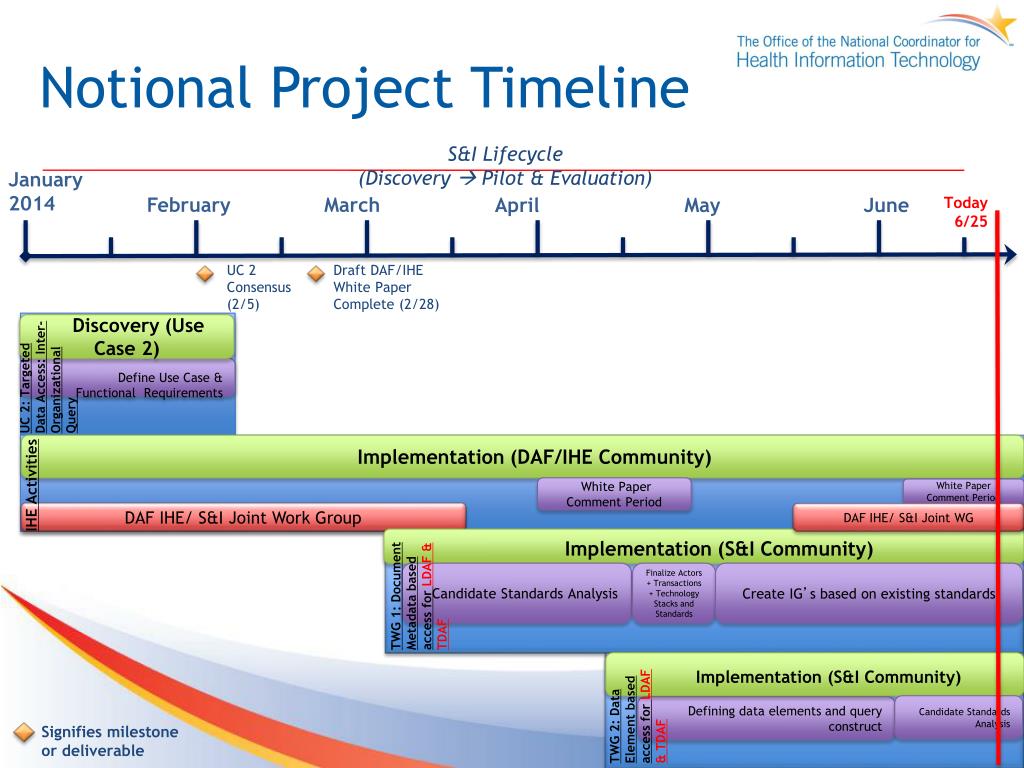

Notional Project Timeline S&I Lifecycle (Discovery Pilot & Evaluation) January2014 February March April May June Today 6/25 UC 2 Consensus (2/5) Draft DAF/IHE White Paper Complete (2/28) Discovery (Use Case 2) UC 2: Targeted Data Access: Inter-Organizational Query Define Use Case & Functional Requirements Implementation (DAF/IHE Community) IHE Activities White Paper Comment Period White Paper Comment Period DAF IHE/ S&I Joint Work Group DAF IHE/ S&I Joint WG Implementation (S&I Community) TWG 1: Document Metadata based access for LDAF & TDAF Candidate Standards Analysis Finalize Actors + Transactions + Technology Stacks and Standards Create IG’s based on existing standards Implementation (S&I Community) TWG 2: Data Element based access for LDAF & TDAF Candidate Standards Analysis Defining data elements and query construct Signifies milestone or deliverable
Recap DAF Work Groups • DAF IHE/S&I Joint WG • Completed prioritization of the 11 gaps. • Started assigning tasks based on the need to write change proposals, create a new profile, etc. • White Paper comment period has been extended through July 3rd • White Paper: http://ihe.net/Public_Comment/#pcc • Comment Form: http://ihe.net/PCC_Public_Comments/ • Direct Transport SWG • Working to create a binding between DAF and Direct Transport based on Common IHE Document Metadata.
Document Metadata • Pending Work: • SOAP Query Stack • Work on Examples and Patient Consent related requirements. • RESTful Query Stack • IHE MHD v2 work on-going within IHE • Alignment with FHIR resources in progress.
Candidate Standards Analysis • Standards Analysis • FHIR • Initial Analysis of FHIR Completed. • HL7v2 • Introduction to HL7v2 presented last week by Brett Marquard • Todays Session will contain Standards Analysis being conducted by Tony Julian of HL7 InM Work Group. • QED/HL7 v3 • Introduction to the standard today • Analysis in Progress • HQMF v2 • Introduction to the standard today • Discussion on HQMF applicability • vMR • Will be reaching out to Ken and see how vMR could apply and ask for a presentation • Event Pub/Sub Model ?
HQMF Applicability • HQMF standard is a document oriented standard, created based on needs of Clinical Quality Measures. • HQMF v2 based on RIM and is very powerful in it ‘s ability to construct queries of various forms and complexities as proven by CQM’s. • Creation of a Query entails creating a Document and then creating various CQM specific data elements in order to use it for DAF’s current queries and query results. • HQMF is only a Query standard and does not support query results, typically QRDA Cat I and III documents are used. • HQMF is not completely machine processable as it is currently if all features of the standard is used. • Discussion: Potentially drop HQMF v2 from consideration for DAF, however it could be used by other initiatives. Communities can use the rest of the DAF Query Stack and use HQMFv2 as the Query standard for applicable use cases.
Data ElementsComment Form • Take a moment to review the latest DAF data elements spreadsheet and submit your comments through the online comment form: http://wiki.siframework.org/DAF+Standards+Harmonization+and+Implementation
Data Access Framework Resources • DAF Wiki Homepage • http://wiki.siframework.org/Data+Access+Framework+Homepage • Become a Community Member • http://wiki.siframework.org/Data+Access+Framework+Join+the+Initiative • DAF Charter • http://wiki.siframework.org/Data+Access+Framework+Charter+and+Members • DAF Standards, Harmonization and Implementation Activities • http://wiki.siframework.org/DAF+Standards+Harmonization+and+Implementation • Standards and Interoperability(S&I) Framework • http://wiki.siframework.org/Introduction+and+Overview • S & I Calendar of Events • http://wiki.siframework.org/Calendar
Initiative Support Leads • For questions, please feel free to contact your support leads: • Initiative Coordinator: John Feikema john.feikema@siframework.org • ONC Sponsors: Mera Choi mera.choi@hhs.gov • Support Team: • Project Management: • GayathriJayawardenagayathri.jayawardena@esacinc.com • Technical Support: • Dragon (Nagesh) Bashyam nagesh.bashyam@drajer.com • Standards SME: • Ed Larsen ed_larsen@comcast.net • Standards Support: • Angelique Cortez angelique.j.cortez@accenture.com • Vocabulary and Terminology Subject Matter Expert: • Mark Roche, MD mrochemd@gmail.com
