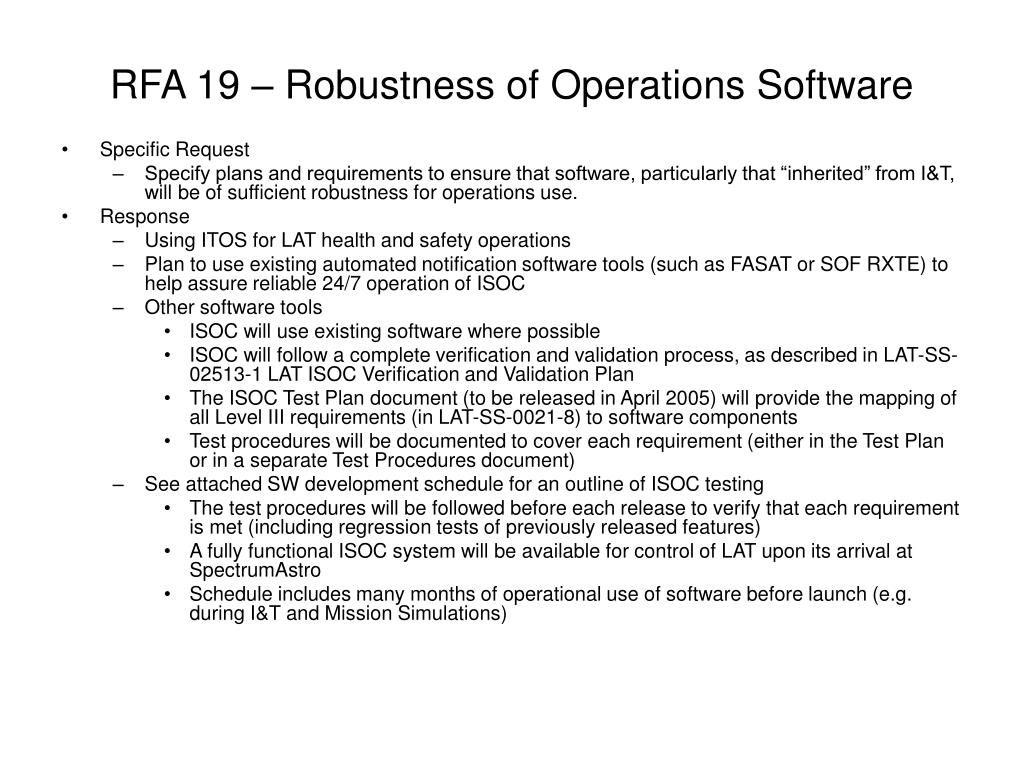

  1. RFA 19 – Robustness of Operations Software • Specific Request • Specify plans and requirements to ensure that software, particularly that “inherited” from I&T, will be of sufficient robustness for operations use. • Response • Using ITOS for LAT health and safety operations • Plan to use existing automated notification software tools (such as FASAT or SOF RXTE) to help assure reliable 24/7 operation of ISOC • Other software tools • ISOC will use existing software where possible • ISOC will follow a complete verification and validation process, as described in LAT-SS-02513-1 LAT ISOC Verification and Validation Plan • The ISOC Test Plan document (to be released in April 2005) will provide the mapping of all Level III requirements (in LAT-SS-0021-8) to software components • Test procedures will be documented to cover each requirement (either in the Test Plan or in a separate Test Procedures document) • See attached SW development schedule for an outline of ISOC testing • The test procedures will be followed before each release to verify that each requirement is met (including regression tests of previously released features) • A fully functional ISOC system will be available for control of LAT upon its arrival at SpectrumAstro • Schedule includes many months of operational use of software before launch (e.g. during I&T and Mission Simulations)

  2. ISOC Software Development Schedule Phase / Milestone Aug-04 Sep-04 Oct-04 Nov-04 Dec-04 Jan-05 Feb-05 Mar-05 Apr-05 May-05 Jun-05 Jul-05 Aug-05 Sep-05 Oct-05 Nov-05 Dec-05 Jan-06 Feb-06 Mar-06 Apr-06 May-06 Jun-06 Jul-06 Aug-06 Sep-06 Oct-06 Nov-06 Dec-06 Jan-07 Feb-07 Mar-07 ISOC CDR ITOS setup/configuration ISOC Verif. with Test Bed Diagnostic Tool Dev Mission Planning Dev DB/Web/E-logbook Dev Plotting/Trending Dev SW enhancements ISOC Demos ISOC Simulation Testing ISOC SW Releases 1 4 2 3 Ground Readiness Tests 3 4 7 2 6 5 End-to-End Tests 6 5 4 3 1 2 Environmental tests at NRL ISOC testing at NRL ISOC ready to take over LAT operation ISOC used to I/F with LAT (front-door only) Mission Simulations Launch SW Dev Slack Times
