Implementation of Test Engineering Training using Remote ATE:A First Experience at European Level Yves Bertrand, Marie-Lise Flottes, LIRMM Montpellier Hans-Joachim Wunderlich, Nicoleta Pricopi, Universität Stuttgart

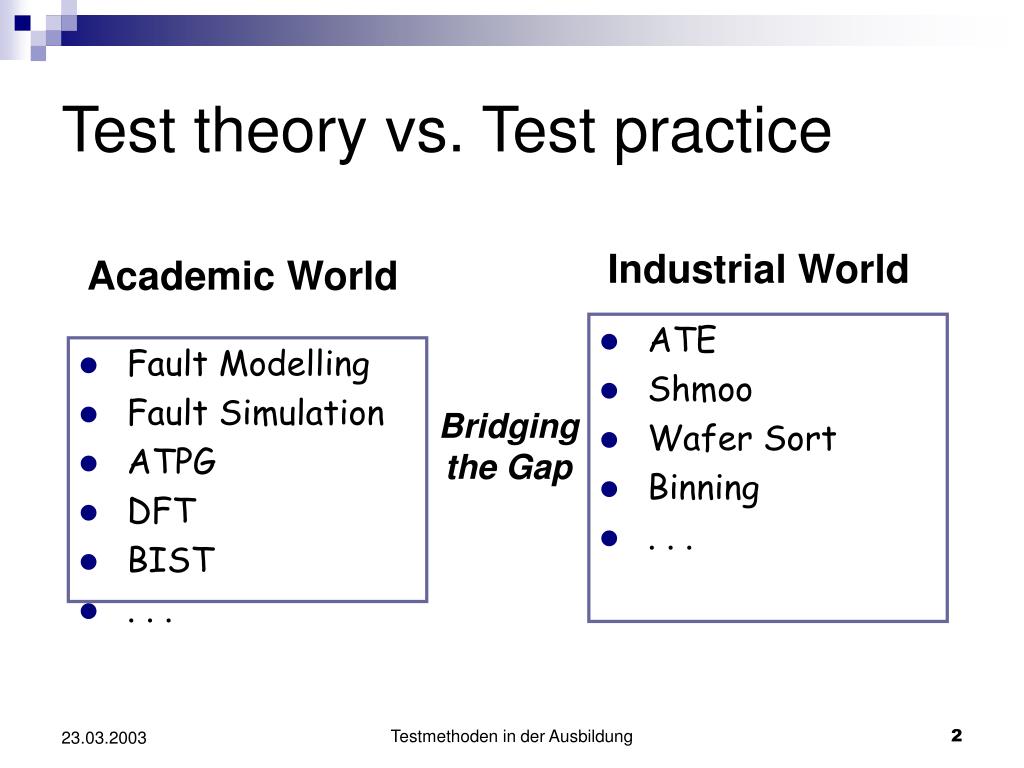

Test theory vs. Test practice • Fault Modelling • Fault Simulation • ATPG • DFT • BIST • . . . Industrial World Academic World • ATE • Shmoo • Wafer Sort • Binning • . . . Bridging the Gap Testmethoden in der Ausbildung

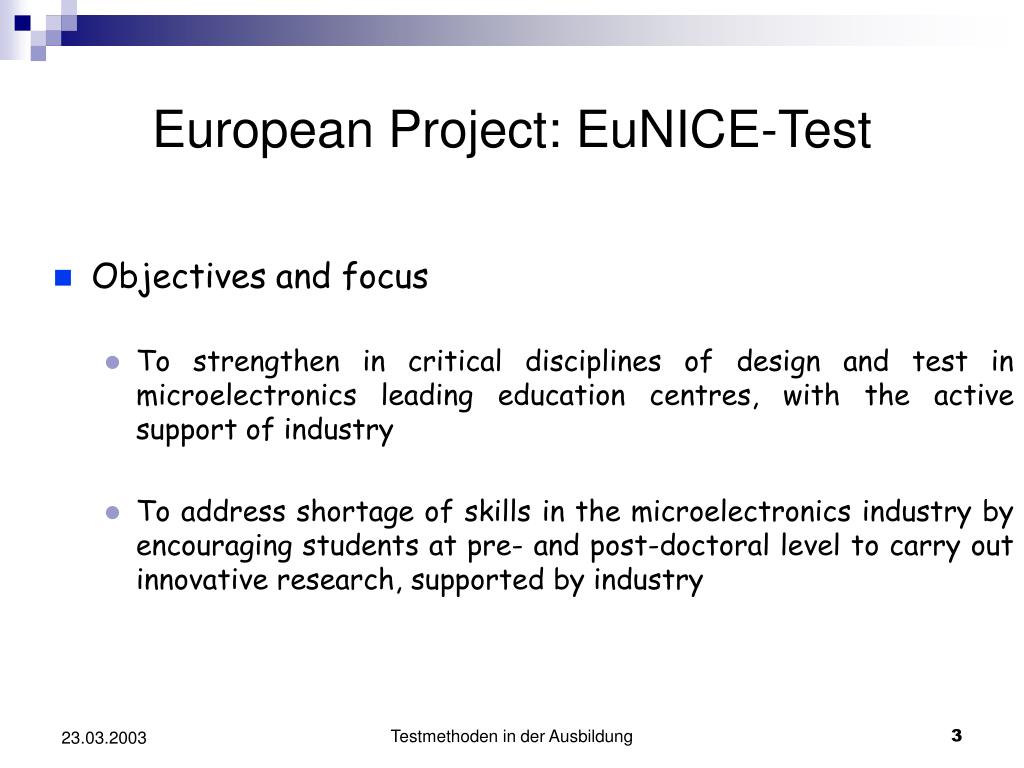

Objectives and focus To strengthen in critical disciplines of design and test in microelectronics leading education centres, with the active support of industry To address shortage of skills in the microelectronics industry by encouraging students at pre- and post-doctoral level to carry out innovative research, supported by industry European Project: EuNICE-Test Testmethoden in der Ausbildung
Remote access to central test ressources Stuttgart Ljubljana Renater Torino Barcelona Testmethoden in der Ausbildung
Agilent 83000-F330t Per-Pin Architecture Pin Count: 128 (/512) Max. Speed: 330MHz PMU/16 Pins Analog Resources Test Tool Testmethoden in der Ausbildung

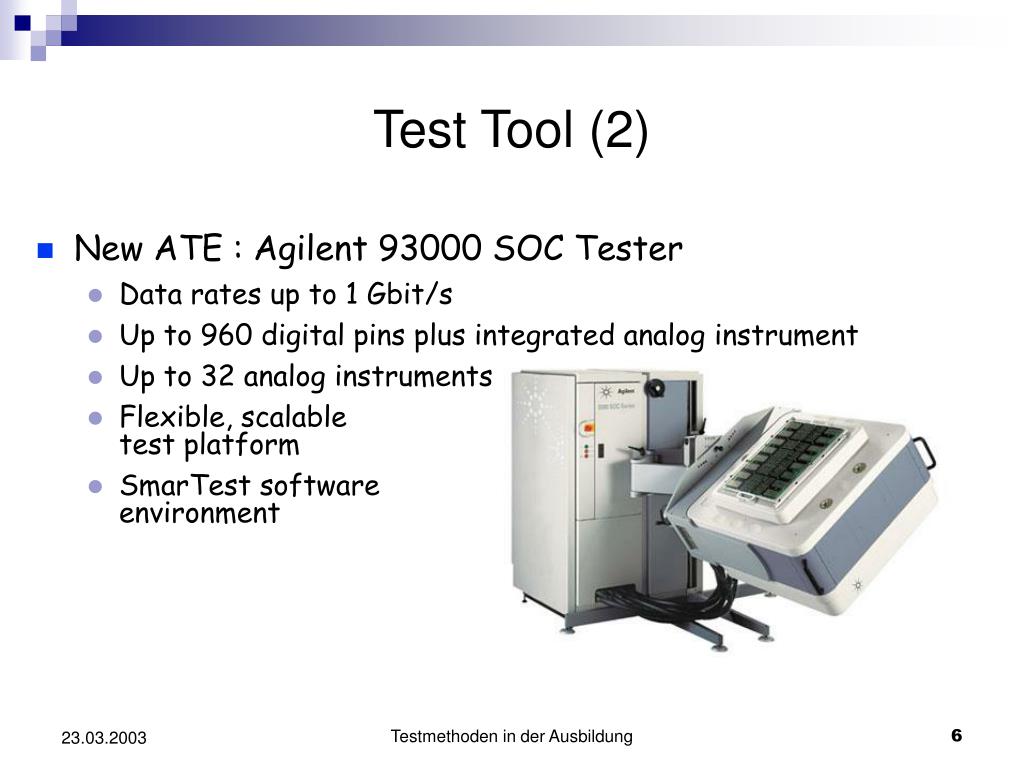

Test Tool (2) • New ATE : Agilent 93000 SOC Tester • Data rates up to 1 Gbit/s • Up to 960 digital pins plus integrated analog instrument • Up to 32 analog instruments • Flexible, scalable test platform • SmarTest software environment Testmethoden in der Ausbildung

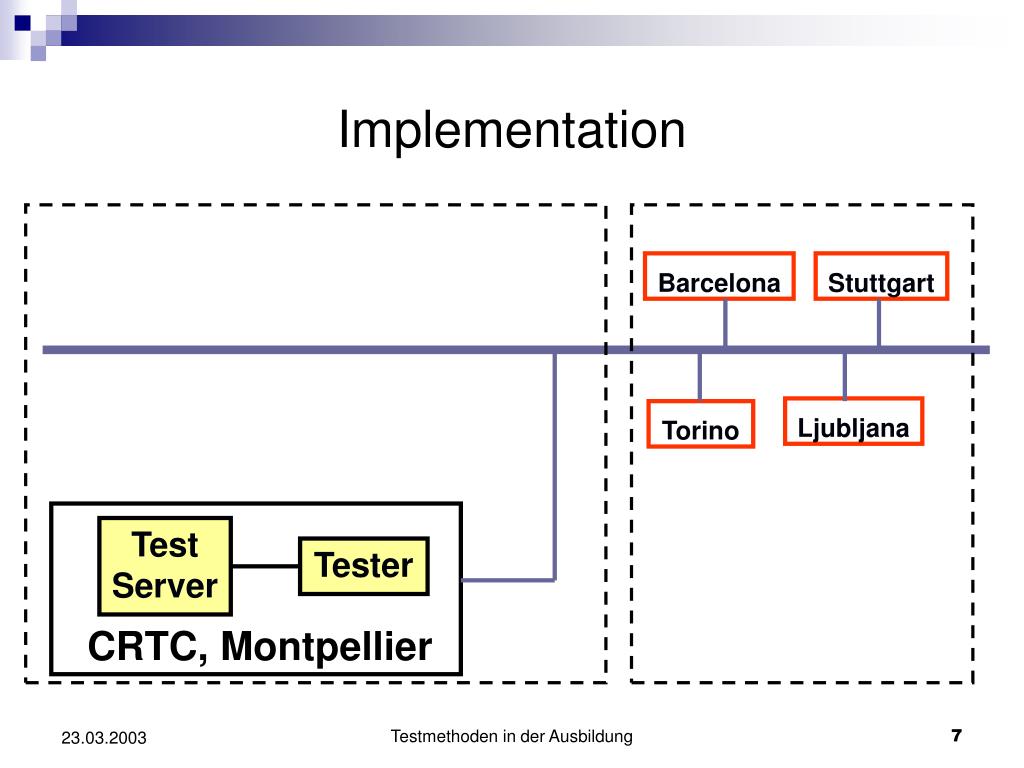

Implementation Barcelona Stuttgart Ljubljana Torino Test Server Tester CRTC, Montpellier Testmethoden in der Ausbildung

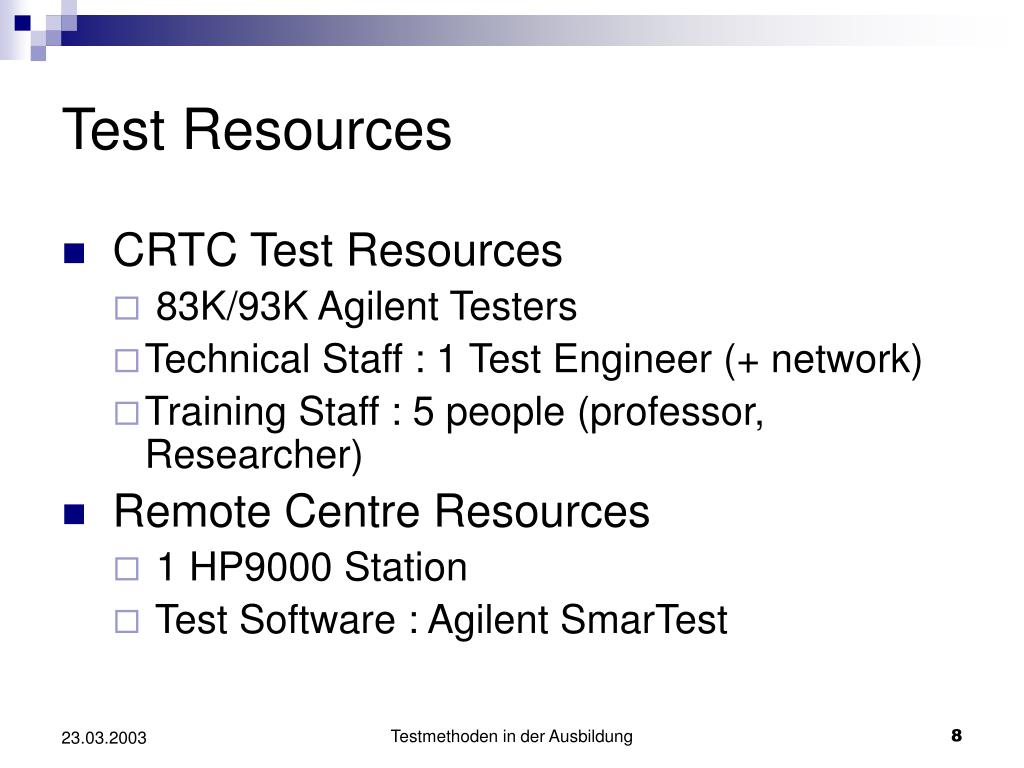

Test Resources • CRTC Test Resources • 83K/93K Agilent Testers • Technical Staff : 1 Test Engineer (+ network) • Training Staff : 5 people (professor, Researcher) • Remote Centre Resources • 1 HP9000 Station • Test Software : Agilent SmarTest Testmethoden in der Ausbildung

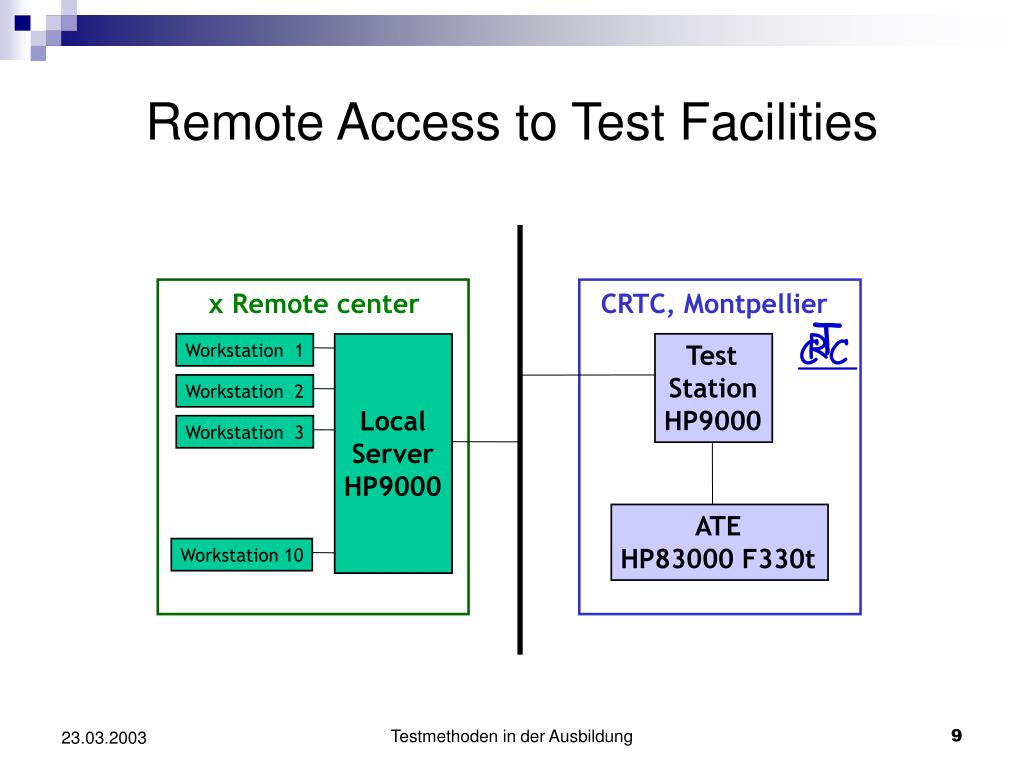

T R C C Remote Access to Test Facilities x Remote center CRTC, Montpellier Test Workstation 1 Station Workstation 2 HP9000 Local Workstation 3 Server HP9000 ATE HP83000 F330t Workstation 10 Testmethoden in der Ausbildung
Digital Test Training (1) • Part 1 (one Week): Basics of ATE Programming • Preparing the Tests • Test Execution and Results Analysis • Avanced Test Concepts • Test Resource Optimization • Automating the Test Program Shmoo Plot Testmethoden in der Ausbildung Softscope Mode

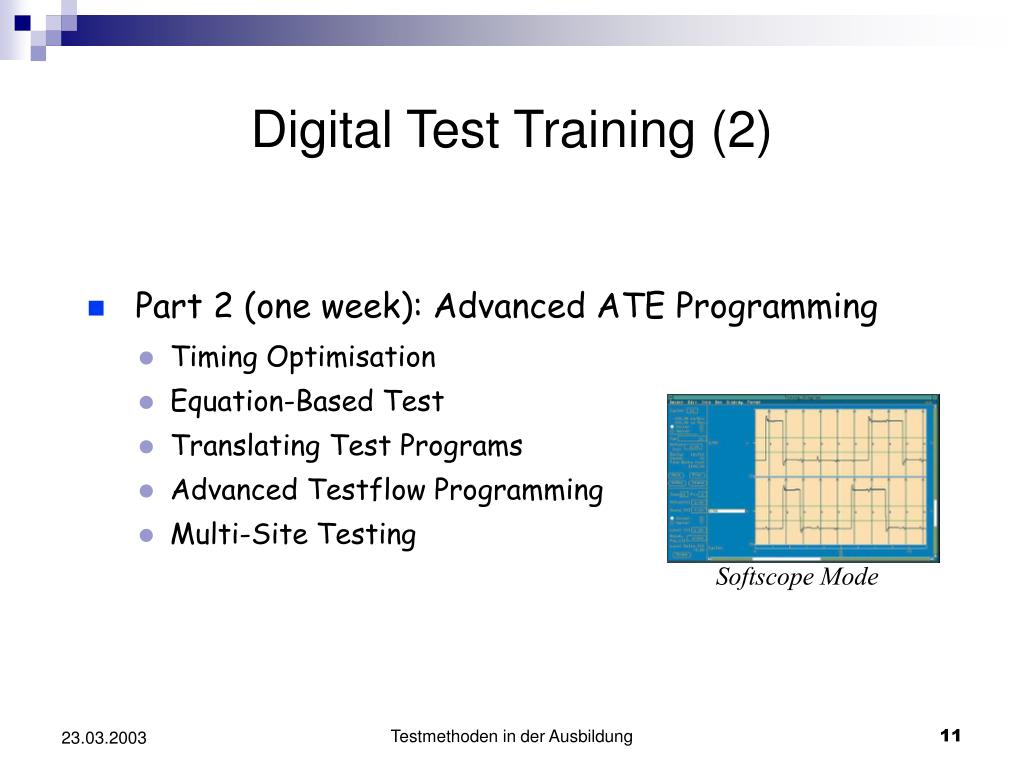

Part 2 (one week): Advanced ATE Programming Timing Optimisation Equation-Based Test Translating Test Programs Advanced Testflow Programming Multi-Site Testing Digital Test Training (2) Softscope Mode Testmethoden in der Ausbildung Softscope Mode

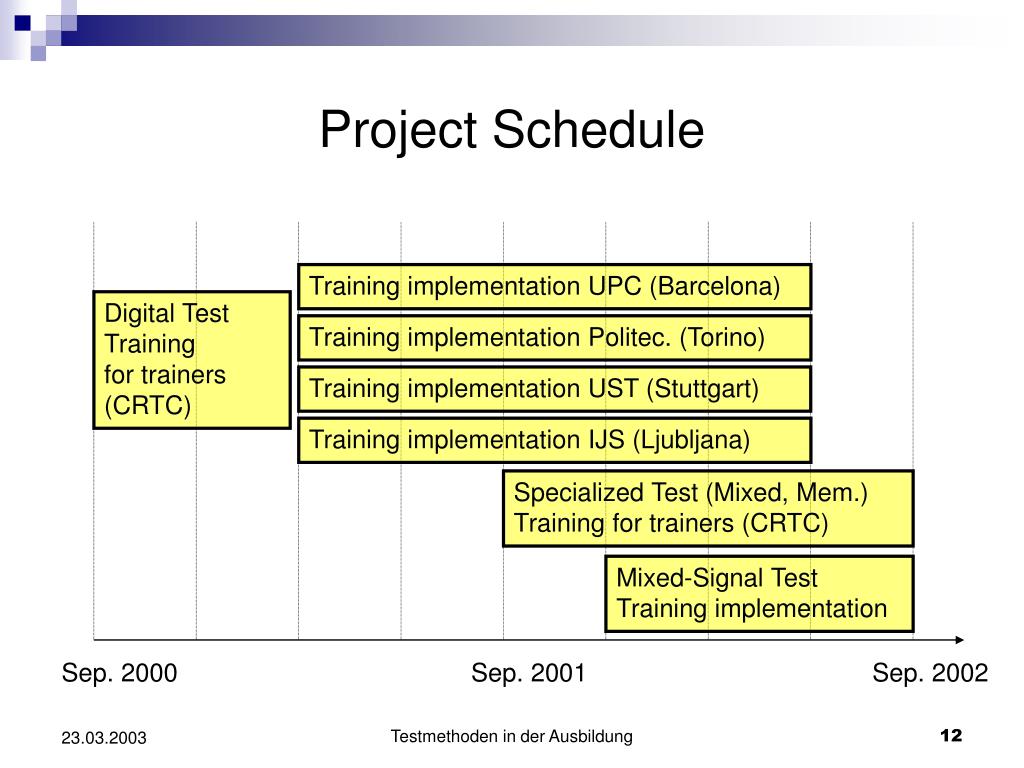

Project Schedule Training implementation UPC (Barcelona) Digital Test Training for trainers (CRTC) Training implementation Politec. (Torino) Training implementation UST (Stuttgart) Training implementation IJS (Ljubljana) Specialized Test (Mixed, Mem.) Training for trainers (CRTC) Mixed-Signal Test Training implementation Sep. 2000 Sep. 2001 Sep. 2002 Testmethoden in der Ausbildung

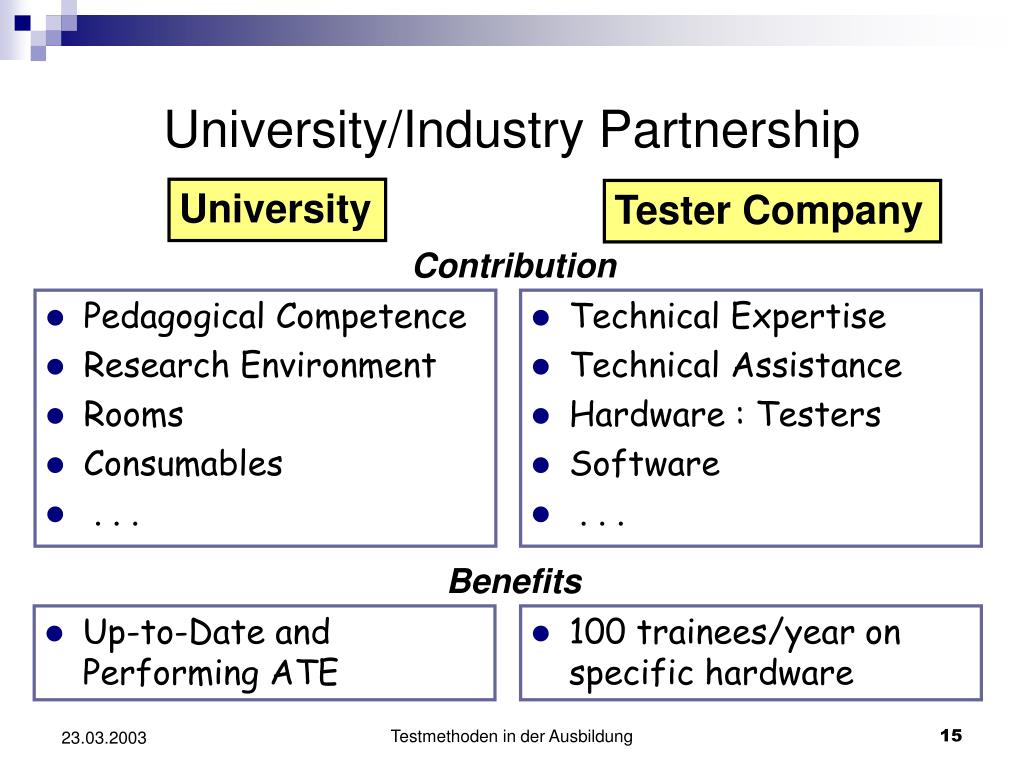

Pedagogical Competence Research Environment Rooms Consumables . . . University/Industry Partnership University Tester Company Contribution • Technical Expertise • Technical Assistance • Hardware : Testers • Software • . . . Benefits • Up-to-Date and Performing ATE • 100 trainees/year on specific hardware Testmethoden in der Ausbildung
