Stabilization of Soft Clay Subgrades in Virginia Phase I Laboratory Study. George Filz and Tom Brandon. Stabilization of Soft Clay Subgrades in Virginia Phase I Laboratory Study. Motivation for the research Issues to be considered Work tasks Schedule. Motivation.
E N D
Stabilization of Soft Clay Subgrades in VirginiaPhase I Laboratory Study George Filz and Tom Brandon

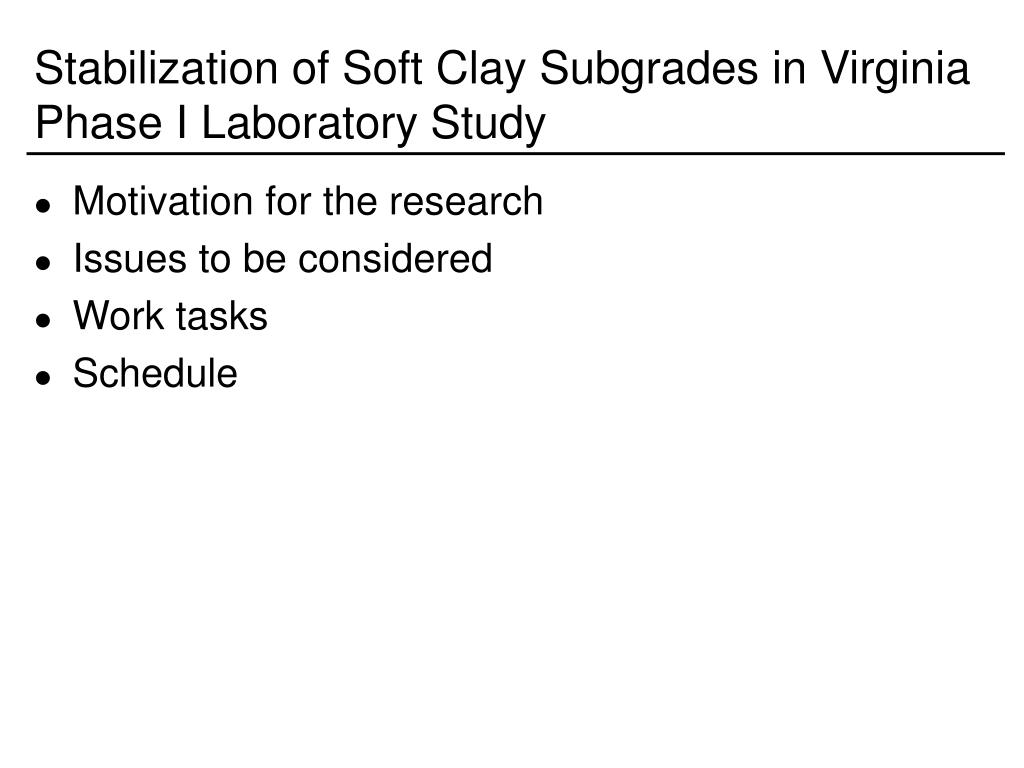

Stabilization of Soft Clay Subgrades in VirginiaPhase I Laboratory Study • Motivation for the research • Issues to be considered • Work tasks • Schedule

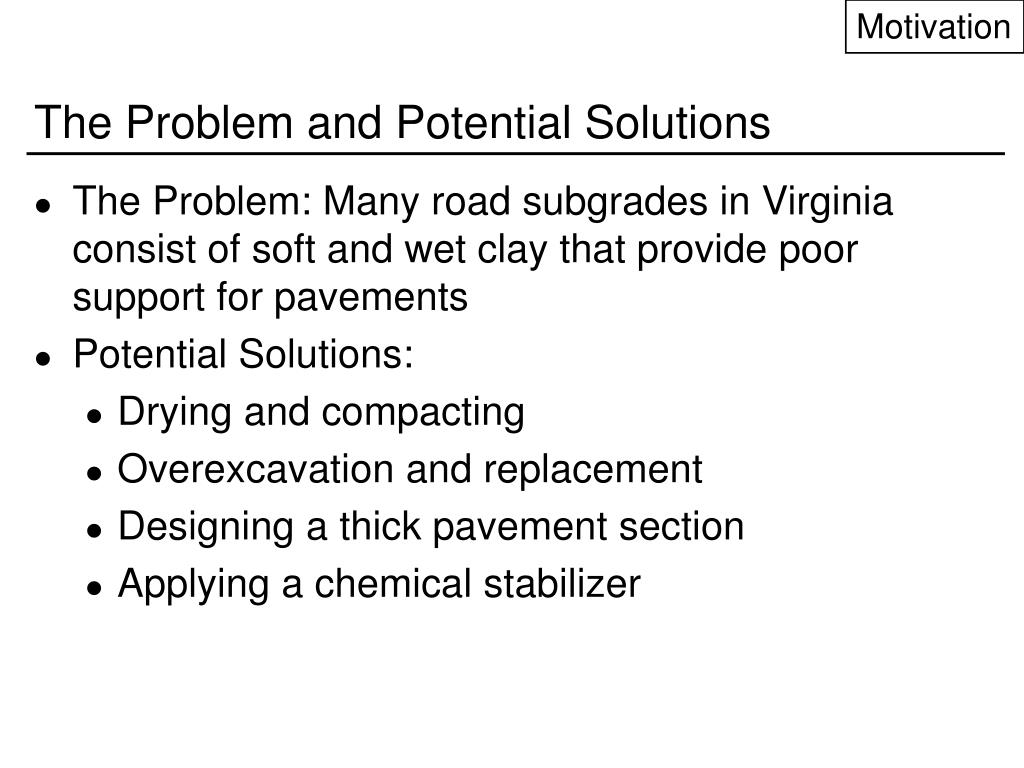

Motivation The Problem and Potential Solutions • The Problem: Many road subgrades in Virginia consist of soft and wet clay that provide poor support for pavements • Potential Solutions: • Drying and compacting • Overexcavation and replacement • Designing a thick pavement section • Applying a chemical stabilizer

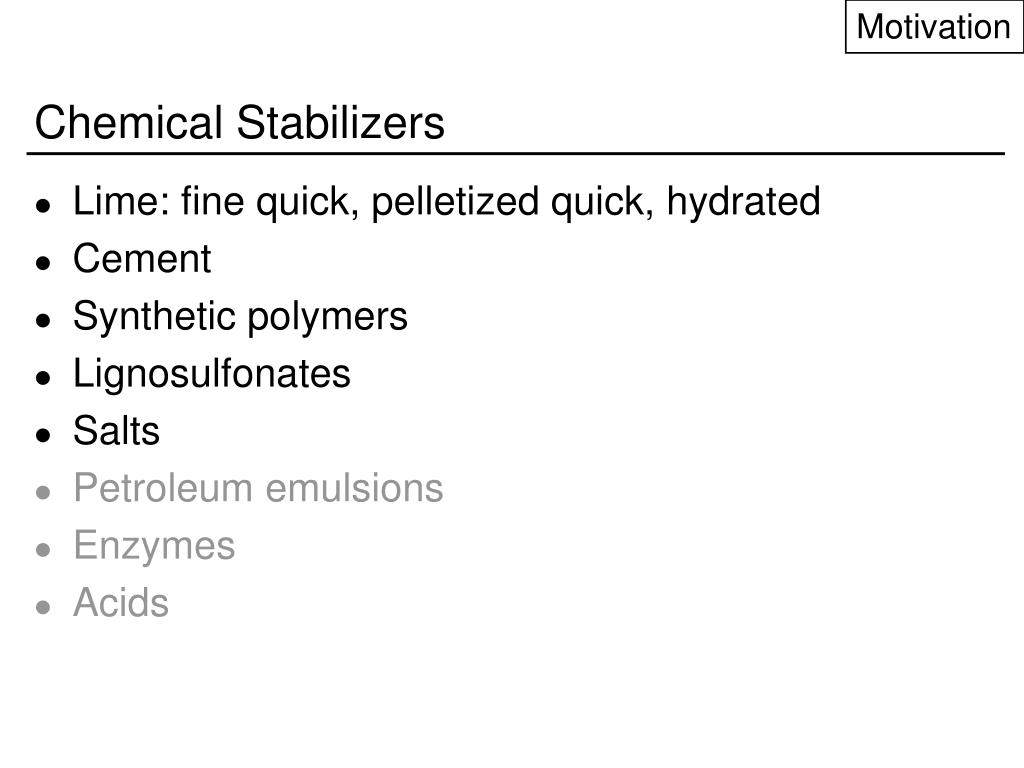

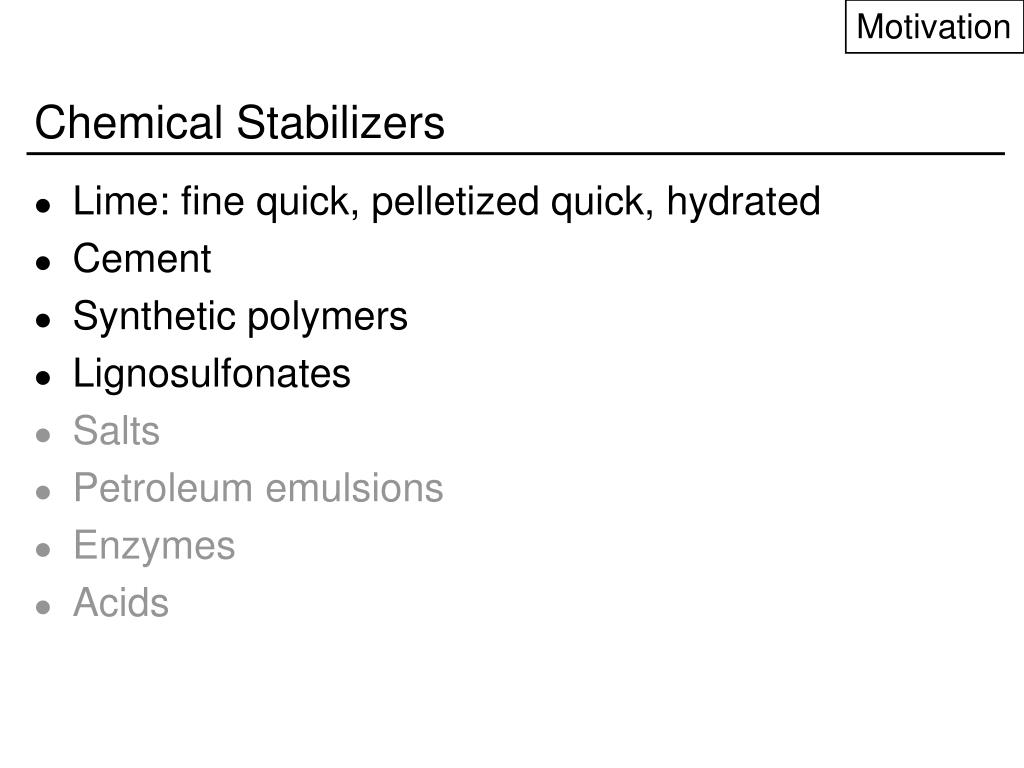

Motivation Chemical Stabilizers • Lime: fine-grained quick, pelletized quick, hydrated • Cement • Synthetic polymers • Lignosulfonates • Salts • Petroleum emulsions • Enzymes • Acids
Motivation Chemical Stabilizers • Lime: fine quick, pelletized quick, hydrated • Cement • Synthetic polymers • Lignosulfonates • Salts • Petroleum emulsions • Enzymes • Acids
Motivation Chemical Stabilizers • Lime: fine quick, pelletized quick, hydrated • Cement • Synthetic polymers • Lignosulfonates • Salts • Petroleum emulsions • Enzymes • Acids

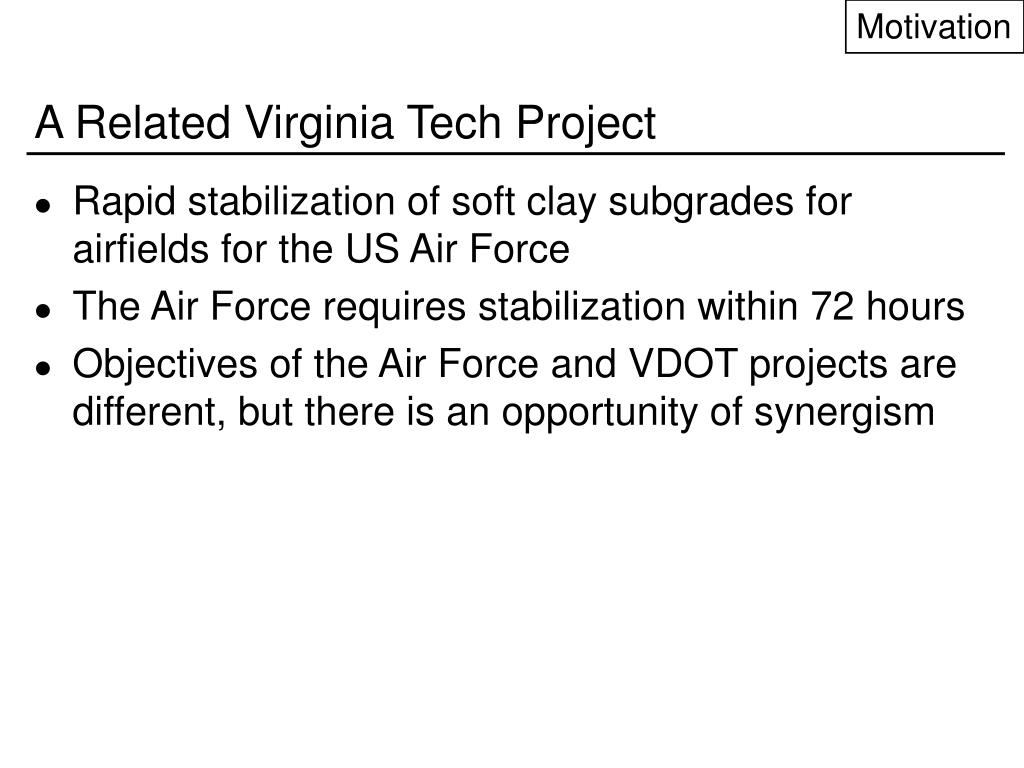

Motivation A Related Virginia Tech Project • Rapid stabilization of soft clay subgrades for airfields for the US Air Force • The Air Force requires stabilization within 72 hours • Objectives of the Air Force and VDOT projects are different, but there is an opportunity of synergism

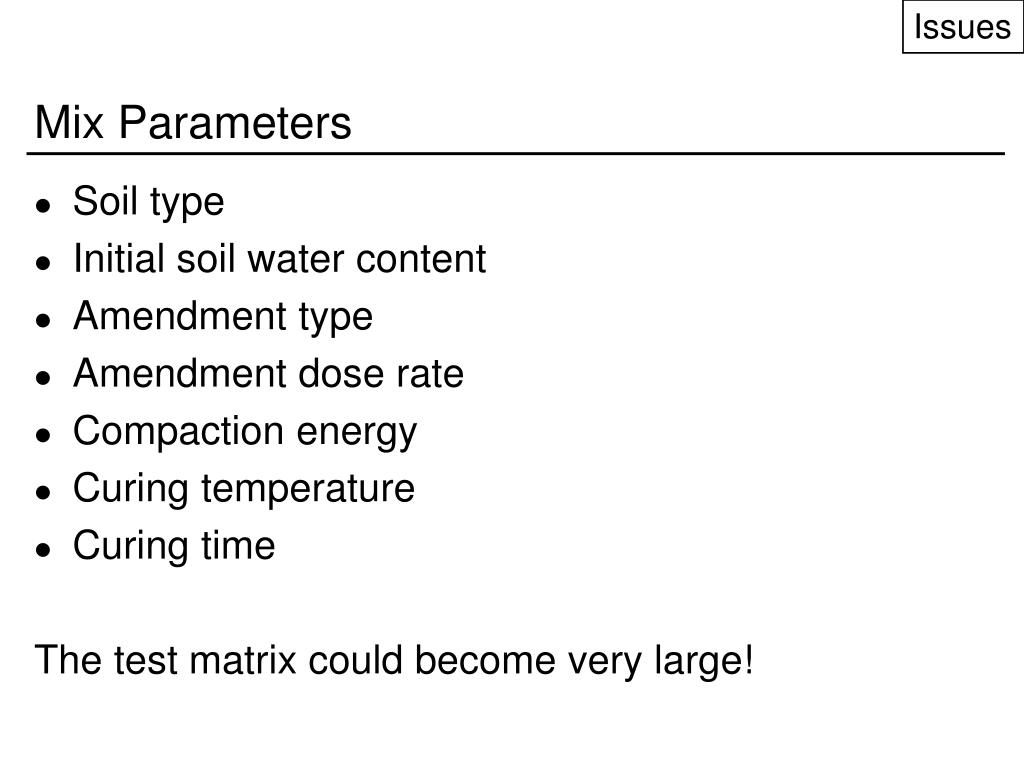

Issues Mix Parameters • Soil type • Initial soil water content • Amendment type • Amendment dose rate • Compaction energy • Curing temperature • Curing time The test matrix could become very large!

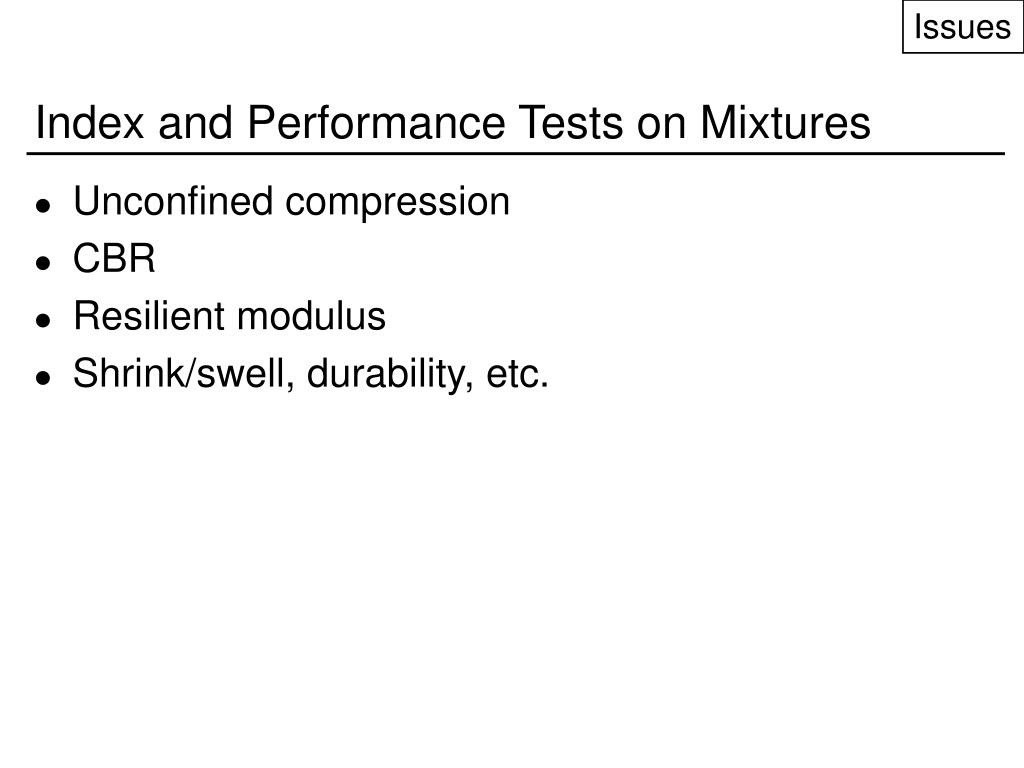

Issues Index and Performance Tests on Mixtures • Unconfined compression • CBR • Resilient modulus • Shrink/swell, durability, etc.
Issues Index and Performance Tests on Mixtures • Unconfined compression • CBR • Resilient modulus • Shrink/swell, durability, etc.

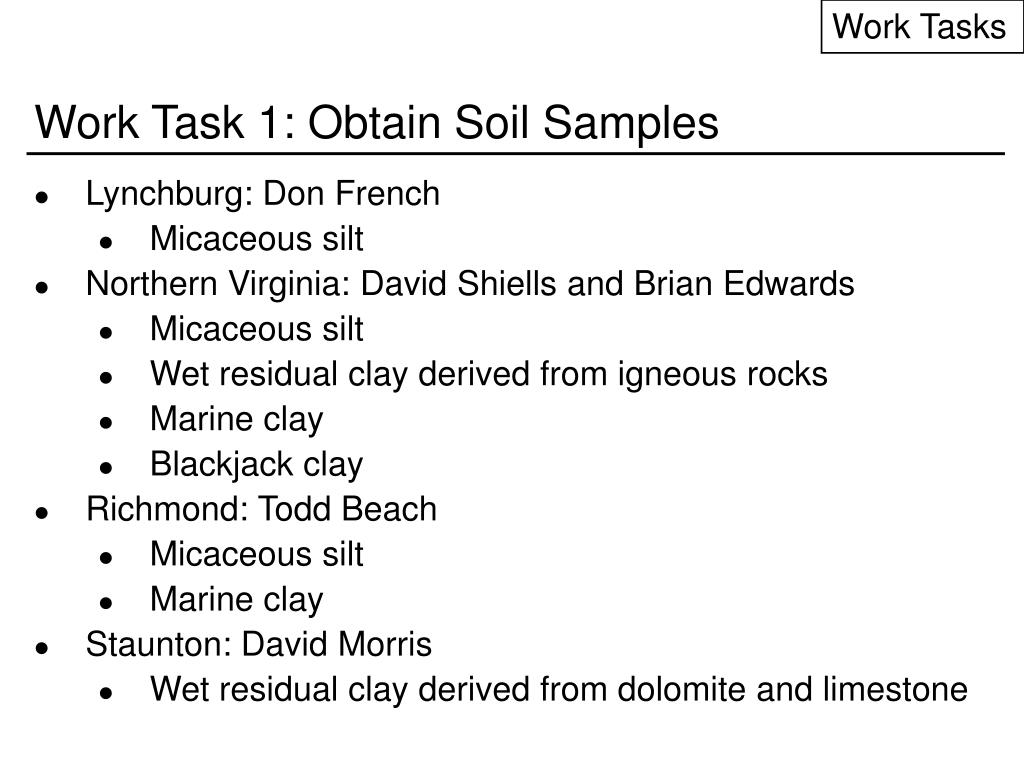

Work Tasks Work Task 1: Obtain Soil Samples • Lynchburg: Don French • Micaceous silt • Northern Virginia: David Shiells and Brian Edwards • Micaceous silt • Wet residual clay derived from igneous rocks • Marine clay • Blackjack clay • Richmond: Todd Beach • Micaceous silt • Marine clay • Staunton: David Morris • Wet residual clay derived from dolomite and limestone

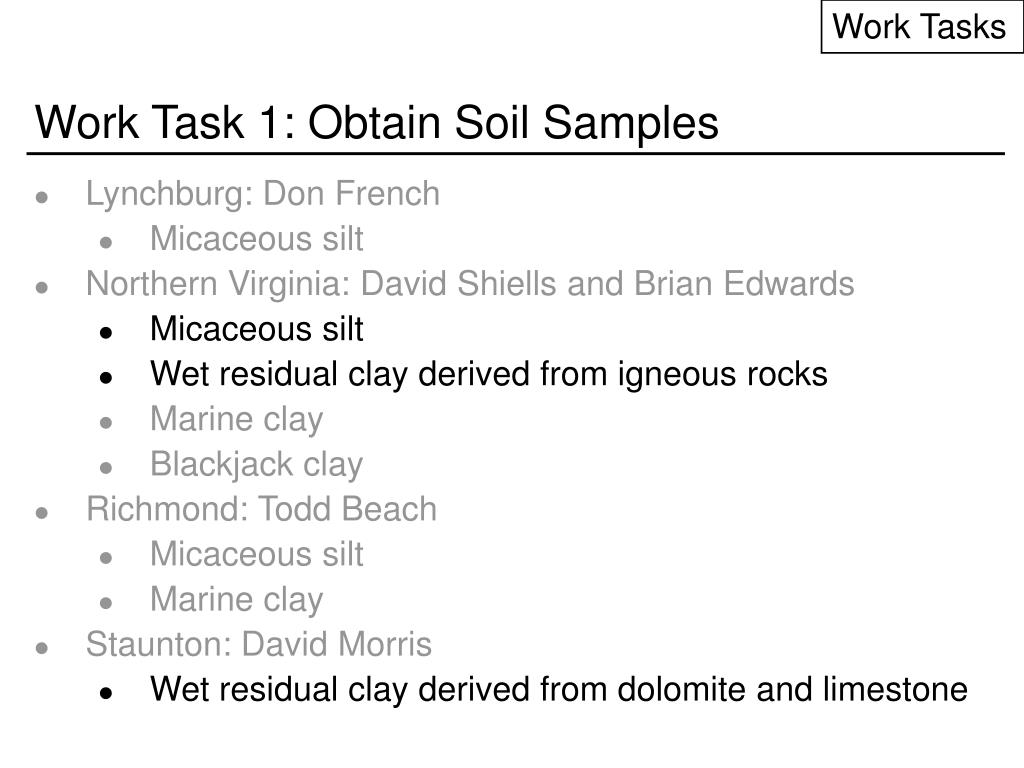

Work Tasks Work Task 1: Obtain Soil Samples • Lynchburg: Don French • Micaceous silt • Northern Virginia: David Shiells and Brian Edwards • Micaceous silt • Wet residual clay derived from igneous rocks • Marine clay • Blackjack clay • Richmond: Todd Beach • Micaceous silt • Marine clay • Staunton: David Morris • Wet residual clay derived from dolomite and limestone
Work Tasks Work Task 2: Soil Characterization Tests • Natural water content • Organic content • Sulfate content • Particle size distribution • Atterberg limits • Moisture-density, standard Proctor energy • Mineralogy of the clay fraction

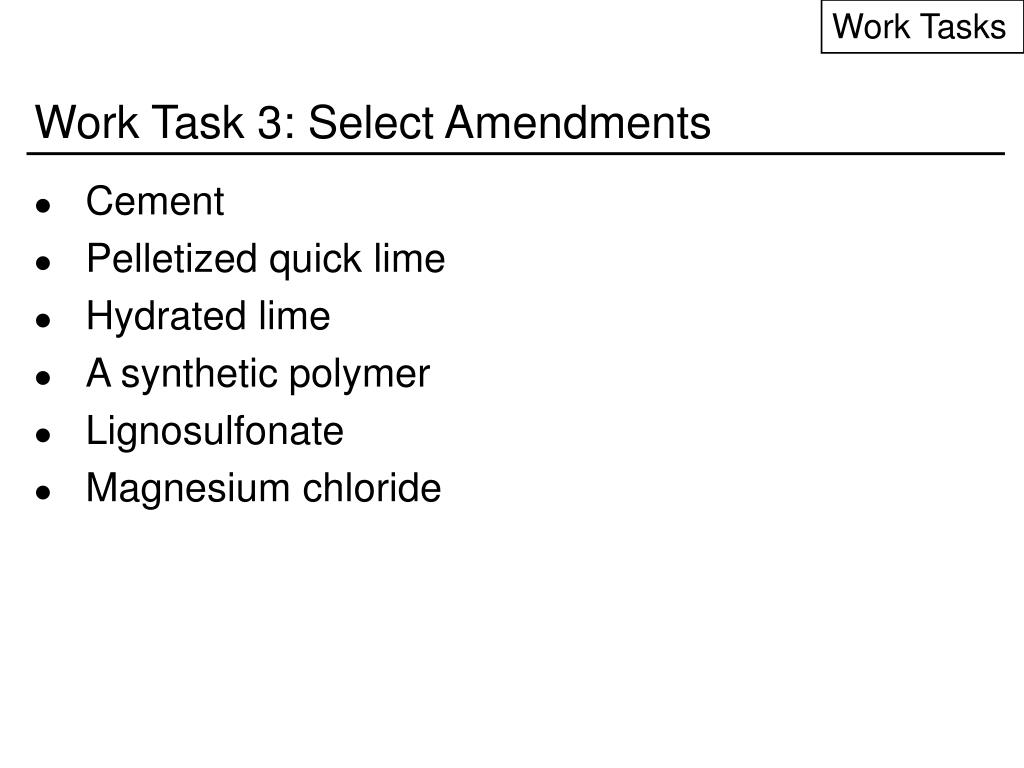

Work Tasks Work Task 3: Select Amendments • Cement • Pelletized quick lime • Hydrated lime • A synthetic polymer • Lignosulfonate • Magnesium chloride

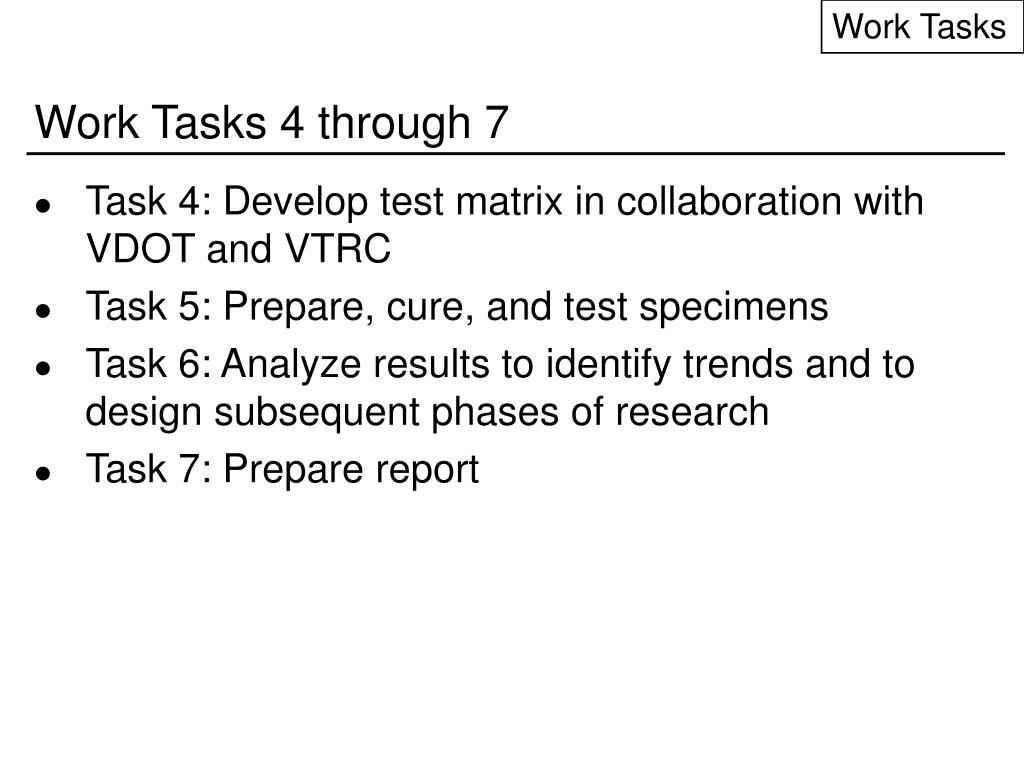

Work Tasks Work Tasks 4 through 7 • Task 4: Develop test matrix in collaboration with VDOT and VTRC • Task 5: Prepare, cure, and test specimens • Task 6: Analyze results to identify trends and to design subsequent phases of research • Task 7: Prepare report

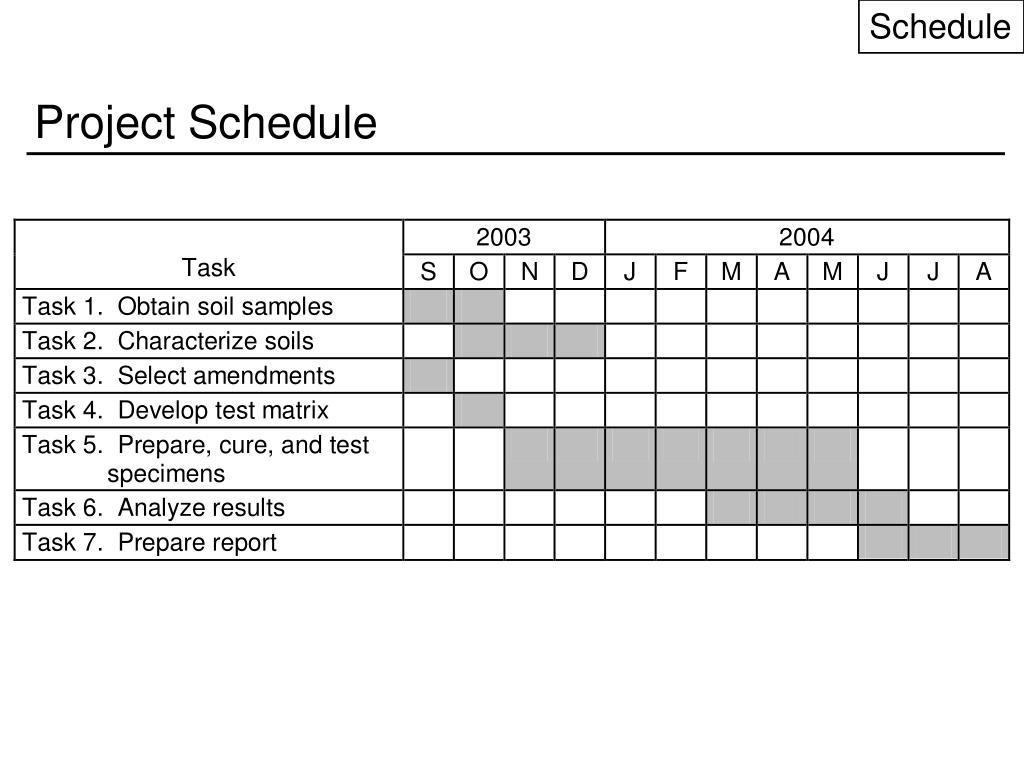

Schedule Project Schedule

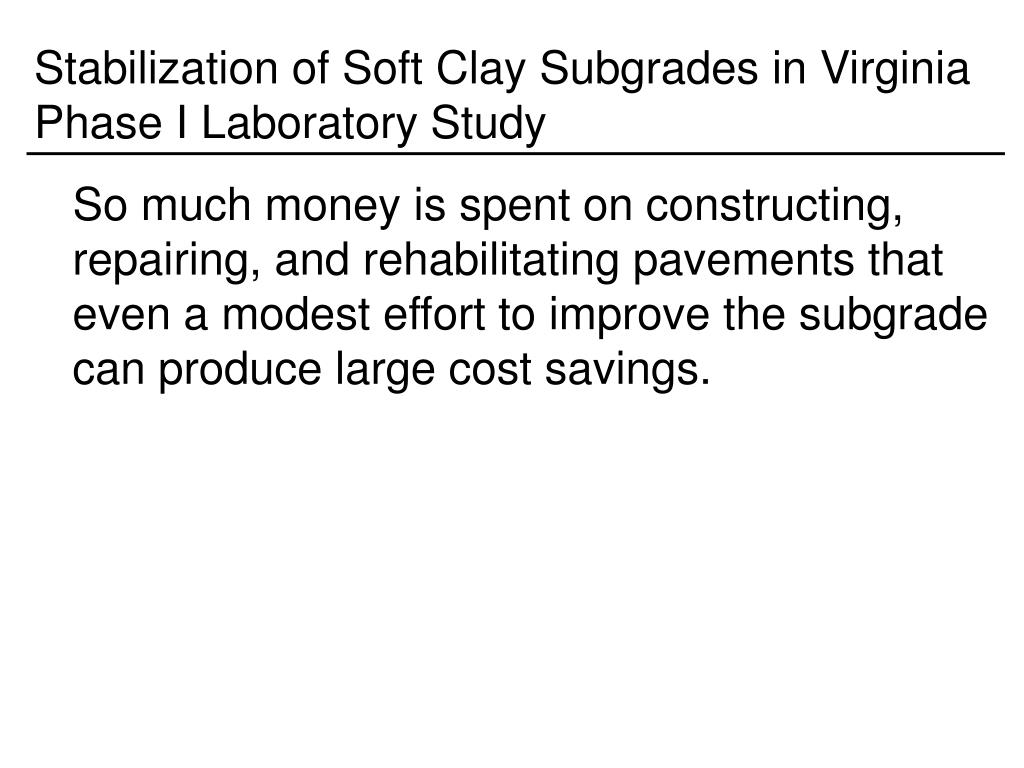

Stabilization of Soft Clay Subgrades in VirginiaPhase I Laboratory Study So much money is spent on constructing, repairing, and rehabilitating pavements that even a modest effort to improve the subgrade can produce large cost savings.
