1 / 21

IBL BP Integration and Service Organisation

IBL BP Integration and Service Organisation. SUMMARY BP insertion BP services Type01 bundles Cooling lines I-flex. Beam Pipe Integration. MPC positioned and surveyed in front of the marble table in building 113 (ATUIBLS_0132) Beam Pipe guided on the marble table’s rail

elke
Télécharger la présentation

IBL BP Integration and Service Organisation

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. IBL BP Integration and Service Organisation • SUMMARY • BP insertion • BP services • Type01 bundles • Coolinglines • I-flex

  2. Beam Pipe Integration • MPC positioned and surveyed in front of the marble table in building 113 (ATUIBLS_0132) • Beam Pipe guided on the marble table’s rail • ~0.2 mm clearance with respect to IPT MARBLE TABLE MPC with IPT

  3. Beam Pipe Integration • Successfully inserted on the IPT on AUGUST 2013

  4. Beam Pipe Services • 3 thermocouples and 12 heaters wires on each side • Integration very tricky because of a lack of space: • New flange with nitrogen connection • IBL service wrapping • Thermocouple connectors (removed)

  5. IBL SERVICE OVERVIEW • Intermediate Flexes (28, identical) • Type01 bundles (28, 4 flavors, see ATU-SYS-CD-0007) • Cooling lines (14 inlet (OD 1.7 mm) and 14 outlet (OD 2.2 mm) IP Type01 bundles and cooling lines PP1 AREA I-Flexes

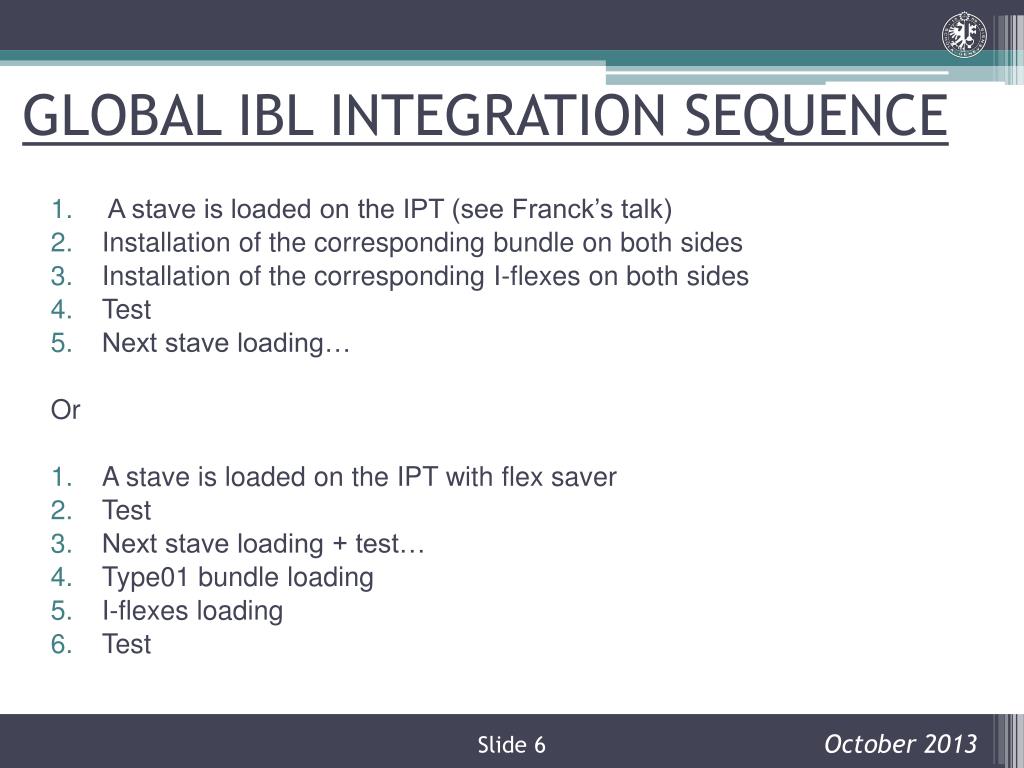

  6. GLOBAL IBL INTEGRATION SEQUENCE • A stave is loaded on the IPT (see Franck’s talk) • Installation of the corresponding bundle on both sides • Installation of the corresponding I-flexes on both sides • Test • Next stave loading… Or • A stave is loaded on the IPT with flex saver • Test • Next stave loading + test… • Type01 bundle loading • I-flexes loading • Test

  7. IBL TYPE01 BUNDLE • 5 Z stoppers are implemented all along the type01 bundle to manage the needed overlength (CTE mismatch) and strain relieve the PP0 area. • Manufacturing according to drawing ATUIBLP_0034. • Bundle n°06 reached most of the requirements • Last point to be solved: • End of the lacing at PP1 • Type of cable (gage24)

  8. TYPE01 BUNDLE TOOLING • Z stopper tool (ATUIBLS_0131) for both bundle flavors (A and C): • Z stopper position within 0.1mm • No force in the bundle • Pre-shaping of the waves • A complete procedure has been developed and validated • A technician has been trained to perform this task

  9. TYPE01 BUNDLE INTEGRATION In collaboration with SLAC team Type 1 bundles are systematically protected Type 1 bundles precisely mounted in Z stoppers HYSOL 9394 is applied (masking technic) Type 1 bundles are systematically checked (Geometry + electrically) Several type01 bundle integration tests done on the IPT

  10. COOLING LINE INTEGRATION In collaboration with Eric Vigeolas CCPM • Requirements: • Cooling lines precisely cut • CTE mismatch management (1.6 mm contraction at -40°C) • Loading without interferences with respect to the neighboring type01 bundles CL compression by 2 mm overlength Single Z stopper CL location (both sides)

  11. COOLING LINE INTEGRATION In collaboration with Eric Vigeolas CCPM • Compression tests on the CL: • CL integrated on the IPT with Z stoppers of bundles • Dynamometer is implemented on the EoS ring • 2 mm compression of the CL at PP1 • Maximum force before and after buckling are saved • Compression of the CL from 2mm to 0.5 mm (cooling configuration)

  12. I-flex Integration Integration requirements: • I-Flexes nominal dimensions according to drawing ATUIBLP_0098 (C.BAULT) • No disconnection of connectors if a small offset in Z is present (+/-2mm). • Mounting / un-mounting without applying any force on the IPT. A tool is going to be used to systematically check the nominal length and the height of each I-flex

  13. I-flex Integration In collaboration with Ole ROHNE’s team • Test set-up to evaluate the reaction forces corresponding to a +- 2 mm displacement with respect to nominal position. • Procedure: • I-Flex installed in nominal position • I-Flex is pulled +1 and +2 mm • Back in nominal • I-Flex is compressed -1 and -2 mm +2mm -2mm

  14. I-flex Integration In collaboration with Ole ROHNE’s team

  15. I-flex Integration on IPT • Both mounting and un-mounting tests have been done on the real IPT • I-flex integration is performed after having mounted the stave and type one bundles • No specific tools are needed to mount the I-flex on the IPT (no pressure on the IPT) • Nospecific tool is used to un-mount the I-flex, excepted a specific brucelle (no pressure on the IPT)

  16. KEY POINTS OF INTEGRATION OF IBL SERVICES • The stave is integrated on the IPT • The CL Z stopper is already glued on the CL and positioned on the IPT • Type one bundles are integrated on the IPT • The cable board is not loaded in the IPT clips • I-flex integration • We connect the I-flex on the cable board starting with the innermost connector • We connect the I-flex on the stave flex connectors starting with the innermost connector • The stave flex is clipped on the IPT • The cable board is clipped on the IPT • The NTC sensor is bonded on the cooling sleeve • Is the space compatible with the bonding process?

  17. INTEGRATION OF IBL SERVICES I-flex 1rst connected 1rst connected NTC sensors

  18. CONCLUSION: • Type01 bundles: • Procedure has been developed and validated • Technician trained • I-Flex: • Geometry controls • Pull tests • CL Integration • 1st integration test • Z stopper prototyping • General • Envelope Jig to validate the envelope before the closing of the MPC

  19. CONCLUSION: what remains to be done / solved / tested • Type01 bundles: • What is the delivery plan ? • Accelerate the Z stopper preparation process: 7 weeks (glue hardening, too long): • Other glue • Accelerated cure (check integration clearances) • I-Flex: • Production schedule ? • Safe mating after integration of the complete I-flex set • Cooling Integration • Validation test • Z stopper production (material, bonding process) • Tool to cut the cooling line precisely • Z stopper compatibility with cooling fitting tightening tool (LAPP/ Didier LAPORTE)

  20. CONCLUSION: what remains to be done / solved / tested • General: • Integration test with final production material • Integration of the PP1 area (extremely tight packing and still missing sealing ring, cooling fittings…) • Detailed integration procedure of the services on the IPT • Feedback from LAPP about wrapping compatibility of the new BP diablo

  21. THANK YOU FOR YOUR ATTENTION
