WP4 Progress Report User Community Enlargement and Applications Support. PSC06 Meeting, Sarajevo, 22 nd November 2007. Asli Zengin, Onur Temizsoylu TUBITAK ULAKBIM Ankara, Turkey. WP4 Objectives. Ensure multi-disciplinary Grid environment
E N D
WP4 Progress ReportUser Community Enlargement and Applications Support PSC06 Meeting, Sarajevo, 22nd November 2007 Asli Zengin, Onur Temizsoylu TUBITAK ULAKBIM Ankara, Turkey The SEE-GRID-2 initiative is co-funded by the European Commission under the FP6 Research Infrastructures contract no. 031775
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 WP4 Objectives Ensure multi-disciplinary Grid environment Identify target Grid communities and applications Support regional applications’ gridification, deployment and usage
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 WP4 Deliverables and milestones Deliverables D4.1 - User community survey and applications expansion, M04 (RBI) D4.2 - Application deployment and support, M12 (TUBITAK) D4.3 - Developer’s Guide for Porting to the Grid, M20 (RBI) D4.4 - User community engagement and Applications assessment, M24 (RBI) Milestones M4.1 Potential application groups identified, M04 M4.2 A number of inter-disciplinary applications running on the regional Grid, M24
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 WP4 Activities A4.1 - Study and propose multi-disciplinary Grid applications carry out survey and study of potential Grid applications in the region, and help identify the target applications for adaptation and deployment A4.2 - Adapt regional applications of interest support for initial application gridification and deployment A4.3 - Support the deployed applications operational and user support of the deployed applications A4.4 - Asses applications Grid usage and take-up assess and quantify the applications usage of the infrastructure, and application take-up in the community.
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 A4.1 Overview Study and propose multi-disciplinary Grid applications Currently there are 23 SEE-GRID-2 applications: 17 old (from the beginning of project) 6 new applications (recently filled in simplified questionnaire) No more new applications will be accepted (project time left is limited) EXCEPT from Albania from Bosnia and Herzegovina
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Critical Points for Countries Moldova - PRNNS Still in one cluster mode. Gridification steps identified: A single grid job to submit tasks manually, also making use of data management for input/output files Organize workflows parallelize the neural network training process for running on several CEs What about ASG support? (Ivica Dimitrovski, Cevat Şener, Miklos Kozlovszky)
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Critical Points for Countries • Albania – New Application(s) • More concrete information needed! • “At FIE researchers are trying to invent something in collaboration with Antun.” • What is this? More details? • Use of optimization software (SimAnnTSP) developed at INIMA. • Any application identified? • Bosnia and Herzegovina – New Applications • Fill in the questionnaire until November 23, Friday, ARC to assess until December 10. • PARSIMLOC (done on own funds, completed) • Is it deployed in grid? • PMFSA (pension funds) • progressing nicely, Haris has found people for it. • PFE for CBIR (already reviewed at the beginning of the project, being developed) • UoBL started gridification • Application will be deployed before the end of the project (This is a stable running application that has just to be ported to grid. • ETFIS (magnetic fields simulations - currently running, written in fortran) • They started to port their existing application to grid
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 A4.2 Overview Adapt regional applications of interest - Support the deployed applications Application lifecycle defined in “Gridification Guidelines” document. SG Gridification Guide (wiki pages) structured and still contributed by developers. Policy: Applications initially supported at the country level. Application Support Group (ASG) created for gridification support. Application Review Committee(ARC) created to assess existing and new candidate applications. Application selection criteria defined by ARC. MoU Between Applications and SEEGRID-2
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 SG Gridification Guide Wiki LEGEND • Black - Unchanged slide content • New contributions since Thessalonica • Status OK if a slide is black and/or green: done or scheduled in Thessalonica or done in the meantime • Issues to be commented or addressed in Sarajevo • New comments and issues just to be noted
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Wiki Status (Albania) • Polytechnic University of Tirana, Faculty of Electrical Engineering, Electronic Department, Section of Computer Engineering and Telecommunications • Workflows (T7) - Participation • Gridification of an application using parameter study workflow • Significant polishing of text is needed
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Wiki Status (Bosnia-Herzegovina) • Faculty of Natural Sciences, University of Sarajevo • Data Access (T4) - Participation • Extra contribution • gfstream: fstream-like classes that use gfal API and boost iostreams • Initial implementation done • To be published by new deadline November 30 2007 • P-GRADE Portal (T1-T9 related investigation area) - Participation • Perl vs P-GRADE Grid portal comparative study on application using MPI + gfal + GSL and Cubpack++ library • To be published by new deadline November 30 2007
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Wiki Status (Bulgaria) • IPP-BAS, Department of Parallel Algorithms • Advanced Replica Management (T2, T6 related investigation area) - Editor/Lead contributor • Seems that there is no interest for FTS/FPS-FTS contribution by December 31, 2007. • UoB contributed with Managing Sets of Files and Replicas Within LFC Catalog • Running Jobs (T1) - Python • Job submission using Python WMProxy • Still in progress
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Wiki Status (Croatia) • RBI/CIC • Interactive Job Pooling (T1 related investigation area) - Editor/Lead contributor • Interactive jobs using bypass • Interactive jobs using rrs • Interactive jobs using ssh • Job output monitoring using job perusal • Job output monitoring using grid-stdout-mon • Pilot jobs using centralized storage • High-level mathematical processing services • Extra contribution • Group within Inter-Job Communication? • Implementation details to be published by the end of October 2007 • Component-based application design (PARF, Virtue, VEPPAR, QRBG service) to be published by the end of 2007? • Usage guide to be published by the end of 2007? • Visualisation (IJC?) • Extra contribution, to be published by the end of October 2007, still pending • Web Authentication and Authorization (T8) • Simple Apache-SSL integration and DN-based authentication • Simple Tomcat-SSL integration and DN-based authentication • MPI (T9) - Participation • Using MPI in Fortran • Extra contribution
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Wiki Status (FYR of Macedonia) • Faculty of Electrical Engineering and Information Technologies, Ss. Cyril and Methodius University • Data Management (T2) - PHP+scripting • Data Management using PHP and shell scripts • To be published by 15 September 2007, still pending, Margita will contact Boro for details. • Running Jobs (T1) - PHP+scripting • Job submission using PHP and shell scripts • Job submission using Java WMProxy • Institute of Informatics, Faculty of Natural Sciences and Mathematics, Skopje • Running Jobs (T1) - Java • Generating VOMS Proxy Using Java API • Workflows (T7) - Participation • DAG job submission in Java • To be published by the end of 2007?
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Wiki Status (Hungary) • SZTAKI • MPI (T9) - Participation • Executing MPI applications using P-GRADE Portal • P-GRADE (T1-T9 related investigation area) - Editor/Lead contributor • P-GRADE White paper • P-GRADE Portal (T1-T9 related investigation area) - Editor/Lead contributor • P-GRADE Portal • Planning to extend it with Portlet programming section • Workflows (T7) - Editor/Lead contributor • Workflows
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Wiki Status (Montenegro) • Center of Information Systems - University of Montenegro • Web Authentication and Authorization (T8) - Editor/Lead contributor • To be published by new deadline November 30, 2007
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Wiki Status (Romania) • INCAS • MPI (T9) - Participation • Announced contribution to "Usage of different Fortran and C compilers with MPICH", "Libraries and softwares based on MPI paradigm" • No timeline defined, still pending, Gabriel will contact application developers. • University Politehnica of Bucharest • Application-Level Event Logging & Performance (T5) - Editor/Lead contributor • In preparation, TOC posted, to be published by 15 December 2007? • Installing and configuring guide for MonALISA • User guide for ApMON • User Guide for LISA • Performance analysis. Case studies
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Wiki Status (Serbia 1/2) • UoB-RCUB • Data Management (T2) - Editor/Lead contributor • Introduction to Data Management Tools and APIs • SEE-GRID File Management Java API (Updated) • Interactive Job Pooling (T1 related investigation area) - Participation • An overview of a work in progress - to be published by 1 December 2007 • Logical Files (T6) - Editor/Lead contributor • Data Management Web Portal - User Guide • Data Management Web Portal - Configuration and Integration with Applications • Software Installation Management (T3) - Participation; acting as Editor/Lead contributor • Software Installation Management Guide (Updated) • MPI (T9) – Participation • Using MPI with PETSc library (UoB) • Advanced Replica Management (T2, T6 related investigation area) - Participation • Managing Sets of Files and Replicas Within LFC Catalog • Application-Level Event Logging & Performance (T5) - Participation • Contributed to CSANU’s Template Based Submission and Benchmarking of MPI Jobs, Varying Jobs and Job Sets • May contribute with event logger & Web app (aggregation, etc.) by 1 December 2007. The original one was used in VIVE
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Wiki Status (Serbia 2/2) • Institute of Physics Belgrade • Running Jobs (T1) - Editor/Lead contributor; Scripting+C • Submission and monitoring of jobs via Network Server using the command line interface • Submission and monitoring of jobs via WMProxy using the command line interface • Data Management (T2) - Command line • Low Level Tools • High Level Tools • Use Cases • Logical Files (T6) - Participation • File Names and LFC • Application-Level Event Logging & Performance (T5) • Job Timing and Status Statistics • University of Kragujevac, CSANU • MPI (T9) - Editor/Lead contributor • Waiting for contributions from INCAS! • Introduction to the parallel computing paradigms • Example of the message passing code • MPI on the GRID: the batching environment - typical scripts • Application-Level Event Logging & Performance (T5) • Template Based Submission and Benchmarking of MPI Jobs, Varying Jobs and Job Sets
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Wiki Status (Switzerland) • CERN • Web Authentication and Authorization (T8) • Simple Tomcat-SSL integration and DN-based authentication • Simple Apache-SSL integration and DN-based authentication
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Wiki Status (Turkey) • Bilkent University, Department of Computer Engineering • P-GRADE Portal (T1-T9 related investigation area) – Participation • P-GRADE Portal, section "Example gridification of a bioinformatics application“ (user erayo) • Data Access (T4) - Participation • Extra contribution, to be completed by new deadline December 1, 2007. • Workflows (T7) - Participation (by METU actually) • MPI (T9) • Extra contribution, to be completed by new deadline December 1, 2007. • Middle East Technical University, Department of Computer Engineering • Data Access (T4) - Editor/Lead contributor - GFAL • Preparing the outline - by September 15, 2007 - currently, there is just a brief list of GFAL functions! • Adding introductory and descriptive information by September 30, 2007, still pending • Adding examples - by October 15, 2007, still pending • P-GRADE Portal (T1-T9 related investigation area) - Participation • Participation to the current missing parts (user birsen, METU) • Workflows (T7) - Participation (user birsen, METU)
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Gridification Guide Recommendations • If you contribute after December 1st, you may miss the D4.3 train • Keep sync with others, particularly with the topic leader • Try to avoid overlapping • Review and improve others’ contributions • Provide original contributions outside of gLite User Guide • RBI has already prepared an early D4.3 draft; TOC is being finalised • Update both Wiki and .doc, if there are no significant changes • Otherwise paste from Wiki and apply formatting of existing .doc content • We are migrating Wiki -> .doc. Consolidate look and formatting of your contribution within .doc • Make internal links within D4.3 using cross-references “Section x.y” • Make external (Web) links printable: use references or insert URLs • Consistent examples, figures, captions, title capitalisation etc. • Some contributions inform on contributing person/institution. Do it whenever appropriate, but not if you are just doing minor additions, corrections of giving informative overview without significant original contribution

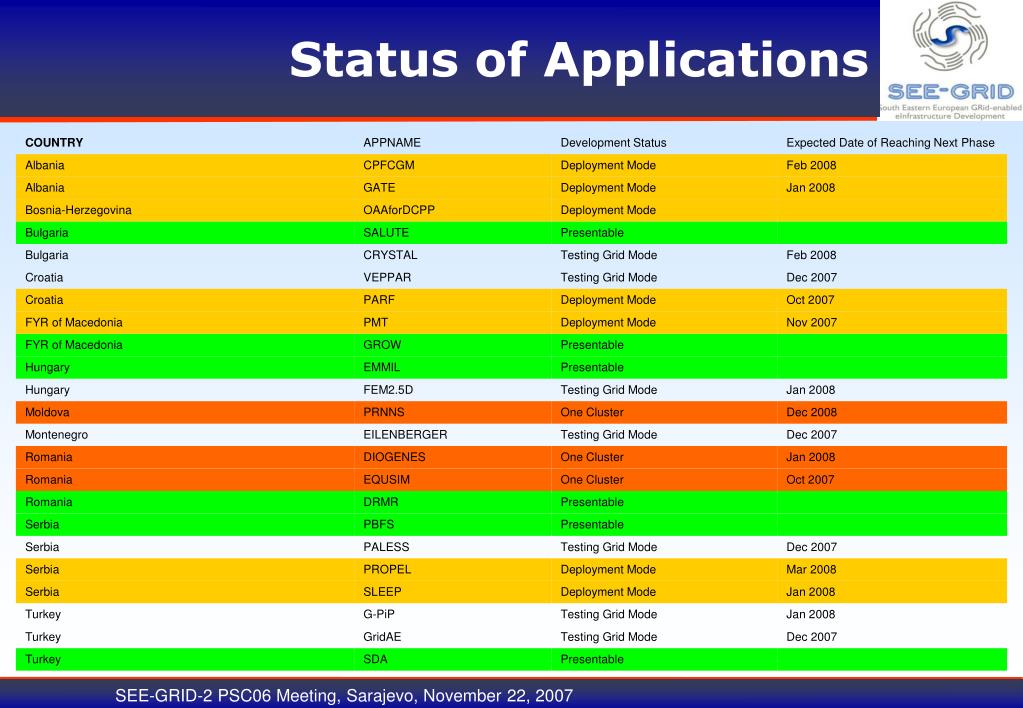

SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Status of Applications COUNTRY APPNAME Development Status Expected Date of Reaching Next Phase Albania CPFCGM Deployment Mode Feb 2008 Albania GATE Deployment Mode Jan 2008 Bosnia-Herzegovina OAAforDCPP Deployment Mode Bulgaria SALUTE Presentable Bulgaria CRYSTAL Testing Grid Mode Feb 2008 Croatia VEPPAR Testing Grid Mode Dec 2007 Croatia PARF Deployment Mode Oct 2007 FYR of Macedonia PMT Deployment Mode Nov 2007 FYR of Macedonia GROW Presentable Hungary EMMIL Presentable Hungary FEM2.5D Testing Grid Mode Jan 2008 Moldova PRNNS One Cluster Dec 2008 Montenegro EILENBERGER Testing Grid Mode Dec 2007 Romania DIOGENES One Cluster Jan 2008 Romania EQUSIM One Cluster Oct 2007 Romania DRMR Presentable Serbia PBFS Presentable Serbia PALESS Testing Grid Mode Dec 2007 Serbia PROPEL Deployment Mode Mar 2008 Serbia SLEEP Deployment Mode Jan 2008 Turkey G-PiP Testing Grid Mode Jan 2008 Turkey GridAE Testing Grid Mode Dec 2007 Turkey SDA Presentable
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Albania – CPFCGM(Electrical) • Current Application Status: Deployed • Next Status: January/February 2008 • Current User Community: • Exact number of current users: 1 • Exact number of direct beneficiaries from the application and its results: 1 • Number of sites that currently the application can run: All SEE-GRID sites (P-GRADE Portal) • Current estimated application accounting: 353 Jobs, 198.66 CPU Hours • Any points to be conveyed to PSC: The last task of the application - collection and blending together of results is in debugging phase.
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Albania – GATE(Bioinformatics) • Current Application Status: Deployed • Next Status: unknown • Current User Community: • Exact number of current users: 3 • Exact number of direct beneficiaries from the application and its results: 3 • Number of sites that currently the application can run: 1 (BG04-ACAD) • Current estimated application accounting: unknown • Any points to be conveyed to PSC: None
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Bosnia & Herzegovina – OAAforDCPP (Business) • Current Application Status: Deployed • Next Status: March 2008 • Current User Community: • Exact number of current users: 3 • Exact number of direct beneficiaries from the application and its results: 3 • Number of sites that currently the application can run: All SEE-GRID sites • Current estimated application accounting: 1407 Jobs, 8.65 CPU hours • Any points to be conveyed to PSC: None
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Bulgaria – SALUTE(Electronics) • Current Application Status: Presentable • Current User Community: • Exact number of current users: 6 • Exact number of direct beneficiaries from the application and its results: 25 people from different institutions: IPP-BAS (Bulgaria), Institute of Microelectronics (TU-Vienna, Austria), Arizona State University (USA), RBI (Zgreb, Croatia), University of Skopje (FYROM) • Number of sites that currently the application can run: 24 Sites • Current estimated application accounting: 45968 Jobs, 58924.14 CPU hours • Any points to be conveyed to PSC: None
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Bulgaria – Crystal(Metallurgy) • Current Application Status: Testing Grid Mode • Next Status: February 2008 • Current User Community: • Exact number of current users: NA • Exact number of direct beneficiaries from the application and its results: NA • Number of sites that currently the application can run: No limitations • Current estimated application accounting: 2 Jobs, 0 CPU hours • Any points to be conveyed to PSC: None
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Croatia – VEPPAR(Computer Science) • Current Application Status: Testing Grid Mode • Next Status: December 2007 • Current User Community: • Exact number of current users: hard to tell, as in teaching each class may be of different size • Exact number of direct beneficiaries from the application and its results: NA (Hopefully many) • Number of sites that currently the application can run: All SEE-GRID sites • Current estimated application accounting: 1464 Jobs, 3097.69 CPU hours • Any points to be conveyed to PSC: There is a demonstration scenario in the recent progress report.
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Croatia – PARF(Computer Science) • Current Application Status: Deployed • Next Status: December 2007 • Current User Community: • Exact number of current users: teams • Exact number of direct beneficiaries from the application and its results: NA (hopefully many) • Number of sites that currently the application can run: 15 • Current estimated application accounting: 200 Jobs, 423 CPU hours, 1000 hours (Not directly from accounting statistics, but stated in progress report.) • Any points to be conveyed to PSC: None
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 FYR of Macedonia – PMT(Computer Science) • Current Application Status: Deployed • Next Status: November 2008 • Current User Community: • Exact number of current users: 50 • Exact number of direct beneficiaries from the application and its results: 50 • Number of sites that currently the application can run: No limitations • Current estimated application accounting: 22 Jobs, 0.01 CPU hours • Any points to be conveyed to PSC: None
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 FYR of Macedonia – GROW(Computer Science) • Current Application Status: Presentable • Current User Community: • Exact number of current users: 4 • Exact number of direct beneficiaries from the application and its results: 4 • Number of sites that currently the application can run: 6 • Current estimated application accounting: 2877 Jobs, 3639.1 CPU hours • Any points to be conveyed to PSC: The application is implemented in Java and is based on WMProxy and LBProxy web services. It can be used to submit to the grid without installing an UI. It runs even on windows
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Hungary – EMMIL(Business) • Current Application Status: Presentable • Current User Community: • Exact number of current users: <5 • Exact number of direct beneficiaries from the application and its results: NA • Number of sites that currently the application can run: No limitations • Current estimated application accounting:15583 Jobs, 759.43 CPU hours • Any points to be conveyed to PSC: More info can be found here: http://indico.cern.ch/sessionDisplay.py?sessionId=23&slotId=0&confId=18714#2007-10-01
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Hungary – FEM2.5D(Geophysics) • Current Application Status: Testing Grid Mode • Next Status: January 2008 • Current User Community: • Exact number of current users: <10 • Exact number of direct beneficiaries from the application and its results: NA • Number of sites that currently the application can run: mostly tested on SZTAKI site • Current estimated application accounting: 682 Jobs, 76.56 CPU hours • Any points to be conveyed to PSC: None
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Moldova – PRNNS(Computer Science) • Current Application Status: One Cluster • Next Status: December 2007 • Current User Community: • Exact number of current users: 5 • Exact number of direct beneficiaries from the application and its results: 5 • Number of sites that currently the application can run: 1 (MD-01-TUM) • Current estimated application accounting: 0 • Any points to be conveyed to PSC: None
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Montenegro – EILENBERGER(Physics) • Current Application Status: Testing Grid Mode • Next Status: December 2007 • Current User Community: • Exact number of current users: 5-10 • Exact number of direct beneficiaries from the application and its results: 5-10 • Number of sites that currently the application can run: SEE-GRID Sites Supporting MPI and FORTRAN • Current estimated application accounting: 109 Jobs, 0.03 CPU hours • Any points to be conveyed to PSC: Progress from PSC05: Grid portal (Gridsphere) installation and testing
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Romania – DIOGENES(Computer Science) • Current Application Status: One Cluster • Next Status: January 2008 • Current User Community: • Exact number of current users: 12 • Exact number of direct beneficiaries from the application and its results: 5 • Number of sites that currently the application can run: 2 Romanian Sites • Current estimated application accounting: 0 • Any points to be conveyed to PSC: None
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Romania – DRMR(Aeronatics) • Current Application Status: Presentable • Current User Community: • Exact number of current users: 6 • Exact number of direct beneficiaries from the application and its results: INCAS - National Institute for Aerospace Research, ROSA - Romanian Space Agency, INCS - Romanian Institute for Sport Research, UPB - University Politechnica Bucharest Aerospace Eng. Dep., IPA - Institute for research in Automation, STRAERO - Institute for Aerostructures • Number of sites that currently the application can run: 1 (RO-05-INCAS) – will be extended to other SEE-GRID sites in Dec 2007. • Current estimated application accounting: 0 (Due to accounting problem of RO-05) • Any points to be conveyed to PSC: None
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Romania – EQUSIM(Earth Science) • Current Application Status: One Cluster • Next Status: March 2008 • Current User Community: • Exact number of current users: 2 • Exact number of direct beneficiaries from the application and its results: 2 • Number of sites that currently the application can run: 1 (RO-07-NIPNE) • Current estimated application accounting: 0 • Any points to be conveyed to PSC: None • This application should progress faster. Gabriel, what do you think?
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Serbia – PBFS(Medical Imaging) • Current Application Status: Presentable • Current User Community: • Exact number of current users: 6 • Exact number of direct beneficiaries from the application and its results: 6 institutions: Center for Scientific Research of SASA and University of Kragujevac and Medical Faculty for Scientific for educational purpose, arvard School of Public Health, Boston, USA, Experimental usage at Clinical Center Kragujevac, Serbia, University of Heidelberg, Germany University of Munich, Germany, University of Vienna, Austria • Number of sites that currently the application can run: 11 sites • Current estimated application accounting: 1062 Jobs, 2155.18 CPU hours • Any points to be conveyed to PSC: MPI support required by PBFS.
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Serbia – PALESS(Electronics) • Current Application Status: Testing Grid Mode • Next Status: December 2007 • Current User Community: • Exact number of current users: 14 • Exact number of direct beneficiaries from the application and its results: 4 • Number of sites that currently the application can run: 1 site (AEGIS03-ELEF-LEDA) • Current estimated application accounting: 67 Jobs, 0.01 CPU hours • Any points to be conveyed to PSC: None
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Serbia – PROPEL(Astronomy) • Current Application Status: Deployed • Next Status: March 2008 • Current User Community: • Exact number of current users: 3 • Exact number of direct beneficiaries from the application and its results: >100 • Number of sites that currently the application can run: 11 sites • Current estimated application accounting: 71 Jobs, 684.2 CPUhours • Any points to be conveyed to PSC: “Number of successfully done jobs / number of jobs submitted” statistics available per site.
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Serbia – SLEEP(Electronics) • Current Application Status: Deployed • Next Status: January 2008 • Current User Community: • Exact number of current users: 4 • Exact number of direct beneficiaries from the application and its results: 50 • Number of sites that currently the application can run: 2 sites • Current estimated application accounting: 153 Jobs, 48.46 CPU hours • Any points to be conveyed to PSC: Application has been restructured. During restructuring phase core modules have been designated. These core modules help students to write their own SLEEP modules, and to test them. These student's modules have been developed as mandatory project assignments on Concurrent and Distributed Programming course. Until now, there were 40 modules developed in this manner, but only 3 of them were deployed as SLEEP modules
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Turkey – GPiP(Bioinformatics) • Current Application Status: Testing Grid Mode • Next Status: January 2008 • Current User Community: • Exact number of current users: 3 • Exact number of direct beneficiaries from the application and its results: NA • Number of sites that currently the application can run: 10 sites • Current estimated application accounting: 34 Jobs, 0.6 CPU hours • Any points to be conveyed to PSC: Developers would like some kind of automatic recovery in P-GRADE for parameter study jobs (and normal jobs, in fact). They shouldn't have to resubmit several jobs themselves. There is a very high failure rate of jobs, and it is inefficient to try to submit them over and over again.
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Turkey – GridAE(Computer Science) • Current Application Status: Testing Grid Mode • Next Status: December 2007 • Current User Community: • Exact number of current users: 5 • Exact number of direct beneficiaries from the application and its results: the robotics group from Kovan Lab. and the partners involved in robotics projects in collaboration with Kovan Lab. • Number of sites that currently the application can run: 3 sites • Current estimated application accounting: 257 Jobs, 9.71 CPU hours • Any points to be conveyed to PSC: None
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 Turkey – SDA(Earth Science) • Current Application Status: Presentable • Current User Community: • Exact number of current users: 4 • Exact number of direct beneficiaries from the application and its results: Kandilli Earthquake Observatory • Number of sites that currently the application can run: 2 sites (TR-01 and TR-05) • Current estimated application accounting: 105 Jobs, 0.25 CPU hours • Any points to be conveyed to PSC: Adding sensors repository of General Directorate of Disaster Affairs Earthquake Research Department is in plan

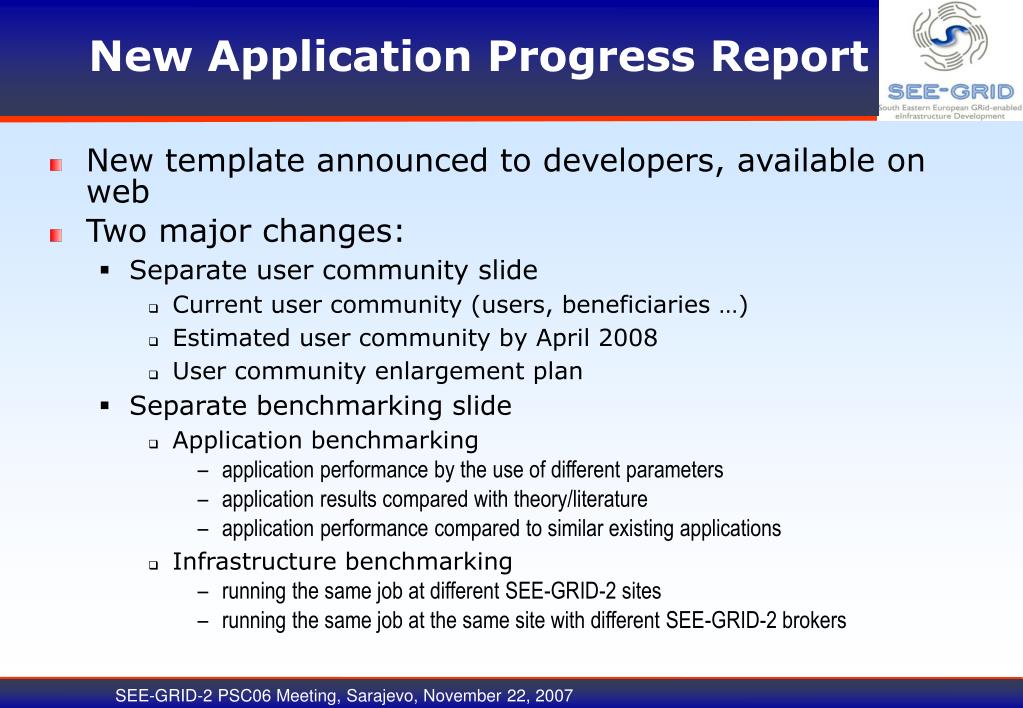

SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 New Application Progress Report • New template announced to developers, available on web • Two major changes: • Separate user community slide • Current user community (users, beneficiaries …) • Estimated user community by April 2008 • User community enlargement plan • Separate benchmarking slide • Application benchmarking • application performance by the use of different parameters • application results compared with theory/literature • application performance compared to similar existing applications • Infrastructure benchmarking • running the same job at different SEE-GRID-2 sites • running the same job at the same site with different SEE-GRID-2 brokers
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 A4.3 Overview • A4.3 - Support the deployed applications • ASG team, members already assigned for each application. • SEE-GRID-2 helpdesk available and to be used for problems. • SG Gridification Wiki online – ongoing. • Useful Helpdesk Tickets for Developers – done. • SEE-GRID Helpdesk – “Applications Support” knowledge base. • GOODs responsible to dump useful tickets of the week. • User Forum (proposed by Peter at PSC05) – pending, Ioannis? • Describe application monitoring, how? – pending, Antun? • WP3/WP4 collaboration – ongoing, what is the status of WP4 infrastructural requirements, Antun? • gLite-3.1 SL4.5 migration • Classic SE to DPM migration • Better MPI support at sites
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 A4.3 Overview • A4.3 - Support the deployed applications • ASG team, members already assigned for each application. • SEE-GRID-2 helpdesk available and to be used for problems. • SG Gridification Wiki online – ongoing. • Useful Helpdesk Tickets for Developers – done. • SEE-GRID Helpdesk – “Applications Support” knowledge base. • GOODs responsible to dump useful tickets of the week. • User Forum (proposed by Peter at PSC05) – pending, Ioannis? • Describe application monitoring, how? – pending, Antun? • WP3/WP4 collaboration – ongoing, what is the status of WP4 infrastructural requirements, Antun? • gLite-3.1 SL4.5 migration • Classic SE to DPM migration • Better MPI support at sites
SEE-GRID-2 PSC06 Meeting, Sarajevo, November 22, 2007 A4.4 Overview • A4.4 - Asses applications Grid usage and take-up SEE-GRID-2 Application Accounting Portal https://gserv1.ipp.acad.bg:8443/Welcome/ • Currently institute info is used to have an estimated accounting data per application. > Not reliable! • More precise accounting will be enabled with the use of VOMS application groups. • But many App. Groups still missing!!! • Since start of project (for 10 already deployed and 9 testing grid-mode applications): • around 70K jobs • around 70K CPU hours
