TFS2010 and Project Server 2010 collaboration: Making Agile Team Progress Visible to the Project Management Office

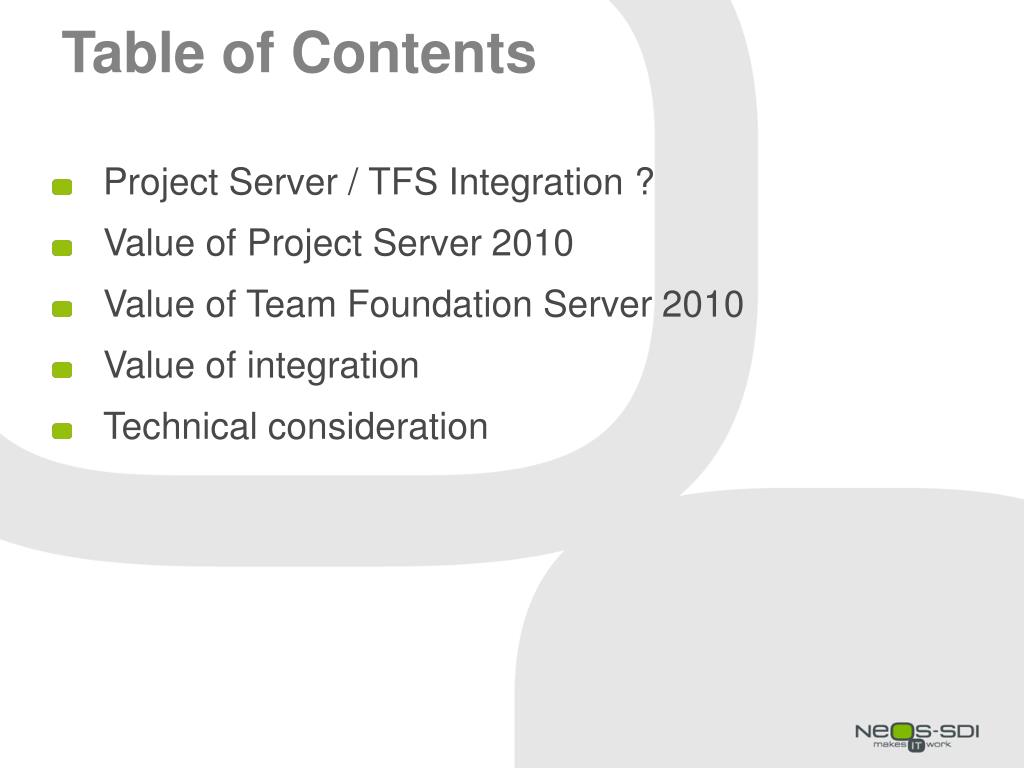

Table of Contents • Project Server / TFS Integration ? • Value of Project Server 2010 • Value of Team Foundation Server 2010 • Value of integration • Technical consideration
Your speaker • Sylvain Gross • BU Manager Europe/Switzerland • Technical leader of ALM/PLM workload • Methodology/Project Management expert • ALM Competency (Microsoft) certified • Black Belt 6 Sigma • sylvain.gross@neos-sdi.com • NEOS-SDI SA • WTCL - Avenue de Gratta-Paille 2 • CH–1018 LAUSANNE • Phone : +41 21 641 11 11

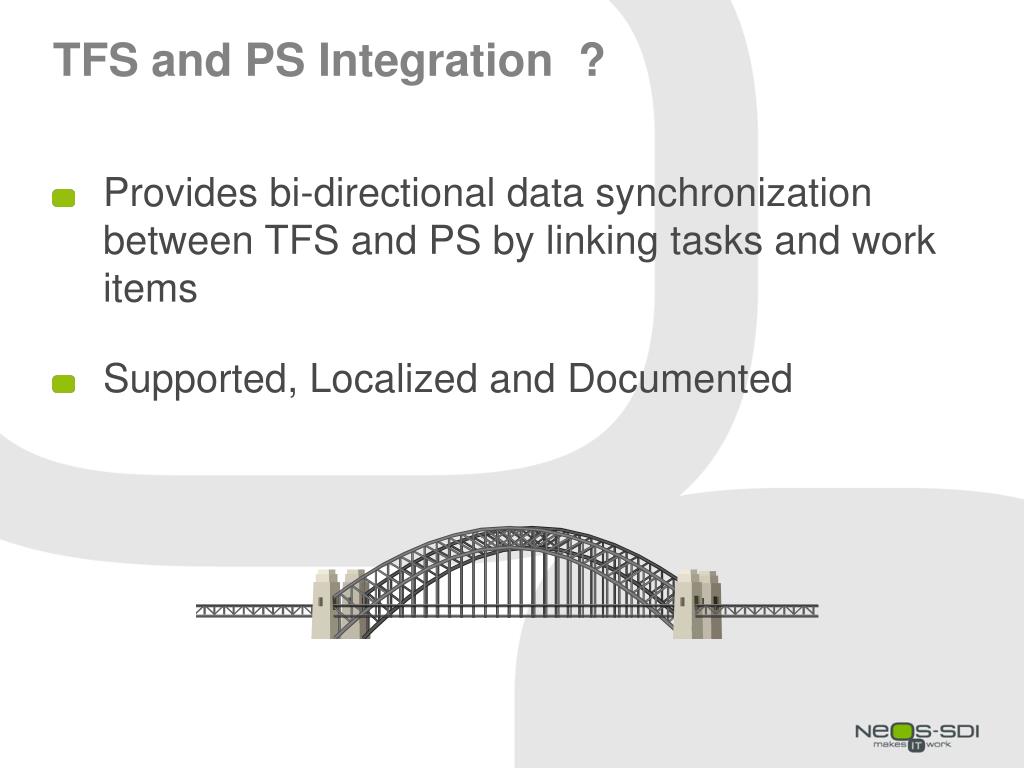

TFS and PS Integration ? • Provides bi-directional data synchronization between TFS and PS by linking tasks and work items • Supported, Localized and Documented
The Value of Project Server • Portfolio selection • Portfolio status • Schedule management • Resource management • Dependency management

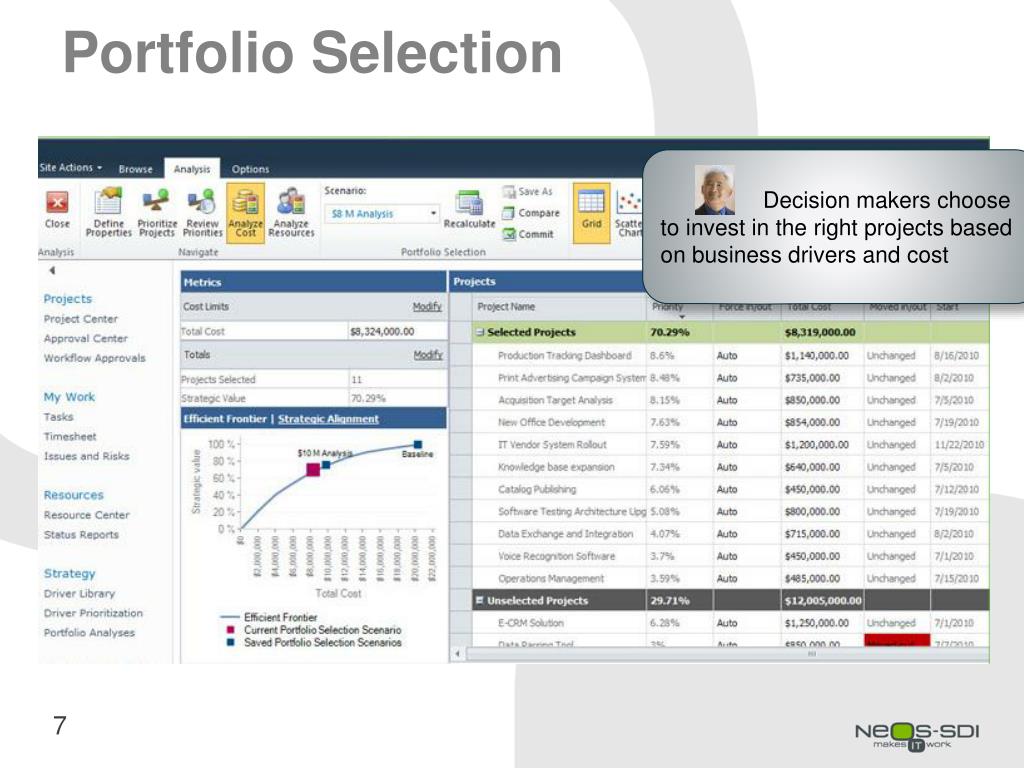

Portfolio Selection Decision makers choose to invest in the right projects based on business drivers and cost

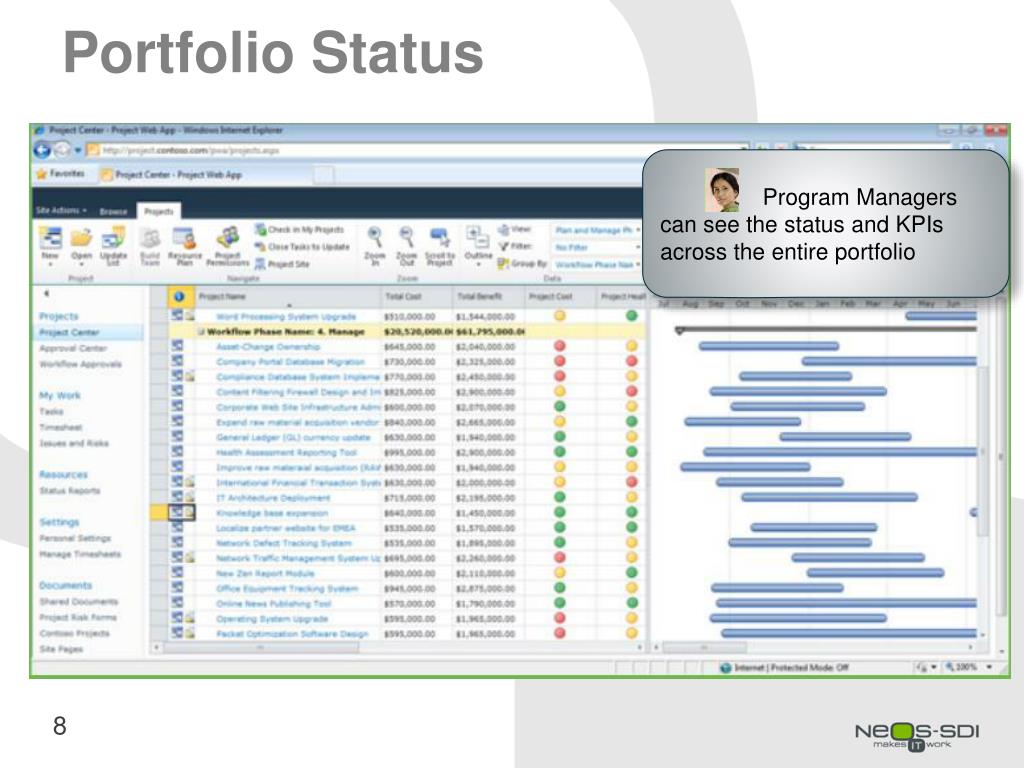

Portfolio Status Program Managers can see the status and KPIs across the entire portfolio

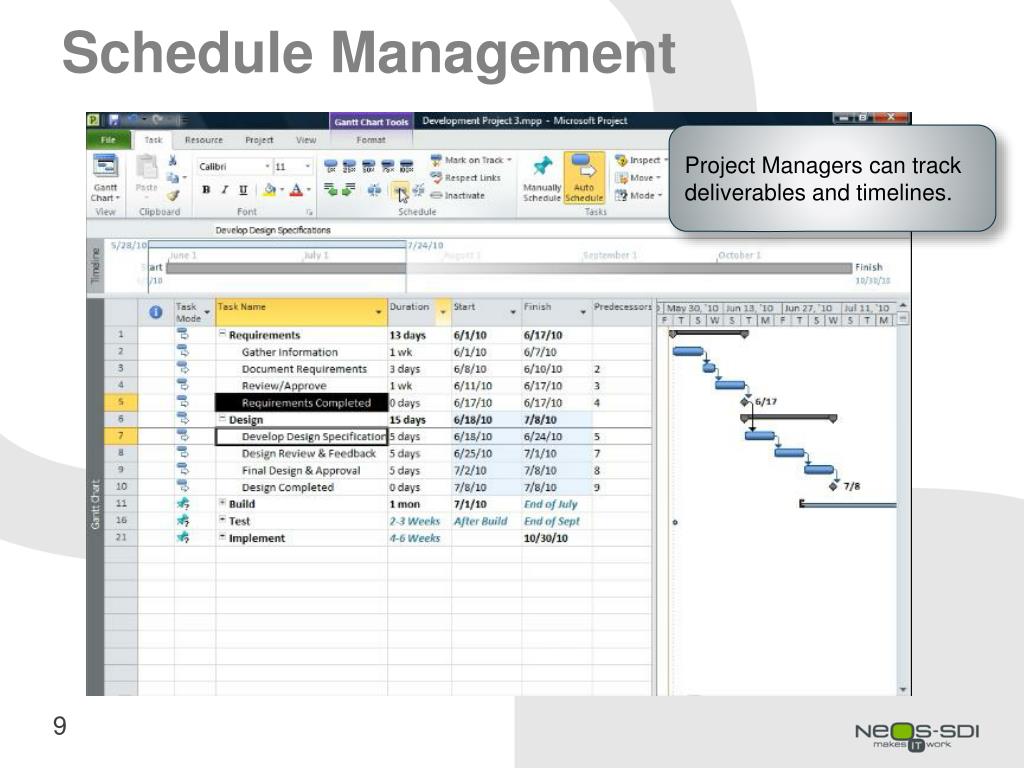

Schedule Management Project Managers can track deliverables and timelines.

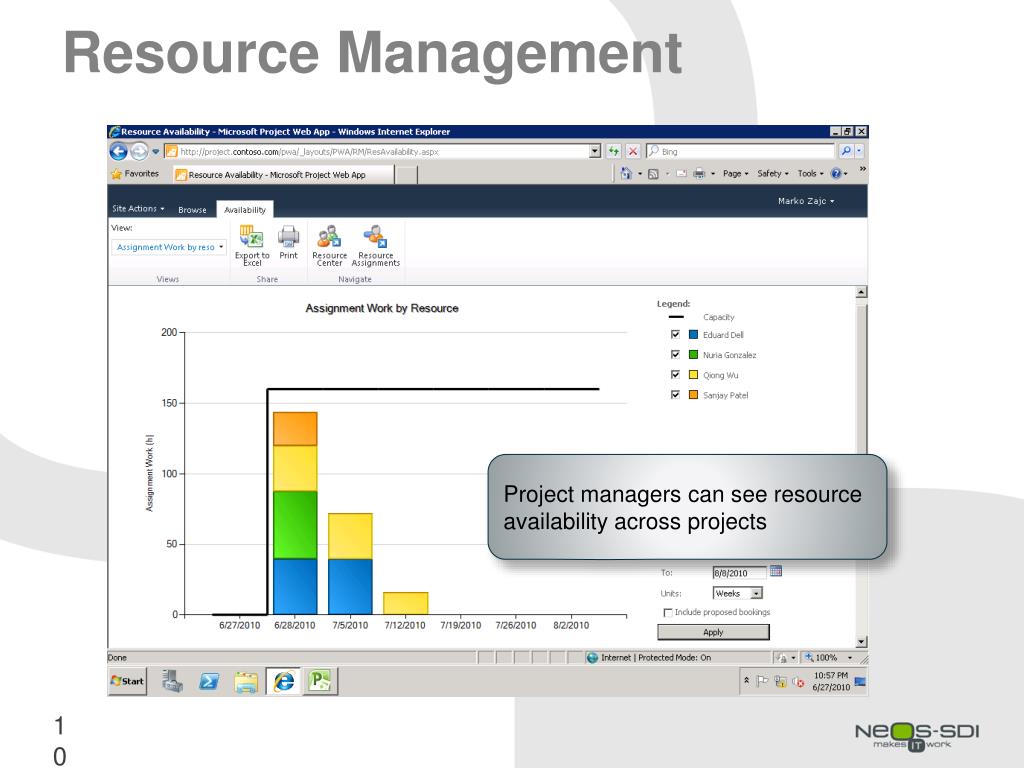

Resource Management Project managers can see resource availability across projects

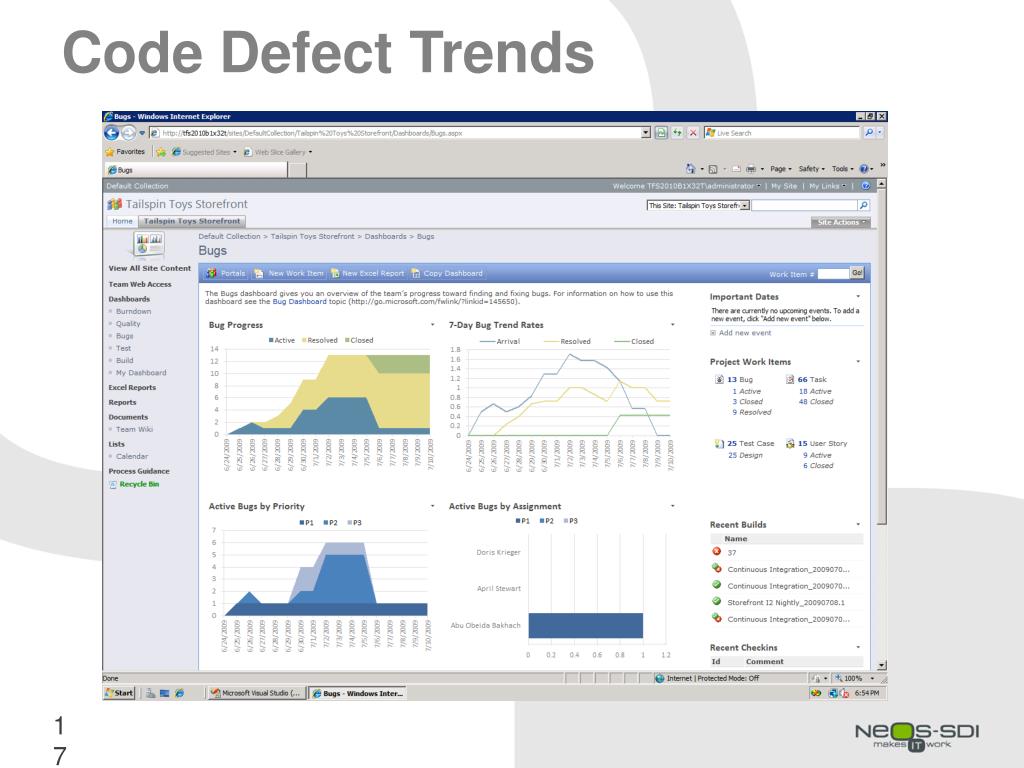

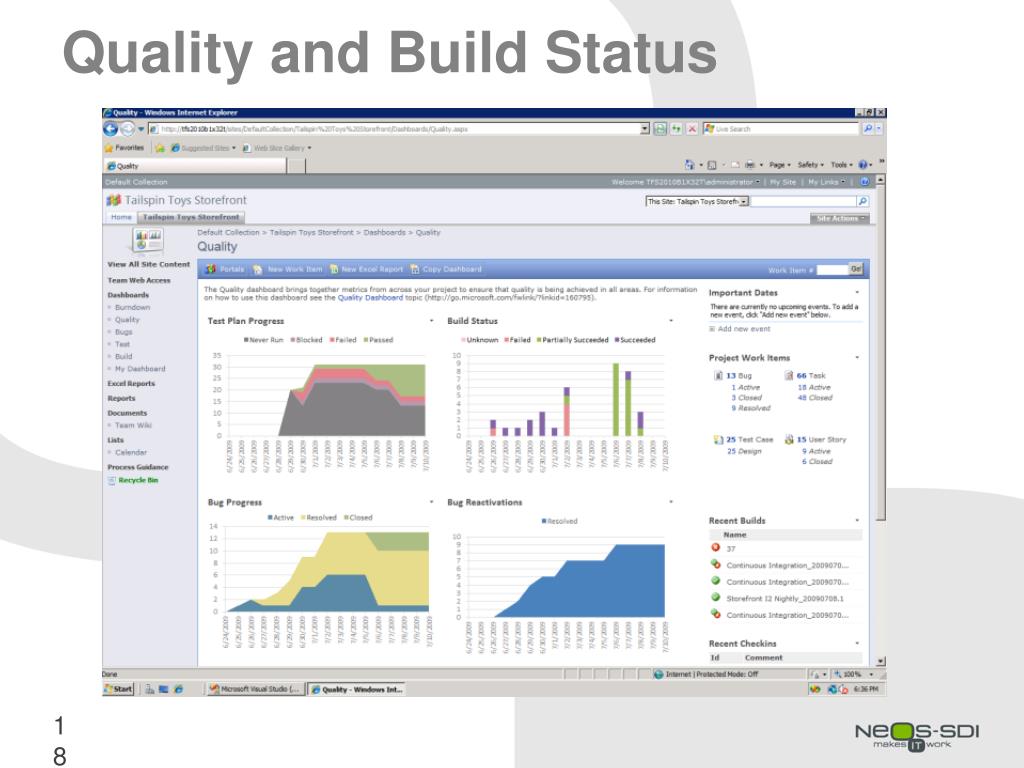

The Value of Team Foundation Server • Work management for development teams • Visibility into the development progress • Work progress • Test Results • Bug Trends • Build Status

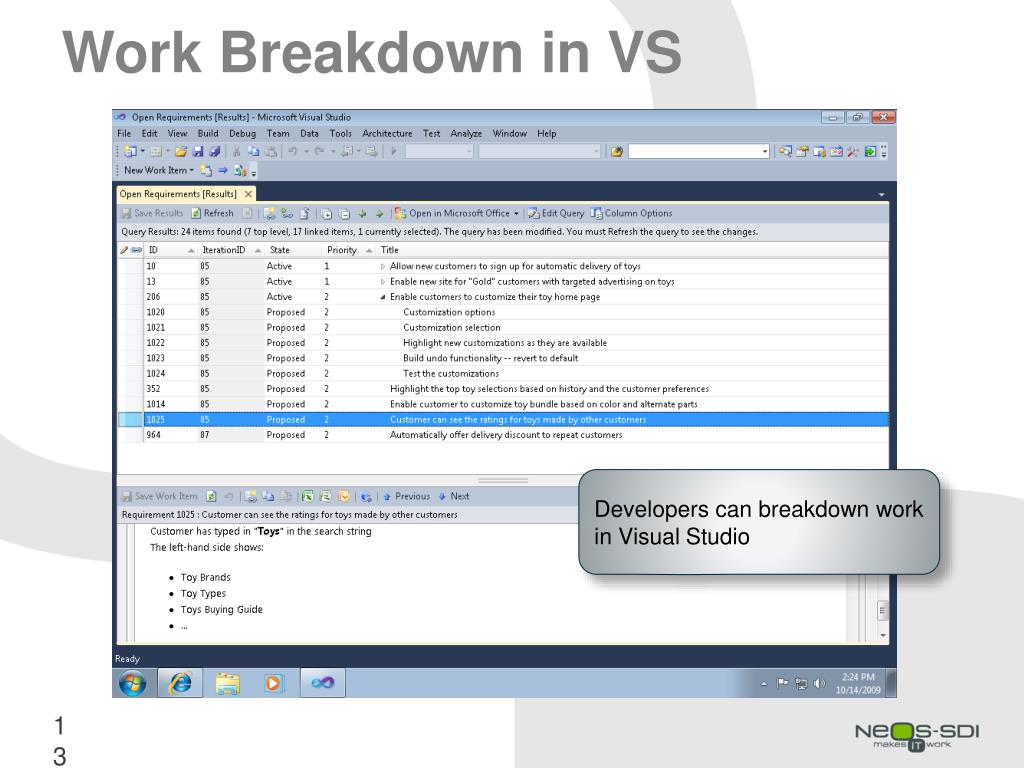

Work Breakdown in VS Developers can breakdown work in Visual Studio
Work Breakdown in Excel Teams can breakdown work in the Iteration planning workbook

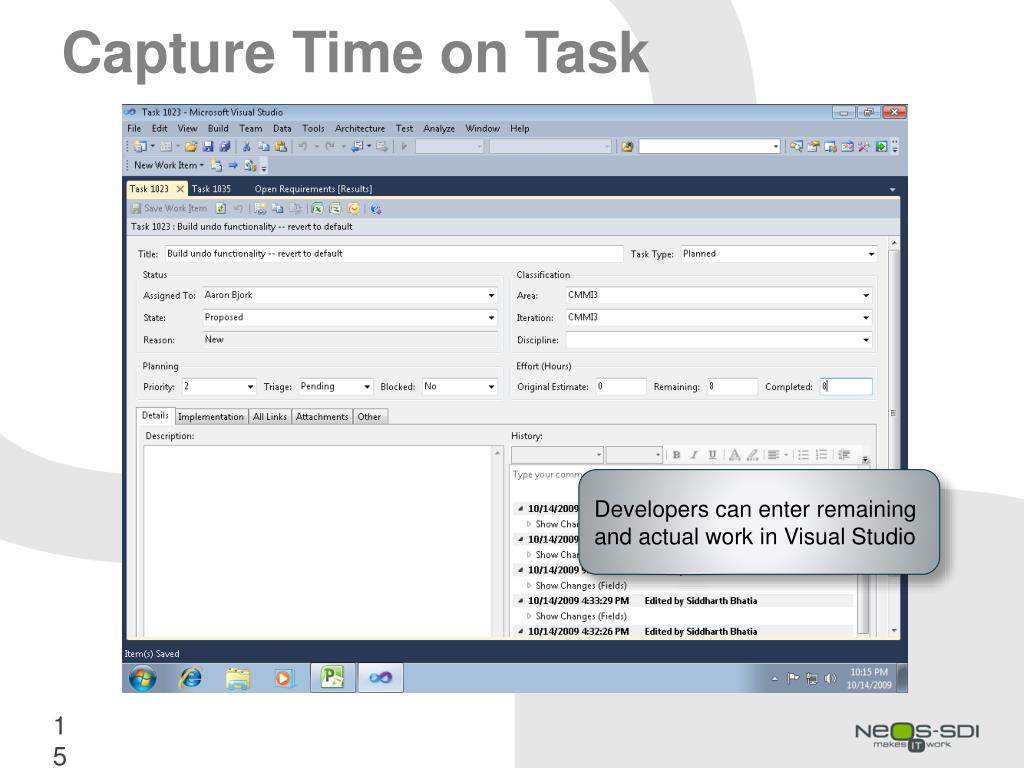

Capture Time on Task Developers can enter remaining and actual work in Visual Studio

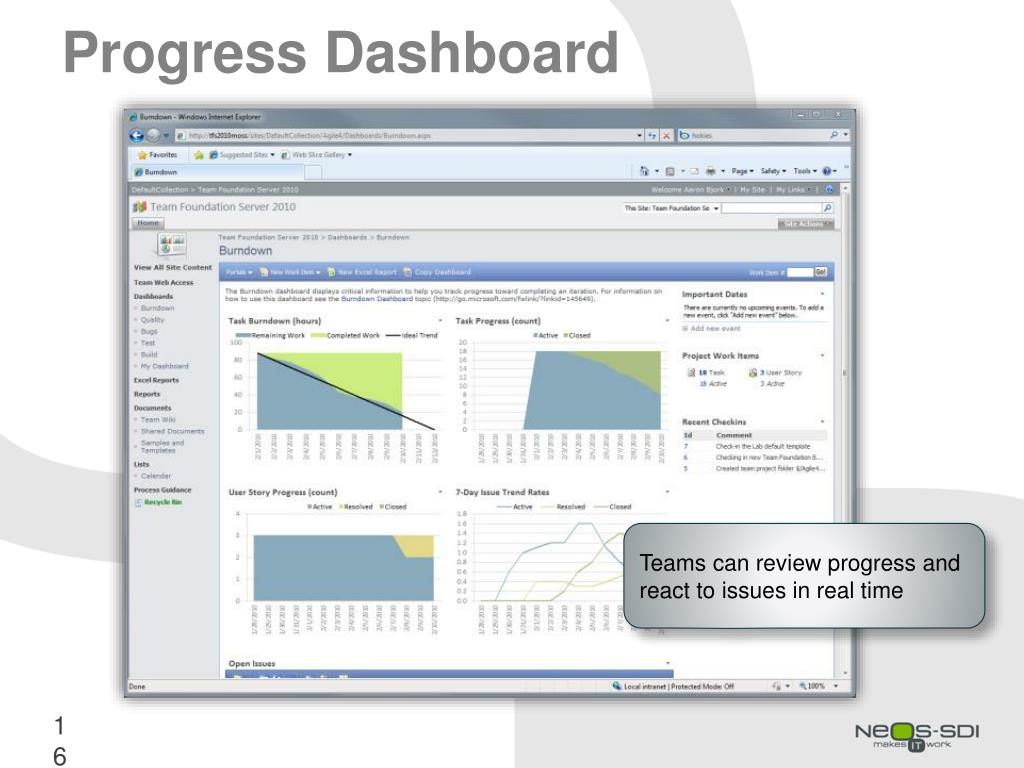

Progress Dashboard Teams can review progress and react to issues in real time

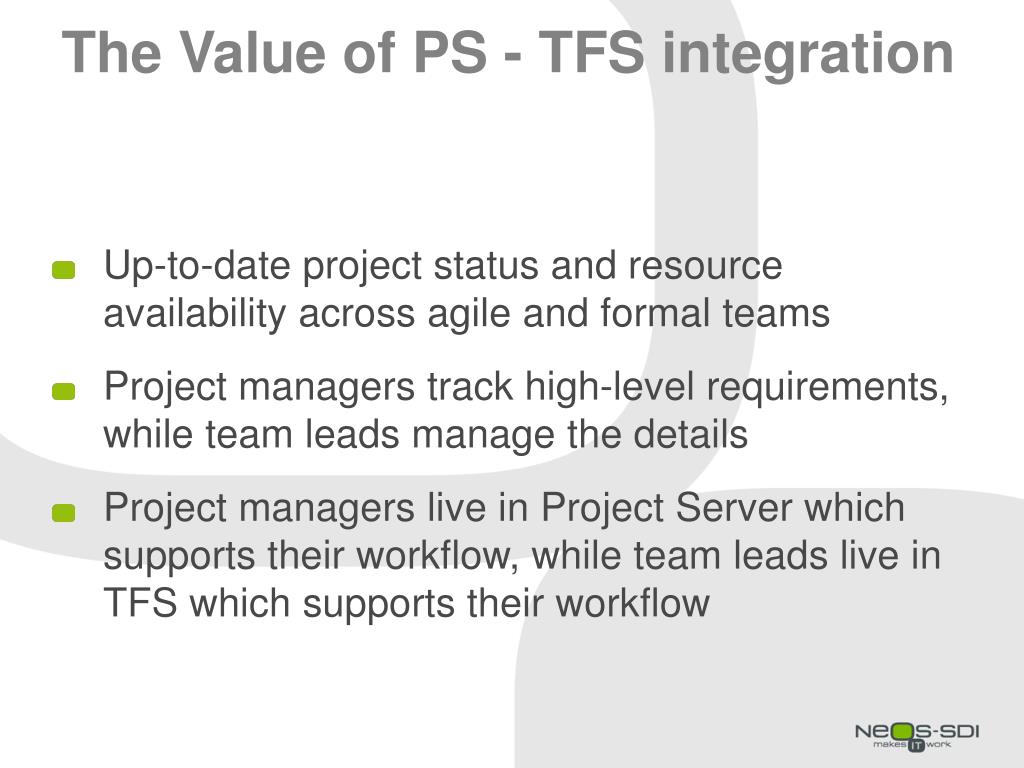

The Value of PS - TFS integration • Up-to-date project status and resource availability across agile and formal teams • Project managers track high-level requirements, while team leads manage the details • Project managers live in Project Server which supports their workflow, while team leads live in TFS which supports their workflow

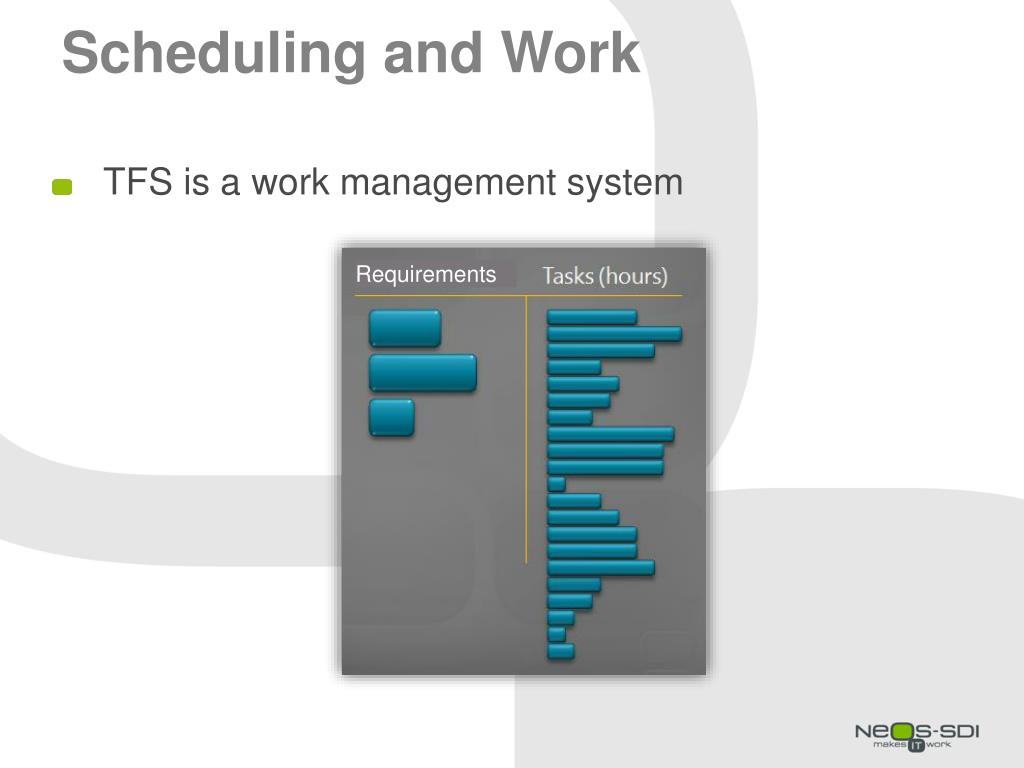

Scheduling and Work • TFS is a work management system Requirements

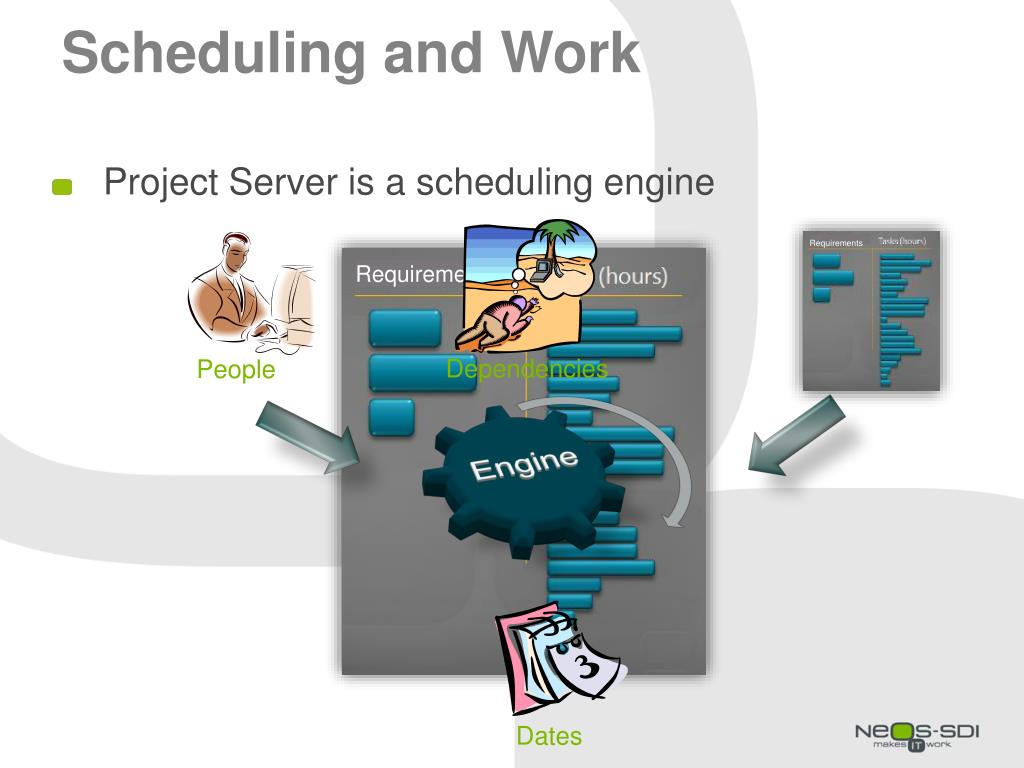

Scheduling and Work • Project Server is a scheduling engine Requirements Requirements Dependencies People Dates

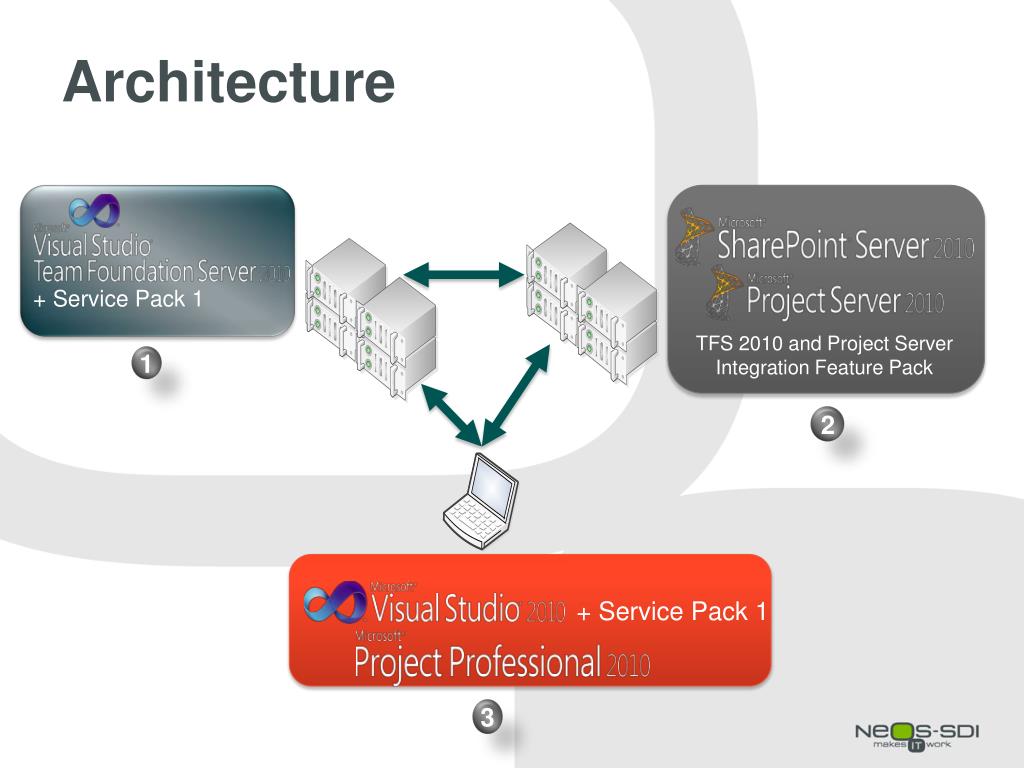

Architecture + Service Pack 1 TFS 2010 and Project Server Integration Feature Pack 1 2 + Service Pack 1 3

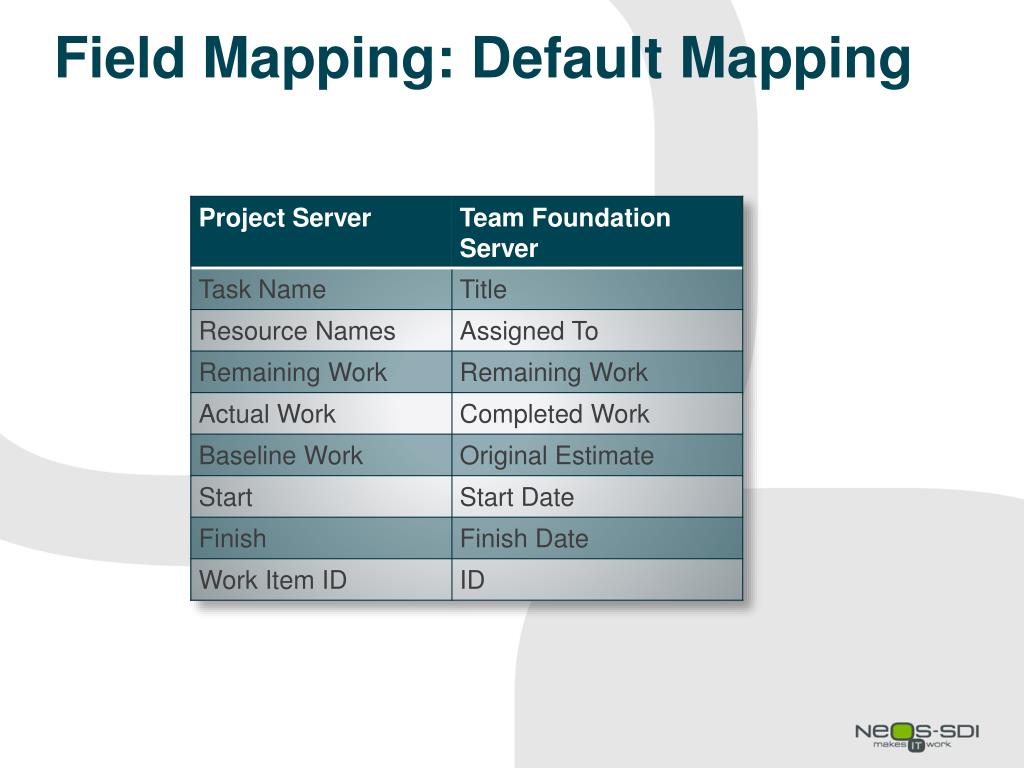

Configuration in Six Steps • Grant Admin permissions • Register PWA Instance • Map PWA to a Team Project Collection • Upload default field mappings • Associate an Enterprise Project Plan with a Team Project • Add TFS Users to Project Server Enterprise Resource Pool Register PWA Instance Grant Administrative Permissions Map PWA to Team Project Collection Upload/Define Field Mappings for Integration Associate Enterprise Project with TFS Team Project Add TFS Users to Project Server Enterprise Resource Pool
