Trial for Unbundled Local Loop

Trial for Unbundled Local Loop. Phase 1 - Co-location Trials Physical Co-location Distant Co-location Phase 2 - End User Technical Trials Manual provision of Metallic Pair Facilities Phase 3 - Automation Trials Initially low volumes with Operator end-customers. Phase 1 - Co-location Trial.

grace
Télécharger la présentation

Trial for Unbundled Local Loop

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

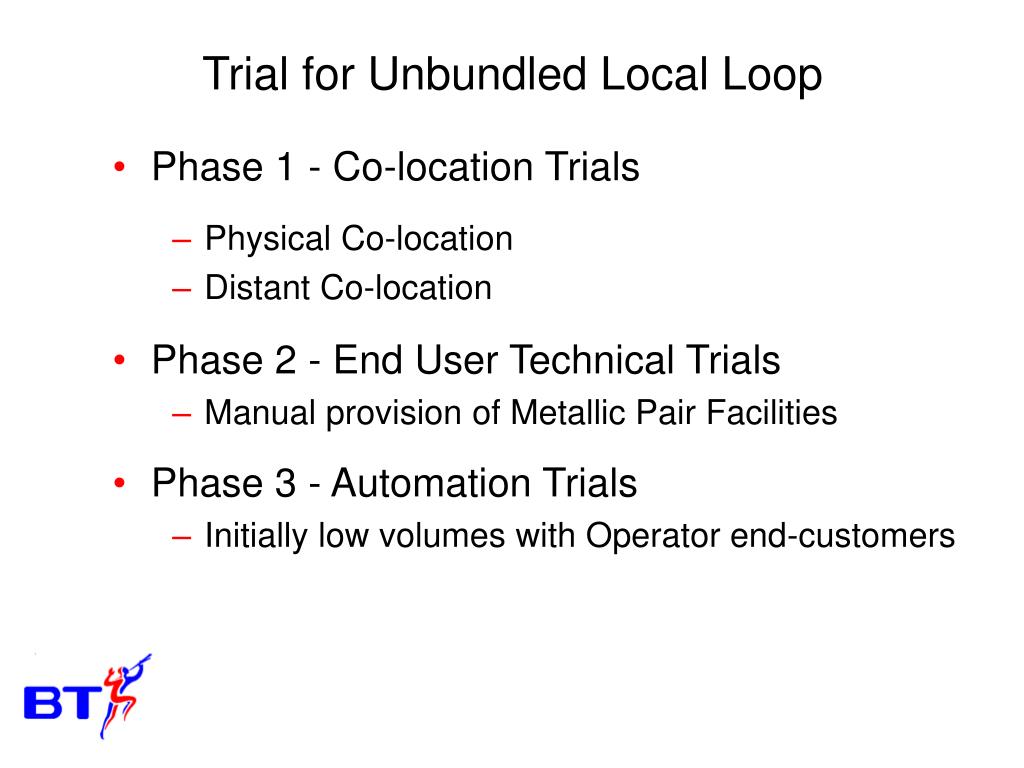

  1. Trial for Unbundled Local Loop • Phase 1 - Co-location Trials • Physical Co-location • Distant Co-location • Phase 2 - End User Technical Trials • Manual provision of Metallic Pair Facilities • Phase 3 - Automation Trials • Initially low volumes with Operator end-customers

  2. Phase 1 - Co-location Trial BT Exchange OLO room OLO room Distant co-lo Distant co-lo BT exchange 4 OLOs sharing a room OLO room 7 co-locations Distant co-lo Distant co-lo Distant co-lo Distant co-lo BT exchange BT Exchange OLO room OLO room BT Exchange 4 co-locations 4 co-locations - 3 Field Force Areas (FFA) - 1 Physical Co-location per FFA - 2 Distant Co-locations per FFA - At Least 1 Dedicated OLO Room per FFA - 12 OLOs Maximum - 15 Co-locations Maximum

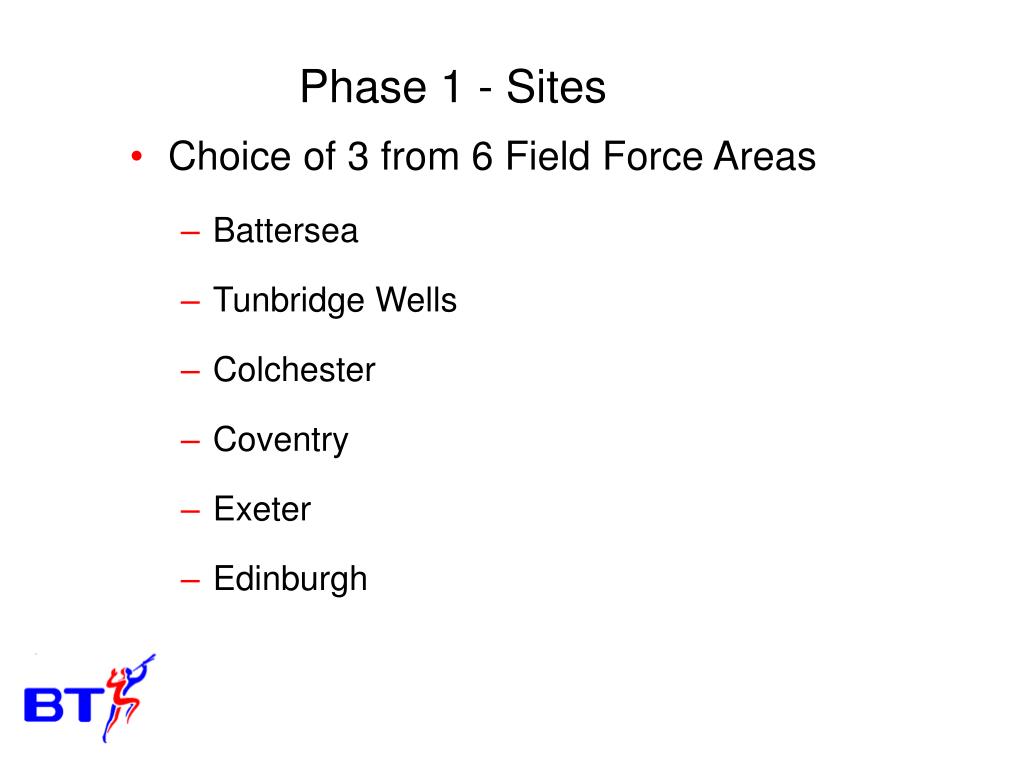

  3. Phase 1 - Sites • Choice of 3 from 6 Field Force Areas • Battersea • Tunbridge Wells • Colchester • Coventry • Exeter • Edinburgh

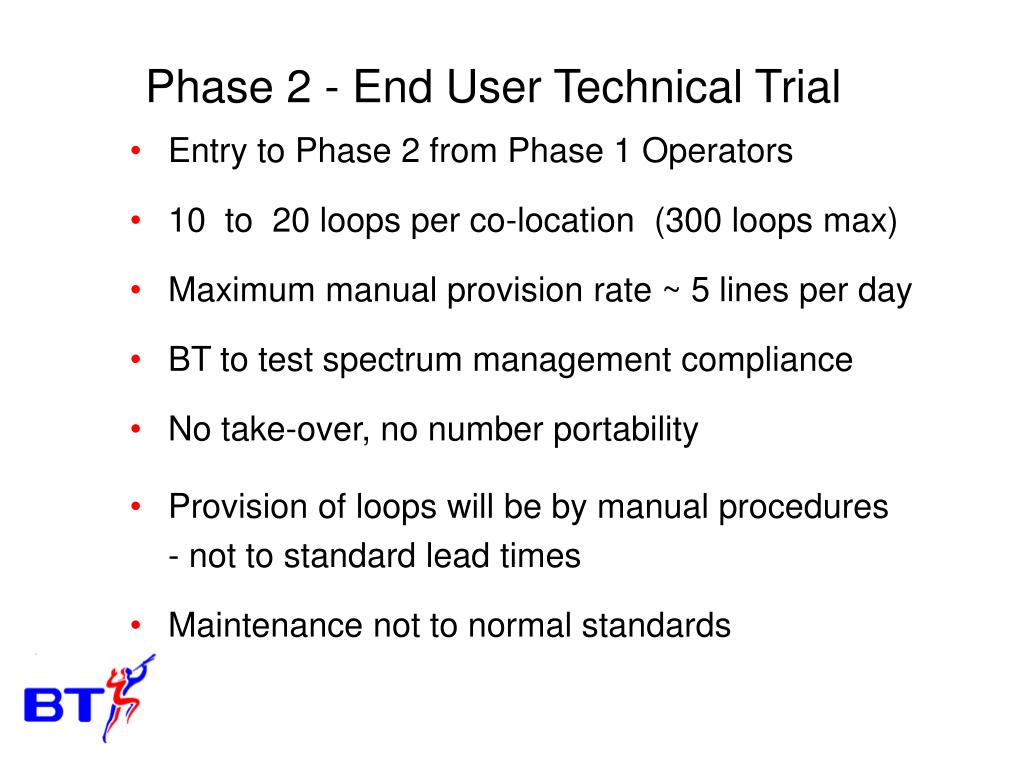

  4. Phase 2 - End User Technical Trial • Entry to Phase 2 from Phase 1 Operators • 10 to 20 loops per co-location (300 loops max) • Maximum manual provision rate ~ 5 lines per day • BT to test spectrum management compliance • No take-over, no number portability • Provision of loops will be by manual procedures - not to standard lead times • Maintenance not to normal standards

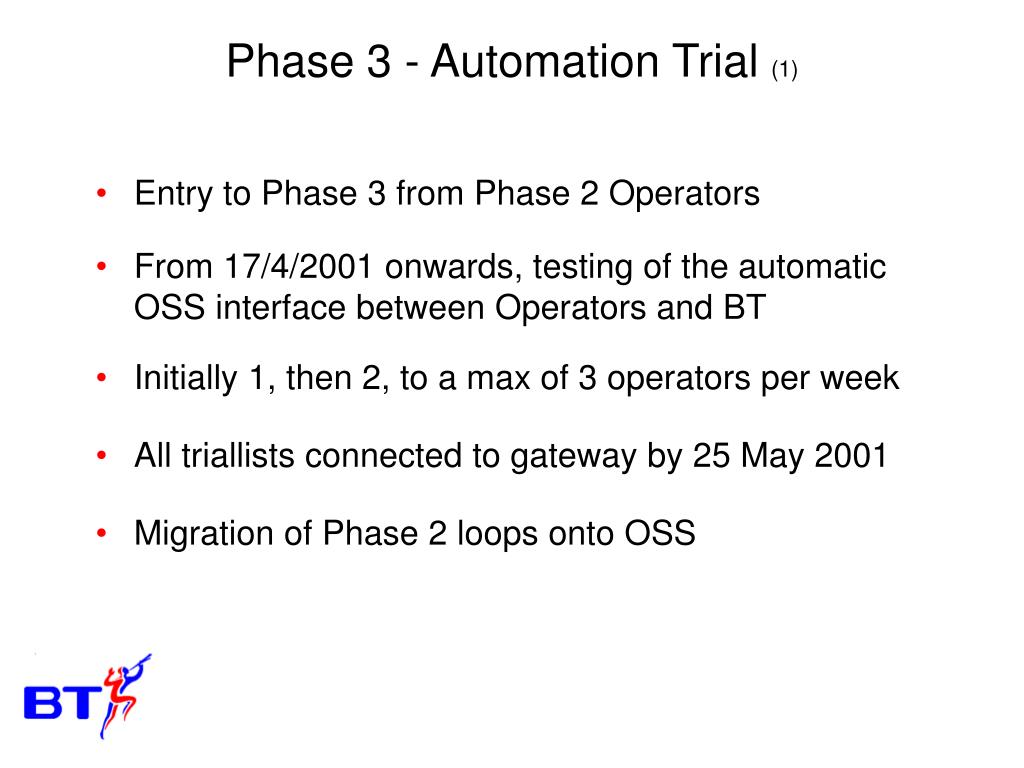

  5. Phase 3 - Automation Trial (1) • Entry to Phase 3 from Phase 2 Operators • From 17/4/2001 onwards, testing of the automatic OSS interface between Operators and BT • Initially 1, then 2, to a max of 3 operators per week • All triallists connected to gateway by 25 May 2001 • Migration of Phase 2 loops onto OSS

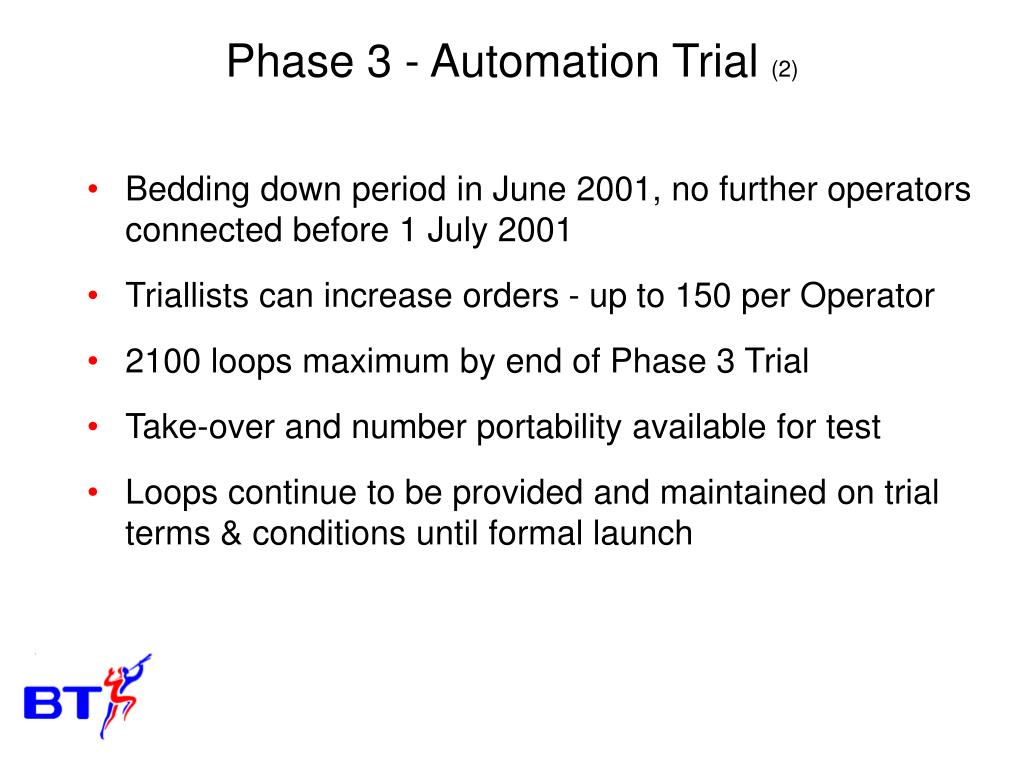

  6. Phase 3 - Automation Trial (2) • Bedding down period in June 2001, no further operators connected before 1 July 2001 • Triallists can increase orders - up to 150 per Operator • 2100 loops maximum by end of Phase 3 Trial • Take-over and number portability available for test • Loops continue to be provided and maintained on trial terms & conditions until formal launch

  7. Timeline Summary Co-location Phase A 1 April 2000 31 Dec 2000 End-user technical trials Phase B 1 Dec 2000 12 April 2001 Automation Trial Phase C 17 April 2001 30 June 2000

  8. Critical System Constraints • COSMOSS modifications for tracking co-location build, tie cables and backhaul - available July 2000 • CSS and other systems for pair provision & maintenance - available end March 2001 • Gateway to Operators and OSS , available for start of phase 3 trial -17 April 2001

  9. Next Steps • Which Operators Involved in the Trial ? • Establish OPF Trial Team ? • Which Sites to be Used in the Trial ? • Orders for Co-location 1/04/2000
