New Morehead State Bowling Facility IET 499C, Fall 2012 Stephen Glossner

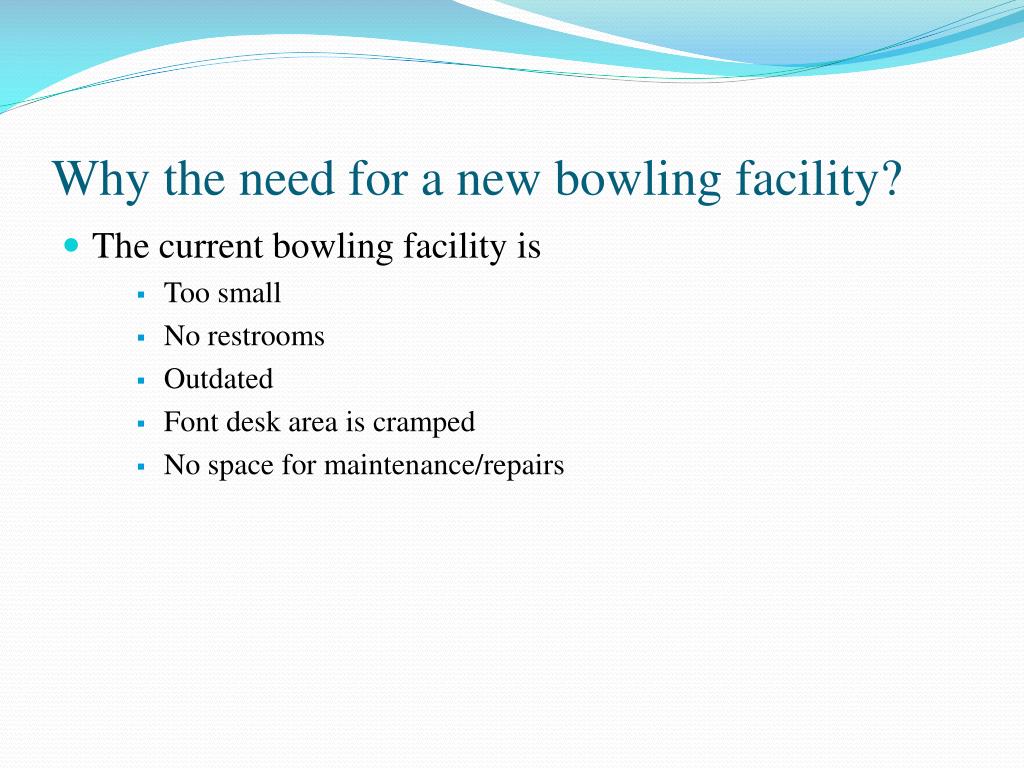

Why the need for a new bowling facility? • The current bowling facility is • Too small • No restrooms • Outdated • Font desk area is cramped • No space for maintenance/repairs
Site Work • Site location • Site survey • Cut and fill analysis

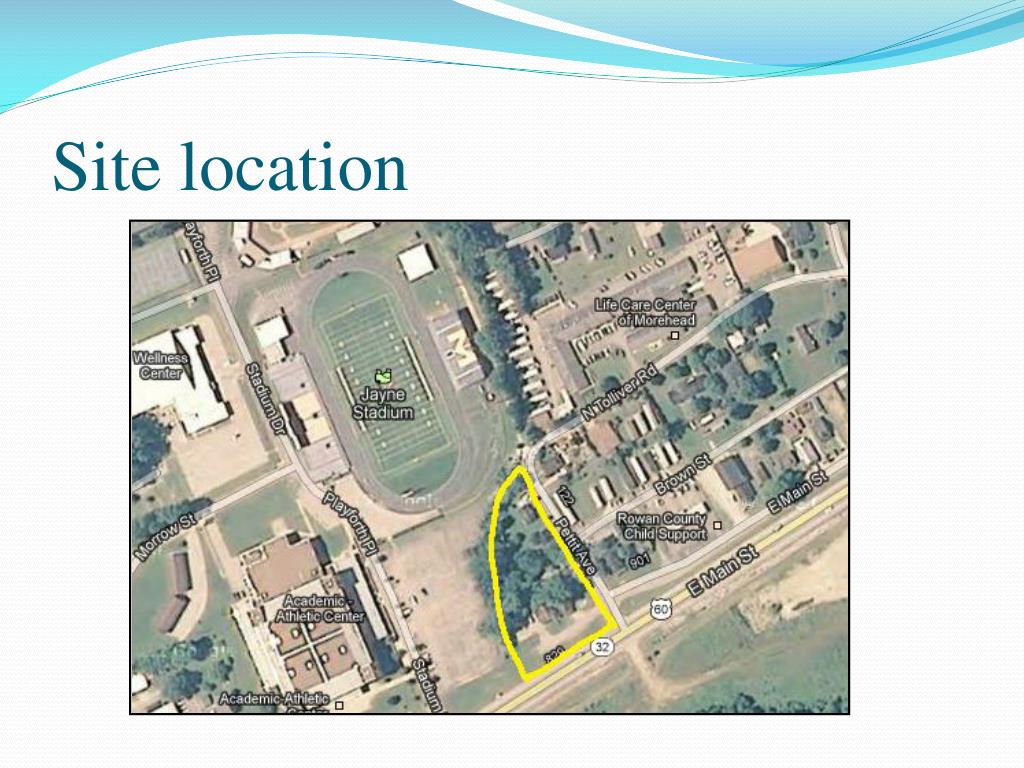

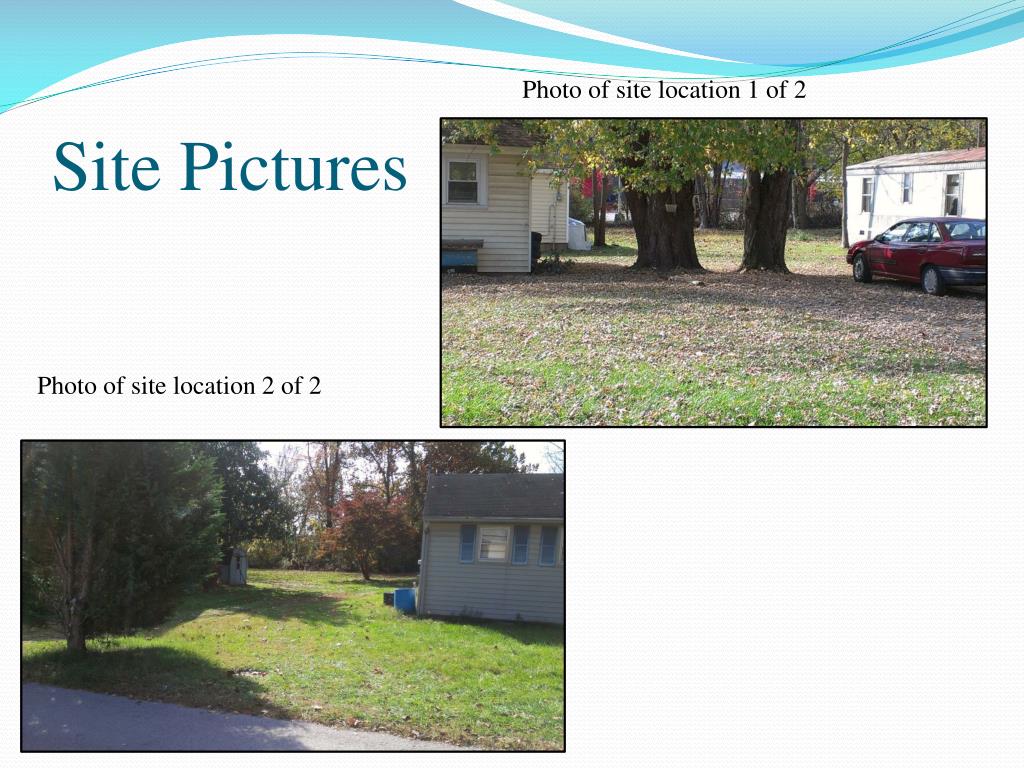

Photo of site location 1 of 2 Site Pictures Photo of site location 2 of 2

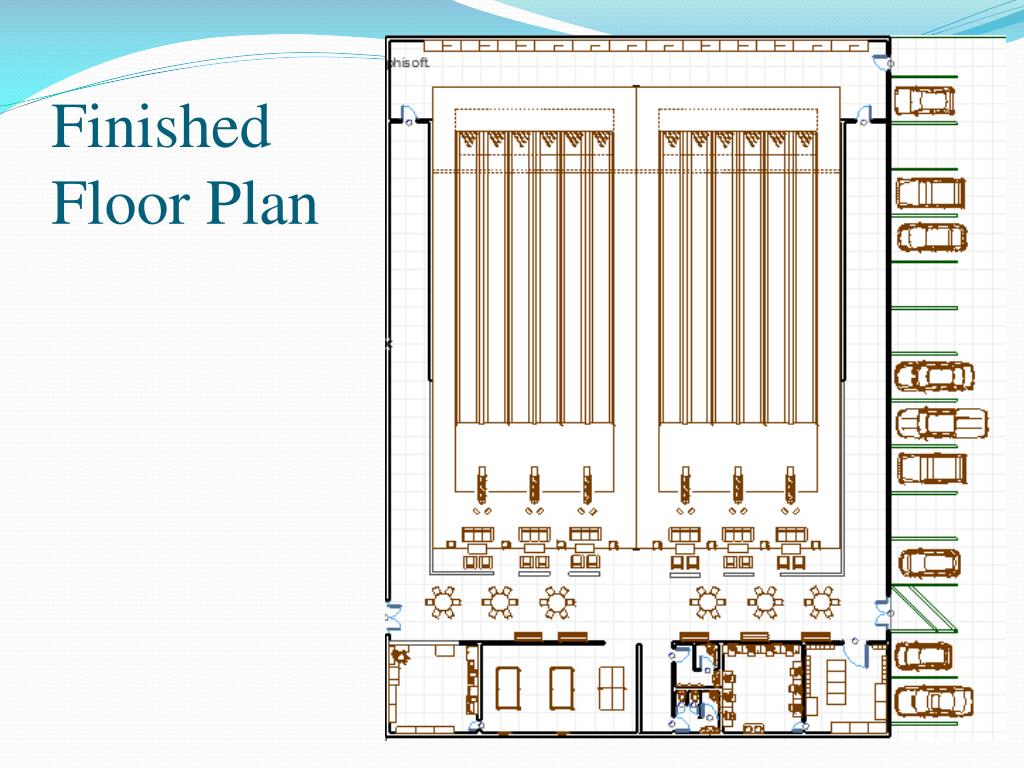

Design • General floor plan • Plumbing/ HVAC/ Electrical • Finished floor plan • 3D rendering

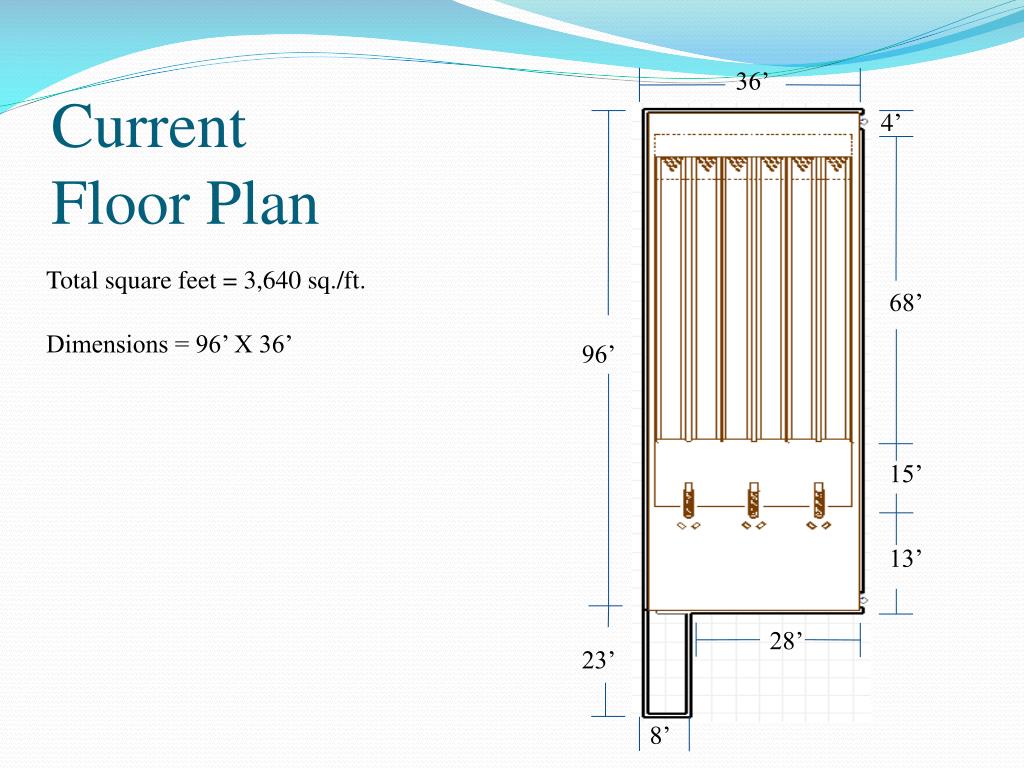

36’ Current Floor Plan 4’ Total square feet = 3,640 sq./ft. 68’ Dimensions = 96’ X 36’ 96’ 15’ 13’ 28’ 23’ 8’
New Floor Plan Total square feet = 16,172 sq./ft. Dimensions = 151’ 6” X 106’ 9” 151’ 6” 15’ 33’ 10’ 7” 20’ 106’ 9”

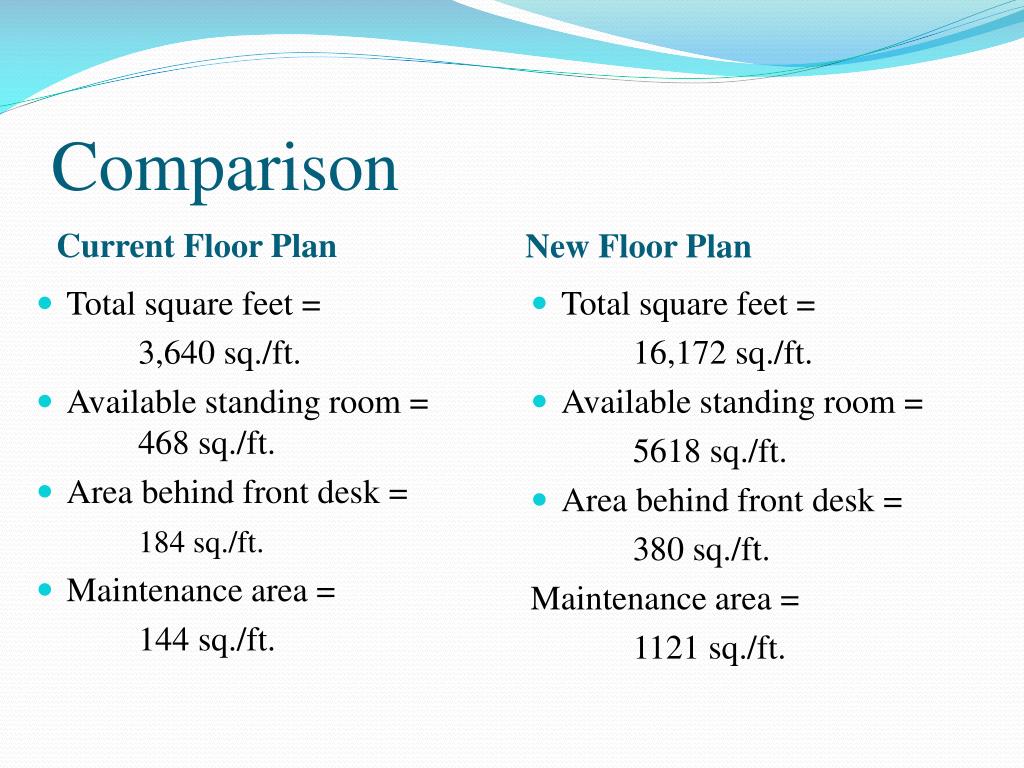

Comparison Current Floor Plan New Floor Plan • Total square feet = 3,640 sq./ft. • Available standing room = 468 sq./ft. • Area behind front desk = 184 sq./ft. • Maintenance area = 144 sq./ft. • Total square feet = 16,172 sq./ft. • Available standing room = 5618 sq./ft. • Area behind front desk = 380 sq./ft. Maintenance area = 1121 sq./ft.

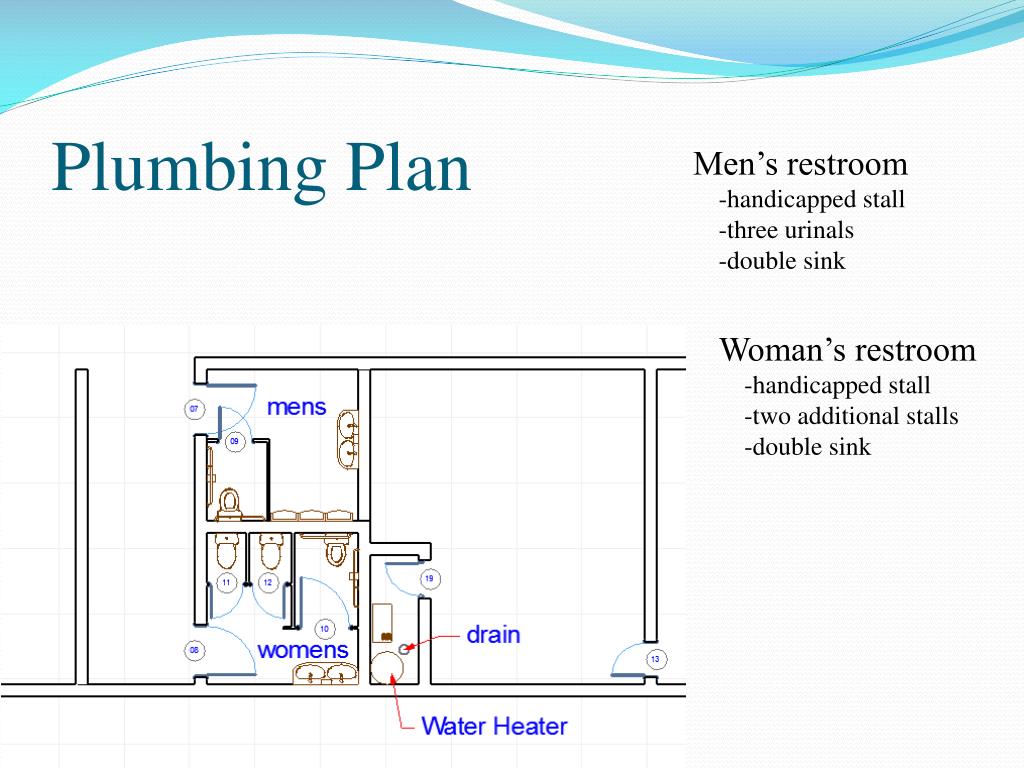

Plumbing Plan Men’s restroom -handicapped stall -three urinals -double sink Woman’s restroom -handicapped stall -two additional stalls -double sink

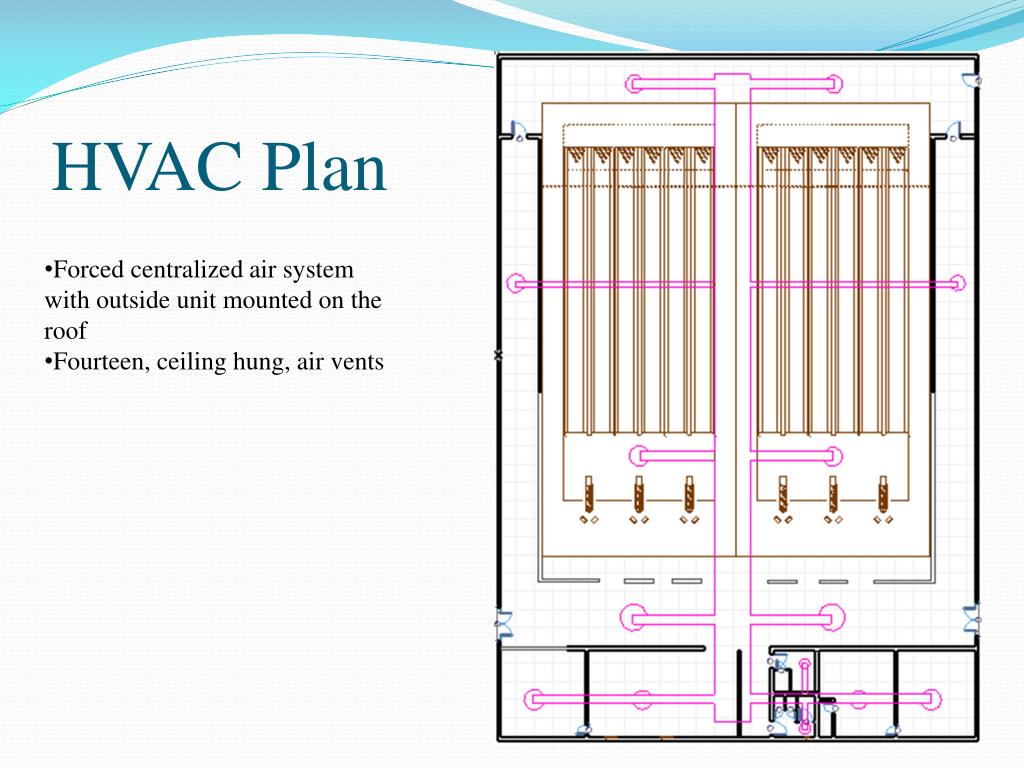

HVAC Plan • Forced centralized air system with outside unit mounted on the roof • Fourteen, ceiling hung, air vents

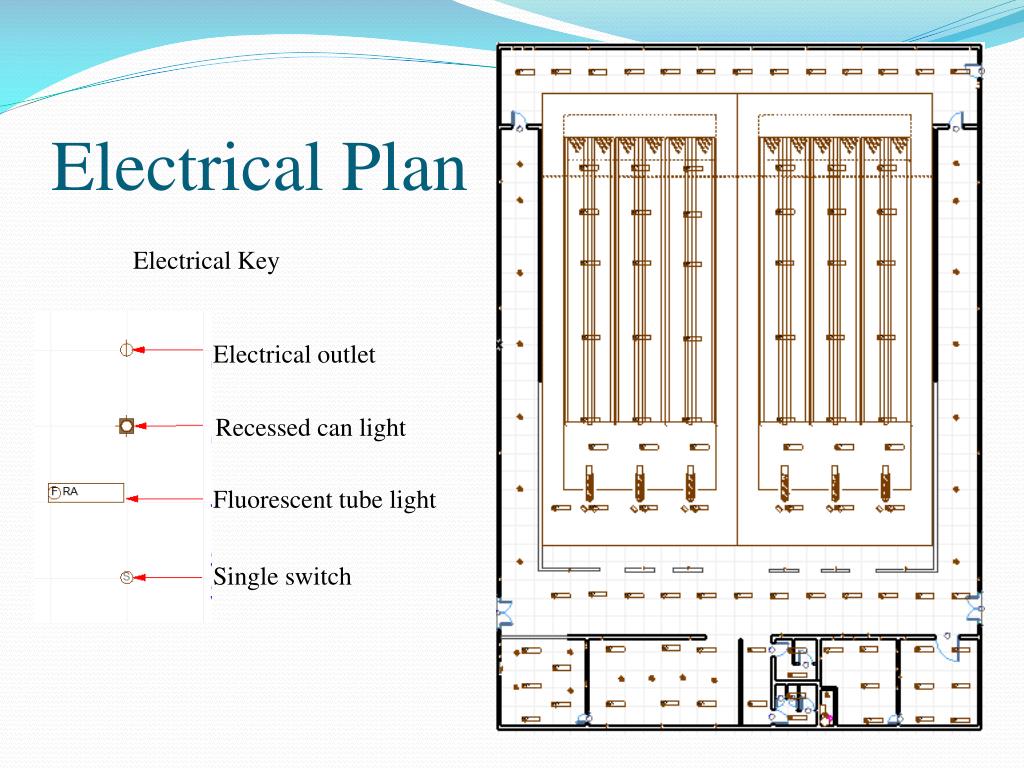

Electrical Plan Electrical Key Electrical outlet Recessed can light Fluorescent tube light Single switch

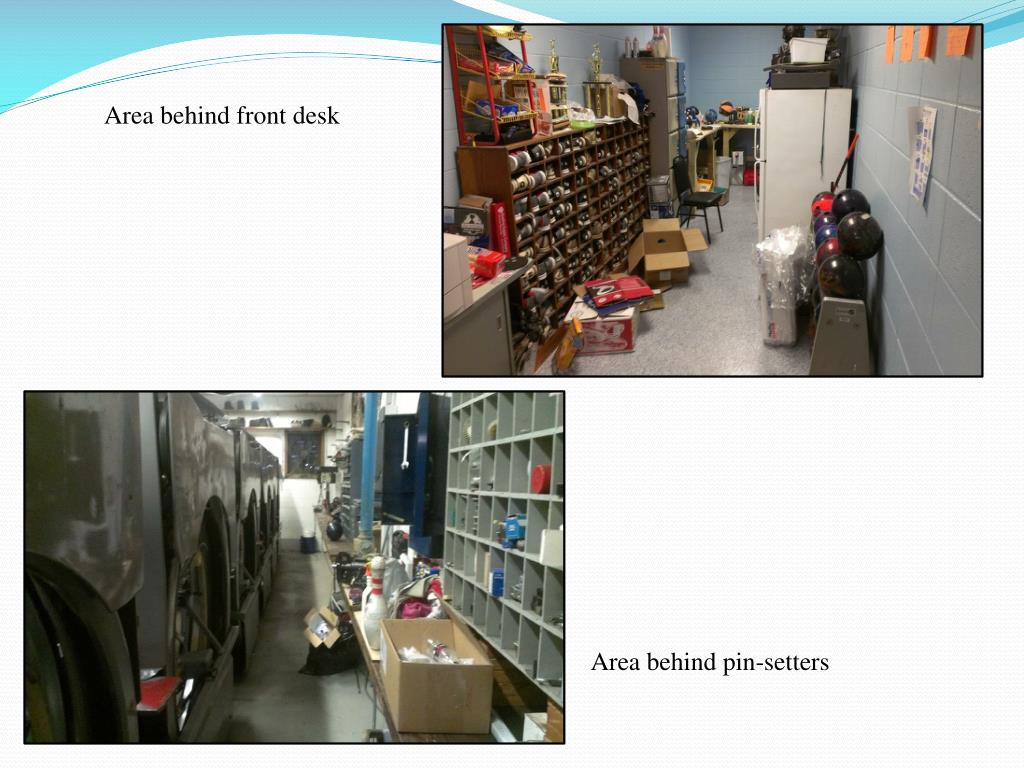

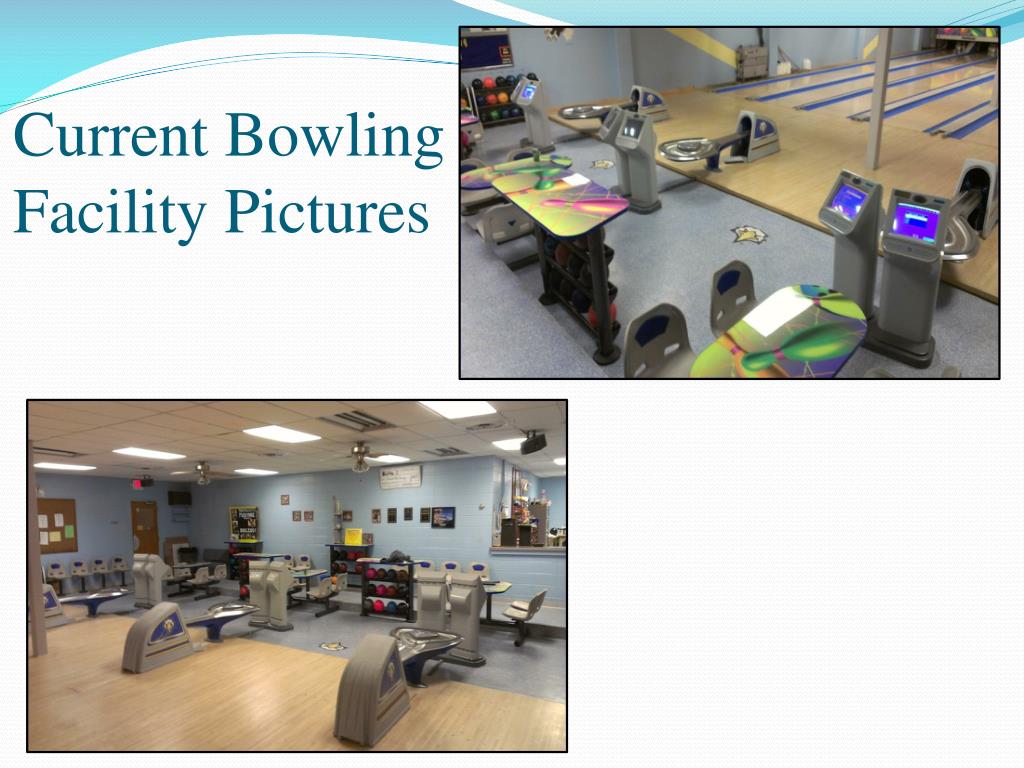

Area behind front desk Area behind pin-setters

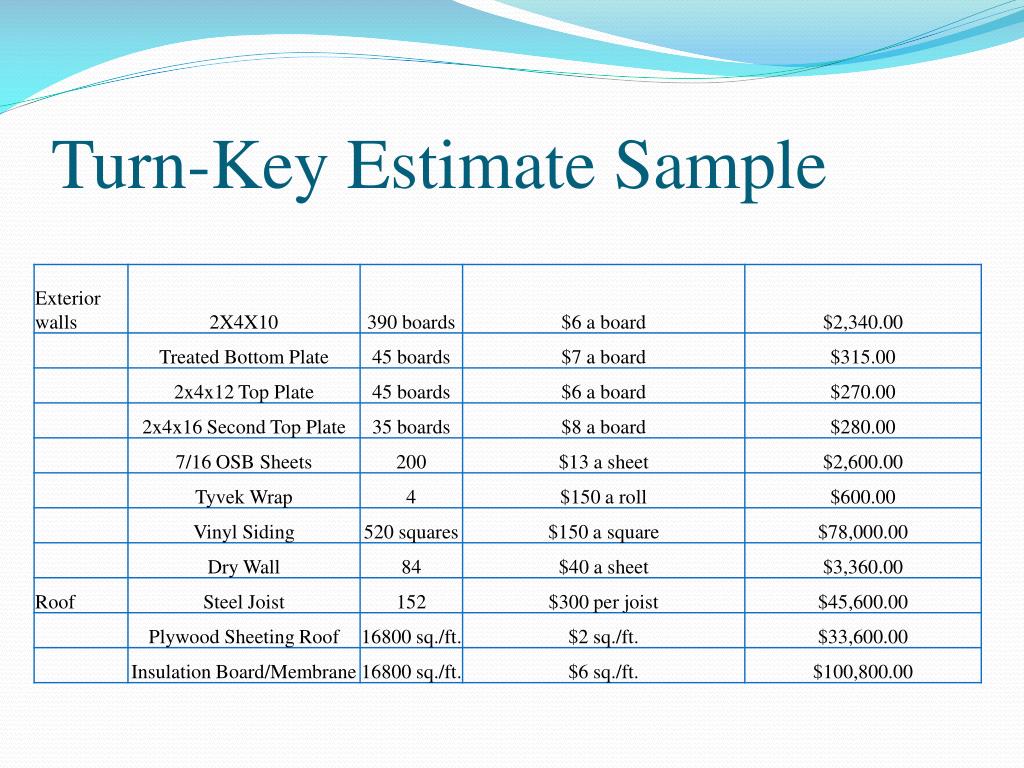

Cost/ Schedule • Material and Labor estimate • Cost analysis • Project schedule

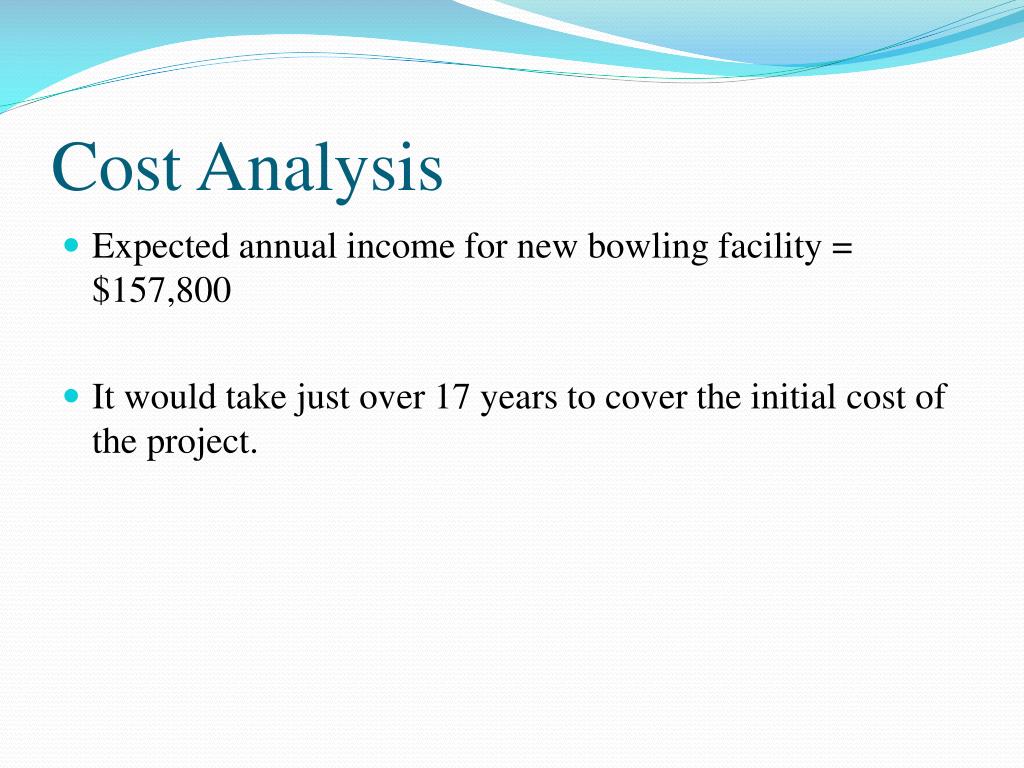

Cost Analysis • Expected annual income for new bowling facility = $157,800 • It would take just over 17 years to cover the initial cost of the project.

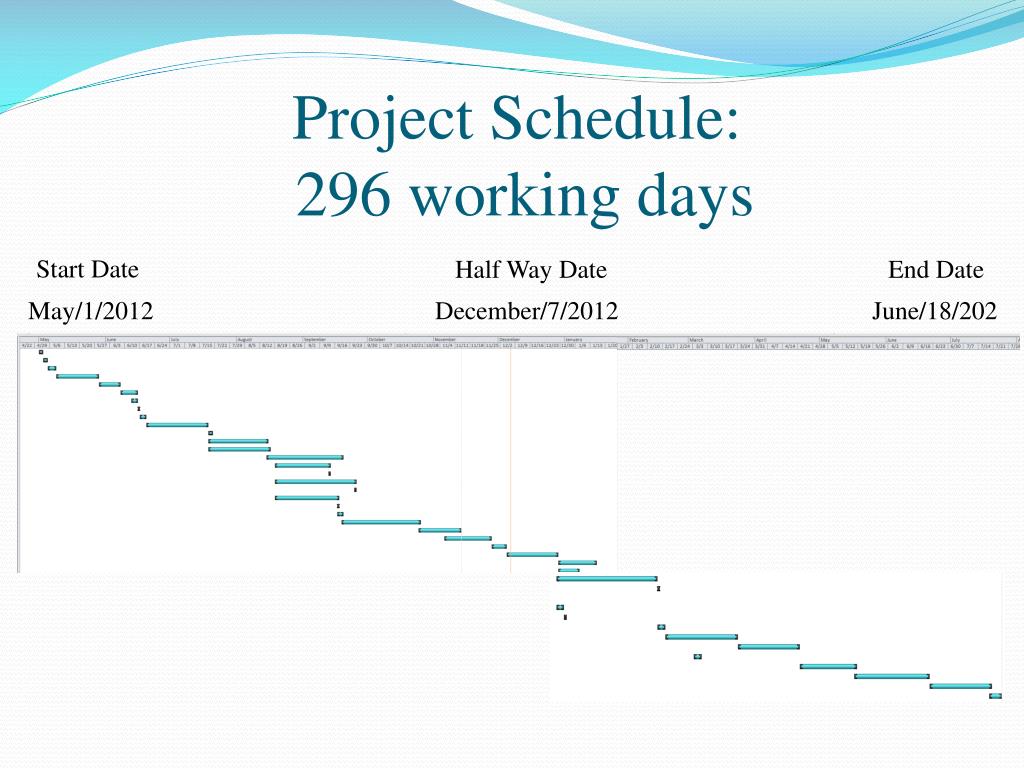

Start Date Half Way Date End Date Project Schedule: 296 working days May/1/2012 December/7/2012 June/18/202
Conclusion A new bowling facility would benefit the university, the bowling team and the city of Morehead • The university • Increased revenue • greater appeal for potential students • The bowling team • Bigger, better facility • More members can join • Updated machines/equipment • The city of Morehead • Something new and exciting • New place to take family
