Dulles Corridor Metrorail Project

Dulles Corridor Metrorail Project. 23-mile new Metrorail line branching off the Orange Line after East Falls Church 11 new stations 5 in Phase 1: East Falls Church to Wiehle Avenue in Reston 6 in Phase 2: Wiehle Avenue through Dulles International Airport to Ashburn

halima
Télécharger la présentation

Dulles Corridor Metrorail Project

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

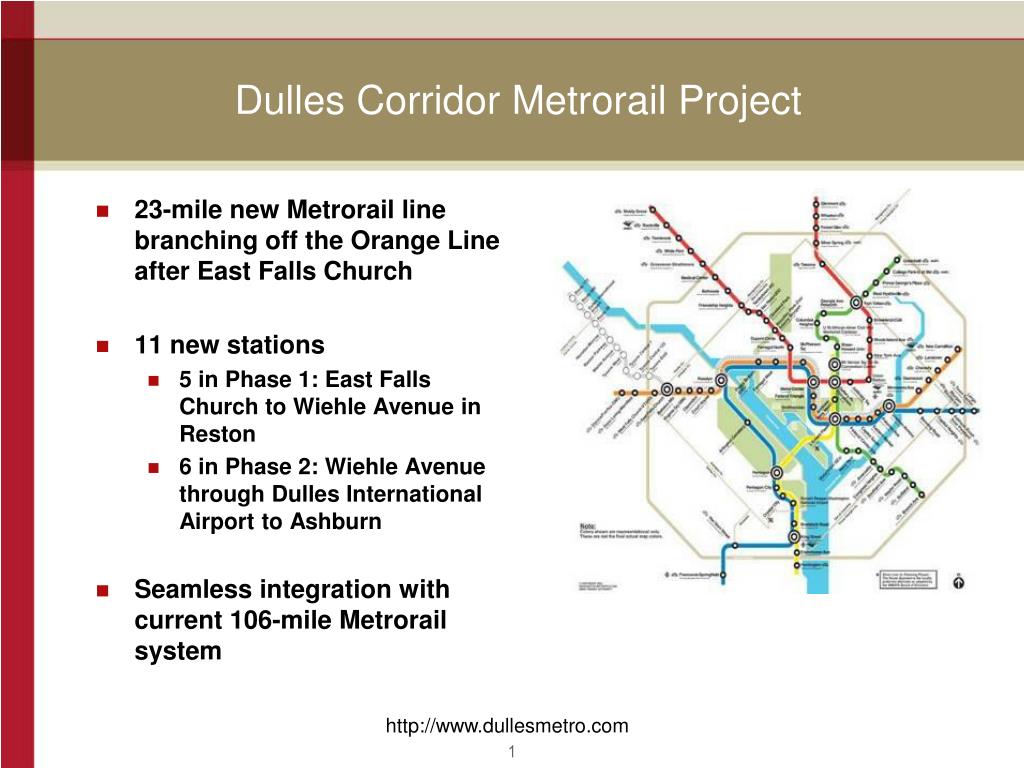

  1. Dulles Corridor Metrorail Project 23-mile new Metrorail line branching off the Orange Line after East Falls Church 11 new stations 5 in Phase 1: East Falls Church to Wiehle Avenue in Reston 6 in Phase 2: Wiehle Avenue through Dulles International Airport to Ashburn Seamless integration with current 106-mile Metrorail system http://www.dullesmetro.com

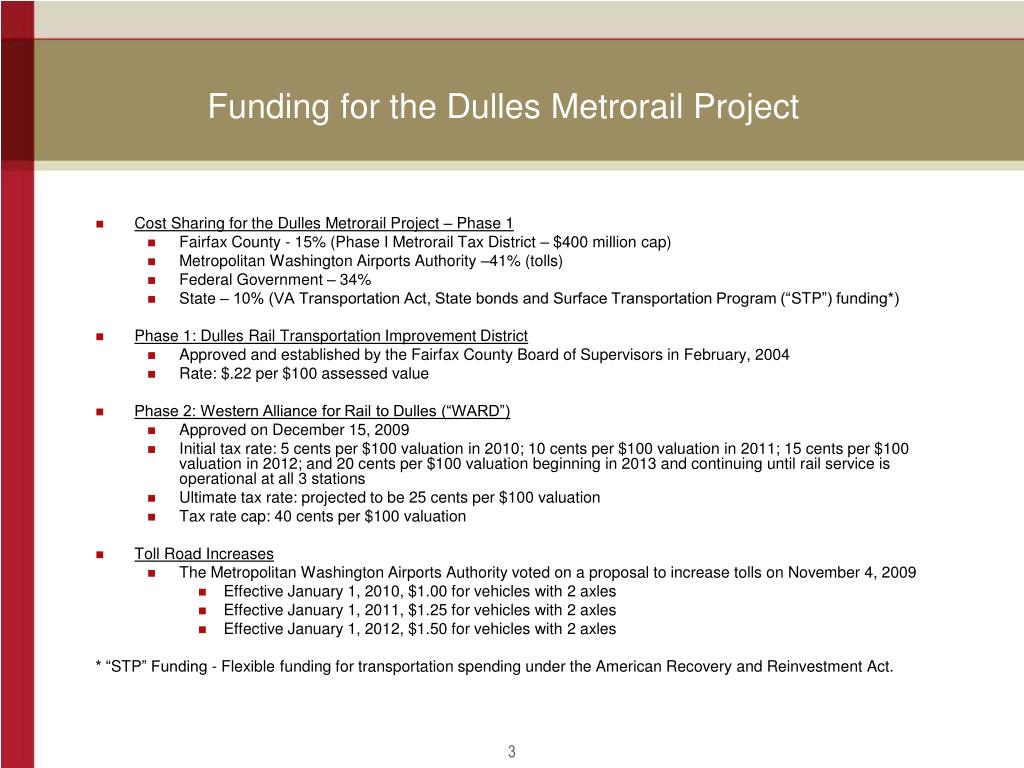

  2. Funding for the Dulles Metrorail Project • Cost Sharing for the Dulles Metrorail Project – Phase 1 • Fairfax County - 15% (Phase I Metrorail Tax District – $400 million cap) • Metropolitan Washington Airports Authority –41% (tolls) • Federal Government – 34% • State – 10% (VA Transportation Act, State bonds and Surface Transportation Program (“STP”) funding*) • Phase 1: Dulles Rail Transportation Improvement District • Approved and established by the Fairfax County Board of Supervisors in February, 2004 • Rate: $.22 per $100 assessed value • Phase 2: Western Alliance for Rail to Dulles (“WARD”) • Approved on December 15, 2009 • Initial tax rate: 5 cents per $100 valuation in 2010; 10 cents per $100 valuation in 2011; 15 cents per $100 valuation in 2012; and 20 cents per $100 valuation beginning in 2013 and continuing until rail service is operational at all 3 stations • Ultimate tax rate: projected to be 25 cents per $100 valuation • Tax rate cap: 40 cents per $100 valuation • Toll Road Increases • The Metropolitan Washington Airports Authority voted on a proposal to increase tolls on November 4, 2009 • Effective January 1, 2010, $1.00 for vehicles with 2 axles • Effective January 1, 2011, $1.25 for vehicles with 2 axles • Effective January 1, 2012, $1.50 for vehicles with 2 axles * “STP” Funding - Flexible funding for transportation spending under the American Recovery and Reinvestment Act.

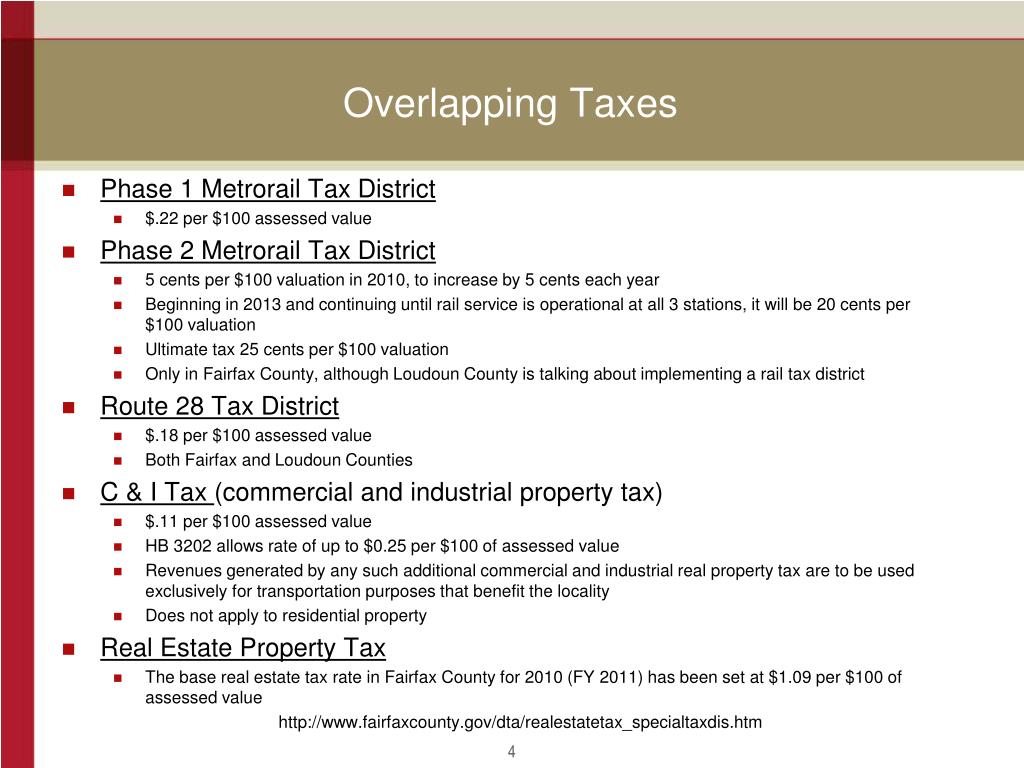

  3. Overlapping Taxes • Phase 1 Metrorail Tax District • $.22 per $100 assessed value • Phase 2 Metrorail Tax District • 5 cents per $100 valuation in 2010, to increase by 5 cents each year • Beginning in 2013 and continuing until rail service is operational at all 3 stations, it will be 20 cents per $100 valuation • Ultimate tax 25 cents per $100 valuation • Only in Fairfax County, although Loudoun County is talking about implementing a rail tax district • Route 28 Tax District • $.18 per $100 assessed value • Both Fairfax and Loudoun Counties • C & I Tax (commercial and industrial property tax) • $.11 per $100 assessed value • HB 3202 allows rate of up to $0.25 per $100 of assessed value • Revenues generated by any such additional commercial and industrial real property tax are to be used exclusively for transportation purposes that benefit the locality • Does not apply to residential property • Real Estate Property Tax • The base real estate tax rate in Fairfax County for 2010 (FY 2011) has been set at $1.09 per $100 of assessed value http://www.fairfaxcounty.gov/dta/realestatetax_specialtaxdis.htm

  4. Construction Schedule • Phase 1 Metrorail • July, 2004: commenced engineering • May, 2008: commenced final design • June, 2008: commenced utility relocation • March, 2009: FFGA approved for Phase 1; Notice to Proceed (“NTP”) issued to design-build contractors • July, 2013: Phase 1 substantial completion • December, 2013: begin service to Wiehle • Phase 2 Metrorail • July, 2009: issued RFP for preliminary engineering • January, 2010: commenced preliminary engineering • Fenruary, 2011: preliminary engineering completed • Summer, 2011: issue RFP for design-build contract • January, 2012: issue NTP to design-build contractors • December, 2016: full project substantial completion; commence service to Route 772 • HOT Lanes • 2007 – 2009: design and engineering • Spring 2008: design public hearing • 2008 – 2010: right of way activity • 2008 – 2010: utility relocation • 2008 – 2012: bridge construction • Summer 2008-2011: construct 4 new outer lanes and demonlish/rebuild all Belway interchanges • 2011-2012: shift Beltway traffic into new outer lanes and construct HOT lanes on inner lanes • 2013: HOT lanes open

  5. Dulles Corridor Metrorail Project

  6. A Year of Dulles Rail Construction Progresses The tunnel that will carry Metrorail between Routes 7 and 123 in Tysons Corner

  7. Routes 7 and 123 West Cut and Tunnel Cover at Route 7

  8. Route 123 and the Dulles Toll Road (Tysons East) Route 123 at I-495

  9. Major Regional Transportation Improvements Metro Rail to Tysons and Dulles Airport • Rail to Tysons by 2013 • Rail to Dulles Airport by 2016 • $5.0+ billion to Dulles Beltway HOT Lanes - $900 million Woodrow Wilson Bridge - $2.4 billion Route 28 Improvements- $400 million Springfield Interchange- $676 million
